Skip to main content

2026-2030 Capital Improvement Plan Updated 3-5-26

Page 1

TABLE OF CONTENTS

3 ABOUT THE CIP AND CARP

4-5 EXISTING FACILITIES

6-7 HISTORY OF IMPROVEMENTS

8 DEBT SCHEDULE

9 R00F SUMMARY

10 HVAC SUMMARY

11-13 ENROLLMENT

14-15 FACILITY CONDITION ASSESSMENT

16-17 PROJECTS

18-19 BUDGET

20-45 5-YEAR PLAN

about the CIP and CARP about the CIP and CARP

THE PROPOSED CAPITAL IMPROVEMENT PLAN (CIP)

The Winchester Public School Division reviews and updates the Capital Improvement Plan (CIP) annually. The proposed CIP identifies projects to be accomplished during a five-year time period. Projects included in this plan meet the City’s definition of major capital expenditure based on the following criteria:

The item is tangible

The value is $50,000 or greater

The life expectancy is at least seven years; and

If any improvement, then the value of the asset is increased, or the useful life is extended beyond that originally anticipated.

The CIP provides a forecast of facility improvements required to support Winchester Public Schools by promoting timely financing, planning, and construction. The funding source for major projects may be from local bond issues, Virginia Public School Authority (VPSA) bonds, pay-as-you-go funding, fund raising, or capital lease arrangements.

THE PROPOSED CAPITAL ASSET REPLACEMENT-MAJOR MAINTENANCE PLAN (CARP)

The CARP includes minor construction, roof replacements, interior renovations, school safety and ADA projects, and HVAC / energy efficiency projects not meeting the funding threshold of the CIP. These projects are funded by annual appropriation by City Council, or approval of budget amendments allocating prior-year operating fund balances

EXISTING FACILITIES EXISTING FACILITIES

Winchester Public Schools operates and maintains approximately 1,000,000 square feet of classroom, laboratory, administrative and support space During Fiscal Year 2026, all WPS schools are being utilized under their designed capacity.

All elementary schools are under capacity.

Daniel Morgan Campus has 1,178 students enrolled (2025-2026) with a capacity of 1,280.

John Handley High School has 1,322 students enrolled (2025-2026) with a capacity of 1,560.

ELEMENTARY SCHOOLS

Frederick Douglass

Elementary School Grades PreK-4

Major overhaul of HVAC, lighting and fire safety systems was completed in 2024

Garland R. Quarles

Elementary School Grades PreK-4

Approaching 30 years of service

Needs mechanical systems rehabilitation in coming years

THE DANIEL MORGAN CAMPUS

Daniel Morgan

John Kerr

Elementary School Grades PreK-4

Newest elementary school All mechanical systems under warranty until 2026

Daniel Morgan

Virginia Ave Charlotte

DeHart Elem School Grades PreK-4

30 years in operation

Needs mechanical systems rehabilitation in coming years

HIGH SCHOOL

John Handley

Emil & Grace Shihadeh

Grades 5-6

Intermediate School

Only intermediate school serving the City of Winchester

Middle School Grades 7-8

Only middle school serving the City of Winchester

High SchoolGrades 9-12

Only high school serving the City of Winchester

Innovation Center Grades 9-12

Opened in September 2021

Increased JH capacity by 300

history of improvements history of improvements

Plan is Adopted

City of Winchester & School Board initiate an ambitious plan to improve and expand school facilities

1990

Frederick Douglass Elementary School Opens

1993

Central Administrative Office Opens

2002

School Board Endorses 7/8 Building Strategy at Daniel Morgan

To address capacity issue at middle school and build capacity at elementary schools, School Board endorses plan to build a new grade 7/8 building attached to Daniel Morgan Middle School and renovate the existing building to accommodate grades 5 & 6. With this plan, 5th graders will move to Daniel Morgan to create capacity at the elementary school level.

2003

VirginiaAvenueCharlotteDeHartElementary SchoolOpens

DanielMorganCampusisExpanded 1995

1997

Garland R. Quarles Elementary School Re-Opens After Complete Renovation & Expansion

2000-2001

Feasibility & Planning Study Completed for John Kerr Elementary School

John Kerr renovation and expansion project is added to the Capital Improvement Plan

2001-2002

Daniel Morgan Campus is Partially Renovated

2002

Planning Study Identifies System-Wide Facility Needs with Capacity Issues in Elementary and Middle Schools

Feasibility & Planning Study Completed for John Handley High School

The building, last renovated in 1979, required substantial upgrades to mechanical, electrical, plumbing, fire suppression/alarm, and architectural system as well as building reconfidugring and xpansion of 24,000 feet Cost for improvements is estimated to be $63.9 million.

2004

CityCouncilapproves$32millionprojectto expandandrenovateDanielMorgan

Project funded by the Virginia Public-Private Education Facilities and Infrastructure Act of 2002 (PPEA)

2004

City Council Approves $50 million of local funding for Handley Project

Remaining funding is to be generated from the sale of Historic Tax Credits and fundraising efforts

Timelinecontinuedonnextpage.

August2005

Daniel Morgan Phase 1 Complete

New academic building, gymnasium, cafeteria and media center in Phase 1

August2006

Daniel Morgan Phase 2 Complete

Renovation of existing building in Phase 2

2007-2008

John Handley High School is Restored & Expanded

2008-2009

JHHS Rear Academic Wing and Gymnasium Are Renovated

2009-2010

HandleyBowlImprovementsCompleted

June2016

New John Kerr Elementary School Opens

August2016

Concept Study Completed for the Douglas School

The Douglas School, which housed Black students from Winchester and the surrounding area during segregation, was sitting vacant after being used for many different purposes over the years following integration

Fall2018

Decision is made to demolish part of the Douglas School building that is unusable

January2021

Demolition, renovation and expansion project begins at the Douglas School

The Douglas School will be renovated and expanded to host WPS Central Offices, meeting spaces, and a museum to share the history of the building Cost of renovations is estimated at $154 million

August2021

The Emil & Grace Shihadeh Innovation Center Opens

A $17 million facility, EGSIC provides Career & Technical Education as well as core academics to students in an interdisciplinary environment

June2022

The Central Administrative Office on Washington St is sold for $1.85 million by Winchester City Council.

January2023

The WPS Central Administrative Office at the Douglas School officially opens

June2024

DouglasSchoolMuseumOpens

A Grand Opening & Ribbon Cutting for the Douglas School is held with over 200 people in attendance

October2024

All HVAC components upgraded; interior lighting and attic sprinkler system replaced

debt schedule debt schedule

WINCHESTER SCHOOL FUND DEBT SCHEDULE

06/30/2028

06/30/2032

06/30/2039

roof summary roof summary

WPS SCHOOL ROOF SUMMARY*

School

Roof Type Yr Install Condition Future Work

Frederick Douglass Shingle New 2010 Excellent 2035

Garland Quarles

John Kerr

Virginia Ave Charlotte Dehart

Daniel Morgan Campus

John Handley

Shihadeh Innovation Center

The Douglas School

Vinyl (roof drains) New 2005 Poor 2028 (Renovation)

Slate New 1955 Fair 2028 (Renovation)

EPDM New 1997 Poor 2028 (Renovation) Asphalt New 1955 Poor 2028 (Renovation)

EPDM New 2016 Excellent 2045

EPDM New 2018 Excellent 2040 Shingle New 2021 Excellent 2051

Vinyl (Auditorium) Replaced 2023 Excellent 2045

EPDM (Main) New 2005 Good 2030

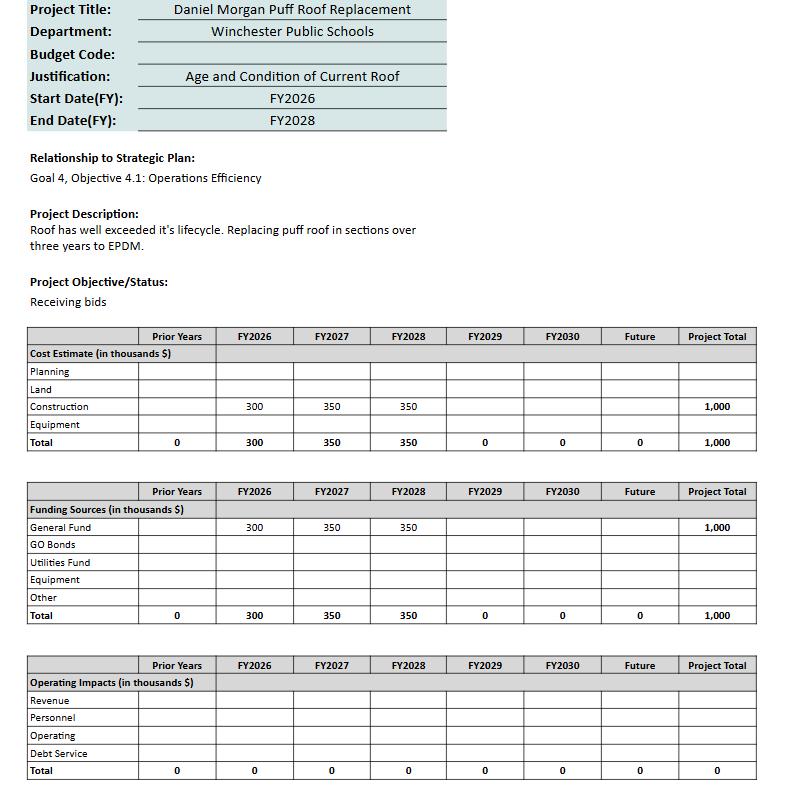

Puff (Original) Recoated 2013 Poor 2026 – Replace w/EPDM

EPDM (Fastened) New 2007 Good 2027-2030

EPDM (Ballast) New 2007 Good 2032 Shingle (Auditorium) New 2007 Good 2032

PVC Trim New 2023 Good 2075

EPDM (ballast) New 2015 Fair 2040

EPDM (new) New 2021 Excellent 2051

EPDM Renovated 2022 Excellent 2045

*Dates of future work have been determined based on the results of the Gordian Facility Condition Assessment

HVAC SUMMARY HVAC SUMMARY

WPS SCHOOL HVAC SUMMARY*

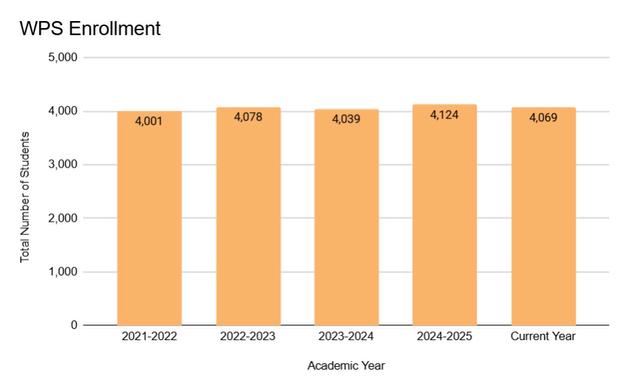

HISTORICAL ENROLLMENT

*Note: PreK Not Included (Current Year: 180)

PROJECTED ENROLLMENT

*Note: Weldon Cooper Center will update 2029-2030 Projections by Mid-January'26

PROJECTED ENROLLMENT

TOTAL ENROLLMENT TREND

facility condition assessment facility condition assessment

GORDIAN FACILITY CONDITION ASSESSMENT

In October 2024, Winchester Public Schools hired Gordian, Inc to conduct a Facility Condition Assessment (FCA) for all of the school district buildings. A FCA is a systematic evaluation of the physical state of school buildings and campuses Its purpose is to provide school districts with an objective understanding of how well their facilities are performing, what deficiencies exist, and what capital investments are needed to maintain safe, functional, and educationally supportive environments.

Major Findings:

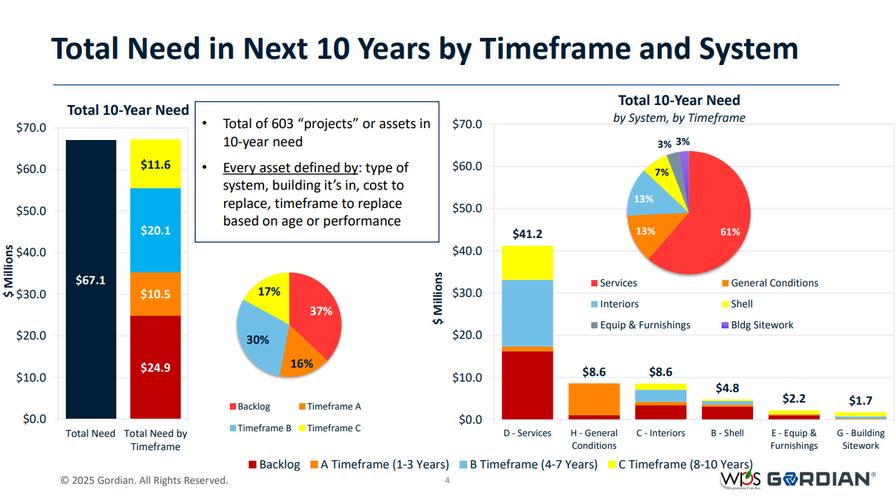

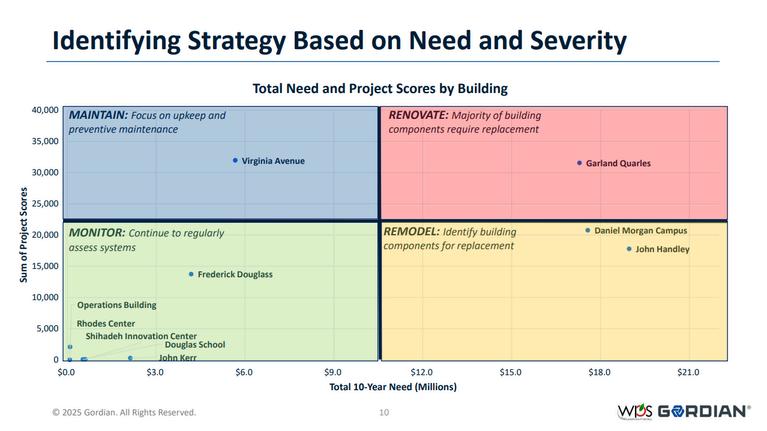

Garland R Quarles Elementary School is in need of a significant renovation or replacement. Other WPS buildings are in a healthy phase on par with other Gordian school districts. The total budget needed to address 603 projects over the next 10 years is $67.1 million. This includes a $24 9 million backlog of needs that are past due 61% of items are in the “Services” category, which includes electrical, HVAC, and plumbing.

GORDIAN FACILITY CONDITION ASSESSMENT

Gordian’s presentation to the Winchester Public School Board is available on Board Docs.

PROJECT SUMMARY PROJECT SUMMARY

MAJOR PROJECTS COMPLETED IN 2024-2025

Virginia Avenue Charlotte DeHart Elementary School: A new playgound, spider tower, and security fencing were installed at VACDES and a sidewalk was replaced.

John Kerr Elementary School: To prepare for the new Early Childhood Special Education program at JKES, classroom furniture was purchased and a new adaptive playground –designed by Handley students – was installed.

Frederick Douglass Elementary School: The special needs playgorund at FDES was updated.

Melvin Rhodes

Alternative Education Center: Upgraded security cameras were installed.

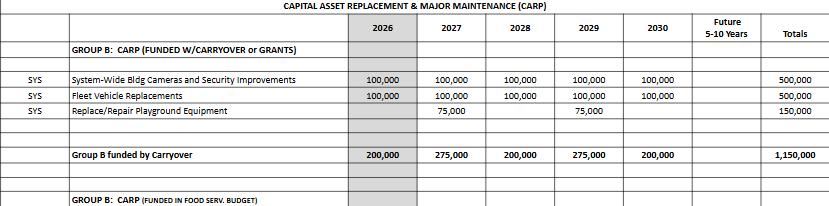

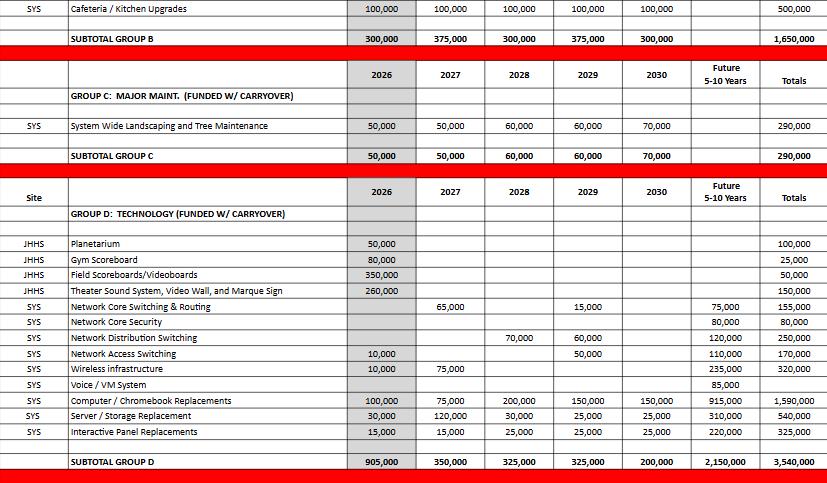

upcoming projects upcoming projects

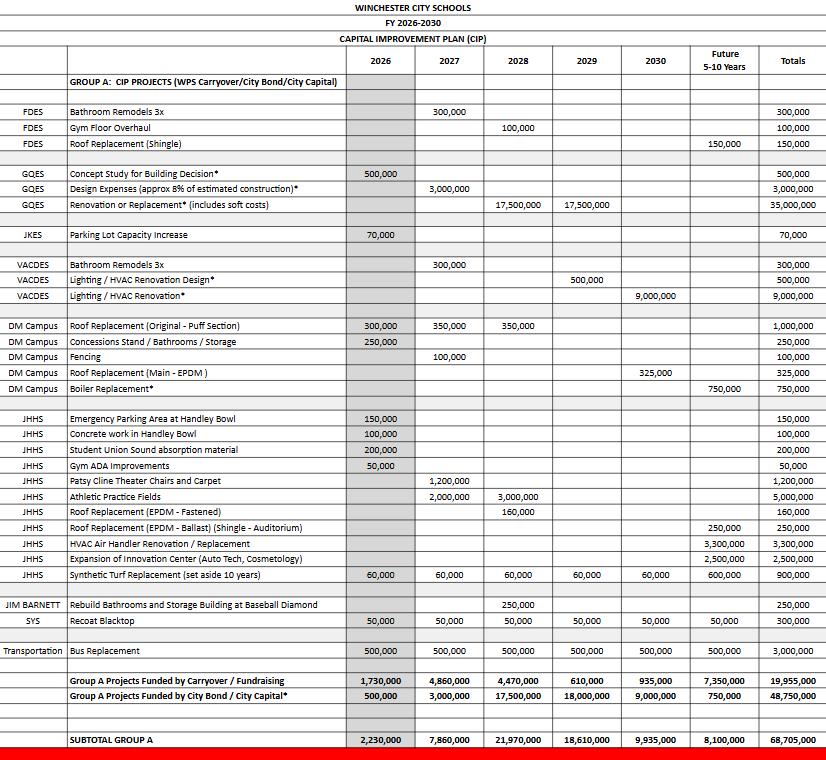

MAJOR UPCOMING PROJECTS

WPS is now better equipped to prioritize projects in the Capital Improvement Plan using datainformed decision-making. Using the information provided by Gordian’s Facility Condition Assessment, backlogged projects are prioritized, followed by those in the 1–3 year timeframe It is important to note that not all deferred maintenance in the backlog is critical; while some assets are at the end of their lifecycle and their maintenance or replacement is deferred, they may remain fully operational and the project is therefore not immediately essential. Additional selected projects that have been identified by WPS are also included.

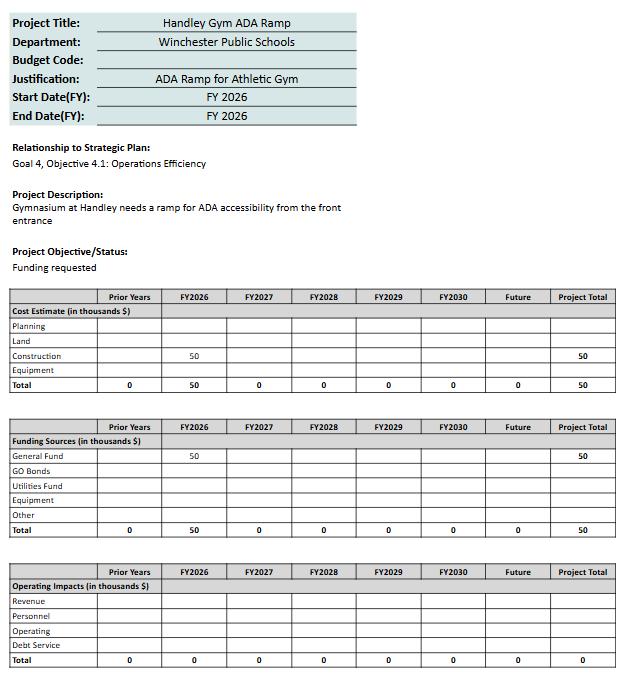

YEAR PROJECT

GQES Renovation - Concept Study

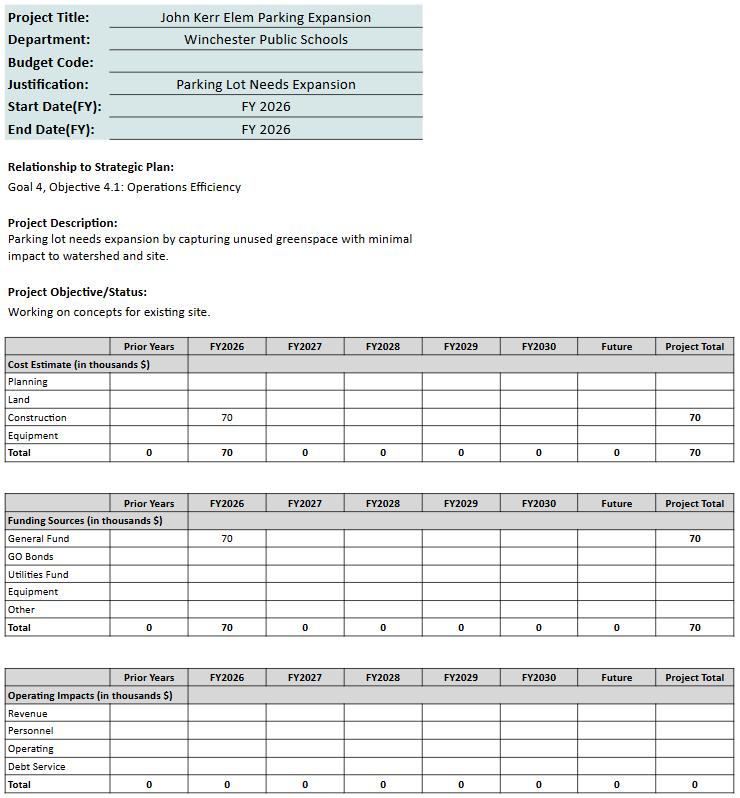

JKES Parking Lot Capacity Increase

DM Original Roof (Sec 1 & 2)

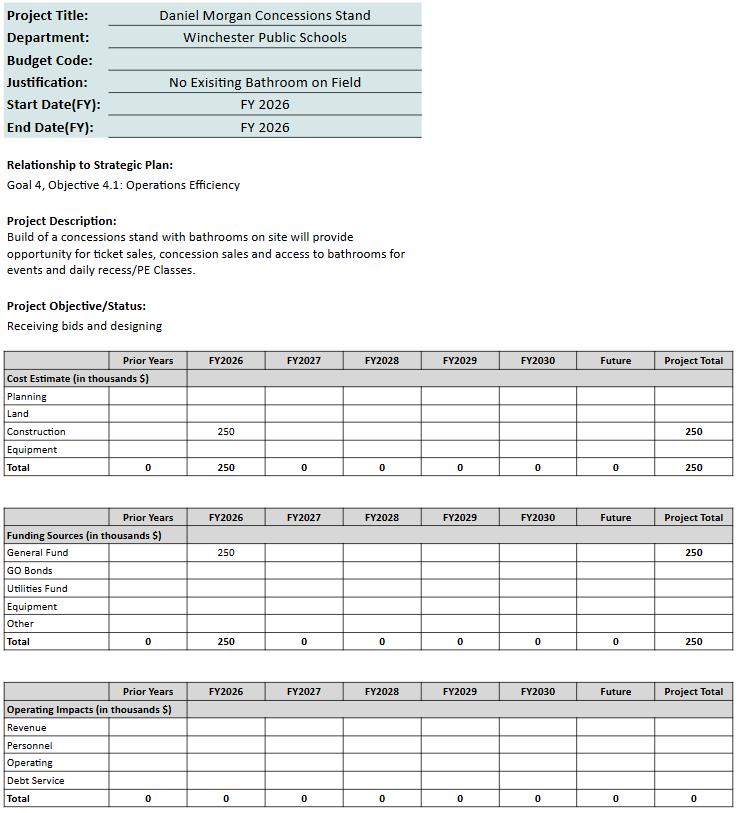

DM Concession Stand/Bathrooms

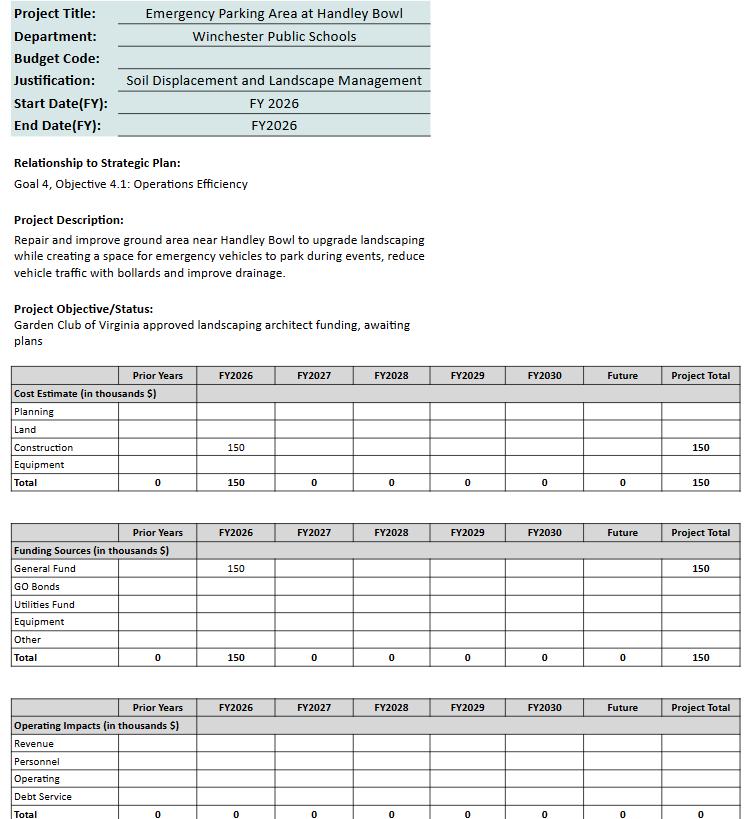

Handley Emergency Parking

Handley Bowl Concrete

FY26

FY27

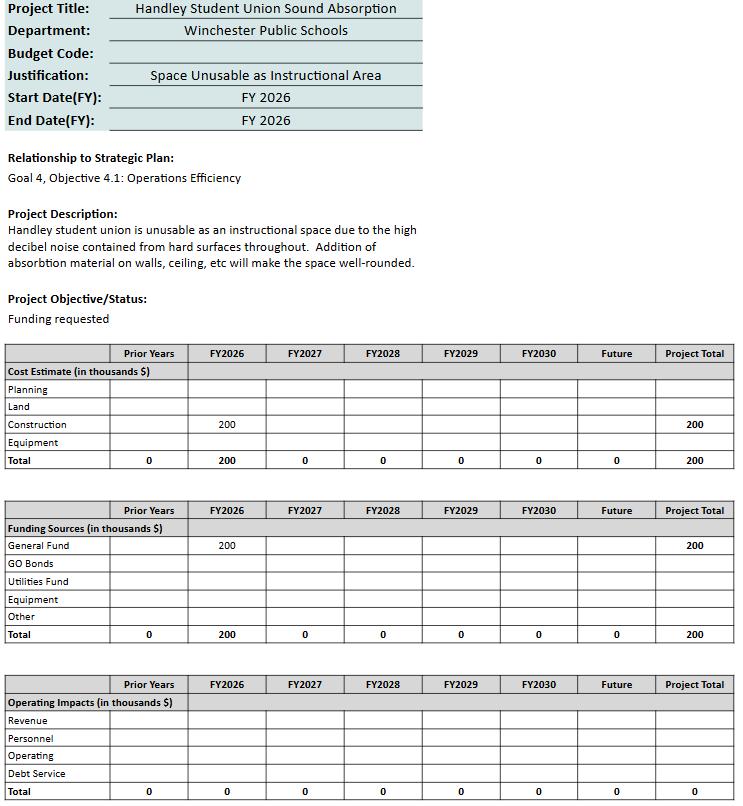

Handley Student Union Sound Absorption

Handley Gym ADA Access

Handley Planetarium

Handley Gym Scoreboard

Handley Football Video Scoreboard

Handley Theatre Sound, Video Wall, Marquee Sign

FDES Bathrooms

GQES Design

VACDES Bathrooms

DMMS Roof (Sec 3 & 4)

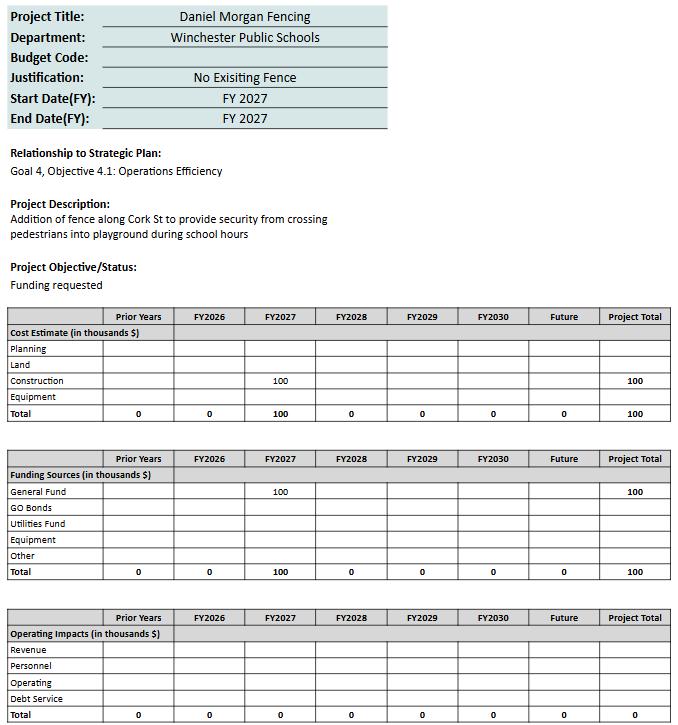

DMMS Fencing

JHHS Patsy Cline Theatre Seats

JHHS Athletic Practice Facility

FDES Gym Floor

GQES Construction (1 of 2)

DMMS Roof (Sec 5, 6 & 7)

FY28

JHHS Athletic Practice Facility

JHHS Roof Replacement

Jim Barnett Bathroom Rebuild

$500,000

$70,000

$300,000

$250,000

$150,000

$100,000

$200,000

$50,000

$50,000

$80,000

$350,000

$260,000

$300,000

$3,000,000

$300,000

$350,000

$100,000

$1,200,000

$2,000,000

$100,000

$17,500,000

$350,000

$3,000,000

$160,000

$250,000

Garland R Quarles Elementary School

TheoriginalportionofGarlandR. QuarlesElementarySchoolwas builtin1955.In1997,awingwas addedtothebuildingandthe originalportionreceivedminor renovations

GQESisinneedofasignificant renovationorreplacementandwill undergoaconceptstudywithan architecturefirmtodetermine capabilitywiththesite.

Aftertherenovationorreplacement ofQuarlesiscomplete, considerationwillbegiventothe potentialrealignmentofgrade levels Thismayincludemovingfifth gradebacktotheelementary schools,butnodecisionshavebeen madeatthetimeofthisreport.

budget budget

Budgetcontinuedonnextpage.

Turn static files into dynamic content formats.

Create a flipbook
