International Research Journal of Engineering and Technology (IRJET) e ISSN:2395 0056
Volume: 09 Issue: 05 | May 2022 www.irjet.net p ISSN:2395 0072
![]()
International Research Journal of Engineering and Technology (IRJET) e ISSN:2395 0056
Volume: 09 Issue: 05 | May 2022 www.irjet.net p ISSN:2395 0072
1Department of Civil Engineering, Shri Sant Gadge baba college of Engineering and Technology, Bhusawal, Maharashtra, India
2Professor Department of Civil Engineering, Shri Sant Gadge baba college of Engineering and Technology, Bhusawal, Maharashtra, India ***
Cost increase refers to the changes occurring in price of specific materials services in a very given economy over a amount of your time. Trade |housing industry |industry} may be a most intricate and dynamic industry that is consistently facing uncertainties. The assorted factors that cause increase in industry area unit studied and mentioned within the article. The concepts advised by researches were additionally analysed andaccordingprice increase will be reduced to a bigger extent by rigorously adopting the remedial live. This study presents a study of price increase in unit worth in construction contracts. The aim is to analyse why the ultimate price of contracts differs from the in agreement contract price following tendering, each to spot causes of discovered discrepancies and to counsel measures that might improve the look and delivery of future comes. Road comes usually accommodates manycontracts andas theyaccount for the most important prices of the comes, price increase within the contracts might increase the chance of project cost. Notwithstanding contract price performance is a very important indicator of project success, it's going to be too oversimplifiedtoequate this with project success. It’s quite potential to deliver a project among budget notwithstanding contract prices intensify, as long because the project price contingency is equal to cowl such escalations. However, escalations in contracts increase the chance of project overrun and will result in alternative issues like conflicts and delays. The results show that the majority of the studied contracts older price increase. The most reasonfor the increase was amendment orders tothe scope that weren't coated by the initial contract. Additionally, the results indicate that quality diagrammatic by contract size, duration, and concrete locationwillincreasethe chanceandsizeofcost.
Price Overrun; social control Skills; Labour price; Materialprice;Contractor;Performance.
In usually, construction comes area unit typically of quite long from many months to many years. Also, constructioncomesareaunitperformedinkeepingwith a pre confirmed contract quantity and contract agreementinessence.Therefore,there'sarobustchance that the price of labour and materials can rise and fall sporadically,toa biggerorlesser extent,throughoutthe lifetime of the project. Thus, most contractors ought to bear extensive injury at that point, because of the fast rise of international raw materials or exchange rates underneathapaymentorfixed pricecontract.Therefore, theprovisionsconcerningcontractworthincreaseought toberearrangedsystemicallytodealwiththefastworth changes.
1. ‘Escalation’maybeatermutilizedinmostcountries, topointtheextentofthosechangesfromthe
2. Commencement of a project through any purpose throughout its life. As equivalent terms, fluctuations’, ‘rise and fall’ and ‘contract worth adjustment’ area unit usedinterchangeably.
3. price increase is outlined as changes within the price or worth of specific product or services in a very given economyoveraamountofyourtime.Itreferstotherise withinthequantityofcashneededtoconstructaproject overandhigherthantheinitial budgetedquantity.price increase happens once actual prices exceed antecedent calculablevalues.
Escalation within the construction market in recent years has been extraordinarily volatile, and this trend is predicted to continue within the close to future because of competition for resources and sure handed employees, moreover as continued robust growth and excess work accessible. This example has created an excellent deal of uncertainty and nervousness among project homeowners WHO have received bids that area unit considerably over budgets that were set before the recent market increase. Project homeowners area unit sweet facedwitharestrictedrangeofselections,noneof
International Research Journal of Engineering and Technology (IRJET) e ISSN:2395 0056
Volume: 09 Issue: 05 | May 2022 www.irjet.net p ISSN:2395 0072
that area unit typically terribly palatable: golf shot their comes on hold within the hopes that the costs can eventually settle go into reverse to pre 2004 levels; researching a design method to bring the project back underneath antecedent established budgets; or somehow finding extra funding to hide the missing funds. Finding ways to each quantify and manage price increase on a personal project is so important for homeowners and contractors so as to make sure that there are a unit spare funds to deliver the ultimate programinbudgetandonschedule.
Escalationisthattheprovisionwithinthepriceestimate for will increase withinthe price of kit, material,labour, etc., because of continued worth changes over the time. Increaseisemployedtoestimatethelongertermpriceof a project or to bring historical prices to this. Increase maybeariskthatmayaccountforaconsiderableapart of construction price, particularly in long run comes wherever the variability and uncertainty is bigger. so there's a desire to assess the chance of price increase in constructionprograms.
Here lies the importance of learning and understanding the assorted aspects and ideas associated with “Cost Escalation”andtoproposenewandchangedtheoriesso thisfieldinclinestowardsaccuracyandperfection.
This study evaluates the assorted procedures and techniques used for foretelling the increase in costs within the industry. The study reflects ways by that participants in construction comes will each track the extent of increase and work along to reduce the impact ofpriceincreaseonthesuccessofaproject.
The thesis throws lightweight on varied existing and ancient ways that area unit being employed in computation of price increase within the industry. This study proposes new approaches and ways that may be enforced in Asian nation within the field of price increase, so the assorted errors, complexities and ambiguity within the still prevailing techniques can be removed. These projected ways are mentioned thoroughly with the assistance of illustrative examples andworldwideevidencesthatprovetheircredibility.
The intention of the client while floating a tender is to obtain a minimum bid price from various contractors applying for tender, with optimal quality as per specification, for a client to expect a minimum bid from the contractor client should either share the risk involved in the contract or reduce the risk factor from the contract so that the contractor will not consider the riskfactorwhilebiddingforthetender.Duetoeconomic un stabilitywecanseealargefluctuationinthepricesof
the construction material and hence the need for the effective method for the calculation of cost escalation in constructioncontractsaccuratelyisstronglyfelt.
The various escalation formula and provisions which have already been discussed lack in either of the things listed below due to which we are unable to attain the accurateescalationcostofmaterials.
1. Therateofescalationiscalculatedbylinkingitwith the Wholesale Price Index (WPI), the Consumer PriceIndex(CPI)andthepriceofthedieselonlyfor POL but the WPI and CPI do not truly reflect the price variation in any specific industry including construction, its material and wages of construction labour.
2. The price index calculated is based upon Lapsers, PaschaandFisherIdealIndex.Ithasnotbeenclearly established which of the three methods used to calculate price index is accurate under various circumstances.
3. In the calculation of WPI about 447 distinct items are considered and out of the total weightage of 1000only257or26%ofthetotalarerelevanttothe constructionindustry.
4. Escalationformulahavebeenseparatelyestablished only for materials such as Cement, Steel and POL whichisabout45%ofthetotalmaterialcostandthe remaining 55% of the material is covered under a generalformula.
5. Every construction project is unique and it is inappropriate to apply the General indices such as WPI or CPI rather specific indices developed sector wiseandregionalwisewillbemoreaccurate.
6. The formula used for the calculation of the escalationcostneedsfurtherimprovisationtoattain accurateresults.
The term “Escalation” suggests that associate “increase that counteracts associate unjust discrepancy between the worth of a product and also the value of the materials”. It’s the supply of “the changes {of prices of values} proportionately and typically sporadically associated mechanically to an alteration (as a rise) withinthecostofmaterials,or{a similaranidentical an associate analogous |the same} adjustment of wages to an alteration within the value of living”. during a works contract, it'd mean a rise within the value of associate item of labour over and on top of the speed stipulated withinthetender,throughouttheamountofthecontract
International Research Journal of Engineering and Technology (IRJET) e ISSN:2395 0056
Volume: 09 Issue: 05 | May 2022 www.irjet.net p ISSN:2395 0072
andperthestep upclausesalsobecausetheformulaein this.
The major inputs during a project like Material, Labour, Plant&instrumentality,TransportationandEnergyarea unit liable to step up, as incontestable by the figure below:

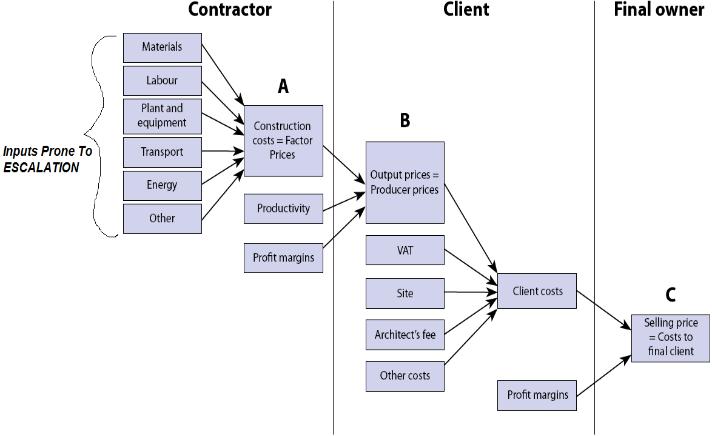

Structureofatypicalconstructionproject
Escalation is caused by several factors like inflation, market conditions, risk allocation clauses within the contract,chargeperunitandtaxes.
A number of things area unit accountable for the recent willincreasewithinthevalueofconstruction.
*Theforemostimmediateproblemsareaunitcurrently:
*Therecentmajornaturaldisasters
*willincreaseinmaterialvalue
*Bidmarketdisruptions
*Thehighvolumeofconstructionwork
*Theregulativeclimate
Upcoming problems which can increase the pressure on value even additional embody coherence within the international economy, associate ever growing demand for construction work, and a shortage of labour as additionalandadditionaltrainedemployeesretirewhile notnewemployeestoswitchthem.
Factors that result in value step up area unit aforementionedtoincorporateamongothers:
*Thescaleoftheproject
*Projectscopeenlargement
*Inflation
*Lengthofyourtimetocompletetheproject
*Unityofpreliminaryengineeringandamount
*Surveys
*Engineeringuncertainties
*Exogenousdelays
*Complexitiesofbodystructures
*Ignoranceofbodypersonnel
Coststep upisadditionalcombinedbyfactorssuchas:
*Projectlocation
*Projectconditions
*Environmentalmitigationprices
*Suspensionofworks
*Strikes
*Poorcoordinationonwebsite
*Endofbid
*Governmentpressures
*Politicalseparation
*Transportationissues
Factors like failure to arrange for adequate personnel, poor understanding of native labour practices and dynamical or unclear labour laws may also result in valuestep up.
Studies additionally indicate that poor management would cause value step up however stress that poor project execution caused by management deficiencies is typicallynotthefirstdriverofprojectvaluestep up.
Inprinciple,constructionworkisperformedperthepre confirmed contract quantity and contract agreement underneath a lump sum contract. There is also some changesineconomic
Conditions, like sharp fluctuation of costs, however, supported that the development contract is administered over an extended amount. To address the chance, most countries regulated the step up clause within the law or conditions relating to construction contract, accepted ‘circumstance alteration principle’, that is one in all the judicial principles. The ‘circumstance alterationprinciple’statesthatifasudden modification of social circumstance, that is tough to forecast earlier, happened when sign language a contract, once imposing and maintaining the contract resultinunfairresults,thelegalimpactofthecontractis also altered and terminated to address the new circumstances.
International Research Journal of Engineering and Technology (IRJET) e ISSN:2395 0056
Volume: 09 Issue: 05 | May 2022 www.irjet.net p ISSN:2395 0072
The on top of clause documented to alter the contract quantity during a construction contract, thanks to the modificationinvalue,istermedassociatestep upClause.
The basic principle for value step up clause is to compensate a contractor for increase in construction value throughout the contract amount. It’s tough, but to workoutexactlythequantumofactualincreaseinvalue asconstructionactivitiesareaunitmultifacetedinnature andinvolveseveralpartiesmaterialsandequipment’s
The principle that the contractorhasto be remunerated for increase in prices over the tendered costs thanks to increase in labour wages, value of politico and alternative materials is currently absolutely accepted. Completely different government organisations, however, adopted varied formulae and coupled them withtheentireSalepricelevel,shopperpricelevel,value of Petrol/ Diesel etc. compiled and printed by Government sporadically. because the range of comes supported by the globe Bank exaggerated, model tender documentssupportedInternationalCompetitiveBidding (ICB) or native Competitive Bidding (LCB) procedures werecompiledbythegovernmentandrecommendedfor adoption within the numerous International Bank for ReconstructionandDevelopmentassisted comeswithin the country. The globe Bank tender documents offer for compensating contractors for will increase within the valueofmaterials,labourandpoliticooverandontopof those stipulated within the base amount. Separate provisions area unit created within the step up for interchange and native elements of prices. Chilling the speed of exchange of foreign currency is additionally providedlately.
The workplace of the Economic authority (OEA), Ministry of business compiles Wholesale price level (WPI) Numbers for all India, on weekly basis. The WPI series, aboard 1981 82, coated altogether 447 commodities. The sector wise hack of forty four7 commodities is I) primary articles ninety three (food articles 44, non food articles twenty eight, minerals 21); ii) fuel, power, light weight and lubricants 20; iii) factory made products 334. In all 2,371 quotations of wholesale costs in respect of 447 commodities were collected, on weekly basis, through official also as non official sources. The official sources area unit board of directors of political economy and Statistics, Ministry of Agriculture; Agricultural selling Departments of Central and State Governments, State Directorates of political economy and Statistics, District applied math Offices, Registrars of Co operative Societies and alternative primary agencies happiness to varied State Governments. The non official sources area unit
numerous chambers of commerce, trade associations, leading makers and outstanding business homes. The weights of things were appointed in proportion to their share within the total price of dealings (output) within theeconomy.
The WPI Numbers for numerous commodities in conjunction with salient options area unit free through Press Note, on weekly basis. The intermission in unharnessoftheindexis 2 weeks.Witha readto revise the bottom year (1981 82) of WPI, a working party was discovered by the Ministry of business. The working partysubmitteditsreportbacktothegovt.andtherefore the same has been accepted. The working party has counselledforshifting the bottomyear(1981 82)ofthe seriesto1993 94.
TheMinistryofbusinessstartedcathartictheWPIseries aboard 1993 94 from Apr, 2000. The series covers altogether435commodities.Thesector wisebreakupof Commoditiesis

(i) Primary articles 98 (food articles 54, Non food articles 25, minerals 19) (ii) fuel, power, light weight & lubricants 19(iii)factory madeproducts 318.
International Research Journal of Engineering and Technology (IRJET) e ISSN:2395 0056
Volume: 09 Issue: 05 | May 2022 www.irjet.net p ISSN:2395 0072
in all probability saved Rs. 5.23 Crores, from the contractor’s purpose of read. If the workings would are done through the CCI technique, then it might have fetchedagainofRs.22.23Crores. Thiscanbeamassive quantity that is entirely lost within the game of construction contractor ship, simply because of the present impractical and obscure techniques and ancient procedures.
There are several different drawbacks that the development comes suffer because of the pitfalls of the presentsystem.
* It’s been ascertained unceasingly over the years, that thepresentwaysdon'tyieldapracticalpriceofthestep upquantity.Theworthobtainedfromthenormalwaysis found to be a lot of less than the worth of step up truly incurred throughout the project. Hence, loss for the contractor.
* Now a days, the contractors became attentive to the actual fact that the present step up formulae wouldn't yieldthemoneytrulyincurredbecauseofvaluestep up. Consequently.It’sbeenfoundthatthecontractorsaddan additional lump sum quantity of their own want and apprehension, to their bid proposals throughout the bidding method for any construction project, inspire of the existence of step up clauses within the tender documents. This action ends up in impractical bids. The client/bid judge isn't able to choose the bid proposals because of the variations within the bid values from totally different bidding contractors. Hence, ambiguity for the client/bid judge further as improvement of the danger of losing the bid for the bidding contractor is formed,becauseofinconceivableandnon competentbid proposals.
This thesis propagates such new approaches that attempt to minimize these pitfalls within the existing system. The study presents the new ideas that are punctually even and proved with the assistance of illustrative examples, actual case studies and worldwide evidences that support these new approaches in each approachthey'll.
This study, as a contribution to the event of the Indian housingindustry,urgesthat it's timeforAsian nation to run off the normal theoretic theories and adopt the pragmatic and pioneering new approaches of constructionpricestep upworkings.
As a section of the analysis work and thesis, the study has evolved ground breaking ideas and new revolutionarymethodologiesassociatedwiththissubject that may purge the snags and hitches related to price step upinhousingindustryandinterninclineittowards perfection.
1. Construction Briefings Magazine, Thomson West, EaganAuthors:JohnGallagherandFrankRiggs(Partners within the Construction observe cluster at the Atlanta workplaceofTroutmanSanders)
2. FieldManualforroadandBridgeEngineers.
3. ConstructionWorldMagazine,India
4. AACE International Transactions Report 2007, Glenn C.Butts
5. New approach to shrewd project price variance, Ching HwangWang,Yu ChunHuang
6. National Taiwan University of Science and Technology,P.O.Box90 130,Taipei,Taiwan
7. Escalation:whatproportionisenough?SenatorButts, CCC
8. regular army Corps of Engineers Manual, thirty first March2000(Manual1110 2 1304)
9. price step up and schedule delays in construction comes in African nation, Chabota Kaliba , Mundia Muya, KanyukaMumba
10. Info systems project escalation: a reinterpretation supportedchoicestheory,MarkKeila,HunFlattob
11. Compilation of shopper worth Indices (CPI) and Wholesalepricelevel(WPI)inRepublicofIndia
12. G.D.Sharma, Joint Director, Central applied math Organization, Ministry of Statistics and Programme Implementation,NewDelhi,INDIA
13. Statistical Analysis of Construction price Index mistreatment ripple Transformation and a Neural Network Hana Nam, Seung Heon Han dynasty, Hyoungkwan Kim Asst academician Yonsei University KoreanPeninsula
14. Sources and strategies Construction worth Indices Statistics
15. Statistics board, Organisation for Economic Co operationandDevelopment,Paris
16. Applied math workplace of the eu Community, Luxembourg
17. Step up factors poignant expenditure forecasts A report for Country Energy, Dr. Tom Hird Daniel Young June
International Research Journal of Engineering and Technology (IRJET) e ISSN:2395 0056
Volume: 09 Issue: 05 | May 2022 www.irjet.net p ISSN:2395 0072
18. Industry Development Council Website: WWW.cidc.in
19. Website:WWW.ghallabhansali.com
20. Depository financial institution of Republic of India Website:WWW.rbi.org.in
21. Workplace of the Economic authority, Ministry of Commerceandtrade,GovernmentofRepublicofIndia.
22. Central applied math Organisation, Ministry of Statistics and Programme Implementation, Government ofRepublicofIndia.
23. A Presentation created by academician. Niranjan Swarup,Convenorcomes,CIDC India
24. Step up Factors poignant Expenditure Forecasts, By Dr.TomHird&DanielYoung(June2009)
25. Press info Bureau, GOI Introduction of Revised seriesofIndexNumbers (April01,2000)
26. Compilation ofCPIand WPI inRepublicofIndia,By G.D. Sharma Joint Director, Central applied math Organisation,NewDelhi,India
27. price step up and Schedule Delays in construction comes in African nation, By Chabota Kaliba, Mundia Muya, Kanyuka Mumba University of African nation (July03,2008)
