COMPARISON BETWEEN CONVENTIONAL AND PREFABRICATED BUILDING USING PRIMAVERA

Page 1

International Research Journal of Engineering and Technology (IRJET) e-ISSN:2395-0056

Volume: 09 Issue: 10 | Oct 2022 www.irjet.net p-ISSN:2395-0072

COMPARISON

BETWEEN

CONVENTIONAL AND PREFABRICATED BUILDING USING PRIMAVERA

2

1M.TECH (CCT) Student, Civil Engineering Dept, Jain College of Engineering, Belagavi, Karnataka, India. 2 Assistant Professor, Civil Engineering Dept, Jain College of Engineering, Belagavi, Karnataka, India ***

Abstract – Primavera is a project-Management Software. It includes project management, scheduling, risk analysis, opportunity management, resource management, collaboration and control capabilities and integrates with other enterprises software such as oracle and SAP’s ERP systems.

The project is based on the comparison between conventionalandprefabricatedbuildingusingprimavera P6softwareconsideringG+4building

Key Words: Risk analysis, Resource management, Cost, Time

1. INTRODUCTION

ABOUT PRIMAVERA SOFTWARE

The original company’s name was primavera system and established in 1993 by Joel Kopple- men and Dick Faris in Philadelphia, USA. In 1988 software system started to develop in a server-based approach that allows primavera to act as a portfolio system. This is split into two version of software one is stand-alone versionusedforsmallprojects,thesecondisenterprise portfolio system this allows primavera to use throughout organizations to manage the projects. In 2008, Oracle brought primavera and turned into primavera Global Business unit. Primavera P6’s is the world’s largest Pharmaceutical, oil and gas, refinery infrastructureclientsandengineeringsuppliers.

ABOUT CONVENTIONAL BUILDING

Conventional construction method is an ordinary or a standard construction. It involves utility of traditional materials, and remains with a specific-parameters. Most of the conventional buildings are based on plans and measurements, as well as floor plans. While prefabricated construction needs less time same dependability as convectional construction. The advantage of conventional construction is that causes notwobuildingtobesameeachbuildingisconstructed individuallydesignedfromthegroundup.Conventional

buildings have more durability than a prefabricated building.

ABOUT PREFABRICATED BUILDING

Prefabricated building is a prefab building that is manufactured and constructed using prefabrication. It is factory made components that will be transported and assembledonsiteforabuilding.Buildingsarebuiltandin one place and can be reassembled in another place this wastrueformobileactivities.EliminaCastlethefirstslave from west Africa was the first European to build first prefabricated building. The world’s first prefabricated, precast panelled apartment blocks were pioneered in live pool.

1.1 OBJECTIVES

Themainobjectivesofthisstudyareasfollows  Tostudythedifferencebetweenconventionaland preconventionalbuildingsusingprimavera

1.2 LITERATURE REVIEW

Themainpurposeistostudyanddetermineconstraintsin adopting prefabrication in construction industry. To find the different methodology in both construction and to conclude which construction is best. Conventional constructionisoldmethodandprefabricatedconstruction isnewone.Wecanfindmanybuildingsareprefabricated.

In this paper they have considered G+7 to estimate the quantities of conventional building and prefabricated building. Estimation of quantities is done to find requirement of materials for both conventional and prefabricated. Hear both are considered and estimated how much quantity of materials needed for the construction. Project duration is also main important for completion of the project. Conventional building needs more time compare to prefabricated buildings. Cost analysis is determined by considering the resource, materials, labour and machineries. By considering these factors we can come to cost factor of both constructions. Datacollectionisalsomostimportantinproject.Fromthis

© 2022, IRJET | Impact Factor value: 7.529 | ISO 9001:2008 Certified Journal | Page287

International Research Journal of Engineering and Technology (IRJET) e-ISSN:2395-0056

Volume: 09 Issue: 10 | Oct 2022 www.irjet.net p-ISSN:2395-0072

paper we can come to know the difference between conventionalbuildingandprefabricatedbuilding

2. RESEARCH METHODOLOGY

The steps start with creating a project in primavera and creating a sequence of activities. After creating the project, the important thing is to add the dates, project planning start and must finish by. These dates will be givenduringthestartoftheproject,wegivethesedates accordingtoplanningitmaychangeduringconstruction ifdatechanges,wecanchangeinsoftware(fig2)

Fig-1: Methodology

Selecting the EPS in these eps we will select in which project our document is added, we can select according tousandwecangivenameswhichwillbeconvenientto us Afterselectingallthefactorsthenourprojectwillbe created.Aftercreatingtheproject,wecanproccedtoadd activities

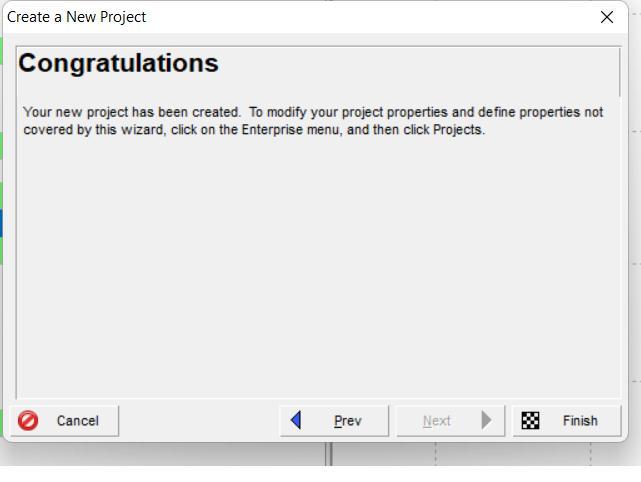

Fig-3: Completionofcreatingproject

2.1. WORK BREAKDOWN

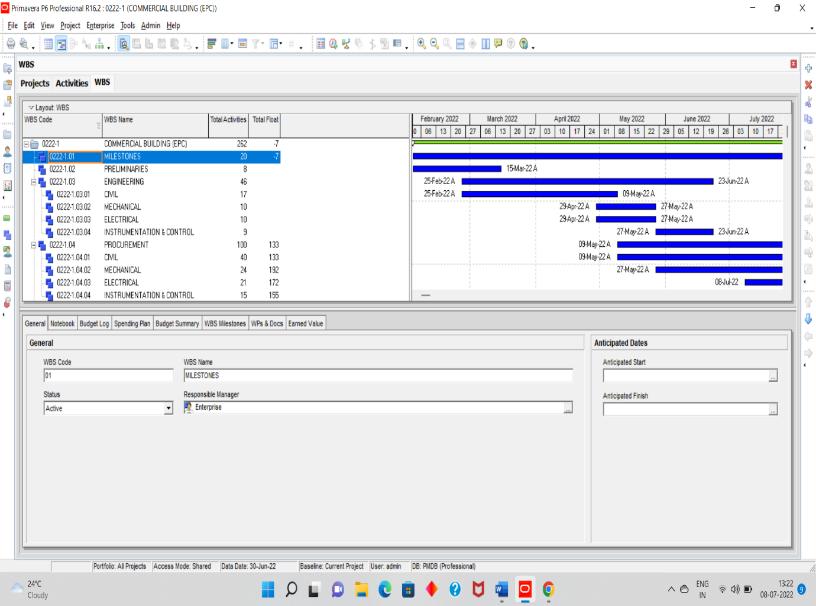

Work breakdown structure in primavera, in work breakdown structure works are divided into smaller parts or components. Work breakdown structure is key project that is deliverable to team’s work to the manageable section. In work breakdown structure it provides the brief information about the project, by seeing the work breakdown structure can understand the project. Breaking down the work and making them in parts and allotting to the different department to procced the work. By breaking down the work load it willbeeasytodothework

Fig-4: Workbreakdownofconventionalbuilding

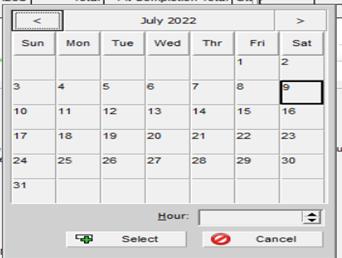

Fig-2: Enteringstartandenddates

©
Certified Journal | Page288
2022, IRJET | Impact Factor value: 7.529 | ISO 9001:2008

International Research Journal of Engineering and Technology (IRJET) e-ISSN:2395-0056

Volume: 09 Issue: 10 | Oct 2022 www.irjet.net p-ISSN:2395-0072

like grain magnitude distribution, specific gravity, consistency limit, compaction traits, shear substance componentsetc.aretabulated.

Fig-5: Workbreakdownofprefabricatedbuilding

2.1. Project Calendar

Calendars are used to make our work easy; calendar defines the workdays and workhours available in a day. In calendars we can add holidays like government holidays, festivals, if works are not present on those particular days in calendar. We can establish our own calendar according to our company’s work, we can assignresourcesandactivityoncalendars.

According to us and our work. Based on calendar resource will come to site before we should order the itemssothatitdeliversonthedaywhich wementioned onthecalendar.

Iftheworkisnotcompletedintimeoritisdelayedfrom certain reasons then we can change the dates in primavera.Thiscalendarmaychangeiftheresourceand laboursarenotavailableorduetoclimaticeffect.Before planningof the project,we considerthedatesaccording to our planning but it may vary during the construction time.

Fig-6:Activitiesoftheproject

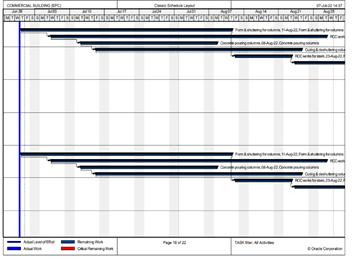

Network diagram shows the activities of the task, when we add activities, it shows the network diagram. Networkdiagramshowstheconnectivityoftheactivities which is liked to which activity it will be shown in network diagram, shows the sequence of the activity. The network diagram shows the relationship between activities.

Fig-6: ProjectCalendar

2.11. ADDING ACTIVITIES:

The clay accessed from location location proven to achieve different geotechnical features. The result is produced in the table 1. Different geotechnical features

Fig-7:NetworkDiagram

2.3. RESOURCE ALLOCATION

In primavera resource allocation of resource is important, for each activity which are the resource neededandwhichtypeofengineersneededtocomplete that particular task. Resource includes equipment, labours that are used for construction, these resources are based on the time and they are used in between activities. Creation of resource will be use full in the project and it makes work easy while construction. In primaverawecanaddtheresourcesiftheyarenotthere in the list, we can add units of the resource and we can add price of the resource which will be used for the

construction.

©
Page
2022, IRJET | Impact Factor value: 7.529 | ISO 9001:2008 Certified Journal |
289

International Research Journal of Engineering and Technology (IRJET) e-ISSN:2395-0056

Volume: 09 Issue: 10 | Oct 2022 www.irjet.net p-ISSN:2395-0072

Fig-8:Resourceallocation

Fig-9:MaterialResourceallocation

2.4. GANTT CHART

Gantt chat is a tool or a basic tool, it represents the

graphical representation of the project. By using Gantt chat we can understand the work easily, it is graphical representation of schedule, activity and time. From primavera software we can plan start and finish dates and chat will represent the dates according to our activities. In this we can add which colour we want to understand our activity, we can add bars, we can make settingsaccordingtoourchoice.

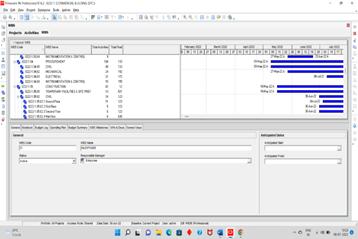

Fig-9:GanttChart

3. ESTIMATION OF THE PROJECT

Cost of the conventional building is taken from the commercialbuildingmentionedinthecasestudy.Which helpsustodiscovercostofthebuilding,thesubstructure cost relatively equal in two constructions. The superstructure cost will vary the cost of prefabricated structure will be more as compared to conventional building.

Table-1:ConventionalBuilding

Table-2: PrefabrictedBuilding

© 2022,
|
| ISO
Certified Journal | Page290
IRJET
Impact Factor value: 7.529
9001:2008

International Research Journal of Engineering and Technology (IRJET) e-ISSN:2395-0056

Volume: 09 Issue: 10 | Oct 2022 www.irjet.net p-ISSN:2395-0072

4. RESULTS

By comparing conventional building and prefabricated building we can know that prefabricated building will be constructed in lesser time, but conventional building needs moretime.

Prefabricated building needs less materials as comparedtoconventionalbuilding.

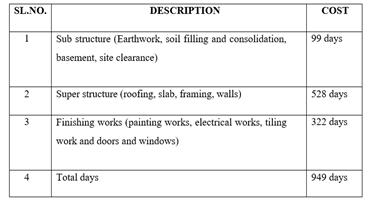

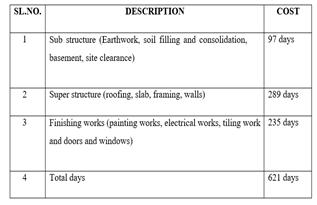

Table-3: EstimationtimeofConventionalBuilding

When we compare cost of both buildings the cost of prefabricated building is 77,50,000 and conventionalbuildingis64,00,000.

As we compare cost of prefabricated and conventional buildings, prefabricated building costmorethanaconventionalbuilding.Byusing primavera software when we compare the days conventional building needs more days as compared to prefabricated building. The cost of prefabricated building is more due to structural steel and equipment cost is more manpower is used less and machinery work will be more in prefabricatedbuilding.

Table-4: EstimationtimeofPrefabricatedBuilding Cost Estimation Graph

Conventional building is traditional type of construction where it needs more man power, morematerials,needsmoretimebutcostisless ascomparedtoprefabricatedbuilding.

Inboththeconstructiontypesdifferenttypesof activitiesareaddednotsimilartype.

Foreachactivitytimeanddatesareprovidedso that the work completes within the time of scheduling.

The lifespan of both buildings is comparatively same.

The approximately budget made for the two buildings based on the planning and scheduling oftheproject.

If we have more time and budget amount then we can go for the conventional type of construction or else if we have less time and more budget then we can go for prefabricated typeofconstruction.

© 2022, IRJET | Impact Factor value: 7.529 | ISO 9001:2008 Certified Journal | Page291

Estimation of duration

2395-0056

2395-0072

COST AND TIME GRAPH OF PREFABRICATED BUILDING

6. CONCLUSION

From the project we can know that by using primavera software it’s easy to plan and schedule theproject.

Primavera helps us to estimate the project time, cost,materialsandlaboursusedforconstruction.

Consideringtwobuildingsinprimaverascheduling and planning and assigning the resources, there are two types of resources materials and labours wecanassigntheresourcesaccordingtoouruse.

The activity needs which kind of materials or equipment by considering that we can assign the resource.

Primavera software helps us to save time and manage the project in proper way in the constructionofaproject

By using primavera software, we can understand thecriticalpaththathelpsustoidentifythecritical activityandwecandoitinabetterway.

While construction we can face many problems like design, planning etc, by using primavera we cancoordinateonthepersonspresentonthesite.

Whenwecompareconventionalandprefabricated building, we can understand the difference between them. In conventional building it is a traditional method which is coming from ancient time, whereas prefabricated construction method is a new method of construction which needs less timetoconstruct.

The lifespan of both buildings is comparatively same,themaindifferenceisthattimeandcost.

International Research Journal of Engineering and Technology (IRJET) e-ISSN:
© 2022, IRJET | Impact Factor value: 7.529 | ISO 9001:2008 Certified Journal | Page292 5. COST
SOFTWARE
costofprefabricated
5.1.
Volume: 09 Issue: 10 | Oct 2022 www.irjet.net p-ISSN:
ESTIMATION FROM PRIMAVERA
Fig10:costofconventionalbuilding Fig11:
building
COST AND TIME OF CONVENTIONAL BUILDING 5.2.

International Research Journal of Engineering and Technology (IRJET) e-ISSN:2395-0056

Volume: 09 Issue: 10 | Oct 2022 www.irjet.net p-ISSN:2395-0072

From estimation we can know that prefabricated building needs less time and more cost, whereas the conventional building needs more time and less cost as compared to the prefabricated building. 

In prefabricated building there are many new techniques used for construction of prefabricated buildings, machines are used more but in conventional building machines and labours are usedinequal. 

From this project we can conclude that both construction methods are good but we have more timewecangoforconventionalconstruction,ifwe have lesser time then we can go for prefabricated construction method the cost will be more in prefabricated construction method as the steel rateismore.

7. REFERENCES

[1] Time Analysis of Pre-Engineered Building with Conventional Steel Building by using Primavera P62019

[2] Study The Application Of Primavera In Planning And Scheduling Of Prefabrication Technology UsedInConstruction

BIOGRAPHIES

AishwaryaKiresurM.TECH(CCT) Student,CivilEngineeringDept, JainCollegeofEngineering,Belagavi, Karnataka,India

ShashankUVanakudari Professor,CivilEngineeringDept, JainCollegeofEngineering, Belagavi,Karnataka,India.

©
| Page293
2022, IRJET | Impact Factor value: 7.529 | ISO 9001:2008 Certified Journal
