Optimization in Supply Logistics Cost of Construction Projects of a Company

Page 1

Optimization in Supply Logistics Cost of Construction Projects of a Company

Lakshana.P1 , Luke Judson2

Abstract - The contribution of construction materials may account 50-65 % of the project cost due to inefficiency of logistics strategies for congested site in urban areas, the supply logistics cost of material raises from 17-25% goes till 49% of supply logistics cost. As a solution to this, tier 1 cities implemented the strategy of just in time with a consolidation center. However, cities of tier 2 and tier 3 still raising concern of supply logistics cost of congested site in urban areas and a consolidation center cannot be the solution for the single contractor. So suggested methodology is just-in-time with the intermediate warehouse by the contractor. Thus, it is of high essence that material resources are managed properly to reduce cost, achieve timely project delivery at the budgeted cost and quality through logistics strategies. This paper proposes the optimization strategy and evaluating criteria of the attributes in the supply logistics cost of the strategy with fixed, semi fixed, variable cost. The study further takes the supply logistics cost of a 3 projects of a same company to develop the methodology and to provide recommendations.

Key Words: Material management, supply logistics, optimization in logistics cost, transportation cost structure, warehousing cost structure.

1. Introduction:

Materials management is defined as "a whole concept encompassinganorganizationalstructureintegratingintoa single responsibility, the systematic supply and control of resources from demand identification through customer delivery." The contribution of construction materials may account 50 - 65 % of the project cost. The delivery service cost will account for roughly 17%-25% of the material cost, i.e., the physical distribution expense will approximate 10%-11% of the engineering project construction cost, indicating that physical distribution activity in engineering construction projects has a significant economic influence. (ChenDuiyong,2014)

This idea includes material functions such as planning, scheduling, purchasing, storing, transporting, and distributing.Productionandinventorycontrol,buying,and physicaldistributionarealldisciplinesthatarerepresented. (Klooster)

Throughthisstudy,optimizationofsupplylogisticscostinof acompanywillbeanalyzed,assessedandmethodologyare proposed to identify the attributes of Transportation and warehousinginlogisticscoststructureandidentificationof methodstoevaluatetheattributesand analysesandasses the attributes in the case study to provide a structured methodology of cost optimization for intermediate warehouse.

1.1 Material Management

1.1.1 Material classification

Materials can be classified into different categories dependingontheirtypeandsizeweneedorusetechnique onsite.

Type of material

Bulkmaterial

E.g.

Concrete,sand

Baggedmaterial cement

Pelletedmaterials

Packagedmaterial

Loosematerials

Doors,frames

Tiles,pipes,electricalfittings

Reinforcement bars, glass panels

1.1.2 Management of material resources

Theemphasisofmaterialsmanagementisthemanagement ofmaterialresources.Itassessesmaterialcostsandmakes efforts to reduce them. The essential cost of resources, accordingtoclassicalphilosophy,isthecostofgettingthem. However, in today's environment, materials management takes into account not only the cost of materials, but also theircosts.Thismeansthatmaterialcostsandmaterialcosts shouldbereducedtoaminimum.Thesematerialexpenses aretypicallyconcealedand arenot labeled as"materials." Instead,theyarelabeledas"overheads,""scrap,""storage," andsoon.(AshwinPatil,2013)

International Research Journal of Engineering and Technology (IRJET) e-ISSN: 2395-0056 Volume: 10 Issue: 03 | Mar 2023 www.irjet.net p-ISSN: 2395-0072 © 2023, IRJET | Impact Factor value: 8.226 | ISO 9001:2008 Certified Journal | Page357
1 Student of Department of Building Engineering and Management, 2 Faculty of Department of Building Engineering and Management, School of planning and architecture & 4, Block B, Beside State Bank Of India, Indraprashta Marg, IP Estate, New Delhi, Delhi 110002, India
***
Table 1Material classification (Adithya A.Pande, 2016)

Theprimarygoalofmaterialsmanagementistominimize anyhiddenmaterialexpenses,regardlessofhowtheyappear inthelogisticscost.

Mostspecificmaterialsimpactedintheconstructioncostare Concrete,Cement,Steel,Aggregates,BrickworkandFlooring

1.2 Logistics Introduction

Contractors are typically merely single connections in logisticchainsthatdeliveritems,services,information,and financingtoaproject.Incontrasttotheindustrialindustries, whichbenefitfromlong-termcollaboration,Incomparison tosuppliersandconsumers,buildinglogisticsnetworksare farmorecomplicatedtomonitorandoptimize. (M.Muya1)

1.2.1 Types of Logistics strategies

 JustinTimeTechnique/Pullsystem

o Justintimewithconsolidationcentre/just intimebysuppliers

 Just in case/ Push system (Construction ConsolidationCentres,2016)

1.2.2 Logistics cost

Thelogisticscost(LC)inthebuildingconstructionprojectis calculated as the Summation of the transportation cost, orderingcost,inventorycost,anddamagecost.

LC=CT+CO+CI+CD

Insomeprojecttransportationcostishigh.Sotounderstand the cost percentage of transportation cost, ordering cost, inventorycost,damagecostis49%-57%,9.9%-15%,11.5%24.5%, 15 %. (Amornsawadwatana, Logistics Costs EvaluationinBuildingConstructionProject)

Table 2 Types of cost associated with offsite logistics

Costs associated

Offsite Logistics

Transport Cost of inputs required for placing andmaintainingthe vehicle on the road (Licensing,taxes)

Type of cost

SemiFixed

Labor (Driver cost andpackerscost) Variable

Vehicle cost –

Preference type of vehicleforquantity

Semi Fixed/ Variable

Maintenance cost of vehicles(oilcharges, tirechargecleaning), Fuelcost

Transportation to storage Loading and Unloading through equipment/labor

Warehouse –handling

Variable

SemiFixed

Warehousesetup SemiFixed if congested site, land cost rent to store materials + Transportationfrom warehouse to constructionsite

SemiFixed

Labor-security SemiFixed

Maintenance cost –

Electricitybill Variable

1.2.3 Attributes

To assess the suitability of attributes in implementing a logisticstrategyinaparticularstudy.

Table 3 Resource consumption during storage (Author)

Logistics process Category Resource

Storageatsupplieryard Labour Worker(handling)

Equipment Handlingtruck Material stocking

Storage at intermediate warehouse

Capital Rent

Table 4 Resource consumption of transportation from supplier to construction site (Author)

Logistics process Category Resource

Transportation (to constructionsite)

Labour Truckdriver Inspector

Equipment Truck Material

Transportation (to intermediate warehouse)

Labor Truckdriver Inspector

Equipment Truck Material

International Research Journal of Engineering and Technology (IRJET) e-ISSN: 2395-0056 Volume: 10 Issue: 03 | Mar 2023 www.irjet.net p-ISSN: 2395-0072 © 2023, IRJET | Impact Factor value: 8.226 | ISO 9001:2008 Certified Journal | Page358

Logisticsprocess Category Resource

Loadingandfix Labour Worker(handling)

Equipment MobileCrane

On-sitestorage stocking Truckdriver Inspector

Capital Opportunitycostfrozen inon-sitestocking

2. Case study data collection and analysis

2.1 Introduction

The nachimaar engineering consultant is a construction company that deals with several projects in the southern region of Tamil Nadu. For a further understanding of optimizingcost,threecasestudieshavebeentakenfromthe same company which are located in Thirunelveli, Thiruchirapalli, and Thanjavur. The case study sites are located in the urban areas. The company procure the materials directly and store it in the construction site without any intermediate warehouse. Due to space constraintthesematerialsareprocuredevery20-25days. Furtherdetailsofcasestudywillbebrushed.

Table 6 Case study Details (Author) Description

In the case study 1, material cost about 63.4% of total constructioncost.Inwhichhalf(36.6%)ofthecostarebulk materials and pelleted materials. concrete takes 17.1% of materialcost.Thesitecanstoreonlyfor2-3days.

In the case study 2, material cost about 55.4% of total constructioncost.Inwhichhalf(36.6%)ofthecostarebulk materials.concretetakes19.4%ofmaterialcostthesitecan storeonlyfor5days

In the case study 3, material cost about 53.7% of total constructioncost.Inwhichhalf(36.6%)ofthecostarebulk materials,concretetakes18.1%ofmaterialcost.Thesitecan storeonlyfor5days.

Using the Just in time strategy, the bulk materials are ordered and stored directly in the site warehouse by a company

2.1.1 Supply of materials of case studies for 3 months

Table 7 Supply of materials of each project for 3 months (Author)

The supply materials for first 3 months are taken. The quantitiesarecalculatedasper BOQ,schedule ofthe each projectandfirst2projectsstartsinthesamemonthand3rd casestudystartsafter2months.

2.1.2

The Percentage of logistics cost from the materials cost is 27.7%,45%,30.79%forsite1,site2andsite3respectively.

International Research Journal of Engineering and Technology (IRJET) e-ISSN: 2395-0056 Volume: 10 Issue: 03 | Mar 2023 www.irjet.net p-ISSN: 2395-0072 © 2023, IRJET | Impact Factor value: 8.226 | ISO 9001:2008 Certified Journal | Page359
Table 5 Resource consumption during loading, fixing and on-site storage (Author)
Case
Case
Case
Project Commercial Mall with Multi Level CarParking Conventional center(G+3) Mall Building (G+2) Location Near Pallai Bus Stand, Tirunelveli,Tamil Nadu
Nagercoil, Kanyakumari Total Estimated Cost INR39.48Crore INR10Crore INR 20.73 Crore Total 16,455sq.m 4645sq.m 9629sq.m Items % of total amount in civil cost Cement 8.5 % 11.7% 9.7% Steel 22.7 % 29.2% 24.8% Aggregate 13.6 % 17.6% 15.5%
study 1
study 2
study 3 Nameofthe
Near Main Junction, Trichy,Tamil Nadu
Project site Cement Aggregates Steel Thirunelveli 929246 kg18585bags 3466349kg 310MT Trichy 265499 kg –5310bags 990385kg 89 MT Thanjavur 546615 kg –10932bags 2039029kg 182MT
Material Logisticscost of site 1 Logistics cost site 2 Logistics cost site 3 Cement, aggregate and steel 14677842 12004227 11789038
Logistics cost from Plant to site (Author)

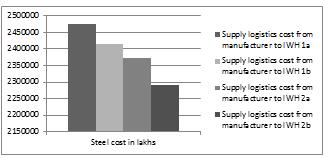

2.1.3 Details of plants of cement, aggregate and steel

The warehouse has been selected on the basis of transportationroutefrom manufacturing/plant/quarryto site,security,rentalrate,laboravailability,distancefromthe site.

2.1.5 Location of site, warehouse, cement, aggregate and steel

Theconstructionsitesarelocatedinthecenterof thecity whichprohibitsthetravelofHGVvehiclesintheparticular timeat11pmto5am.Sothewarehousecentersaretakenin thehighwayroadaround50kmsawaywhichwillreducethe rentalrentalso.

2.1.4 Location and distance details of plants from warehouse

The company is procuring the cement from the branded cementfactoryandaggregatesareprocuredfromthenear quarries. Even though there is availability of local brands plants in Tamil Nadu, the company prefers from JSW and Tatasteels.

2.1.6 Type of Vehicle, dimensions and Rentalrate

International Research Journal of Engineering and Technology (IRJET) e-ISSN: 2395-0056 Volume: 10 Issue: 03 | Mar 2023 www.irjet.net p-ISSN: 2395-0072 © 2023, IRJET | Impact Factor value: 8.226 | ISO 9001:2008 Certified Journal | Page360
Table 8 Intermediate Warehouse Distance
Name Distance from intermediate warehousetositewarehouse(km) Site1 Site2 Site3 Keezhapur near ariyalur. 355 66 43 Thuraiyur, near salem totrichyroad. 337 50 94
(Author)
Plant Location Distance from intermediate warehouse1 Kms Distancefrom intermediate warehouse2 Kms Cement India cement Perambalur, TamilNadu 43 94 Dalmia cement, Dalmiapuram, TamilNadu 32 66 Aggregate Govt stone quarry 242 208 Thiruvakkarai Rd, Tamil Nadu 162 173 Steel Jsw Lal Bagh Main Rd, Bengaluru, Karnataka 354 305 Tata Race Course, 271 203
Coimbatore,
Table 9 Location and Distance Details of plants (Author)
Gopalapuram,
Tamil Nadu 641018
10
and
Vehicle body type Construction facilities other than construction sites at which used Rate weight Tipper Truck –HGV Quarries,mines 90,0001,10,000 9.8*2.4*2.8 65cu.m Capacity :16-28ton Tipper truckLGV Intermediate warehousetosite 86,000 3.8*2.4*3.5 Capacity : 10-12ton Flatbed-HGV Products from processing facilities and to/frombuilders’ merchants and storagefacilities 83,000 26 ton – L 12m 12 ton – L 8m
Table
Type of Vehicle, dimensions
Rental rate(Author)

2.1.7 Vehicle Type and Labour Charges

The labor charges for a driver are given in 2 ways one is lumpsumandotherwayiskmperway.Lumpsumrateper trip by truck driver is 10,000 – 30,000 depends upon distance travel, location and type of HGV vehicle they driving.

Table 11 Vehicle Type and Labour Charges (Author)

Vehiclebodytype Distance travel per day Labour Rate

HGV 100-150km/day 50/kmor7.4/hr

LGV Upto400km/day 30/kmor3.2/hr

2.1.8 Rental rate

Rentalratedependsonthearea,landrentonthelocation.

Table 12 Rental cost of warehouse(Author)

2.2 Total logistics cost are

Supply logistics = TC(CC(semifixedcost)+CV(variable cost)) +WC(CC(semifixedcost)+CV(variablecost))+LC (CC(semifixedcost)+CV(variablecost)) Thecostincrease, causedbyachangeinleadtimeofprocessesandordercycle time.Thecostincreasecausedbyachangeincargoturnover andstocklevel.

2.2.1 Analysis

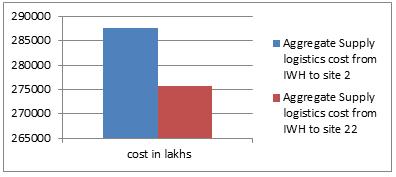

2.2.1.1 Cost from supplier to intermediate warehouse

2.2.1.2

International Research Journal of Engineering and Technology (IRJET) e-ISSN: 2395-0056 Volume: 10 Issue: 03 | Mar 2023 www.irjet.net p-ISSN: 2395-0072 © 2023, IRJET | Impact Factor value: 8.226 | ISO 9001:2008 Certified Journal | Page361
Warehouse Rent/month Total cost for 3 months Warehouse1 60,000 1,80,000 Warehouse2 83,000 2,49,000

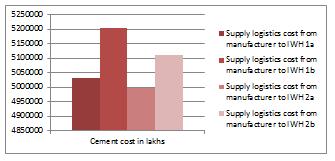

of supply logistics Figure 1 Cement supply logistics cost from manufacturing plants to Intermediate warehouses (Author) Figure 2 Aggregate supply logistics cost from manufacturing plant to Intermediate warehouse (Author) Figure 3 Steel supply logistics cost from manufacturing plant to Intermediate warehouse (Author) Cost intermediate warehouse to site Figure 4 Cement supply logistics cost from Intermediate warehouses to site 1 (Author) Figure 5 Aggregate supply logistics cost from Intermediate warehouses to site 2 (Author)

Thelogisticscostofthesite withintermediatewarehouse reducesthelogisticscostby7%-19%fromthiscase.When compared with each scenario, the price of transportation fromquarries/plantstoanintermediatewarehousebyroad indicated a potential optimal plan. These elements can be capturedbydefiningappropriatenumberofvariousdecision variablessuchasdistance,fastestroute,timetakentoreach thedestination,andvehiclesize.Theresultsshowedthatthe percentagesavinginlogisticscostandthefeasiblesolutionis obtained from 16 possible routes (refer above table). The leastpossiblerouteis4-5%lesserthantheotherroutes.

4. Recommended Methodology for Logistics cost

Thispapercontainstheconcludingremarksforthecompany whichdealswithseveralconstructionprojectsincongested siteinaurbanarea.Transportationvehiclesizeforcarrying thebulkmaterialsof 1700–6000ton useHGVofmedium sized can transport comparatively in lesser cost of 3-8% thanhighsizedofHGVduetoitsperdaytravelconstraint which may increase the no of hours travel due to that maintenance and fuel charges will be high. if we take low sizedHGVvehicle,speedofthevehicleincreasebutthenoof transport increase so the transport vehicles rate takes doublethetimes.

Intermediatewarehousingcanbeplacedatthedistanceof 150 km maximum for easy shipping from intermediate to site,thenwhichwillbetravelledthroughLGVs.soitcanhave lessernooftripsgenerated.

5. Conclusion

The conclusions drawn for the optimization of supply logistics cost which to answer the company with several projects in congested site in a urban area and it can be concluded using recommending a logistic strategy just in timewithintermediatewarehouseforacompanywhichhas several projects in the same areas. It is concluded by identifying the appropriate approaches for intermediate warehouseandthetransportationbyfindingandevaluating the attributes in the logistics cost with fixed, semi fixed, variablecoststudyasabase.

Theabovethemethodologyofjustintimewithintermediate strategy will help to understand the variables of cost in transportationandwarehousinginthelogisticscostandthe percentageofsupplylogisticscostreduced.Thisstudyhas gone as far as a review of transportation cost and warehousing cost from supplier to site via intermediate warehousingofaprojectofsamecompany.Thus,itcanbe concludedthatthisdissertationpaperdevelopsavaluable methodologyforevaluatingthelogisticscostofcompany.

6. References

1. Construction Consolidation Centres. (2016).London: Transportforlondon.

2. Abdallah,H.(2004). Guidelines for Assessing costs in a logistics system. Unites States Agency for InternationalDevelopement.

3. Adithya A.Pande, S. (2016). Study of material managementtechniquesonconstructionprojects. International Journal of informative & futuristic research

4. Aiswarya Sreekumar, D. P. (n.d.). Sustainable Retrofit for Adaptive Building Reuse–A Facility

International Research Journal of Engineering and Technology (IRJET) e-ISSN: 2395-0056 Volume: 10 Issue: 03 | Mar 2023 www.irjet.net p-ISSN: 2395-0072 © 2023, IRJET | Impact Factor value: 8.226 | ISO 9001:2008 Certified Journal | Page362

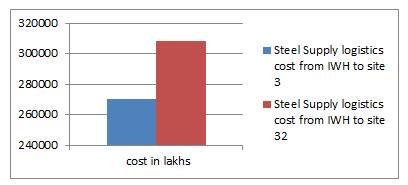

Figure 6 Steel supply logistics cost from Intermediate warehouses to site 3 (Author)
