COMPARATIVE STUDY OF ACTUAL AND CRASHED SCHEDULE OF BUILDING USING MSP
Sanjay Jagadeshwara E1, Dr. Nagaraj P S21Mtech Student (Construction Technology), University Visvesvaraya College of Engineering, Bangalore University, Bengaluru
2Professor, Civil Engineering Dept. University Visvesvaraya College of Engineering, Bangalore University, Bengaluru ***
Abstract - Project management is main stream which overall makes a civil industry worth into existence in accordance with the control on constraints such as time and cost. This paper will mainly help out to differentiate actual and crashed schedule and their behavioral improvements in time according to the relative cost. Microsoft project software is used to enhance the scheduling adding Crashing, Slack time and alternative building material to the work planning activity. Crashing makes a proper inventory behavioral time benefits from the overtime of huge workforce and improvement in the duration of an activity using slack time in software. An alteration with the cost is maintained which helpful in retrogression of overall costs of the project.
The main aim is to reduce the improved development period from new time and to meet a specific deadline. The main motivation behind this project is to reduce time using crashing and slack (Time Optimization).For cost optimization alternative building material is used to reduce the cost and making project more well-organized and inexpensive.
Key Words: scheduling and crashing, crashing trials, alternative material and techniques, crash ability, cost slope.
1. INTRODUCTION
• Everyonewantstobemoreconservativewhenitcomesintotimeconstraint.
• Shorterdurationworkshouldbedonegivingmoreprofitableresults.
• Manyprojectshavesomeriskanduncertaintieswhichwenotconsideritorallybutitcomesintoaccountwhenwe executeitpracticallywhichmakesincreaseintime,costandoverallocationofresources.
• ToOvercome,PlanningandSchedulingaredoneandtohavecrashedscheduleFollowingMethodsareused
CrashingOfanActivity.
CrashingUsingMicrosoftProject.
SlackTime.
Iftimeisofsecondaryconcern,eachactivitycouldbeperformedatitslowestpossiblenormalcost.Ifcostisofsecondary importance,eachactivitycouldbespeededuptobecompletedintheleastcrashtime.Betweenthesetwolimitsliesthebestor optimalsolution.However,tofindsuchsolution,itrequirestheconsiderationofcomplexcollectionofconcurrent,interrelated, andoverlappingactivities.
Inordertocountertheunforeseendelays,Projectmanagementistheapplicationofknowledge,skill,toolsandtechniquesto project activities to meet the project requirements. The primary focus of this research is to compare actual and crashed schedulebyenhancingtheschedulethroughCrashing,SlacktimeandalternativeTechniquestotheworkplanningactivity usingMSP.
2. METHODOLOGY
1. DataCollection.

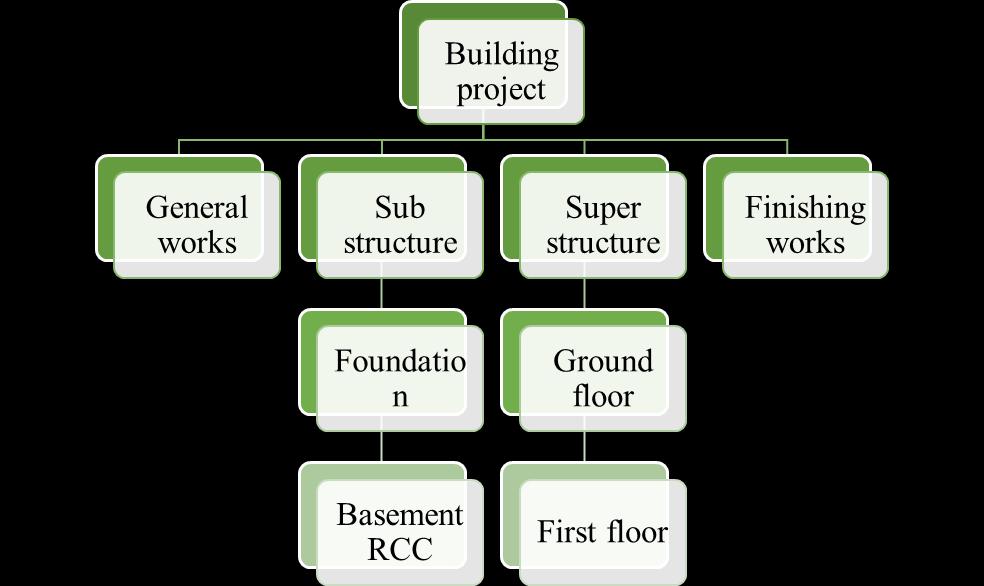

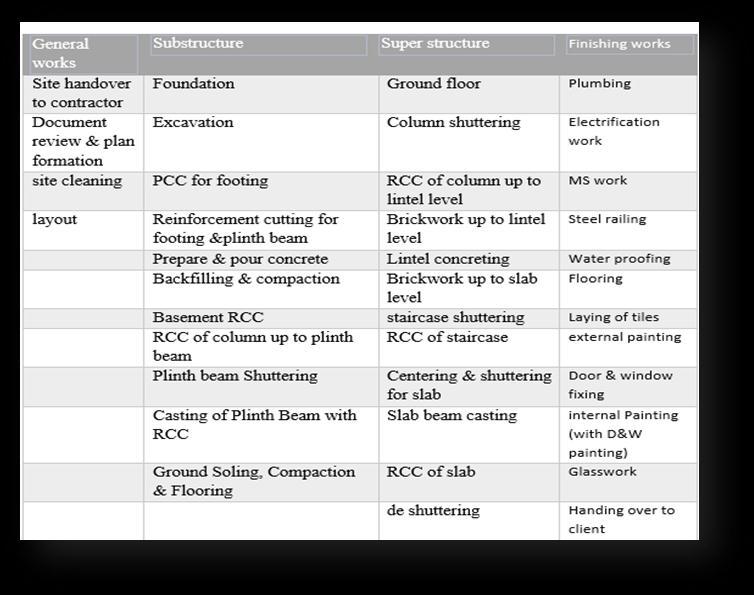

2. Workbreakdownstructure.
3. Maximumdurationisapplied.
4. AddingResources.
5. AssigningResources.
Crashingusingovertime.
Slacktimeforoptimization.
Time&CostoptimizationusingAlternativeBuildingMaterialandTechniques.
6. ResultshowingTimeandCostOptimization.
7. Comparingactualandcrashedscheduleoftheproject.
3. PROJECT CASE STUDY
• Theresidentialprojectoftwofloors(G+1)signedbythecompanyfor8monthsiscompleted.Clientwantedhisproject tobecompletedinshorttime,accordinglyconstructionwasdonebythecompany.
• Inmyopinionthetimescheduleoftheprojecttoreachclientsatisfactioncanbereducedfurthermoreandcanobtain thebiggestprofitfromthisproject.SoIreplannedtheprojectandtriedtomakeadifferencetoshowhowtogetthe maximumprofitbycrashing.
• TheprojectlocatedinHulimangala,Bangaloresouth,andit’sabout1200sqft.
• Structure Builtuparea
Groundfloor 772.00sqft
Parkingarea 330.00sqft
Firstfloor 1102.00sqft
Theratebeforecrashing₹3,506,362/-,innumbers(Thirtyfivelakhsixtythreethousandsixtytworupeesonly).
4. PROJECT PLANNING
• ProjectPlanningisageneralandmostcommonterminconstructionmanagementwhichreferstoattaintheexpected goalsanddestinations.Planningisthekeytobringtheexpectedprojectsintorealityorinexistence
5. SCHEDULING AND CRASHING OF PROJECT
Thescheduleisatooloratechnicofeveryprojectmanagementteamwhichisusedandpracticedtopredictmost probableprojectcompletiontimeandthusenablingthein/ontimeresourcesconceptionwhicharebudgetedonthe particularwork.
Thenormaldurationoftheproject is228days

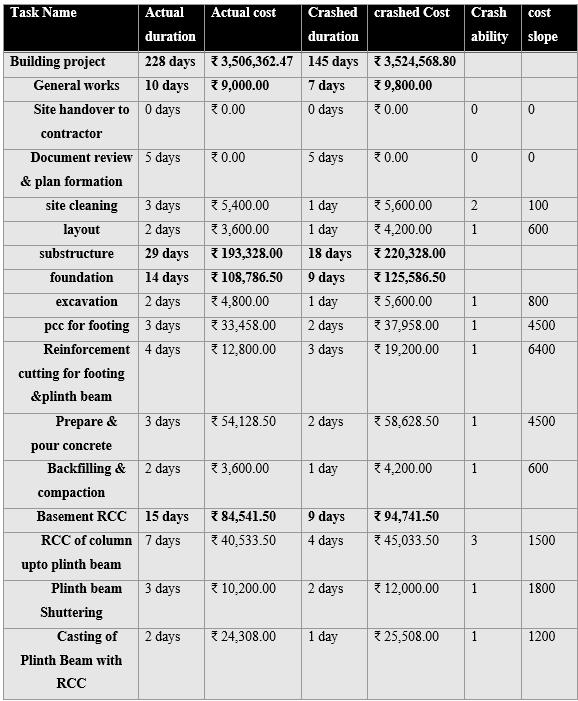

5.1 DURATION CRASHING

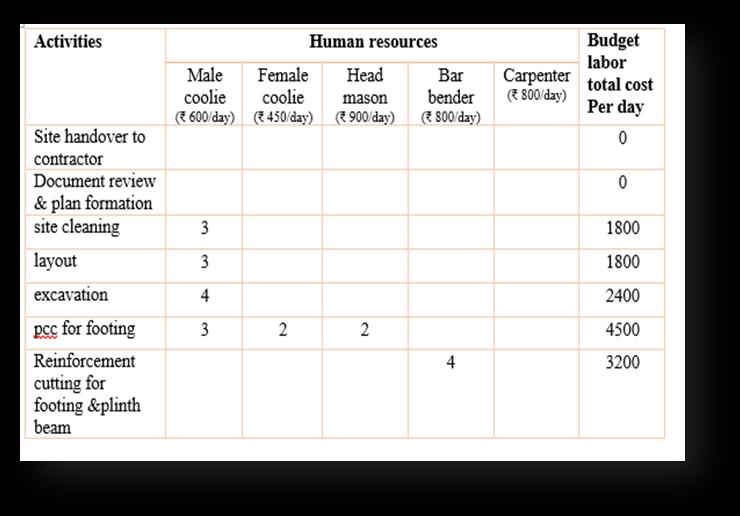

Tofinishthisactivity,thecrewshouldbeformedfrom7Labors,PCC&mixer.So,weassumedtohave1crewwith budgettotalcost/day=4500rupees Wefoundthatthiscrewwith100%productivitywillfinishtherequiredamount ofworkin3days.
Totallaborcost=4500x3=13500rupees
Materialcost(PCC&mixer)=19958rupees
Thereforetotalamountrequiredforthisactivityis 33458 rupees.
Crashing; nowweassumedwehave2crewsbutwefoundthatiftheonecrewgiveproductivityof100%,thetwo crews won’t get a completion rate by 200% due to crowdedness and the lack of supervisors and other considerations.Soweassumedthatifwehave2crewtheproductivitywillincreaseby160%to170% Sothisactivitywillbefinishedin2dayswithatotalcostof 37958 rupees
ThemainapproachesforcrashingofanactivityinMicrosoftprojectis:
1.Apportioningadditionalresourcestotheprojectwhichmakeseasywayforcrashingofanactivity.
2.Overtimeallocatedtotheresourcesmainlyhumanresource.
3.Hiringadditionalresources.
4.ForEarlycompletionextrapayments.
5.2 ALTERNATIVE BUILDING MATERIAL AND TECHNIQUE
• Alternatematerialandtechniquenotonlycrashthetimebutalsocutsdowntheoverallcost
Rat trap bond
Rattrapbondisacavitywallconstructionandleadstoreductioninthequantityofbricksrequiredformasonrywork
ByadoptingthismethodofbondingofbrickmasonrycomparedtotraditionalEnglish/Flemishbondmasonry,itis possibletoreduceinthematerialcostofbricksby25%and10%to15%inthemasonrycost.
Thecavityinredtrapbondprovideseffectivethermalandsoundinsulation.
Plank & Joist Roofing System
PrecastRCCPlankandJoistisasystemwhichconsistsoftwotypesofprecaststructuralelementsPlank(whichislike asmallcomponentofabiggerroofslab)andJoist.Afterplacingprecastelements,in-situconcreteisplacedtogiveflat surface
Thetechnologycanproveeconomicalifthenumberofplanksandjoistsaremore- suchasinthecaseofa2or3 storiedbuildings.
Cost - Overall cost reduction by 15-20% because of reduction in steel consumption and because of faster roof constructiononcethewallsarecomplete.Itdoesn’trequireanymaterialforshutteringduringconstruction
Time- Saves construction time – the slab can be ready in 2-3 days as compared to at least 14-21 days for a conventionalRCCslab
Quality-Centralizedproductionprovidesabetter,durableandconsistentqualityroofascomparedtothequalityof conventionalRCCroofsinmountainregions
Polycarbonate glass
Polycarbonateisamaterialwhichcontainsagroupofcarbonatesintheirchemicallybuildstructure.Polycarbonateis mainlyassimilartoaconventionaltransparentglassbutinflexibleasplastic.Polycarbonateglassiseasilyinstalled, cutandeasilyavailableinribbedsinglesheetorflattwin-wallthicknesses.
Useofpolycarbonatesheetismuchlesserthanthecostoftoughenedglass.Polycarbonatesheetislightweight,good fireresistant,provideUVprotectionandhashighimpactresistance.

5.2 PROJECT CRASHING METHOD
TheProjectCrashingmethodwasusedtofindtheoptimumdurationandminimumcostoftheproject.Theprocedure forshorteningprojectdurationcanbesummarizedinthefollowingsteps:
Drawtheprojectnetworkdiagram.
CPMcalculationsandidentifythecriticalpath,usenormaldurationsandcostsforallactivities.
Computethecostslopeforeachactivityfromthefollowingequation: cost slope = crash cost – normal cost / normal duration – crash duration
Startbyshorteningtheactivitydurationonthecriticalpathwhichhastheleastcostslopeandnotbeenshortenedto itscrashduration.
Reducethedurationofthecriticalactivitieswithleastcostslopeuntilitscrashdurationisreachedoruntilthecritical pathchanges..
The cost increase due to activity shortening is calculated as the cost slope multiplied by the time of time units shortened.
Continueuntilnofurthershorteningispossible,andthenthecrashpointisreached.
Thisistheprojectdirect-cost/timerelationship.Byaddingtheprojectindirectcosttothiscurvetoobtaintheproject time/costcurve.Thiscurvegivestheoptimumdurationandminimumcost.
Crash ability & cost slope
5.3.1 DIRECT AND INDIRECT COST
Directcost:Normalcostwhichwillbeassignedontoaselectedworkpackageorprojectactivity
Directcost=3506362rupees
Indirectcost:Cost thatcan’tberelatedtoanyparticularworkpackageorprojectactivity
Engineer=20000/month
Supervisor=18000/month
Guard=11000/month
SoifweestimatethetotalsupervisorysalariesinMonthwillbe=49000rupees.
Indirectcostperday=1633.33rupees
5.3.2 CRASHING TRIALS
Indirectcostoftheproject=228*1633.33=372400rupees
6. RESULT AND DISCUSSION
Result for Time Optimization

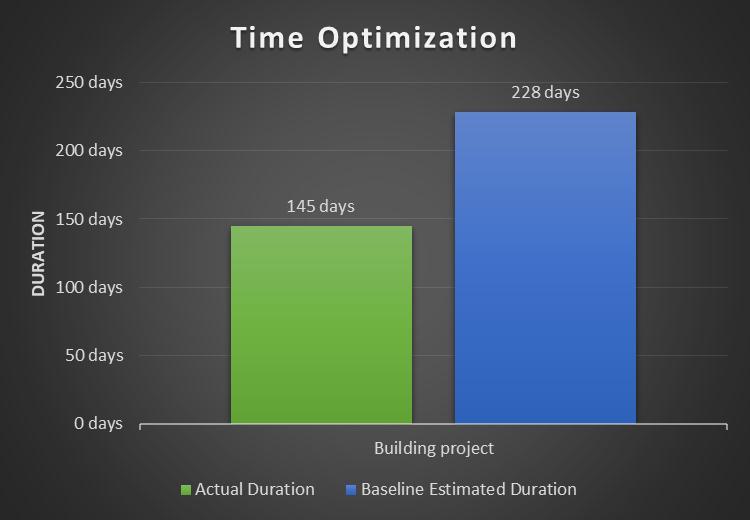

Thedurationwhichisconventionallyobservedis228dayswhichisbeingdecreasedbycrashingandwiththehelpof slacktime.Theapproximatelyreduceddurationis145days.
Majorlyforoptimizingtimethemethodologyextrahumanresourcesareusedandworkeasilywithoutanyhectic situations.
The time optimization is also depending on how well a contractor organizes his work schedule with a proper utilizationofmaterial,machineriesandhumanresource
Result For Cost Optimization
Projectcostoptimizationisdonebyusingthealternativebuildingorientedmaterialswhichreadilycutdownthecost oftheprojectbutalsosatisfiesownerwithaneconomicalresult.
Soforalternativebuildingmaterialaninsulatedstructuraltoughenedglassisreplacedbypolycarbonateglass,regular brickmasonryisreplacedbyRattrapbondtechniqueandregularRCCofslabisreplacedbyPlankandjoistroofing system,whichcutsthecostoftheproject.

Thecostofpolycarbonatesheetis₹650/sqmwhichisconsiderablyverymuchlesscomparedtotoughenedglass whichis₹2400/sqmandbyrattrapbondandplankjoistroofingsystemcostreducedupto30%foreachreplaced activity.

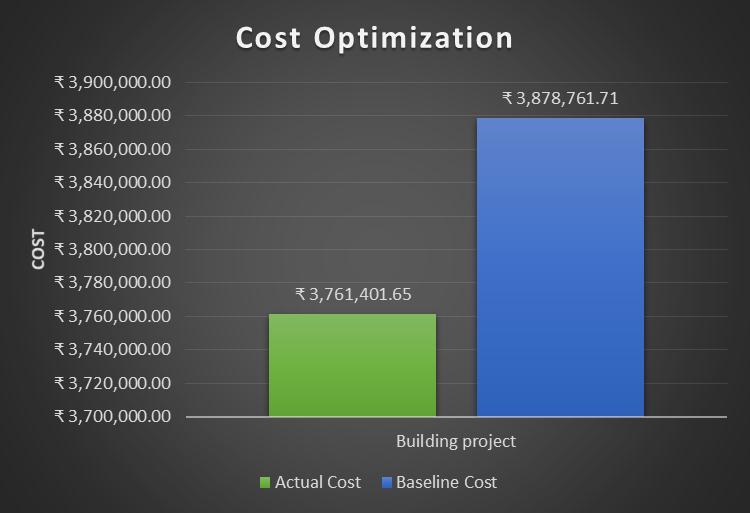

Thecostoftheprojectis ₹3878761,byapplyingcrashingand byapplyingthealternativematerialcosttheoverall costofthebuildingisreducedby₹3761401
7. CONCLUSION
Fromtheresultswecanmaketwocomparativeconclusions:
1)Comparisonofactualtimeandcrashedtimeoftheproject.
2)Comparisonofactualcostandcrashedcostoftheproject.
Fromprojectcrashingwecanconcludethat
1) Projectcrashingcostandindirectcosthaveinverserelationship.
2) Indirectcostincreasesasprojectdurationincreases.
3)Crashing cost are highest when the project is shortened, to overcome this we have used alternate materials and techniques.
ThisprojectconcludesthatanyrelativeconstructionprojectmainlydependsontheTimeandCostconstraintswhich givesapropereconomicalweightagetoanyproject.
A proper planning and scheduling will also make a huge differenceinconstruction projectconsidering the labor management
Propermanagement,interpersonalmanagement,technicalmanagement,andtheuseoftechnologyinbuildingprojects mayallhelptoreducedelays.
Clientwantedhisprojecttobecompletedfaster,companycanstillreducethetimetoreachclientsatisfactionandhe didn’t obtain the biggest profit from this project. So, after completion of the project, crashing is done to make a differenceandshowhowtogetthemaximumprofitfromit.
Additionofhumanresourcesandalternativebuildingmaterialsliketoughenedglassisreplacedbypolycarbonate glass,regularbrickmasonryisreplacedbyRattrapbondtechniqueandregularRCCofslabisreplacedbyPlankand joistroofingsystem,whichcutsthetimeaswellascostoftheproject.
Asaresult,thetotaldurationofprojectwas228daysanditwasreducedto145daysusingcrashingandalsocostof ₹117360wasdecreasedfromtheactualcost.
REFERENCES
1. KomeshSahuandMeenaSahu(2014),Costandtimeandalsominimumprojectdurationusingalternativemethod, Internationalreviewofappliedengineeringresearch,vol-4,no5,pp,403-412
2. Bhushan V.Tatar and Prof.Rahul S.patil (2016),Time and cost optimization techniques in construction project management,
3. Shifat Ahmed et.al (2016), Minimize time and cost for Successful completion of a Large scale project . Planning, schedulinganddelayanalysiscasestudyRathodRajshekharGopal (2016)
4. AkashLankeandD.Venkateswarlu(2016),DesignCost&TimeAnalysisofPrecast&RCCBuilding.ComparativeStudy OfTime-costOptimizationDileepkumarreddyandVenkatavaraPrasad(2018)
5. FloatTimeReductionPotentialInConstructionProjectAndItsImpactShubhendraKumarMishraandSarthakSingh Rajput.(2020)
6. ToStudyAdvancedProjectPlanningAndScheduling-caseStudyMr.GunjalKartikeyanandMr.RohitGholap(2021)
