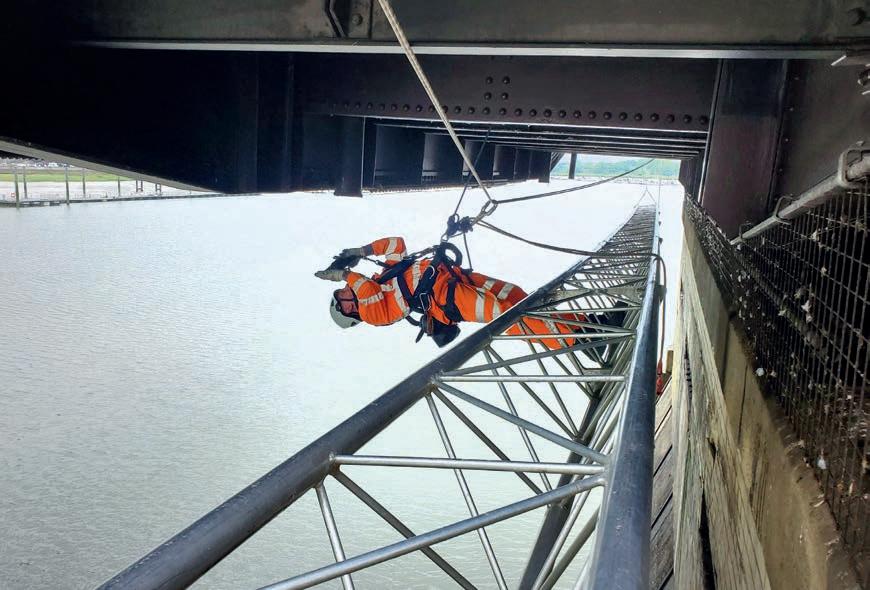

Bridge inspectors used skilled rope access techniques to conduct a detailed survey of the Grade II-listed Rochester Old Bridge. Rope access specialist company Up and Under and sister company CAN Structures, both part of the RSK Group, carried out the inspections as part of a six-year contract with the Rochester Bridge Trust to monitor its assets.

‘The strongest teams check in’ Fire protection company Ark and Bowmer + Kirkland rolled out high-visibility jackets across their sites featuring messages to help raise awareness of mental health issues in construction. The initiative aims to highlight the importance of creating open conversations around mental health and serves as a visual reminder of the challenges everyone, including construction workers, can face.

National Maritime Museum’s roof upgrade

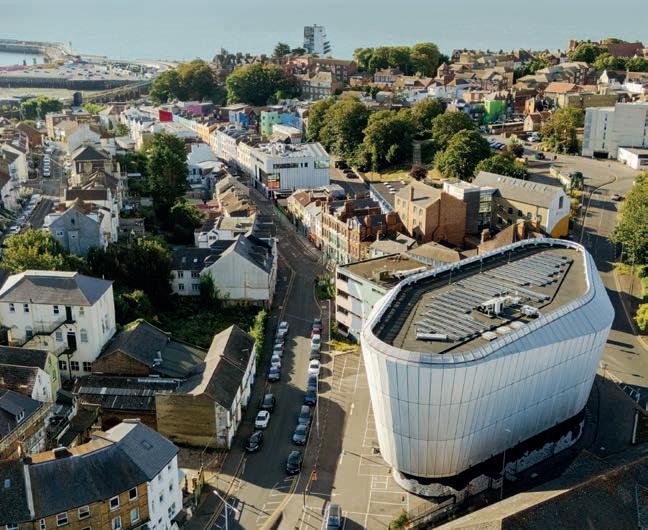

Willmott Dixon Interiors completed a £12.3m refurbishment of the National Maritime Museum’s Ocean Court in Greenwich, London, with an extensive upgrade to its iconic glazed roof. The project included installing more than 2,550 sq m of solar-protective glazing and Barrisol membrane, resolving long-standing issues with water ingress, solar heat gain and acoustic performance at the Grade I-listed building.

Blenheim Palace’s clock tower restoration

Blenheim Palace has begun a seven-week restoration programme on the 18th-century clock tower located at the entrance to the UNESCO Site’s Great Courtyard. The clock is considered the finest surviving example of the craftsmanship of clockmaker Langley Bradley. The project is being led by Chris Monaghan, clerk of works in the Blenheim Palace built heritage team, and Carmen Alvarez, Blenheim Palace’s collections manager.

Mike Reader MP talks to CM about housing targets, MMC – and wrestling (p18-22)

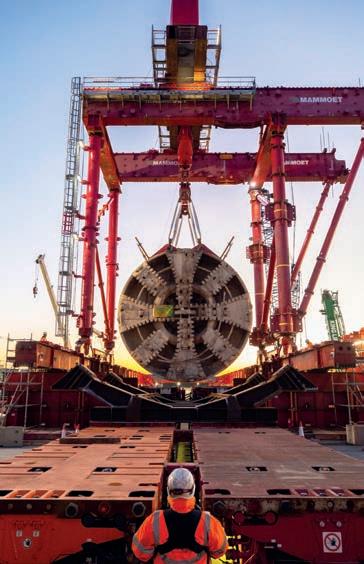

Bespoke gantry system for HS2 TBMs removal

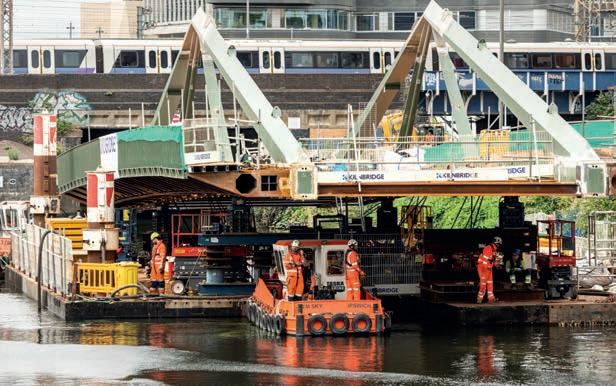

Dutch heavy lifting company Mammoet worked with tunnel boring machine (TBM) manufacturer Herrenknecht and HS2 tunnels main contractor, Skanska Costain Strabag joint venture, to design and assemble a custom gantry system to lift four TBMs weighing almost 900 tonnes each. This solution enabled the removal of each of the TBMs as a single piece and reduced dismantling operations within the shaft by bringing lift operations to the surface, mitigating risk.

Gleeds sets Guinness World Record

Construction consultancy Gleeds marked its 150th anniversary teaming up with kite surfer Jake Scrace and stuntman Chey Anich to set a new Guinness World Record. The extreme sports pros reached almost 500m over The Needles at the Isle of Wight to claim the accolade for ‘Highest Kite Surf Tow-up’ ever recorded. Scrace, a carpenter who specialises in building ‘tiny homes’, had previously made headlines by kite surfing over both Worthing and Brighton piers.

Half of construction SMEs report losses or lower profits

Findings from the latest SME State of Trade Survey show that acute skills shortages and rising costs are disrupting delivery and impacting profits

A total of 49% of SME builders in the UK reported lower-than-expected profits or losses in the first half of 2025, according to a joint report by the Federation of Master Builders (FMB) and the Chartered Institute of Building (CIOB). Although the industry is showing “strong signs of recovery” after a

challenging end to 2024, acute skills shortages and rising costs driven by materials prices and wages continue to disrupt delivery and squeeze profits, the latest SME State of Trade Survey found.

Of the 458 FMB and CIOB members surveyed, 75% saw increased material costs and 67% reported rising wages

The survey found that almost two-thirds of construction SMEs are being affected by a lack of skilled tradespeople and salaries. This is having an impact on growth, with one in four saying their business may be on the path to going bust, said the report.

Despite this gloom, more than half (51%) of firms have a positive outlook for the second half of the year. Additionally, construction SMEs also saw strong growth in workloads, enquiries and employment, led by housebuilding and maintenance.

Skills shortages

The survey also found that almost two-thirds (61%) of construction SMEs are being affected by a lack of skilled tradespeople.

According to respondents, the most difficult trades to hire are carpenters (33%), roofers (32%), plumbers/HVAC (28%), general labourers (29%), and bricklayers (28%).

The survey found that, due to these skills shortages, 49% of employers have experienced job delays, while 23% have faced job cancellations.

Continued cost increases and squeezed margins also appear to be impacting potential employment opportunities. Around one-third (34%) of employers said they are restricting recruitment, and just over one in five (22%) are making staff redundant.

Despite the challenging outlook across the labour market, 39% of firms have increased the size of their workforce –up from 17% in Q4 2024. In addition, just 13% of employers reported a decrease in staff numbers. ●

CIOB Aspire launched to champion early careers in construction

Institute wants to encourage young people aged 14-19 to look at built environment careers. By Nadine Buddoo

The Chartered Institute of Building (CIOB) has launched CIOB Aspire

– a new initiative designed to inspire and support people who are considering a career in construction.

CIOB Aspire is open to individuals aged 14 to 19, as well as those interested in a career change, looking to take their first steps in the industry.

A new digital space has been created to signpost to useful resources and websites, including:

● Information on the range of roles in construction, apprenticeships, CIOB accredited courses and where to get started

● Industry insights including blogs and videos from some of CIOB’s Tomorrow’s Leaders community

● Links to support finding early

career opportunities through CIOB Jobs or CIOB company members

● Information for CIOB members, parents, employers and educators on how to support a career in construction

● Useful website links for CIOB partners and other organisations working in the early careers space.

CIOB will add more information to the digital platform over the coming months, including new marketing resources aimed at students, educators, parents and employers.

Collaborative approach

As well as the digital resources, CIOB is also teaming up with partners and organisations already working in the early careers space to provide opportunities for this

CIOB Aspire aims to engage with young people who are interested in construction careers

Inspiring and educating individuals around the broad range of opportunities and career paths available is of utmost importance

Cox, CIOB

audience, and will continue to explore further partnerships. CIOB members and industry professionals in the UK and Northern Ireland can sign up as construction ambassadors through the STEM Ambassador Scheme, providing a safe platform to connect with educators and 14- to 19-year-olds in schools and colleges.

Sophie Cox, product owner – Tomorrow’s Leaders at CIOB, said: “Inspiring and educating individuals around the broad range of opportunities and career paths available is of utmost importance, while at the same time challenging some of the misconceptions that exist.

“We are delighted to be launching CIOB Aspire, which aims to do just that.”

Engaging with the next generation

Earlier this year, as part of the focus on early careers, CIOB relaunched its Think Construction Toolkit, comprising lesson plans, interactive activities and presentation templates to support construction ambassadors and teachers engaging with 14- to 19-year-olds. Over-18s can sign up to access the toolkit at ciob.org.

In July, CIOB signed up as a partner for Open Doors 2026. Delivered by Build UK from 23-28 March, the event will help to showcase the range of careers available in the construction industry. ●

BSI publishes ‘landmark’ inclusive PPE standard

New standard follows CIOB and CM campaign #PPEthatfits, launched in 2023 under then president Sandi Rhys Jones

The British Standards Institution (BSI) has announced the launch of a new standard for inclusive PPE.

The standard – Provision of Inclusive PPE (BS 30417:2025) – aims to help support organisations or individuals involved in the purchase, provision or use of PPE.

Earlier this year, BSI opened a public consultation to allow all stakeholders, including end users and technical experts, to provide feedback on its draft standard.

Through the consultation process, BSI has refined the standard to ensure it is relevant, clear and technically accurate.

BS 30417 offers a framework to help employers, employees, procurement teams and health and safety professionals ensure that PPE:

● Provides the expected protection and safety for everyone who needs it.

● Fits every worker, regardless of gender, disability, or cultural considerations.

● Is selected and procured with inclusivity in mind.

‘A statement of values’ Sara Gibbs, standards development manager at BSI, said the new standard represents a “landmark moment for the construction sector and beyond”.

“For too long, protective equipment has been designed around the average – a model that excludes many and compromises safety,” she explained.

“BS 30417 aims to address this critical gap by ensuring that PPE must fit the individual, regardless of gender, body shape, age, or ability.

“This standard is more than a technical

This standard is more than a technical document; it’s a statement of values. It reinforces the principle that everyone deserves protection that is not just available, but appropriate Sara Gibbs, BSI

document; it’s a statement of values. It reinforces the principle that everyone deserves protection that is not just available, but appropriate.

“Poorly fitting PPE is more than a discomfort; it’s a safety risk. BS 30417 confronts the outdated ‘one-sizefits-all’ mindset and brings equity, inclusivity and dignity to the forefront of workplace safety.”

The release of the standard coincided with National Inclusion Week (15-21 September) which, Gibbs said, underscores “a powerful message that inclusion and safety are inseparable, and both must be prioritised”.

BSI is currently planning a parliamentary launch, backed by growing government interest and the support of Kirsteen Sullivan MP, to highlight the national importance of the new standard.

Gibbs added: “This milestone would not have been possible without the relentless work of the Chartered Institute of Building (CIOB) and its impactful #PPEthatfits campaign.

“What began as a call for change has become a movement, now enshrined in a British standard.”

CIOB campaign

#PPEthatfits was launched in 2023 to help address inequalities in the provision of PPE across the construction industry.

The campaign was spearheaded by former CIOB president Sandi Rhys Jones.

“This isn’t about pink hard hats or extra-small hi-viz, it is about fundamental safety – something that is essential for an industry to demonstrate that it truly cares about attracting and keeping the people it needs,” said Rhys Jones.

“It is also about more than construction and it is particularly rewarding that the process so ably driven by BSI has engaged with other industries and sectors.”

CIOB is expected to publish a Technical Information Sheet later this year that will help support members and the wider industry in adopting the new inclusive PPE standard. ●

For more information about the #PPEthatfits campaign and CIOB’s global directory of inclusive PPE suppliers, visit www.ppethatfits.com.

Off-grid: how energy infrastructure impacts construction projects

Contractors must engage with grid operators early to avoid delays in their developments, writes Barrett Harris

Among the several challenges facing UK construction, getting a quick connection to the electricity grid is fast becoming another hurdle to overcome. Recent soaring demand for connections has put the grid under significant pressure, with backlogs leading to long wait times.

Over the past decade, installed generating capacity in the UK has consistently risen, driven by the expansion of offshore wind, solar and battery storage. By contrast, the highest level of electricity

demand that was successfully supplied by major power producers (peak demand) remained relatively flat, due to efficiency gains and changing consumption patterns. The result is a system that, on paper, has more capacity than demand (see chart, top right).

However, capacity type and location matter as much as the headline totals. Renewable generation is concentrated in specific regions, such as Scotland for wind and the south of England for solar.

Construction projects that depend on secure and high-voltage

connections, like large industrial facilities or data centres, often face delays if local grid reinforcements lag behind the pace of new connections. This mismatch means that even with sufficient national capacity, local shortages can restrict development.

The most pressing challenge is the lengthening grid connection queue. Developers seeking to connect new power plants, battery storage or demand-intensive projects must apply for a grid connection agreement.

The volume of these applications has surged. In September 2023, 549

GW of projects held agreements according to Ofgem’s Connection Action Plan report. Energy Networks Association data show this had grown to 889 GW by June 2025.

Long timelines

This dramatic rise reflects both the surge of renewable proposals, many benefiting from expedited Department for Energy Security and Net Zero (DESNZ) planning consent and the growing interest in electrification of transport, housing and other sectors.

The following chart (below, right) illustrates the sharp 563.3%

Recent soaring demand for connections has put the grid under significant pressure, with backlogs leading to long wait times

increase in granted renewable planning applications between 2020 Q2 and 2025 Q2, leading to a combined capacity of 110.2 GW.

For construction projects, the implication is clear: even if planning consent is secured, the lack of a timely grid connection can put projects on hold for years. Some developers now face connection dates well into the 2030s.

For the construction industry, grid constraints bring delays, cost pressures and shifting priorities. Projects can be held up for years awaiting substations or transmission upgrades, while grid reinforcement costs often run into tens of millions of pounds. Some developments are redesigned to lower peak demand through on‑site generation or storage.

However, reforms are under way. Ofgem and the National Energy System Operator are working to remove inactive ‘zombie’ projects and prioritise those ready to build, while grid reinforcement programmes ramp up. But timelines remain long.

As a result, energy infrastructure is now a core strategic consideration. Developers and contractors must engage with grid operators early, secure realistic connection dates and integrate energy resilience into designs from the outset.

As the UK moves toward net zero, the synchronisation of DESNZ’s planning momentum with the physical readiness of the grid will determine not only continuity of energy supply, but also how quickly new industries can scale and the communities that support them can be established.

Barrett Harris is a senior economic analyst at Turner & Townsend.

Gigawatts (GW) n Coal n Nuclear n Oil n Wind, wave, solar and hydro n Gas n Other sources
