Waitematā Station (Britomart) Community Liaison Group
![]()

Britomart Station Control Room (SCR)

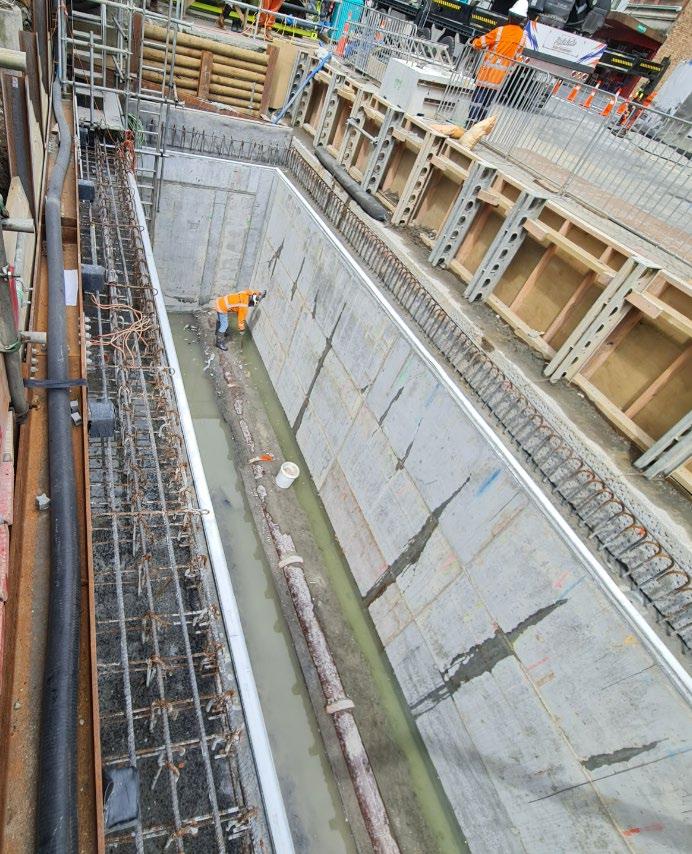

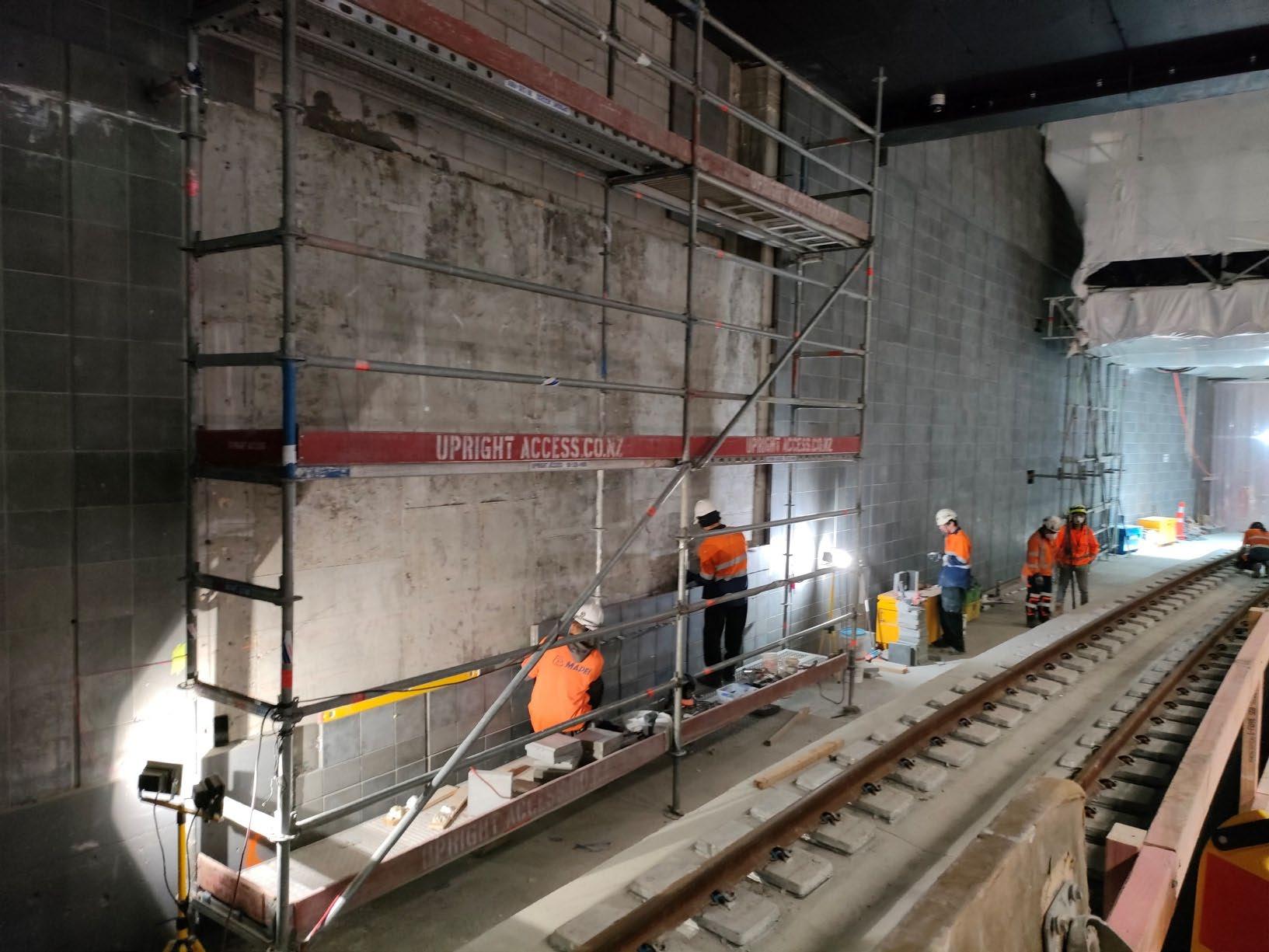

Bluestone work on South wall Preparation for Terrazzo pour
Britomart Phase 2 works Bluestone work on South wall
milestones completed 2022
• Completed the construction of the new south wall to Britomart tunnel.
• Installed temporary structures to ensure stability of the old wall during the demolition period.

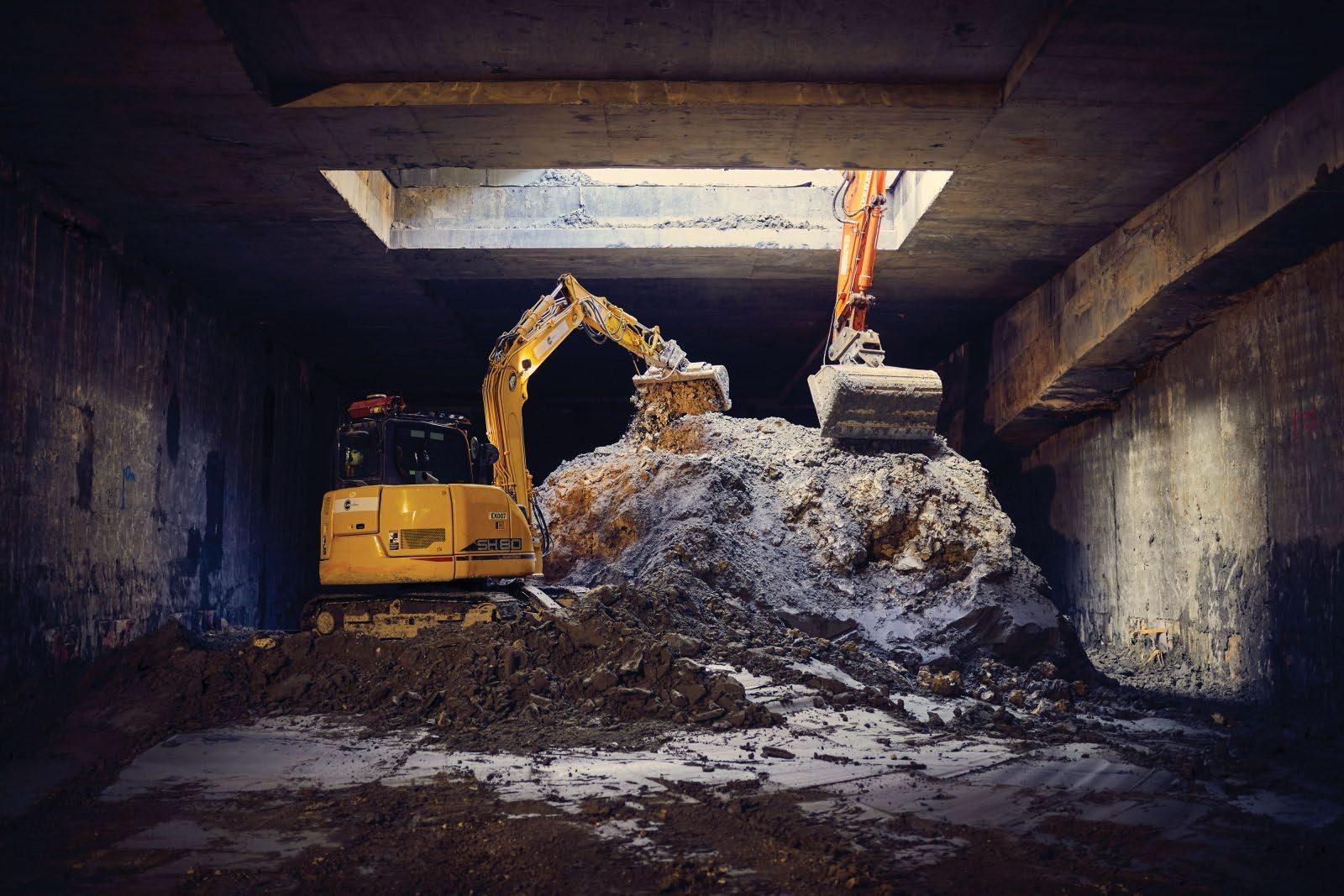

• Excavated down through the existing surface area on the corner of Scene Lane/Britomart Place.

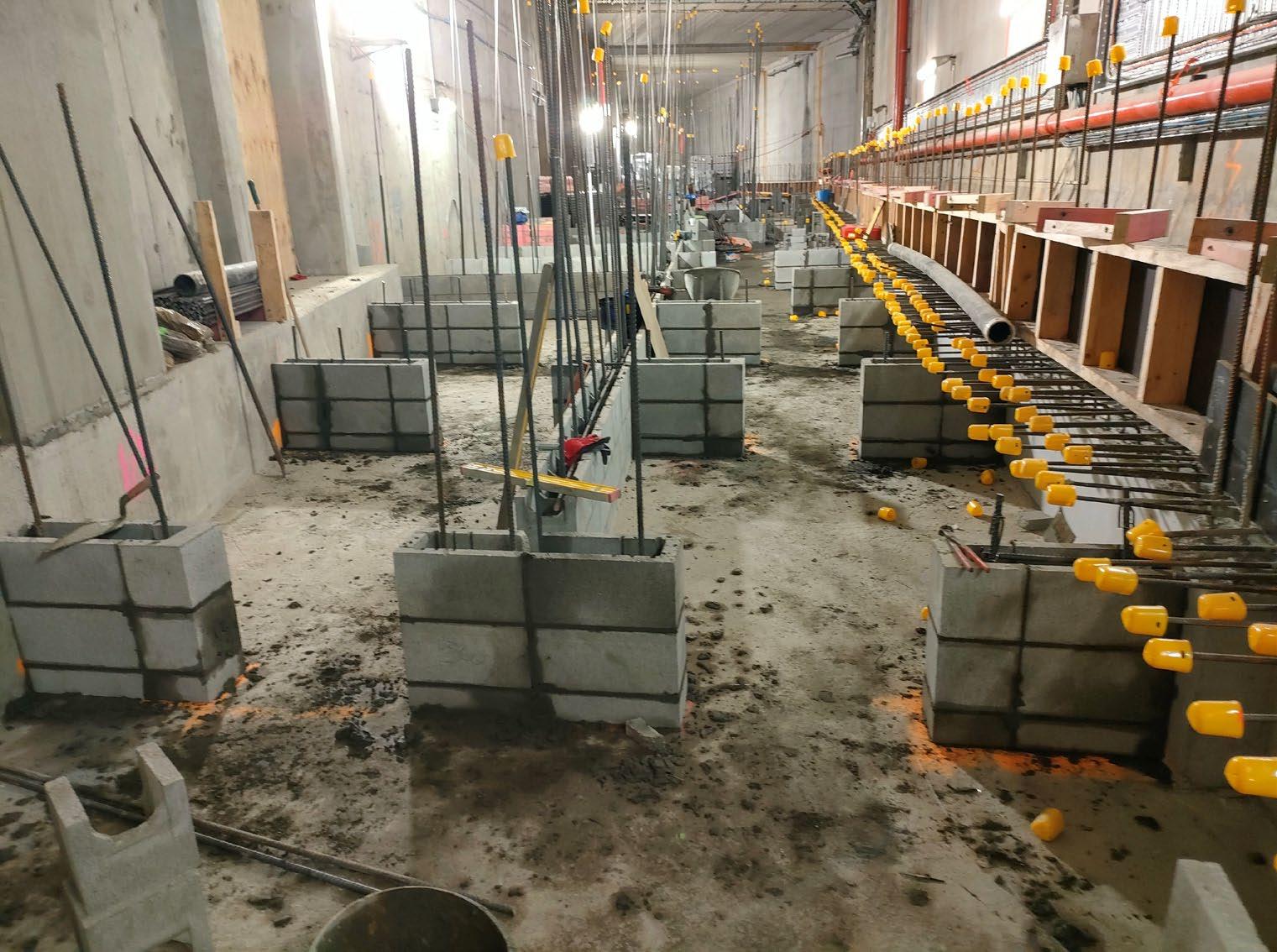

• Installed beam and wall strengthening, and re-established structure; installed panels; precast lid placed over surface works pit.
• With over 50,000 manhours on this project, it’s all been carried out to date with no safety incidents.
2023
• Complete all surface works up to ground level, and commence with final landscaping finishes at Britomart Place.
• Demolish the old south wall during the Christmas rail network shutdown (Block of Line).
• Complete the final completion items of the new south wall once demolition is complete.
• Commence track improvement works from Platform 1.
• And of course, continue with an excellent standard of safety management and control.

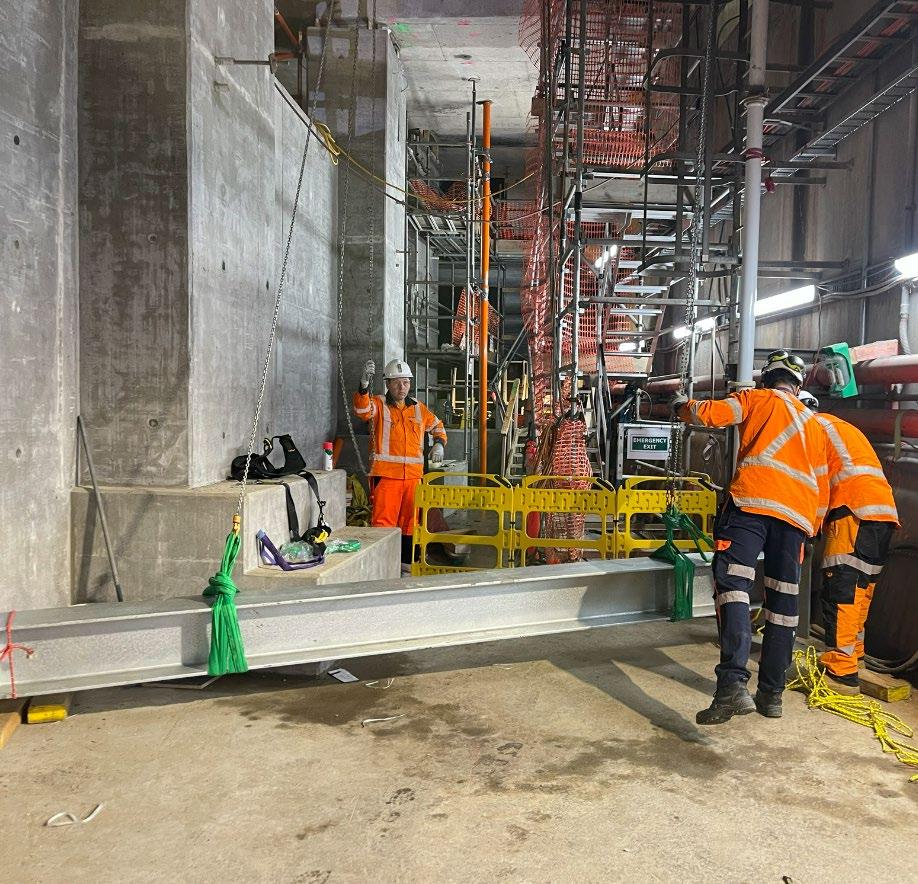

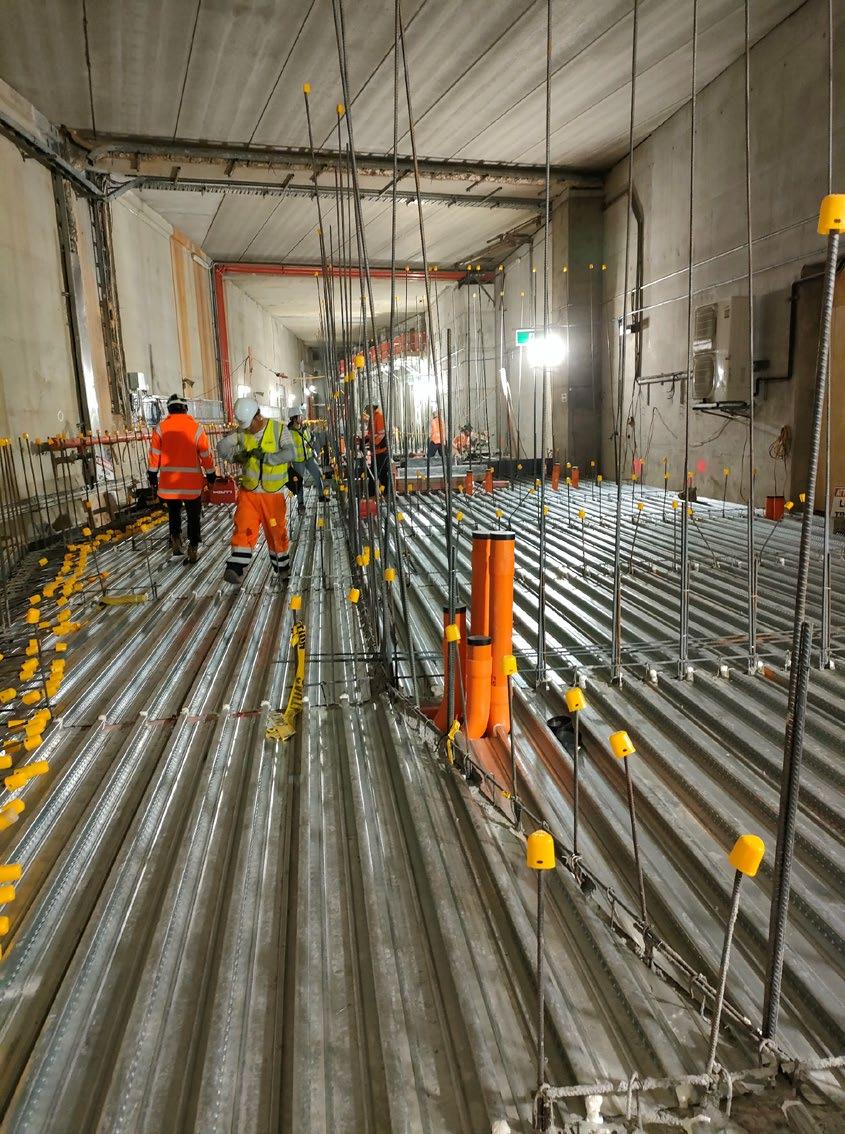

Lifting precast concrete slabs into placeachieved on time, despite delays occurred earlier in project

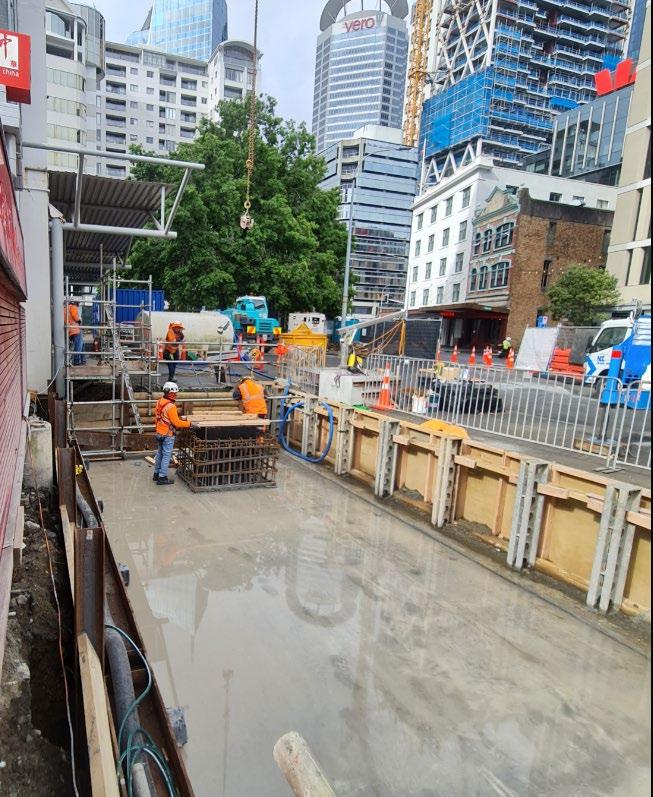

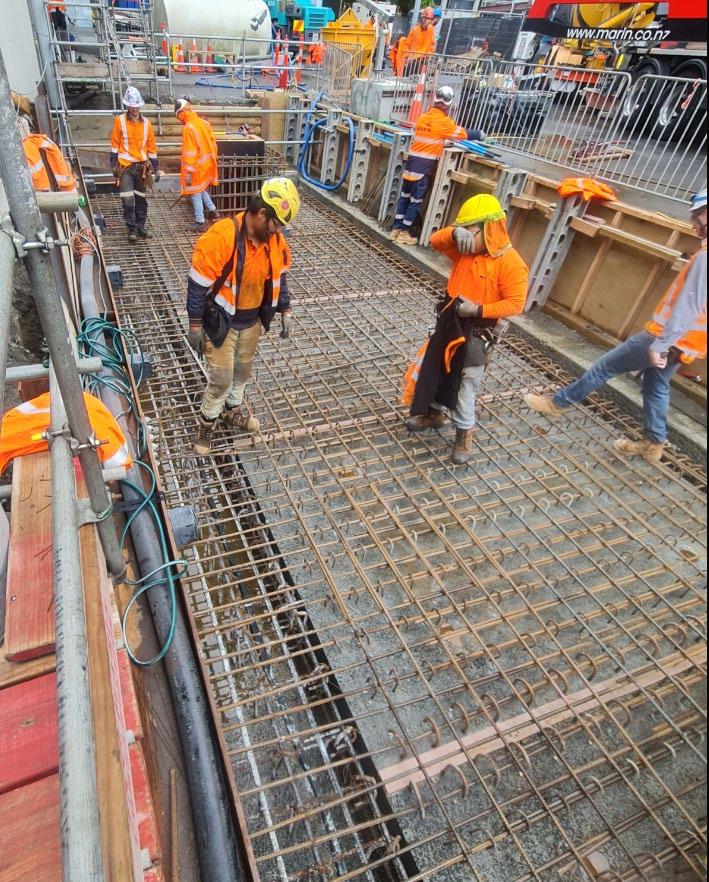

being placed for slab pour

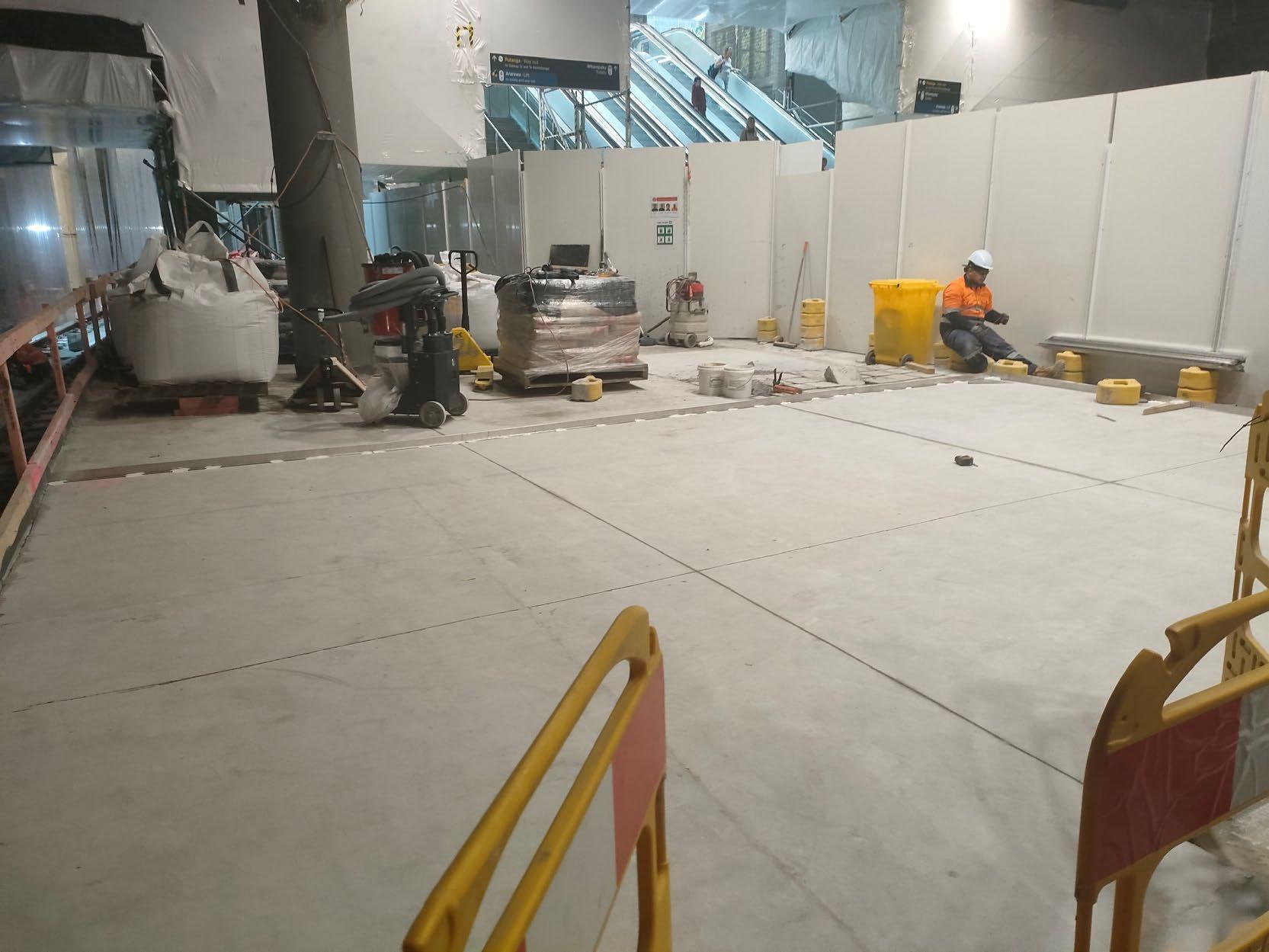

Concrete topping slab complete

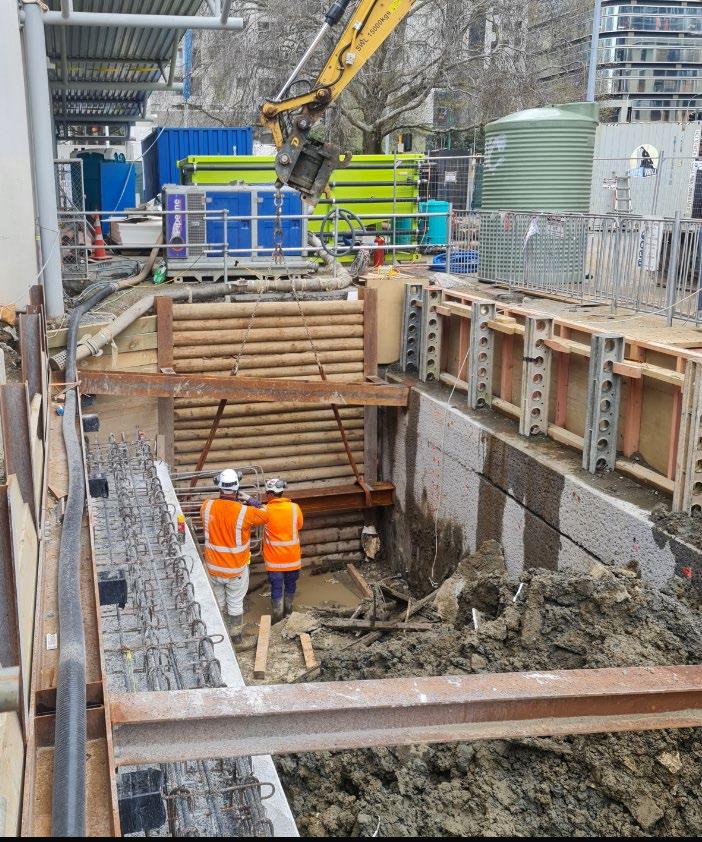

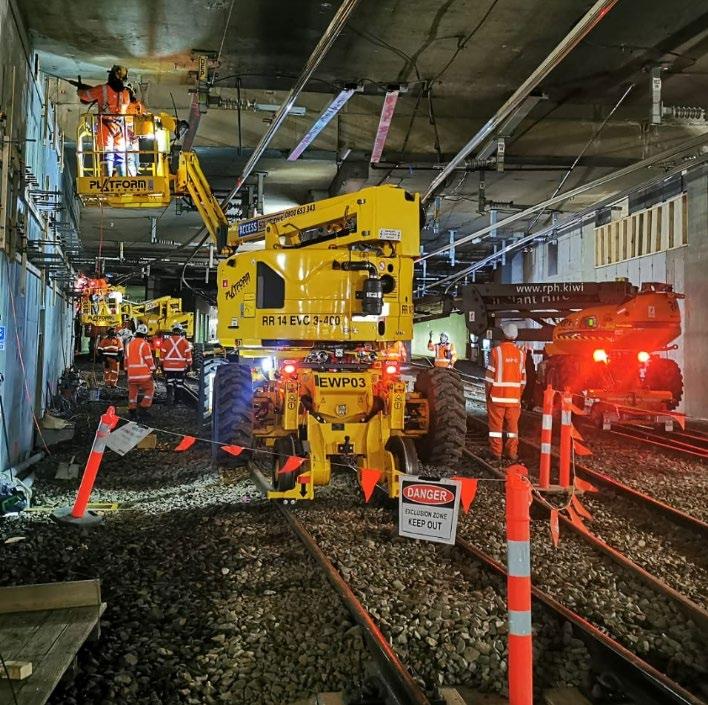

South wall scaffold removed, preparing to install tie beams
Last tie beam installed

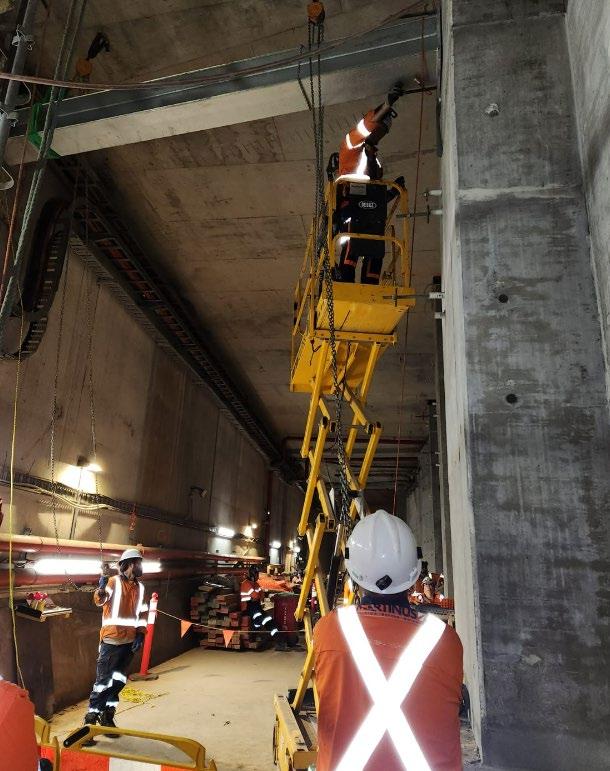

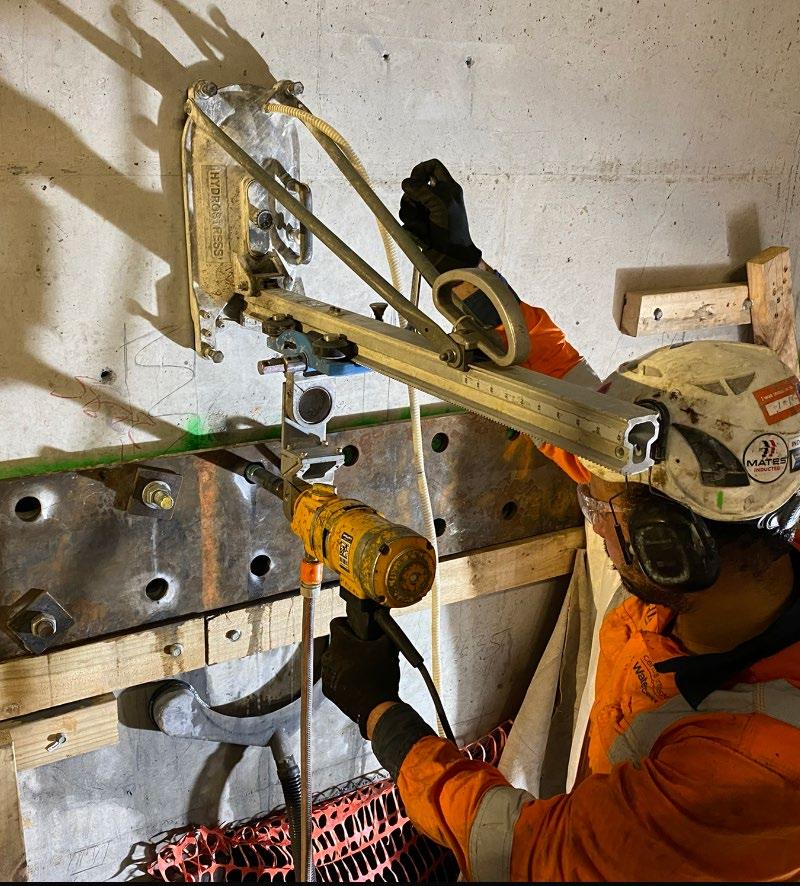

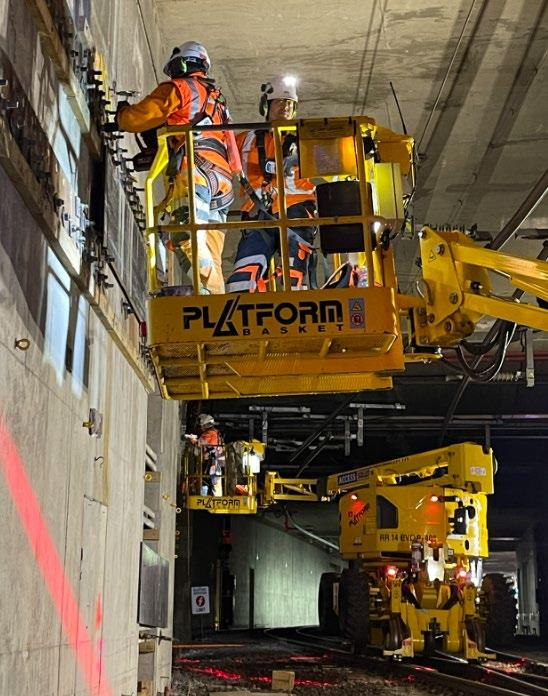

Drilling old wall for bolting of stabilisation plates Installing further stabilisation plates, trackside during Block of Line
Torquing several hundred bolts to engineer’s requirements
• Approaching the busiest time for rail. Every day we make sure our Martinus whānau gets home safely to their families.
• Our new “What’s your Reason?” initiative further reinforces safety as a key focus.
• Hazard identification refresher session: stopping, reflecting and resetting. Feedback safety improvement suggestions.

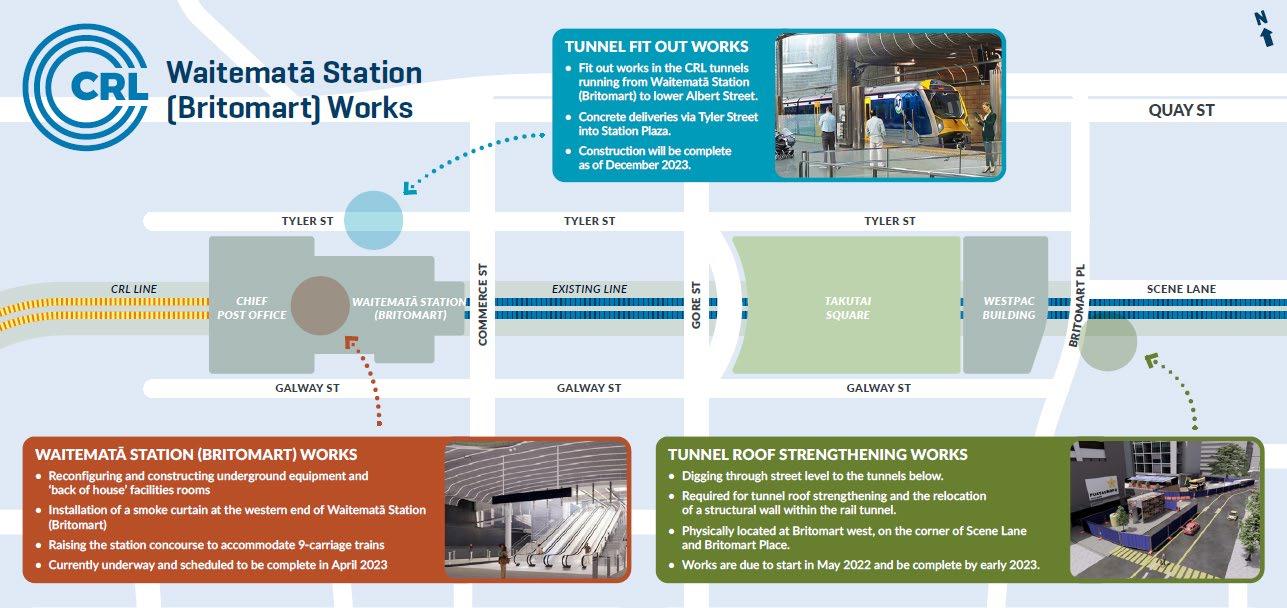

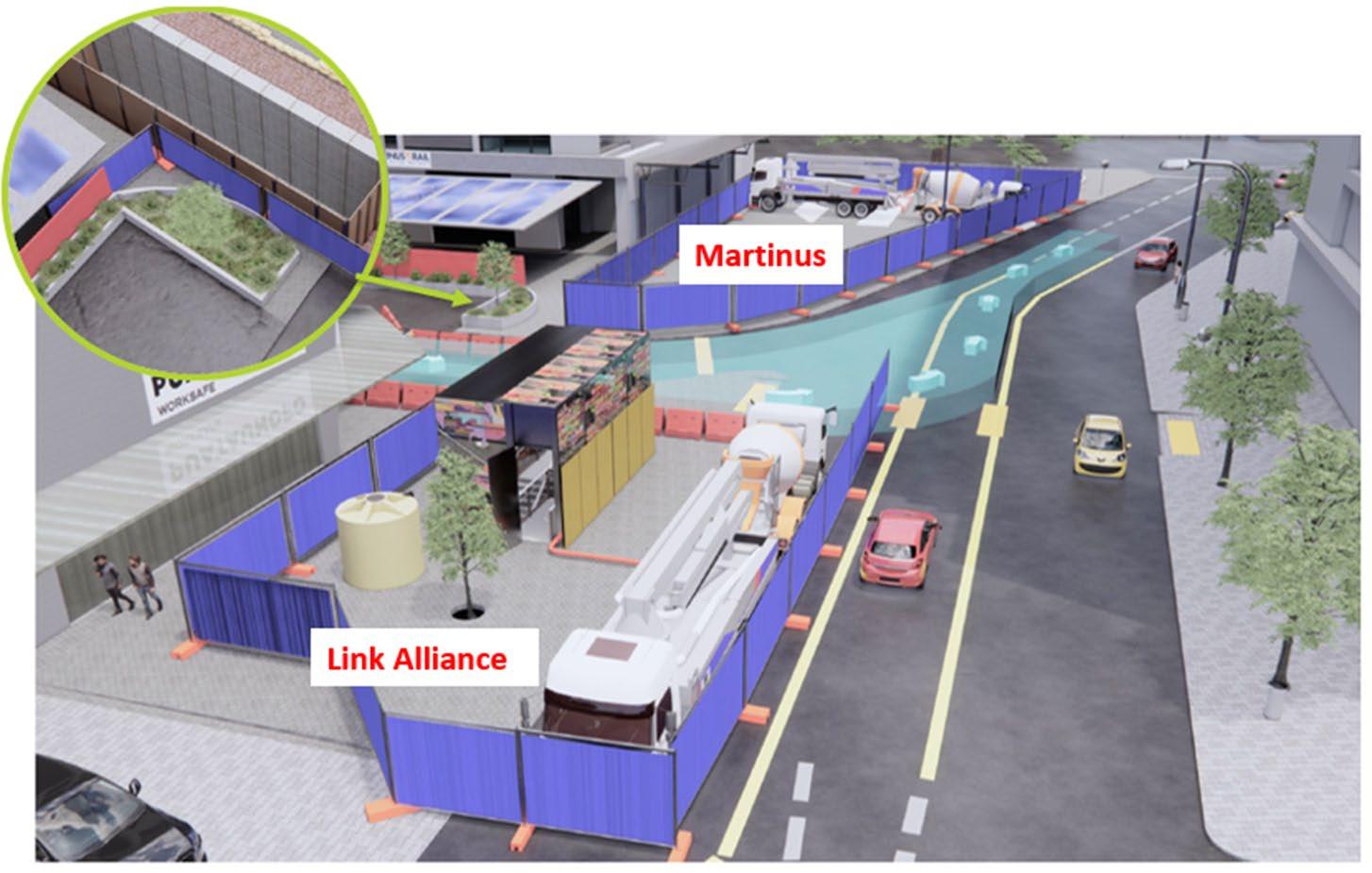

Martinus Rail and Link Alliance have been occupying part of Britomart Place and Scene Lane for works to:
• Strengthen the roof of the underlying railway tunnel (enabling rearrangement of walls and tracks within the tunnel)
• Reconfigure underground equipment rooms at the eastern end of Waitematā Station (Britomart)
• The above ground works (excluding the streetscape reinstatement) will be completed by early April 2023.
• During the latter stages of the works, and as Martinus and the Alliance progressively demobilise (removal of construction support areas, hoardings etc.), permanent reinstatement of the Britomart Place/Scene Lane streetscape will commence.
• The streetscape reinstatement is programmed to be completed by the end of May 2023.
The following slides illustrate the sequence of events:
• Streetscape reinstatement completed (end of May).
• Martinus continues to occupy former ‘China Restaurant’ premises as a site office.

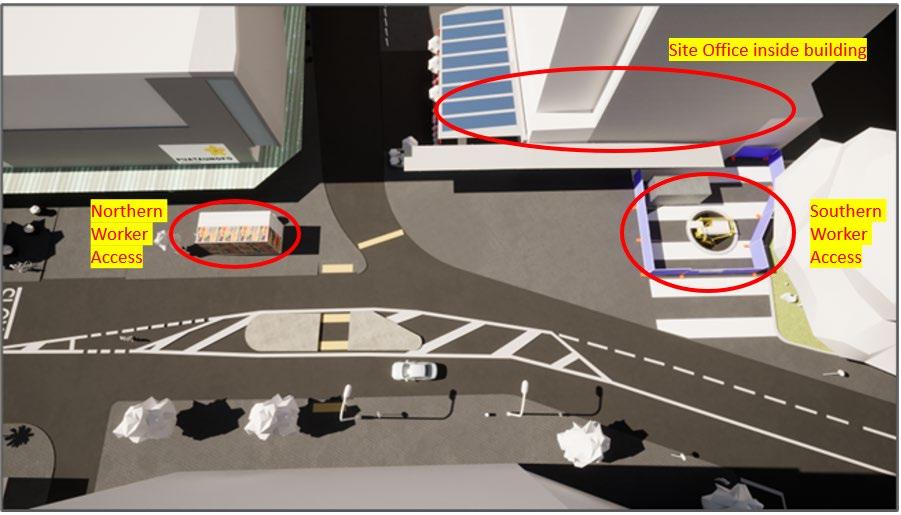

• Construction worker access (as shown).
• Intermittent concrete deliveries expected throughout the year.
• The whole rail network will be closed during this period. • No commuter trains will be operating.

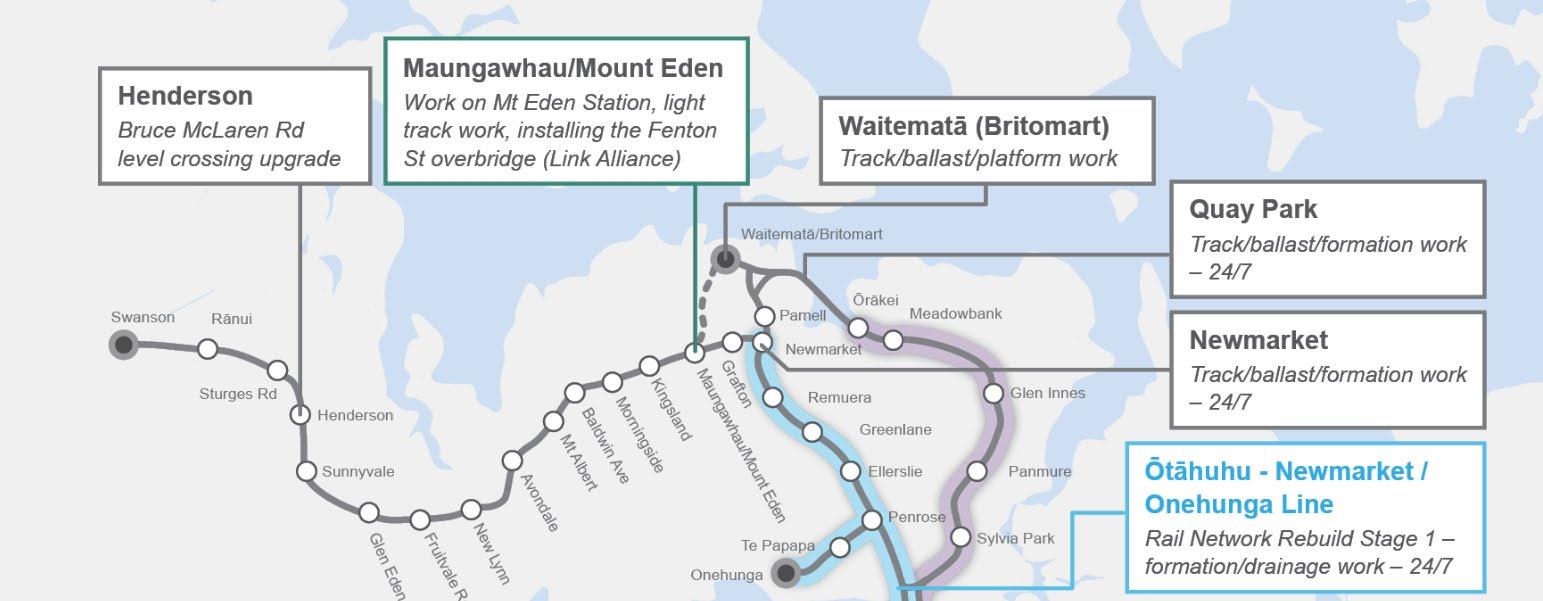

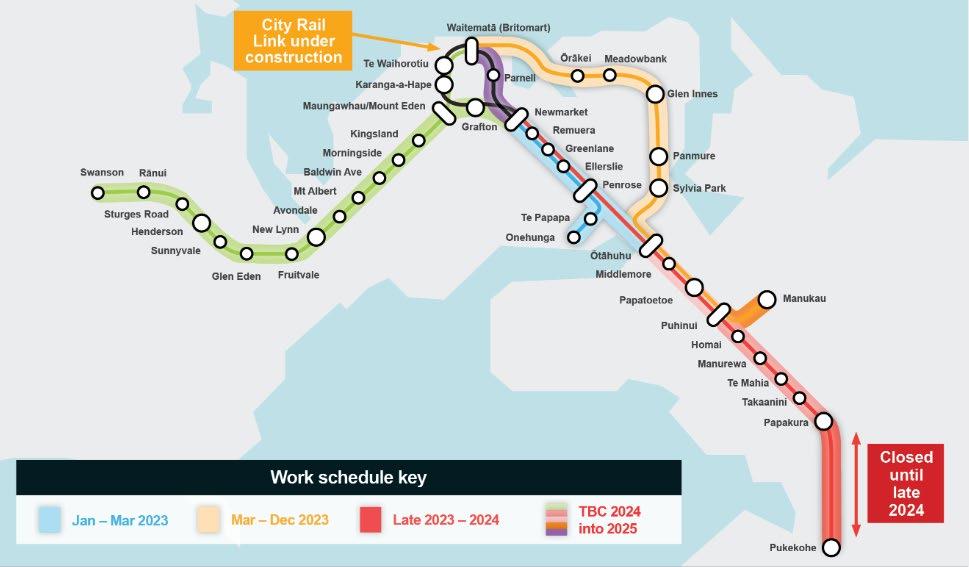

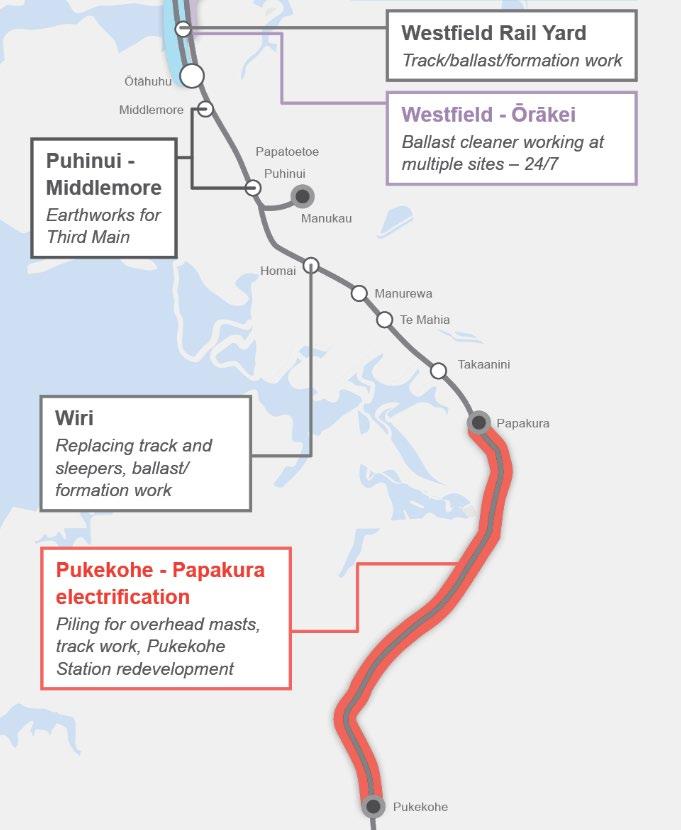

January 2023 - 2025

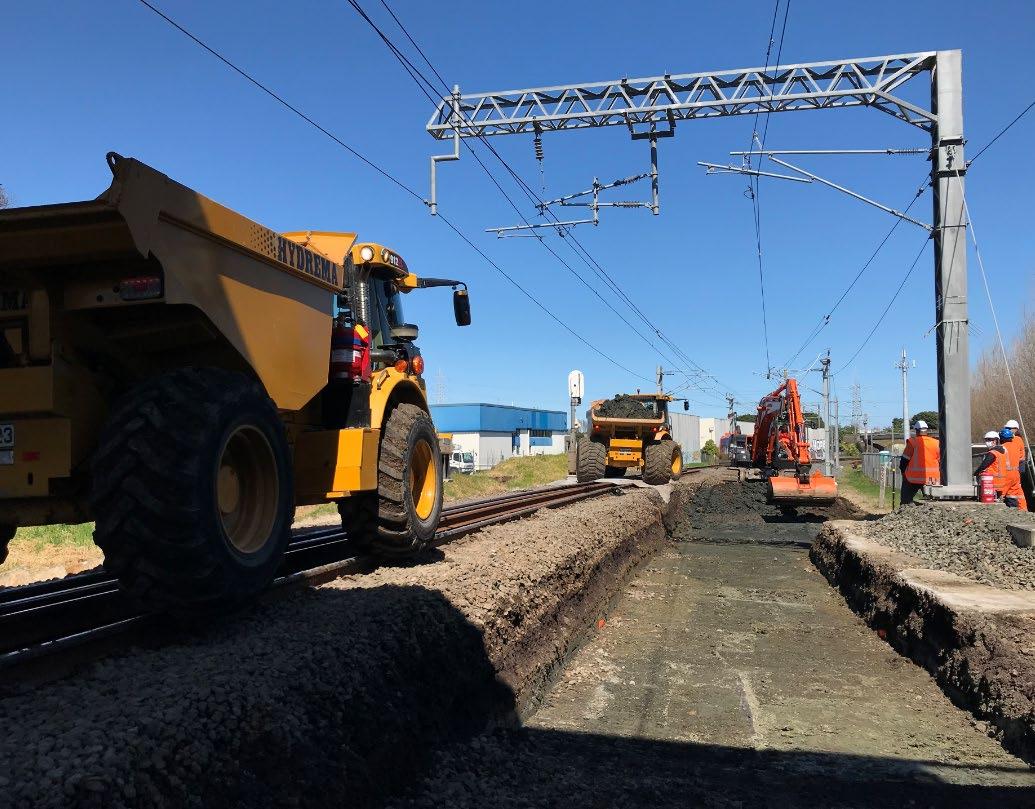

• Replacing the aging foundations under Auckland’s rail tracks and improving drainage
• This vital upgrade will be completed one section at a time over the next three years.
• While one section is being worked on, the rest of the train network will keep running.
Stage 1: 16 January - 19 March 2023

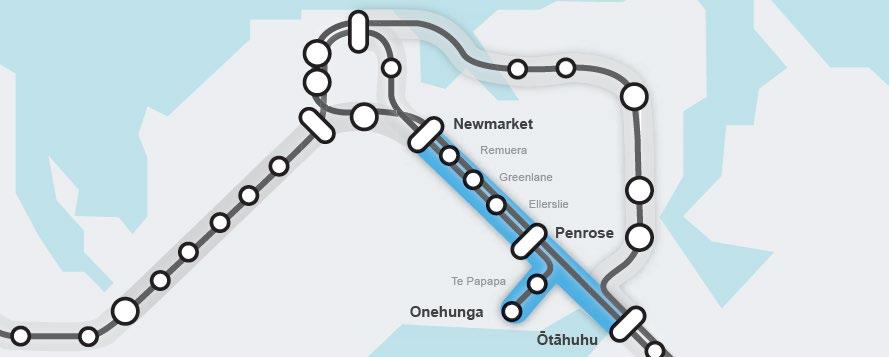

• Remuera, Greenlane, Ellerslie, Penrose, Te Papapa, Onehunga stations will be closed
• All other stations remain open
• All trains to South Auckland will run via Glen Innes and Panmure
• Extra buses will be added to enable travel
