WEST IRVING CREEK
Channel Improvements from S Rogers Road to W 5th Street and S MacArthur Boulevard to W Oakdale Road


COMMUNITY MEETING #1
APRIL 14, 2026

1
2
INTRODUCTIONS & BACKGROUND
3
PROJECT OVERVIEW Q&A AND BREAKOUT
![]()
Channel Improvements from S Rogers Road to W 5th Street and S MacArthur Boulevard to W Oakdale Road


COMMUNITY MEETING #1
APRIL 14, 2026

1
2
INTRODUCTIONS & BACKGROUND
3
PROJECT OVERVIEW Q&A AND BREAKOUT

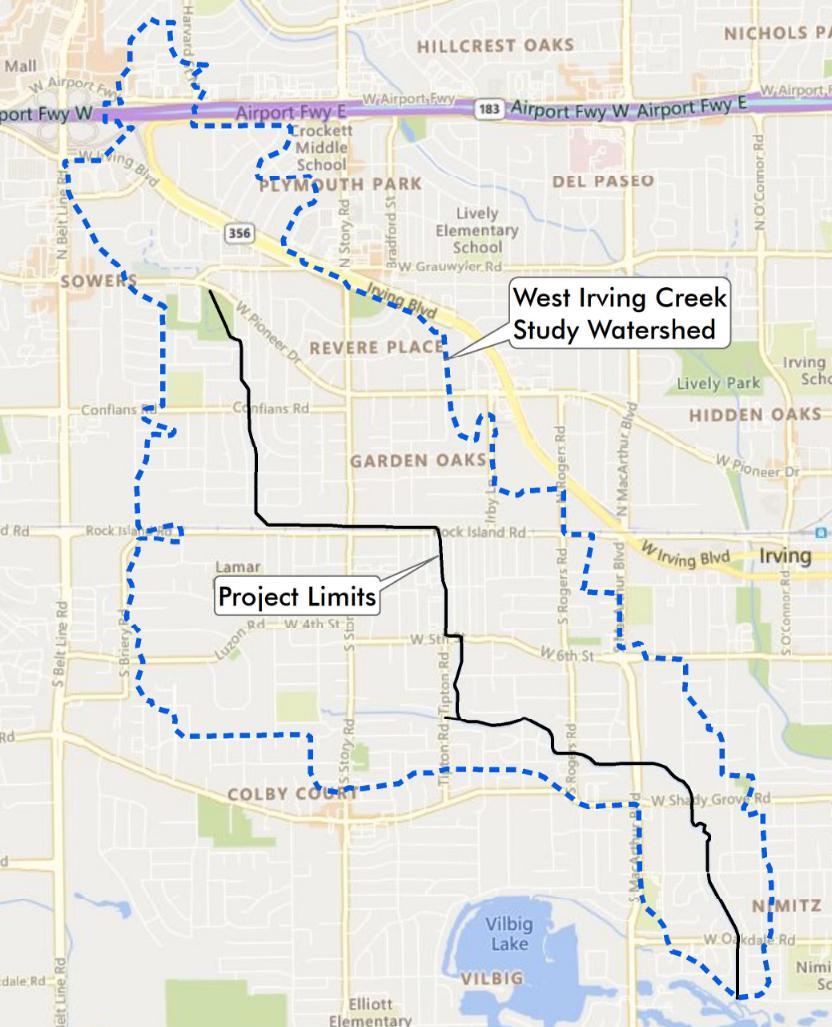

▪ Drains 3+ square miles
▪ Runs for 3+ miles
▪ Constructed in the 1960s and 1970s
▪ Inadequate to meet modern flood protection standards

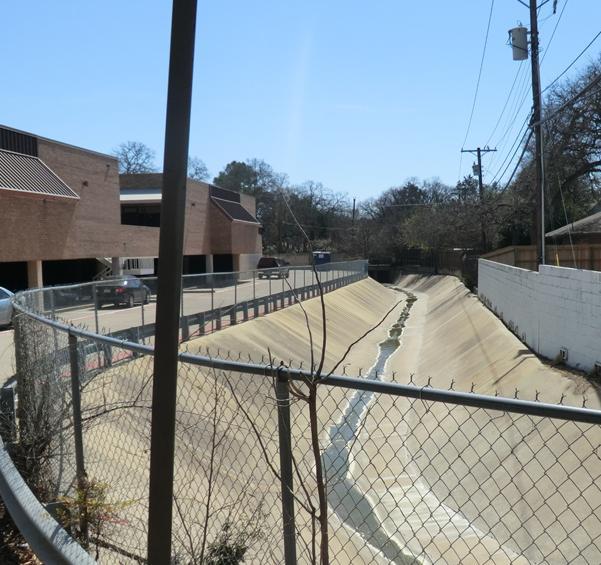

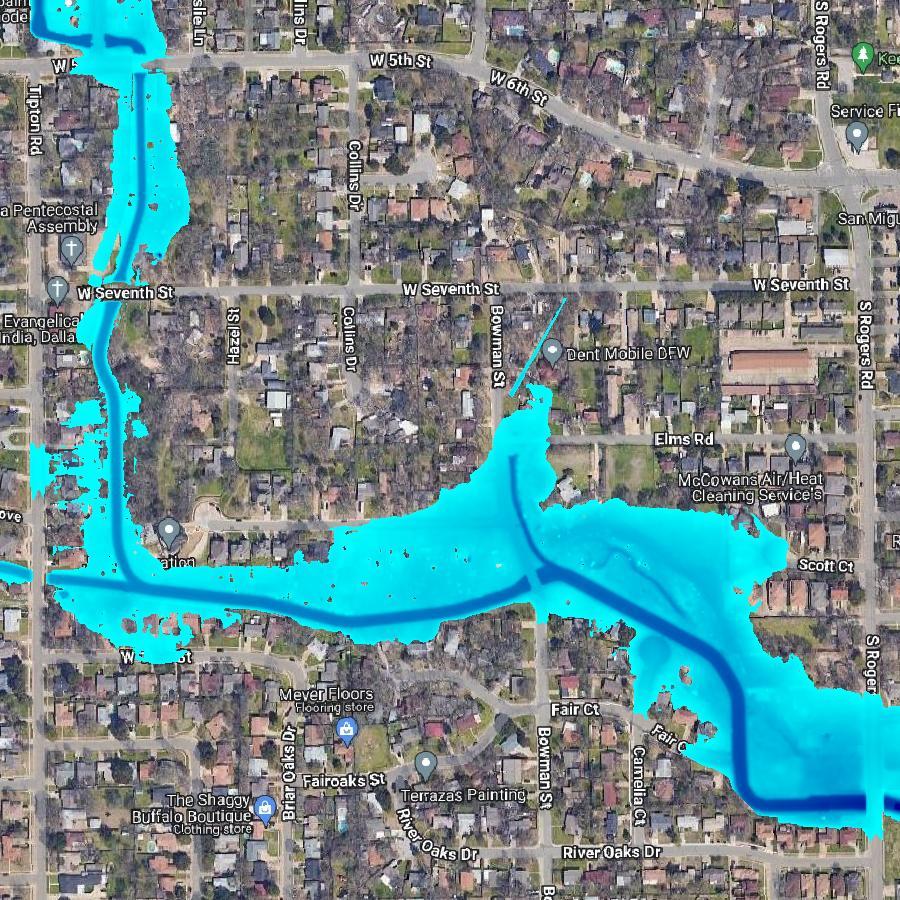

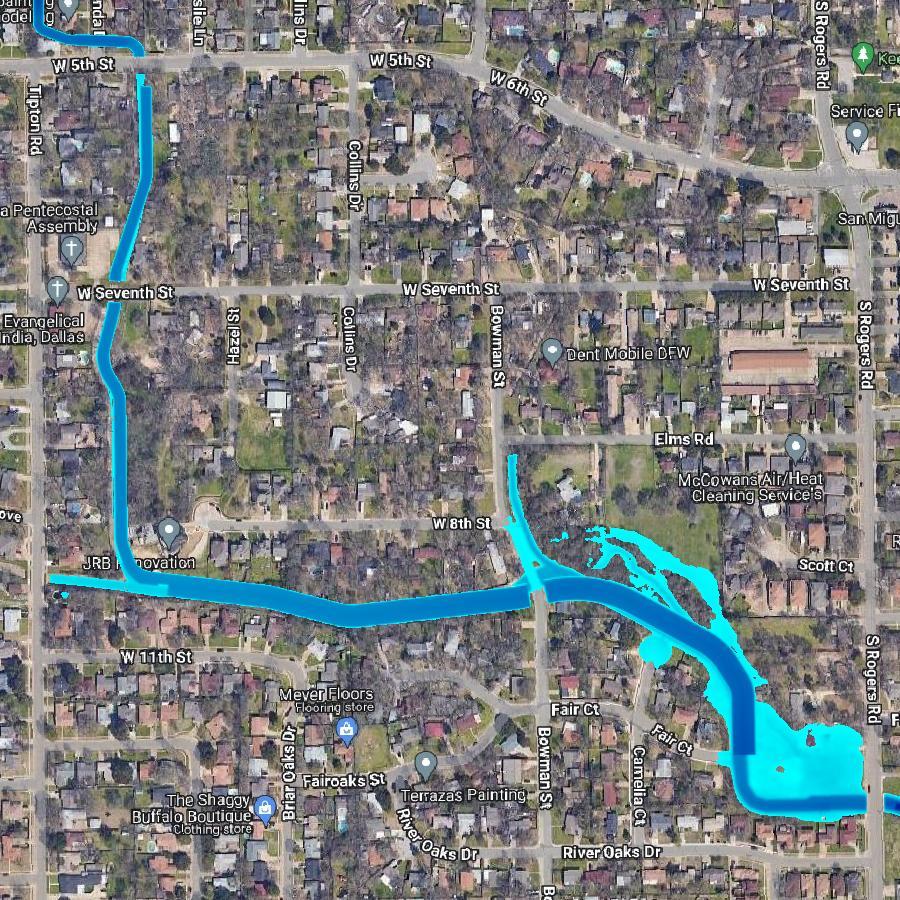

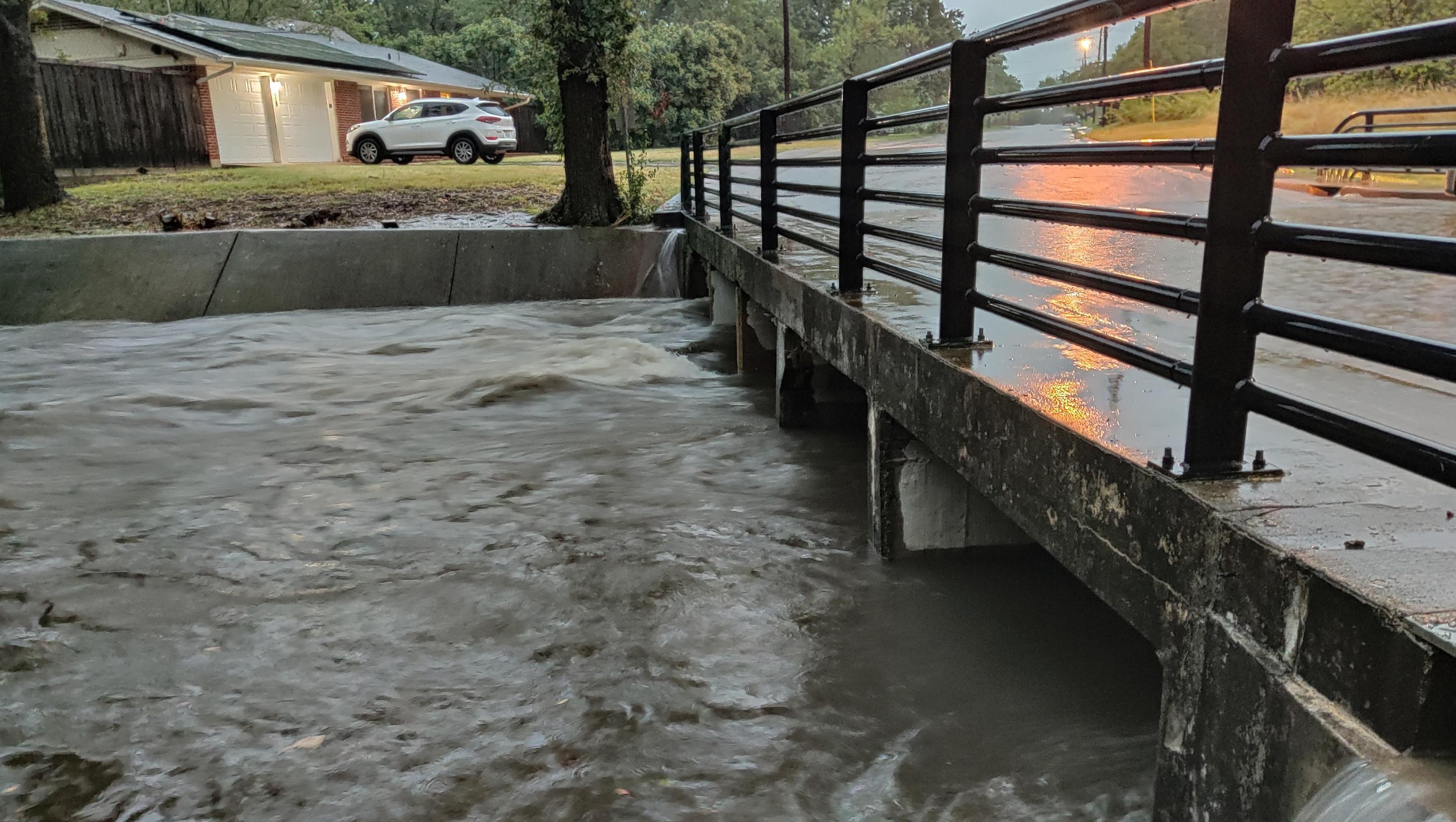

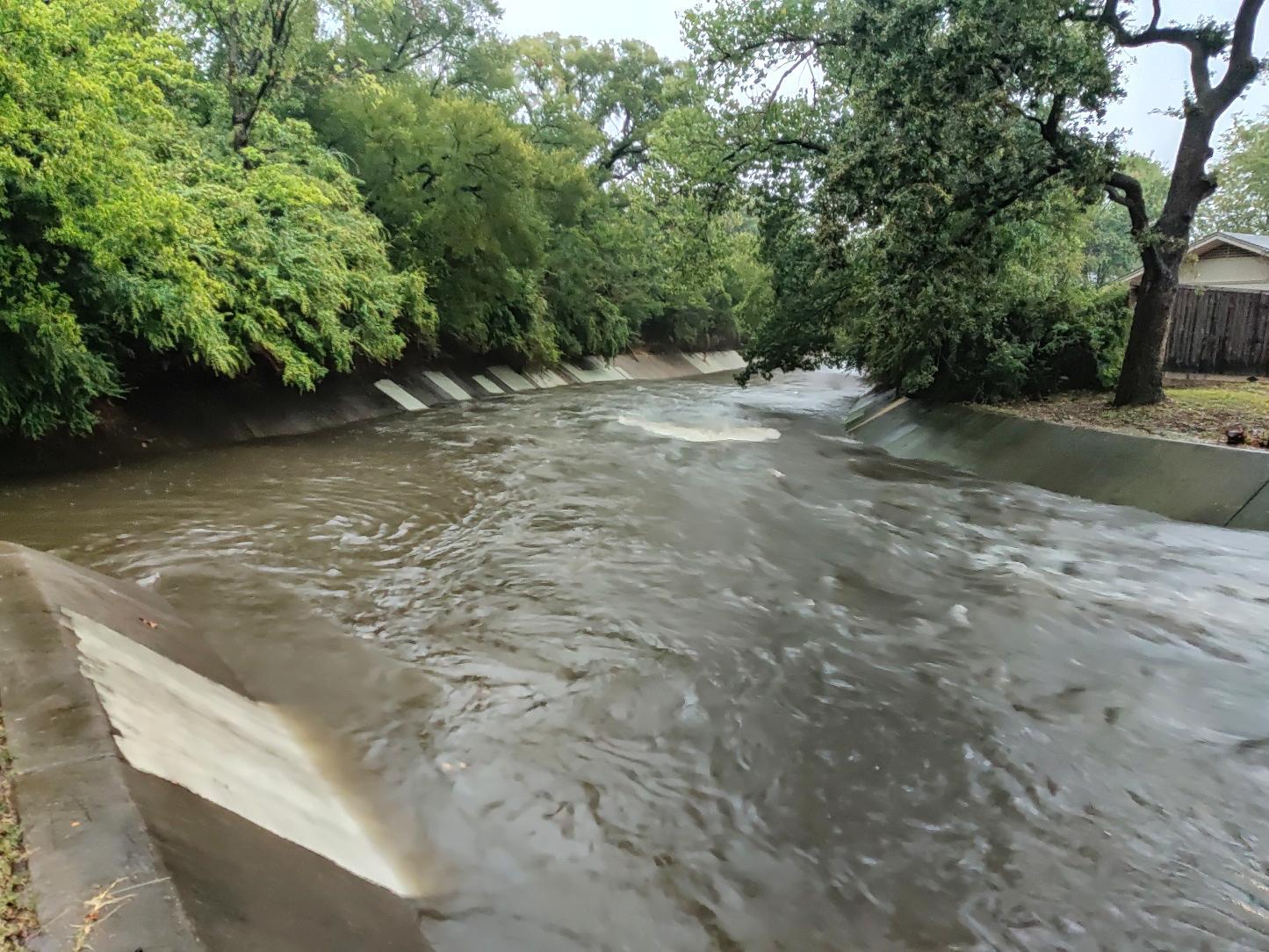

Channel Near Capacity at Bowman Street
▪ History of street and home flooding
▪ Portions not mapped by FEMA
▪ Recent improvements:
▪ Wyche Park Detention
▪ Hogbottoms Outfall Debris Collector
▪ Project led by the Municipal Drainage Utility

▪ #1 priority of the MDU
▪ Project expected to cost $90+ million
▪ Comprehensive Study completed 2021


Phase AUnder Construction


Phase BFuture Phase Phase CCurrent Project Phase DDesign Complete

▪ TWDB Flood Infrastructure Fund funded

▪ Awarded $45M grant and 0% loan in 2023
▪ Awarded $70M grant and 0% loan in 2025
▪ Over $70M in savings to the City versus typical financing!
▪ Accelerated project implementation

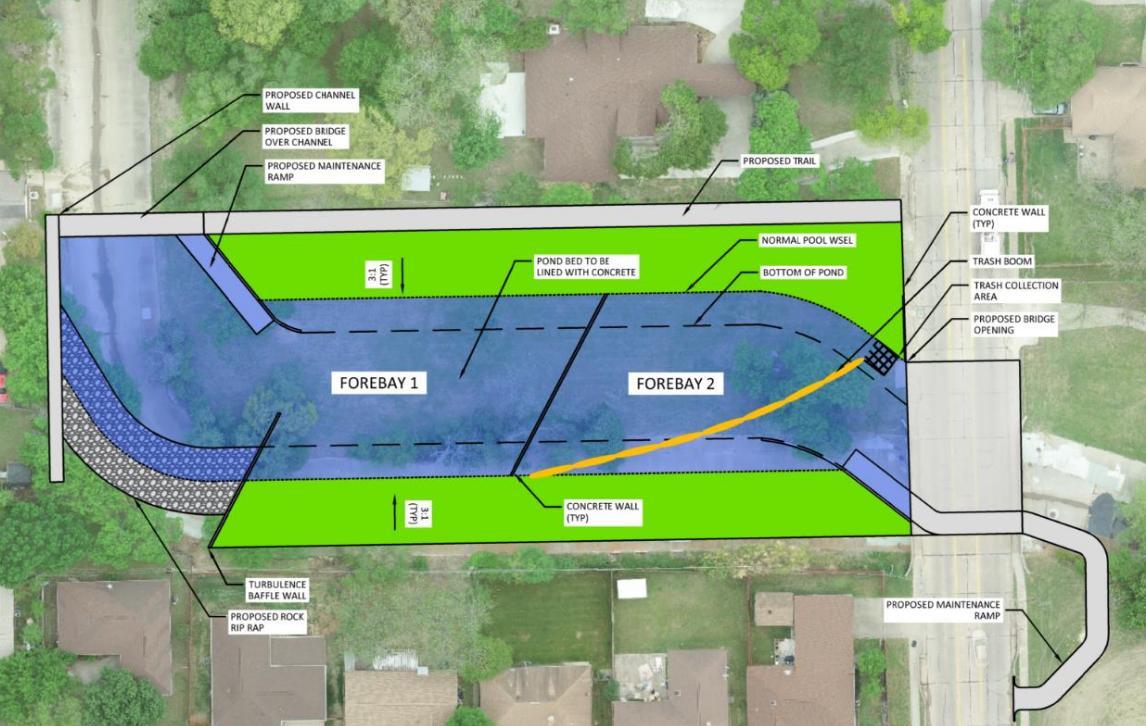

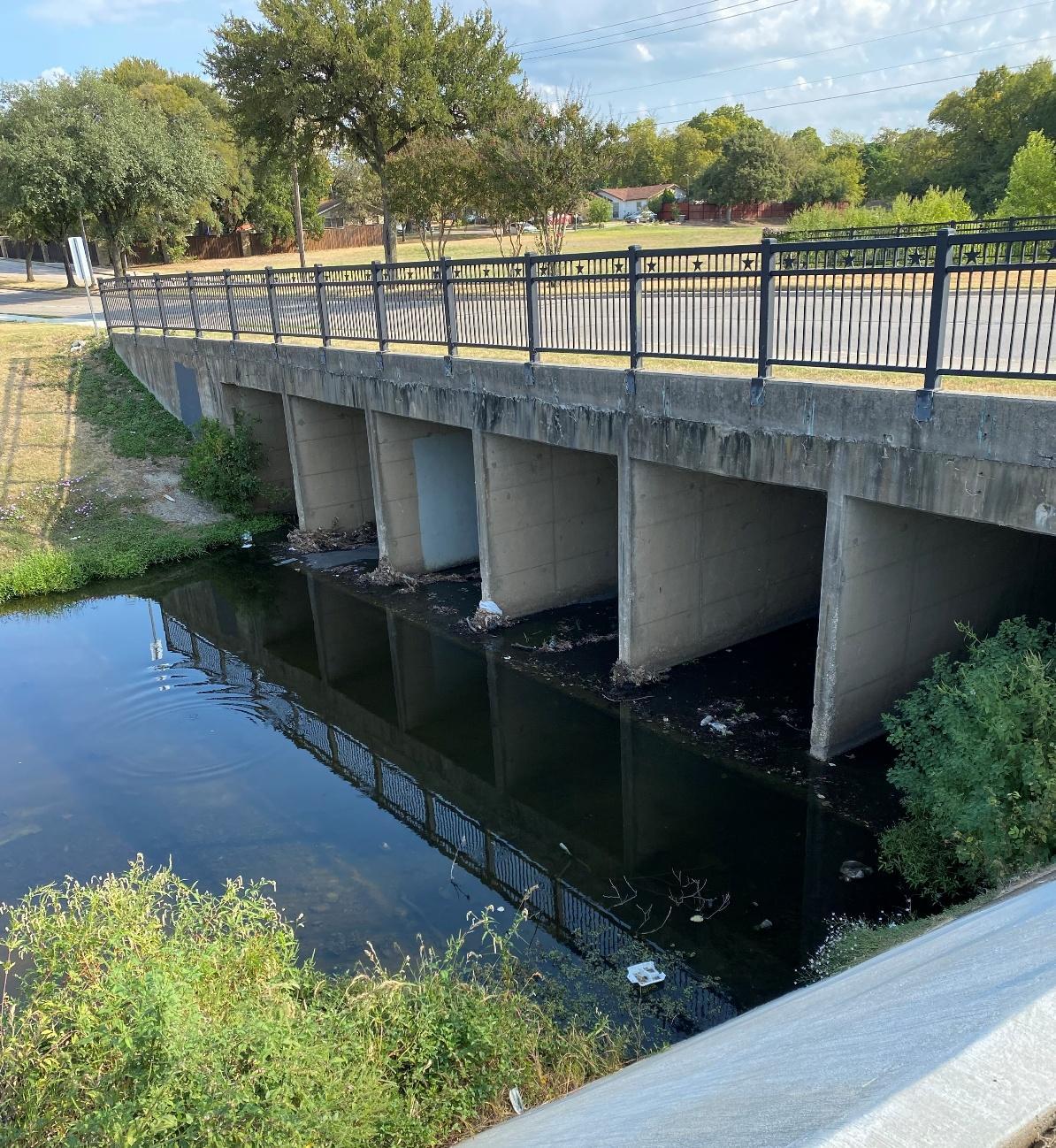

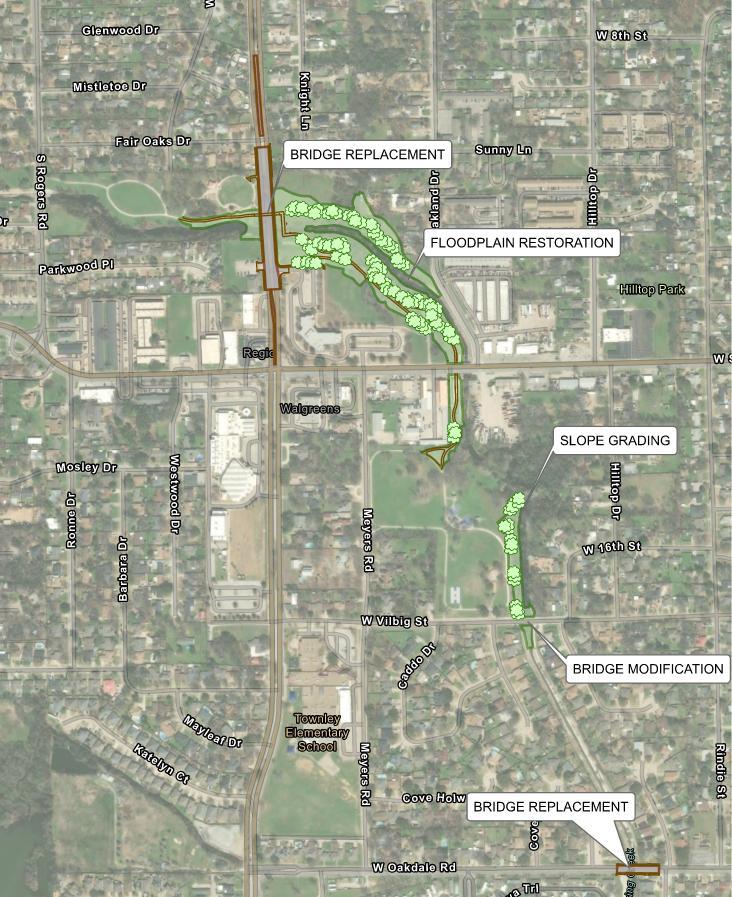

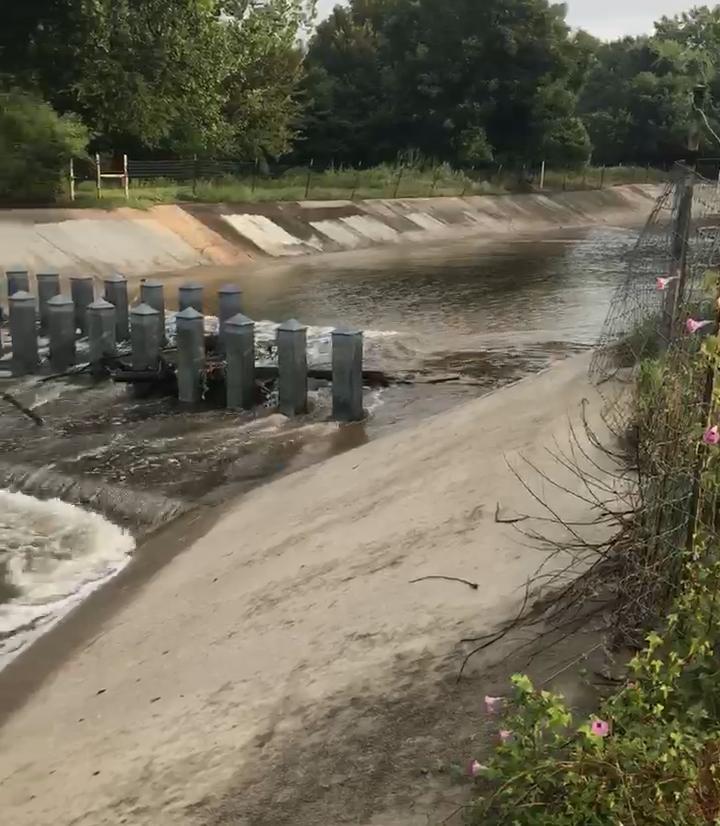

Trash/Debris Capture

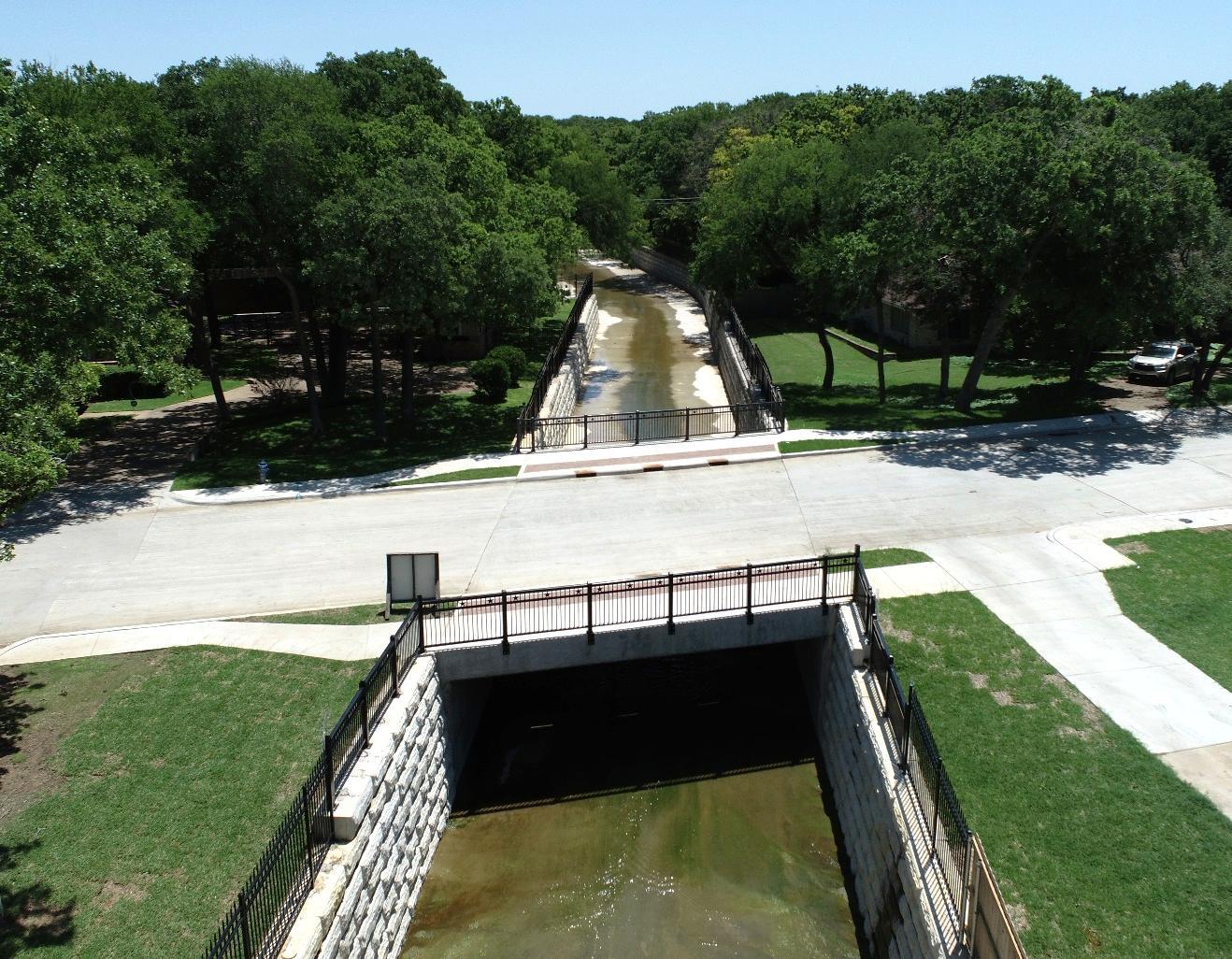

Bridges at W Vilbig Street and W Oakdale Road
Slope Grading at Shady Grove
Trail Park
Trail and Floodplain Restoration at Dallas College

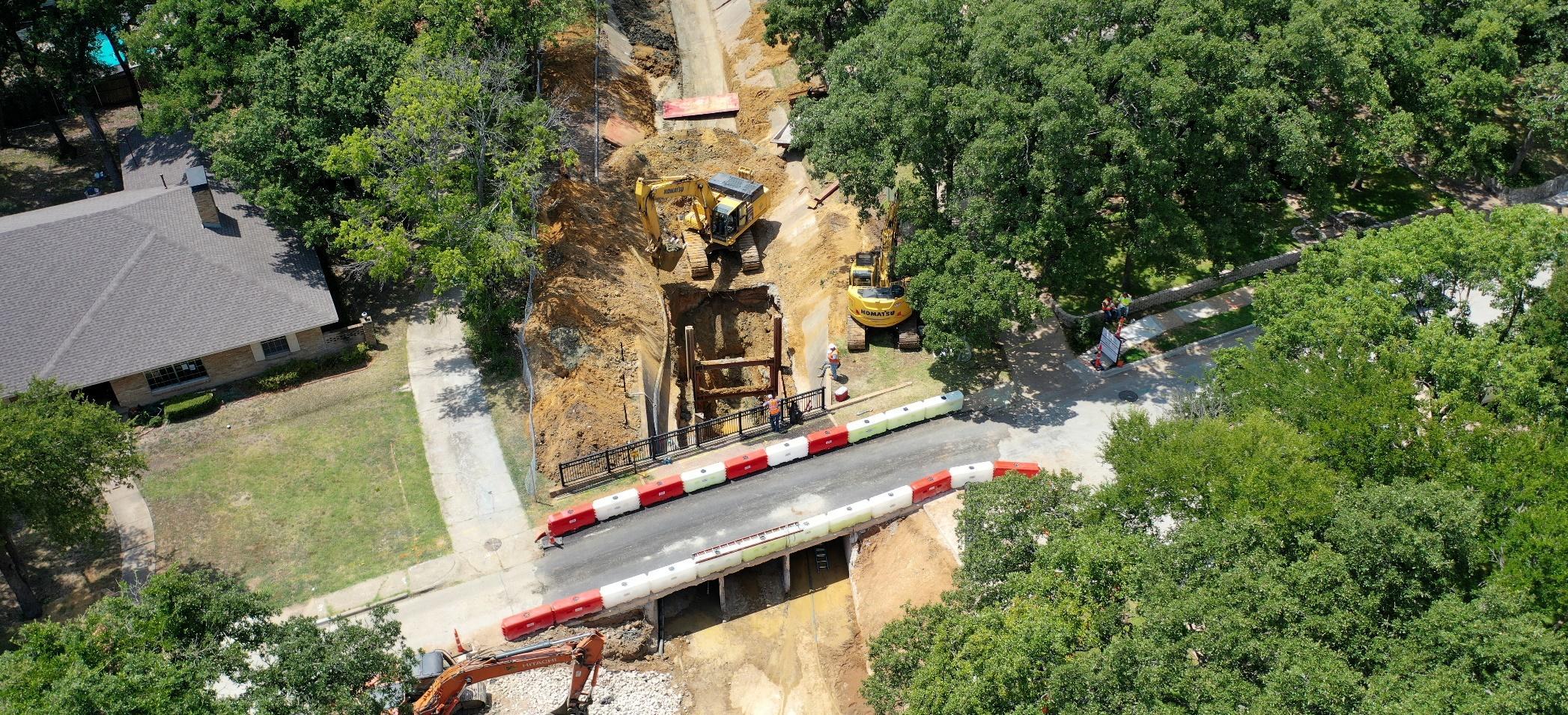

MacArthur Boulevard Bridge
▪ Goal to protect parks and downstream waterways from trash and debris

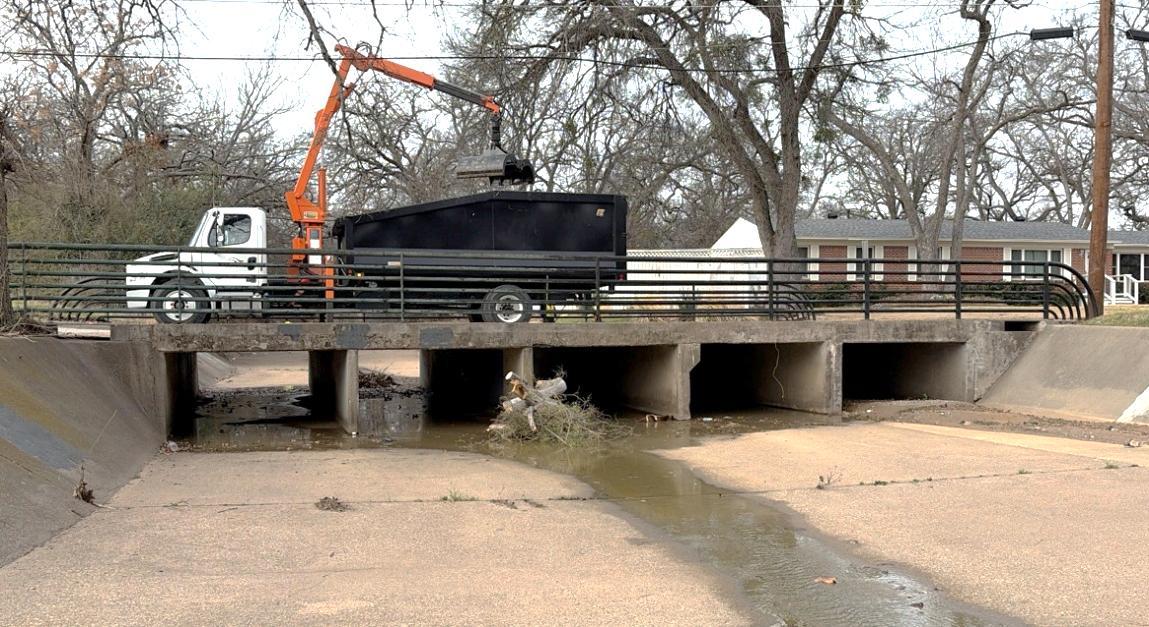

▪ Evaluating improvements to existing trash rack system
▪ Other improvements at Wyche Park and Markwood Park in other phases

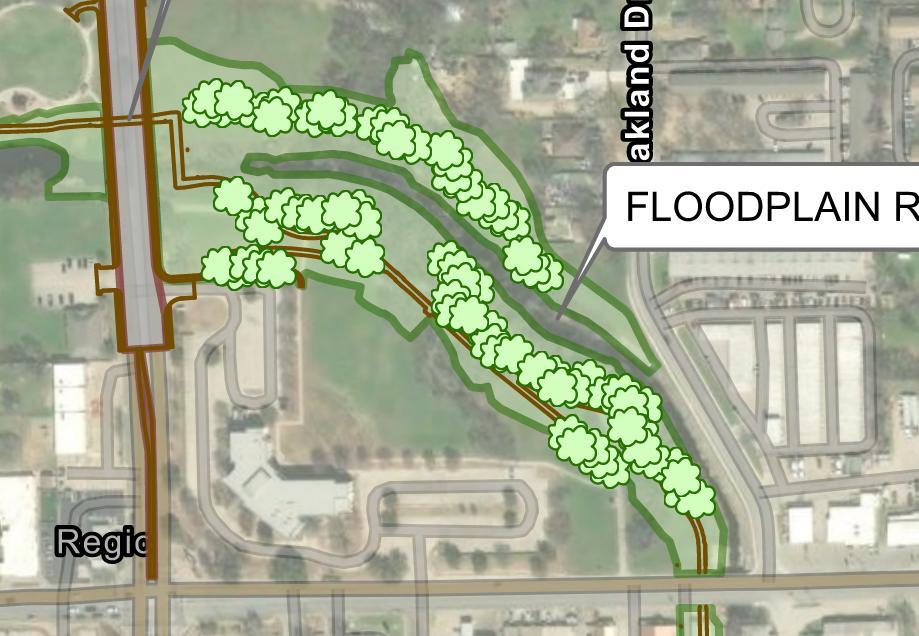

▪ Remove fill from floodplain near Dallas College

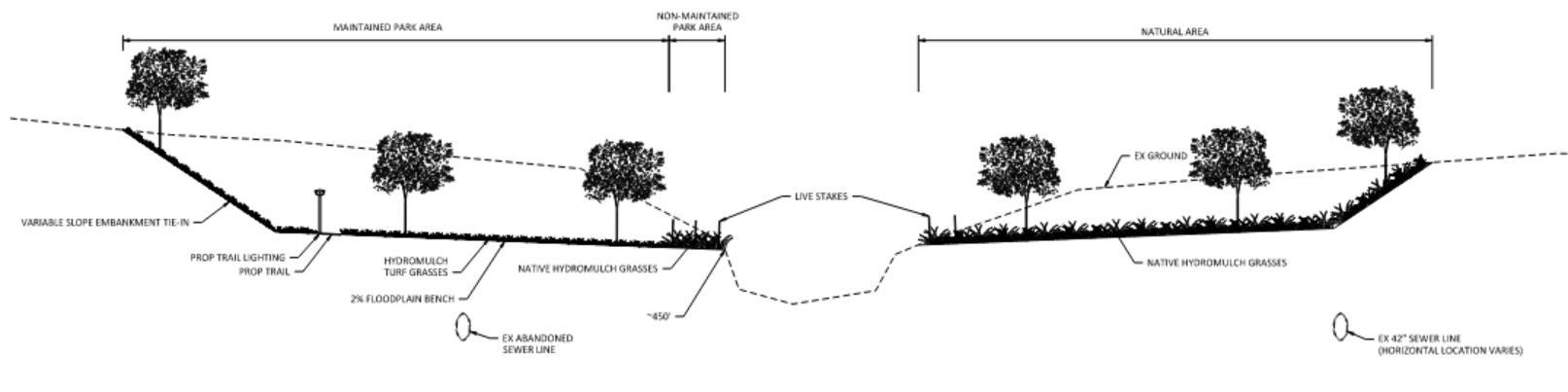

Reduce flooding and erosion
Restore riparian vegetation
Manicured turf grasses and trail near College

▪ Raise road approximately 6 feet
▪ 160 foot span over floodplain
▪ Phased to allow 2 way traffic during construction
▪ Traffic control major consideration
▪ Goal to minimize disruption

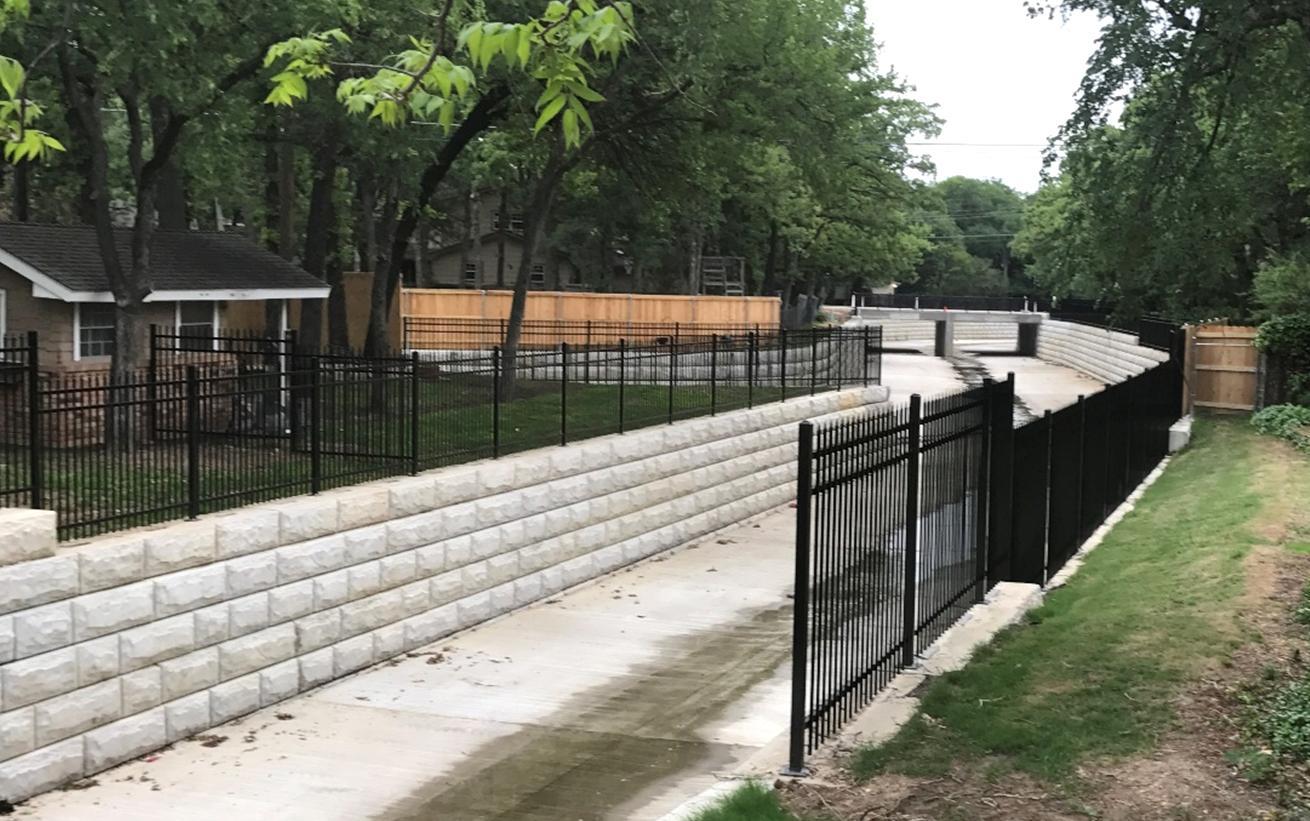

▪ Similar to recent Delaware Creek Projects

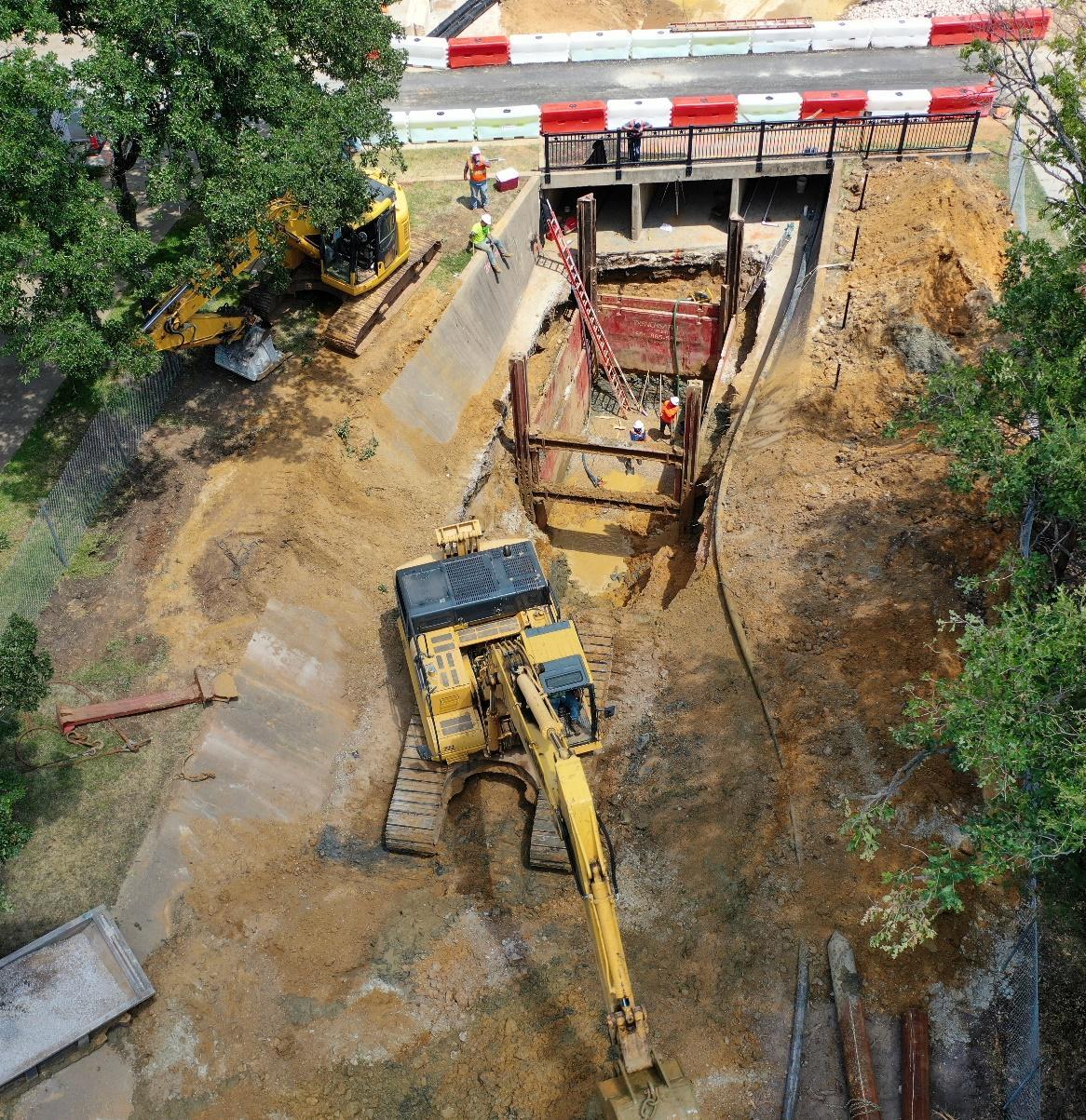

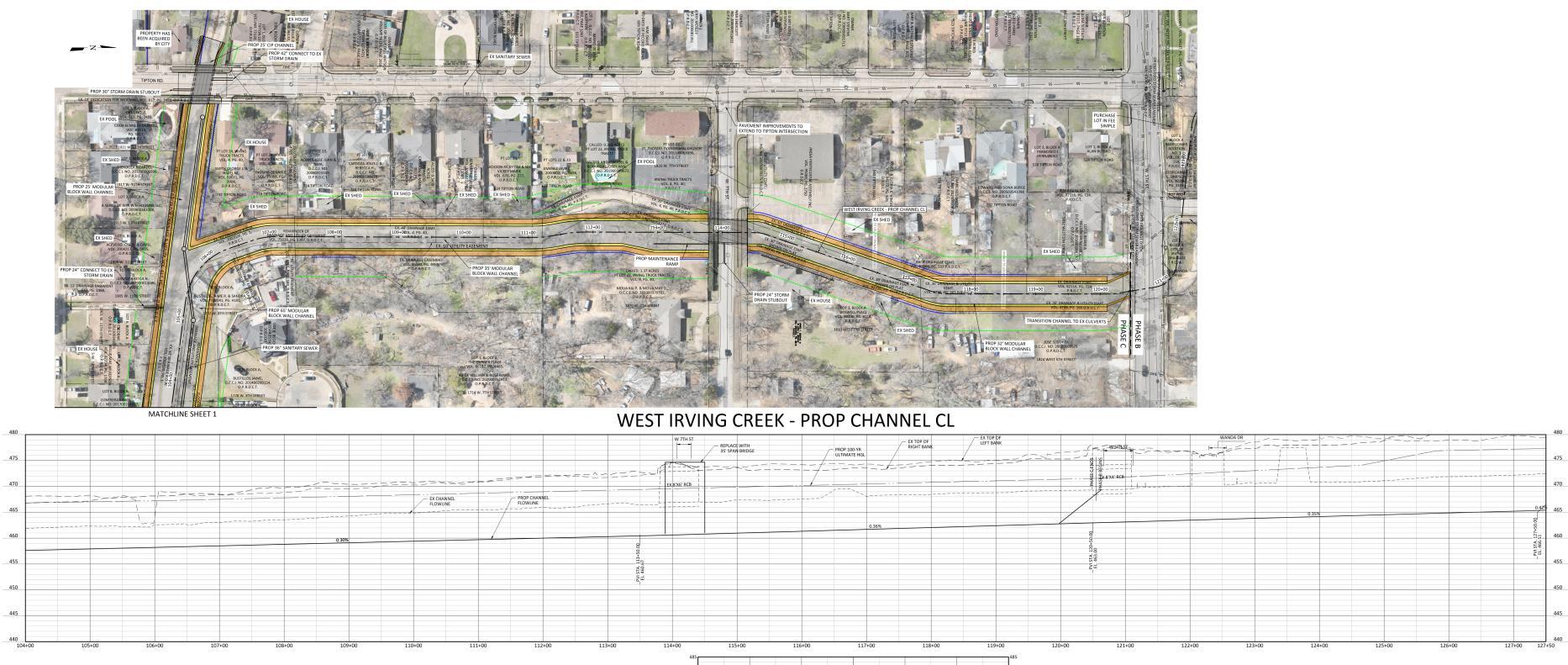

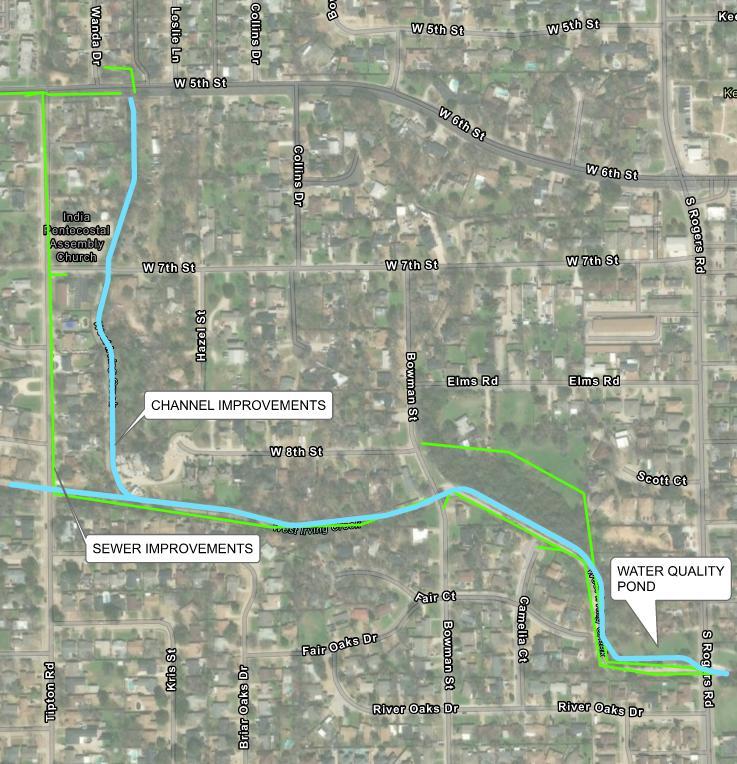

▪ Deepen and Widen Channel
▪ Minimize Footprint with Vertical Walls
▪ Replace or Add Fencing
▪ Improve Aesthetics
▪ Provide 100-Year Capacity

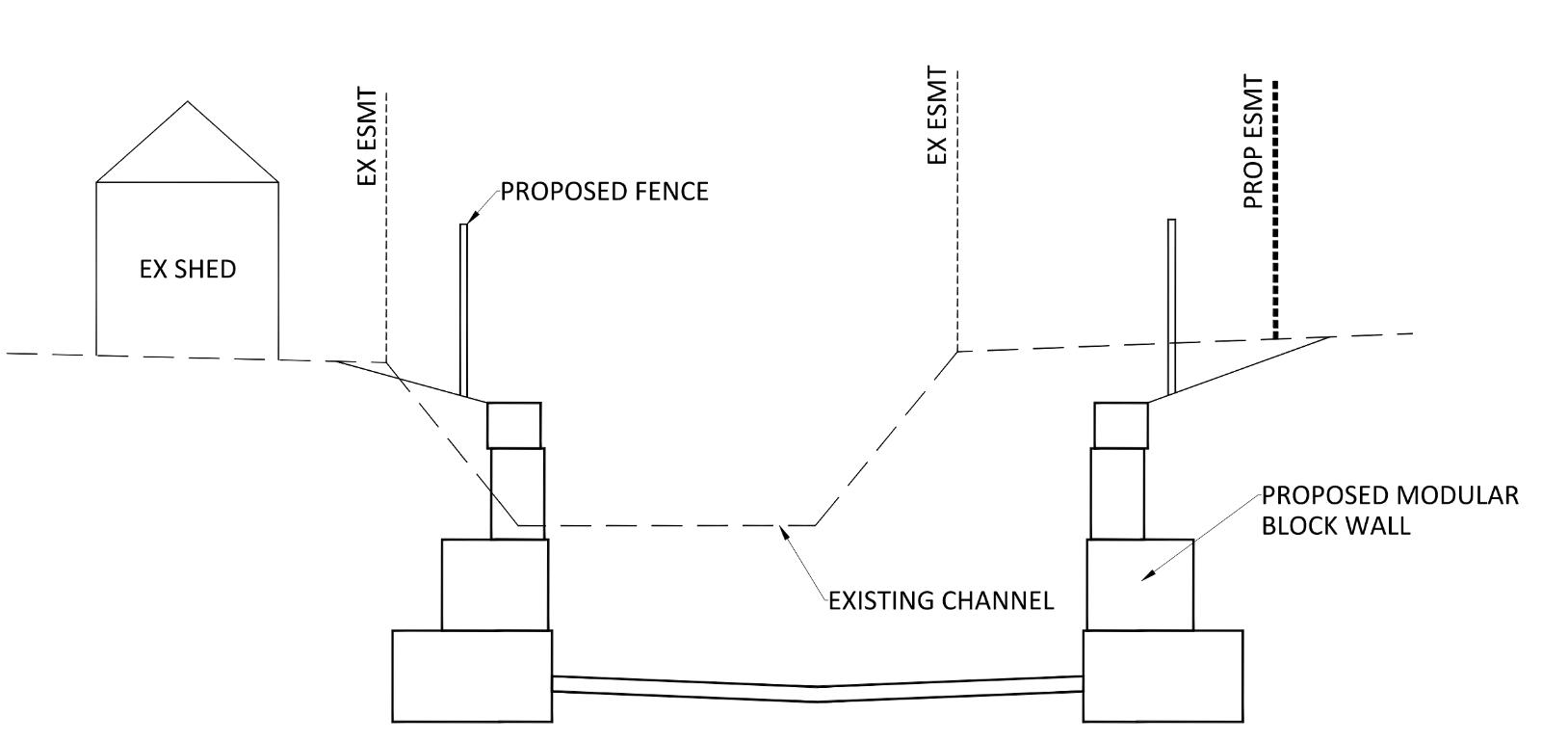

▪ Vertical walls for deeper channel

▪ Widen channel and acquire additional easement in some areas
▪ Construction footprint larger than the finished wall

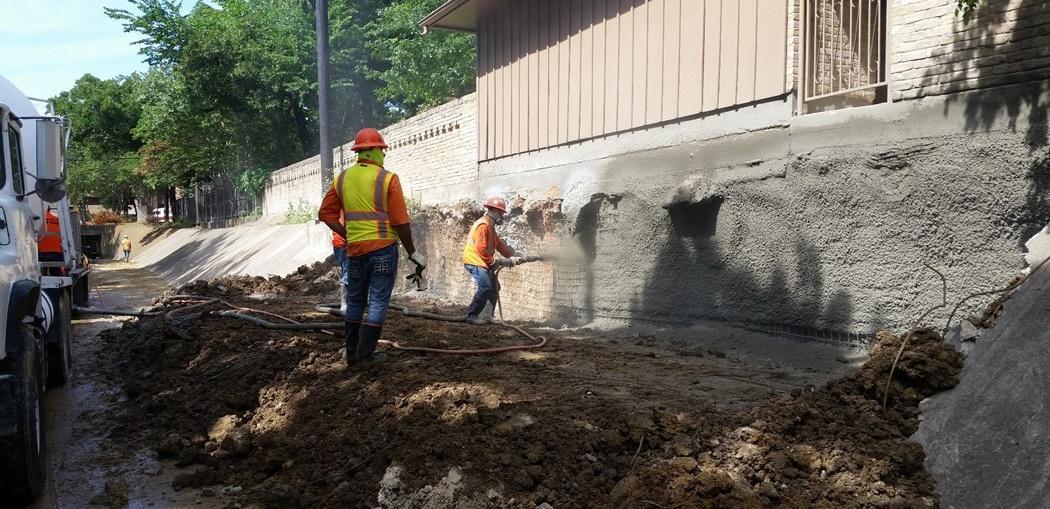

▪ Shoring to protect homes and other features near construction
▪ Access To Properties Adjacent To Channel Will Be Required For Construction
▪ Shoring Will Be Implemented To Protect Structures
▪ Property Agents Will Contact Affected Property Owners




▪ Wastewater beneath channel
▪ Other water and wastewater lines in streets
▪ Adjusted before channel work
▪ Minimize service disruption
▪ Provide capacity for future needs

▪ Collect debris and trash
▪ Protect Markwood Park, Shady Grove Trail Park, and Dallas College
▪ Pedestrian bridge providing trail connection from Fair Court to Markwood Park
▪ Will result in a continuous trail from through Dallas College to Shady Grove Trail Park

To be updated

Community Meeting #1
Field Survey Work
Engineering Plans
Property Coordination

Community Meeting #2
Bid and Award

Community Meeting #3
Construction
▪ Design completed by Q1 2023
▪ Construction expected to begin Q3 2023

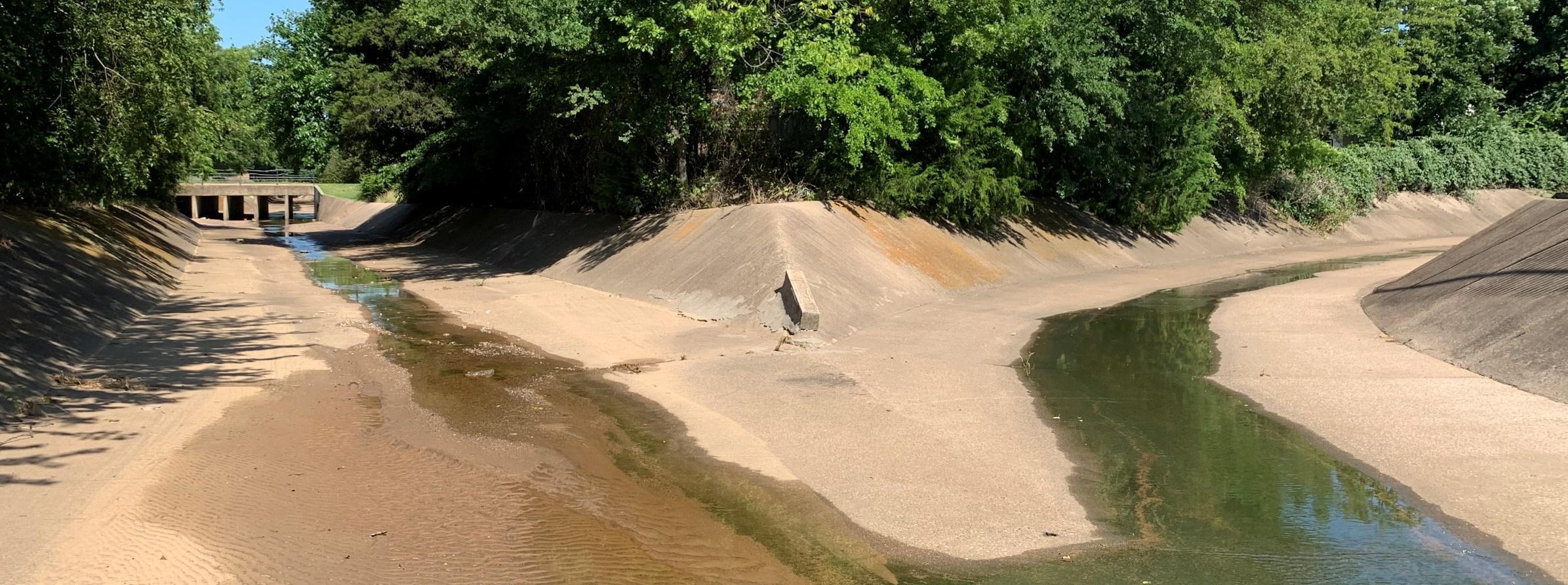

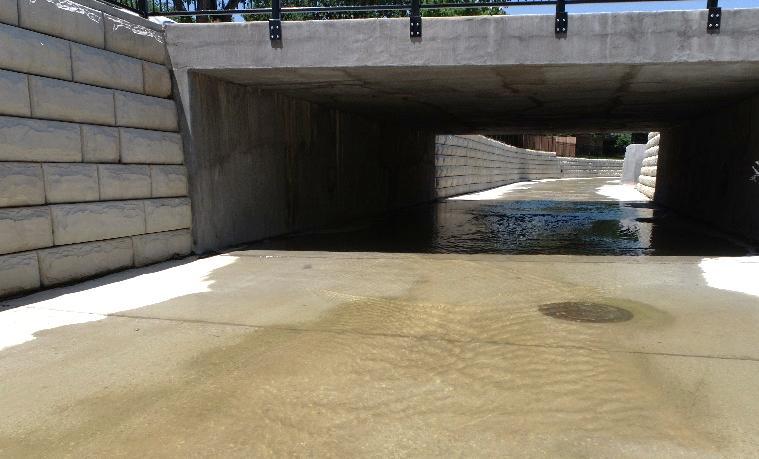

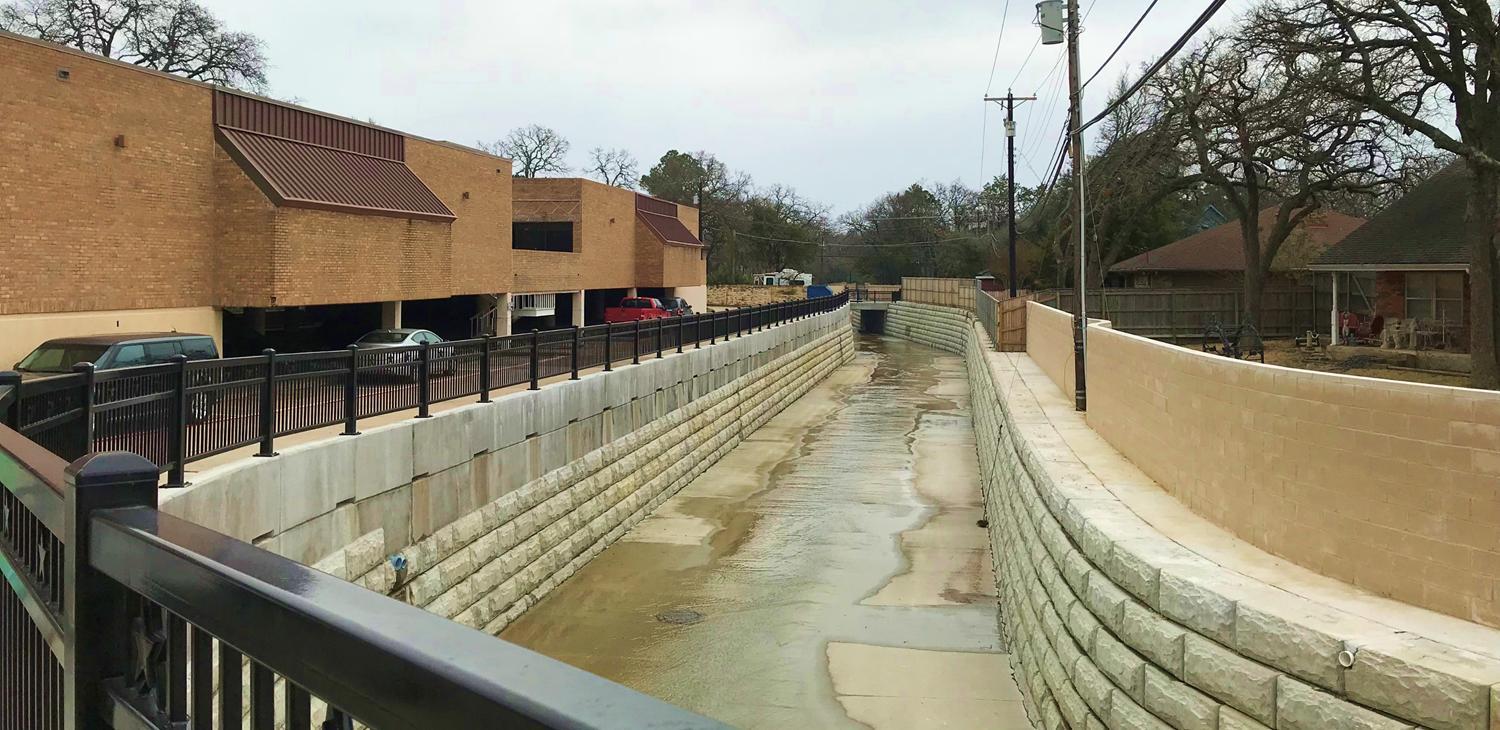

Before and After on Delaware Creek

▪ Review project concepts
▪ Ask Questions
▪ Fill out comment cards
