City of Dallas DFWIA Water Line Relocation Project
48-inch Irving and DFW International Airport Water Line Relocation
Dallas Water Utilities Contract No. 20-231
January 26, 2021
Erick Steitle
Pipeline Project Management
Dallas Water Utilities
Ben Stephens, PE, ENV SP
Halff Associates, Inc.
This presentation will be recorded.
Agenda
• Team Introductions and Meeting Format
• Existing Water Line
• Proposed Improvements
• Schedule and Next Steps
• Question and Answer
Introductions and Format
Rishi Bhattarai, P.E. 214-671-9183
rishi.bhattarai@dallascityhall.com
Erick Steitle 214-948-4248
erick.steitle@dallascityhall.com
Estela Ornelas 214-671-9554
Estela.ornelas@dallascityhall.com
Halff Associates Ben Stephens, PE, ENV SP
Meeting Format
• Presentation (30 minutes)
• Question & Answer (30 minutes)
• Questions submitted via online chat feature
• Questions will be directed to project team to answer
• Additional Questions and Responses
• Email to project manager
* Technical problems during presentation? call (214) 217- 6430
Existing Water Line
Existing Water Line
• Existing 30-inch and 48-inch Water Line is part of a system by which Dallas Water Utilities supplies water to City of Irving, Cypress Waters, and DFW International Airport.
• Constructed in 1972, prior to development in area.
• Located within an existing 20-foot-wide City of Dallas Water Easement.
• Physical encroachments on and along the easement exist due to discrepancies between the actual easement location and its location as incorrectly represented on plats of Valley Ranch 16 and Valley Ranch 24.
Existing Water Line
Access Improvement Needed
• Narrow easement through developed area is difficult to access.
• Several easement encroachments pose a risk to the structural integrity and maintenance/operability of the water line.
• Access for maintenance activity is likewise a potential risk to structures encroaching the easement.
• DWU needs to improve access to the pipeline for future maintenance/operability.
Alternatives Evaluation
• Dallas Water Utilities and Halff Associates, in consultation with the City of Irving, performed an alternatives evaluation.
• Minimizing public impact a top priority.
• Selected alternative involves relocation of the water line around Valley Ranch 16 and Valley Ranch 24, within Ranch Trail and Ranchview Drive street rights-of -way.
Performance Assessment
• The existing water line must remain in operation during construction of the proposed improvement.
• Leak and performance assessment surveys of the existing water line were performed in 2010, 2015, and 2018. No leaks were detected at those times.
• Leak and performance assessment survey was repeated in November 2020. No leaks were detected.
Proposed Improvements
Water Line Relocation
Water Line Improvements
• Install 3,140 linear feet of new 30-inch and 48-inch water line and associated valves and appurtenances.
• Aligned primarily within:
• Inner-most west-bound lane of Ranch Trail
• Inside south-bound lane of Ranchview Drive
• Associated pavement and affected utility repairs/replacements to City of Irving standards.
• Abandon existing 30-inch and 48-inch water lines in place by filling with grout.
• Release City of Dallas Water Line Easements following construction.

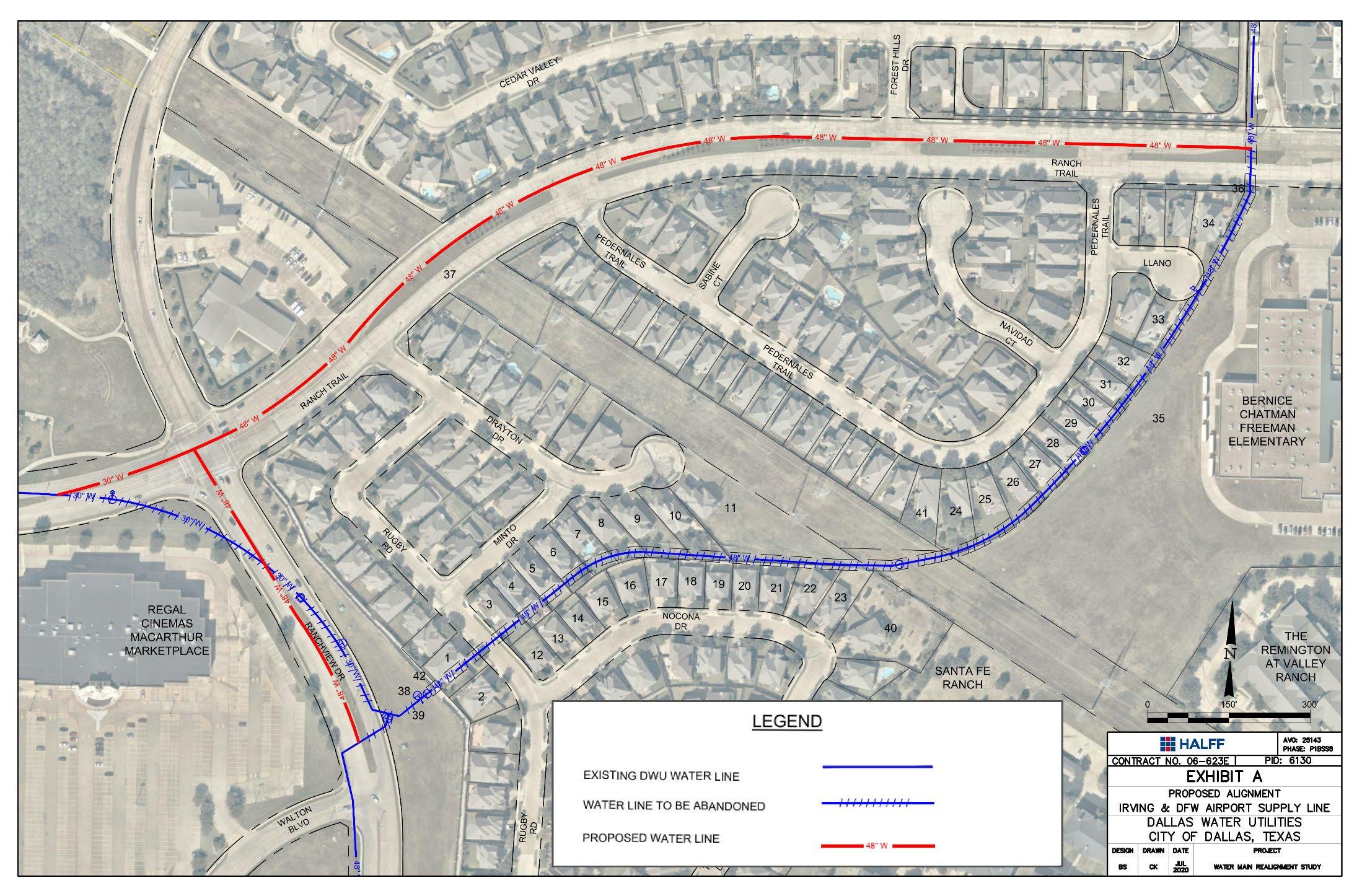

Proposed Water Line
Proposed Water Line
What to Expect During Construction

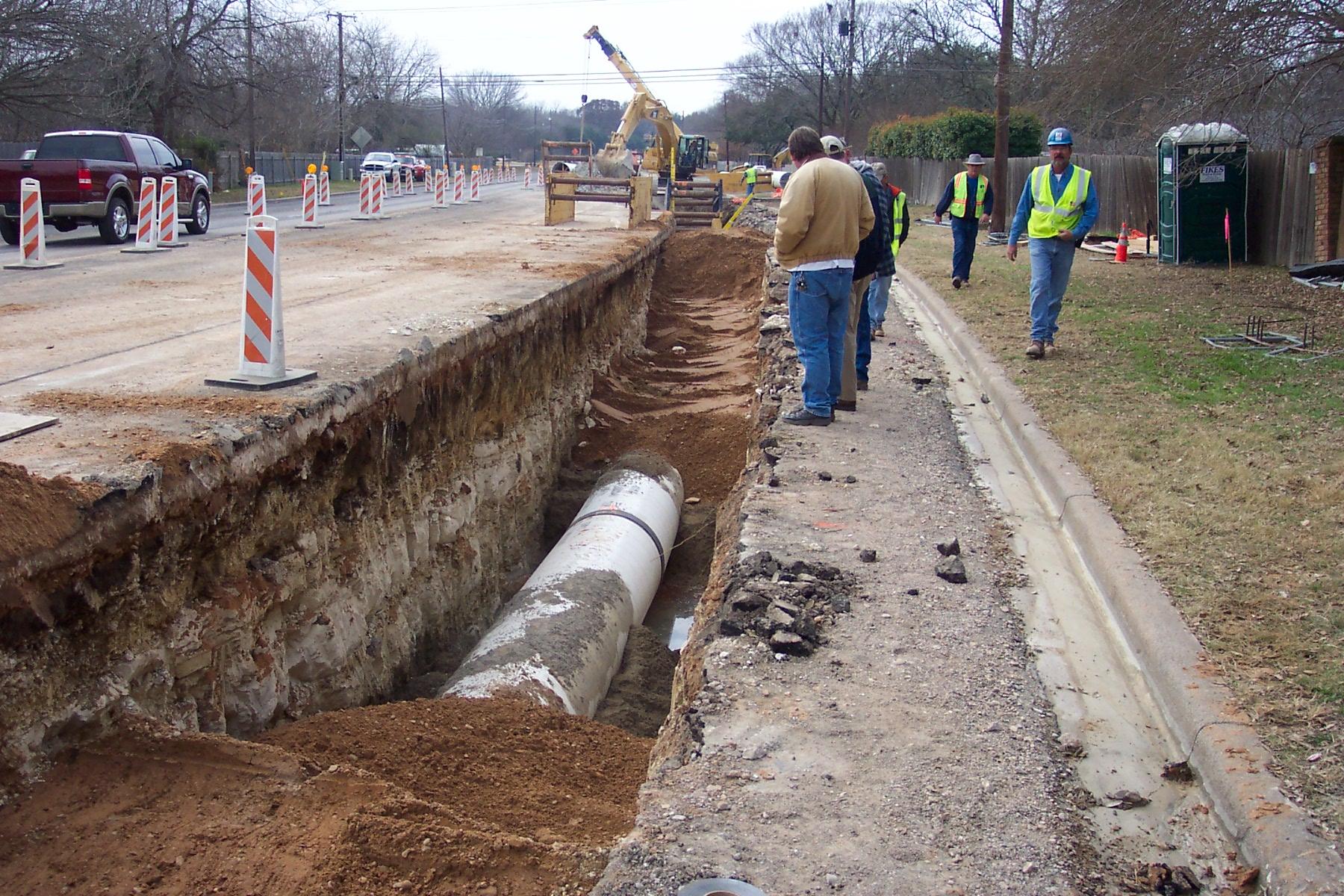

• Contractor will use street right-of -way for trenching and water line installation, construction vehicle traffic, and equipment storage.
• Detailed Traffic Control Plan (TCP) to be developed by the Contractor.
• TCP submitted for review and approval to City of Irving.

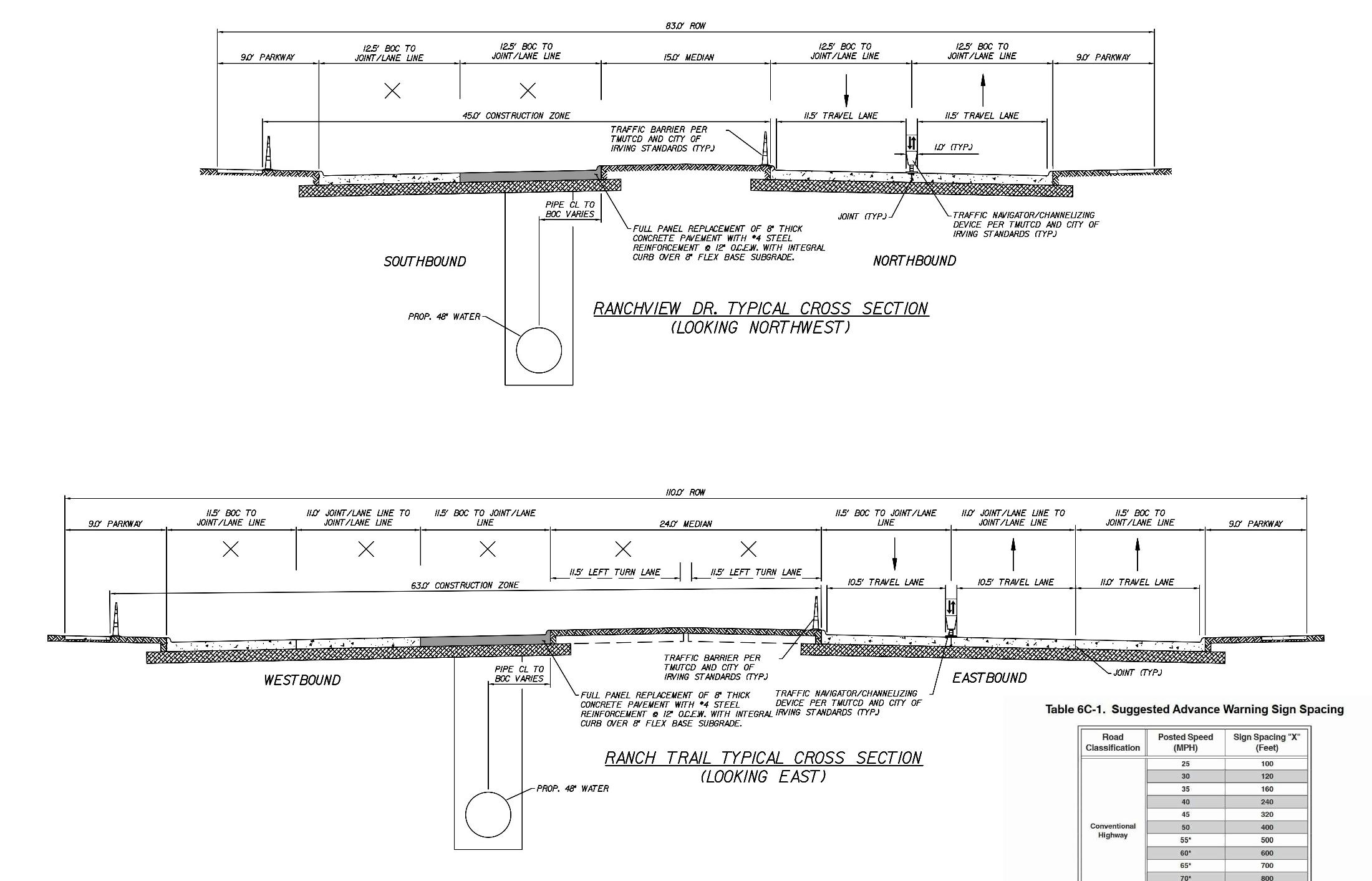

What to Expect During Construction
What to Expect During Construction

• Ranch Trail:
• Current anticipation (specific plan to be developed by Contractor): Contractor to use west-bound lanes and median. East-bound lanes to be temporarily converted to two-way traffic.
What to Expect During Construction

• Ranchview Drive:
• Current anticipation (specific plan to be developed by Contractor): Contractor to use south-bound lanes and median. North-bound lanes to be temporarily converted to two-way traffic.
Schedule
and Next Steps
Project Schedule
• Project Bid – June 2020
• Construction Contract Awarded – October 2020
• Start of Field Activities – Anticipated February 2021
• Complete Construction – Anticipated Winter 2021/2022
• Release of Easement – Anticipated Spring 2022, following construction completion and pending Dallas Council approval
Community Updates
Phase
Comments
Construction Start Winter 2020/2021 Community Meeting
Construction InProcess Summer 2021 Community Update
