April 22, 2025: West Irving Creek Public Meeting

Page 1

CAPITAL IMPROVEMENTS PROGRAM

WEST IRVING CREEK

Channel Improvements from W Pioneer Drive to Alan-a-Dale

Public Meeting for Construction

April 22, 2025

1

2

INTRODUCTIONS & BACKGROUND

PROJECT OVERVIEW

3

4

CONTRACTOR INTRODUCTION

MEETING AGENDA

Q&A AND BREAKOUT

1.

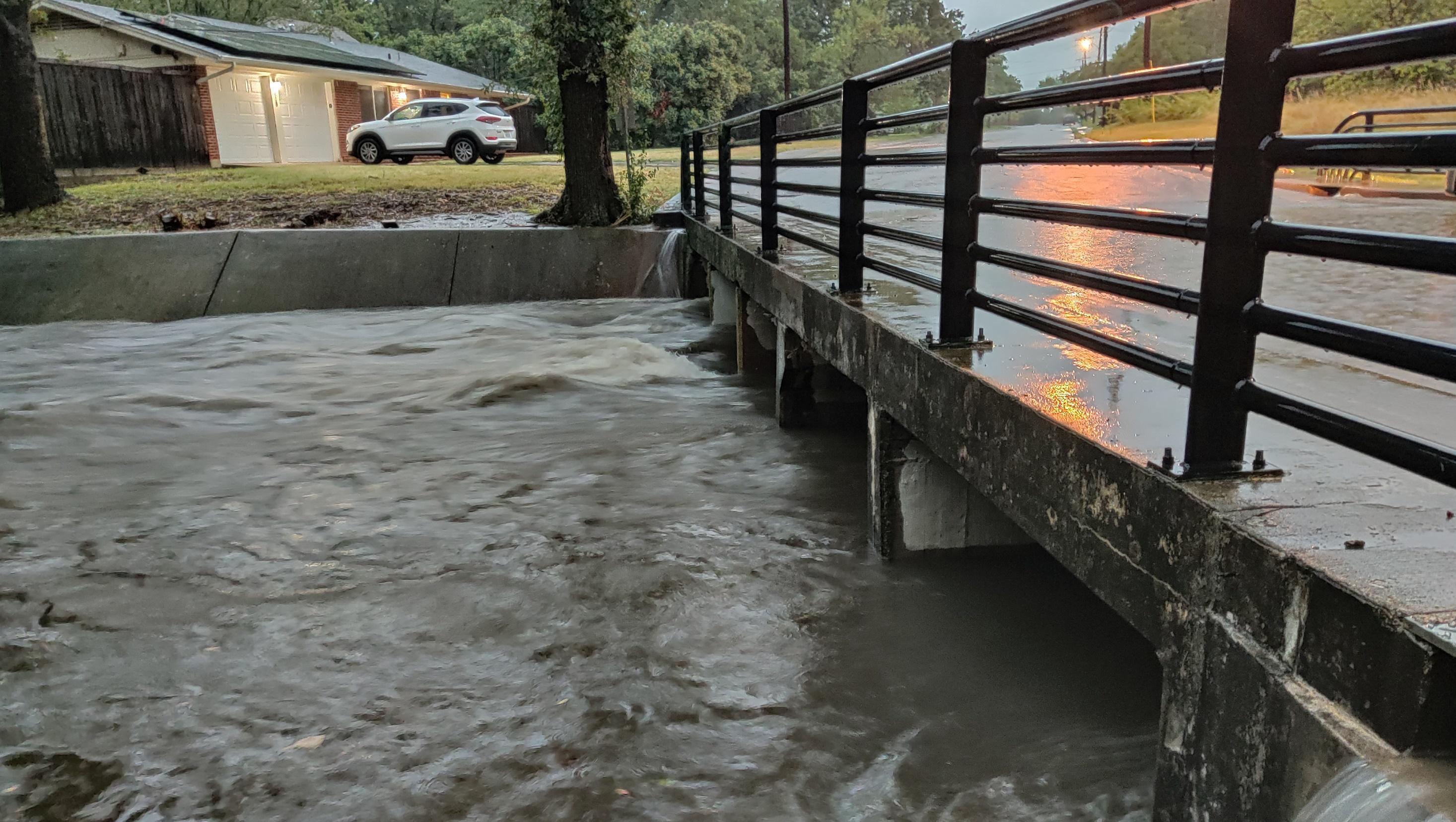

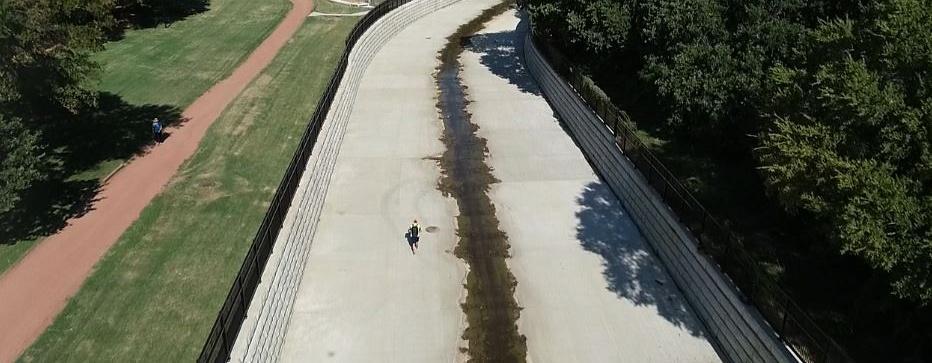

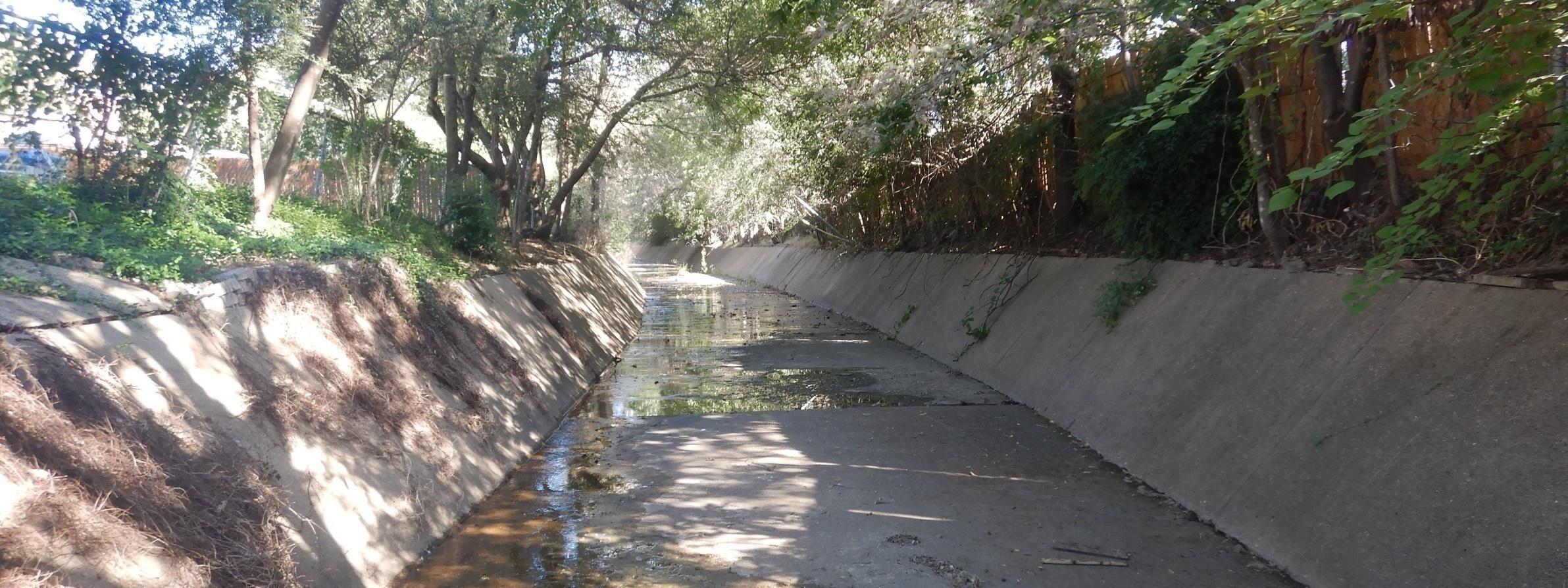

Existing Channel Upstream of Conflans

INTRODUCTIONS & BACKGROUND

TEAM

HUMPHREY & MORTON CONSTRUCTION

IRVING CITIZENS

IRVING

MAYOR/CITY COUNCIL

CAPITAL IMPROVEMENTS

PARKS AND RECREATION

WATER UTILITIES

WHAT IS WEST IRVING CREEK?

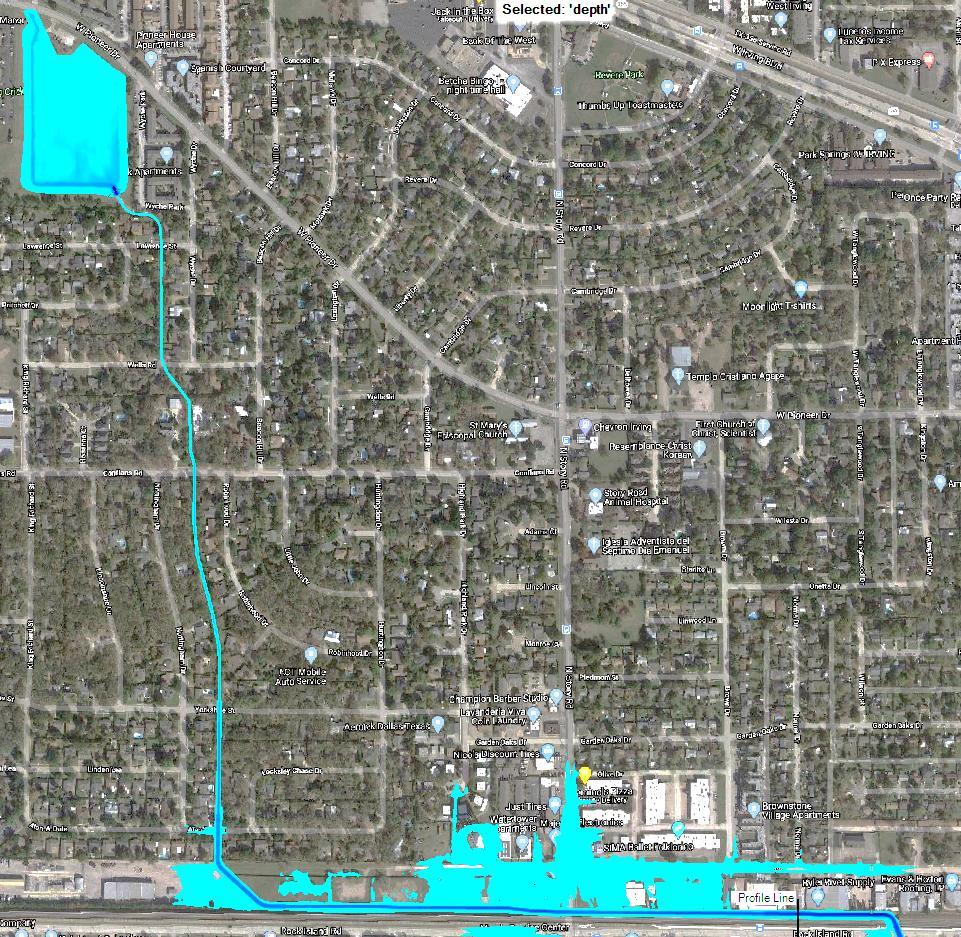

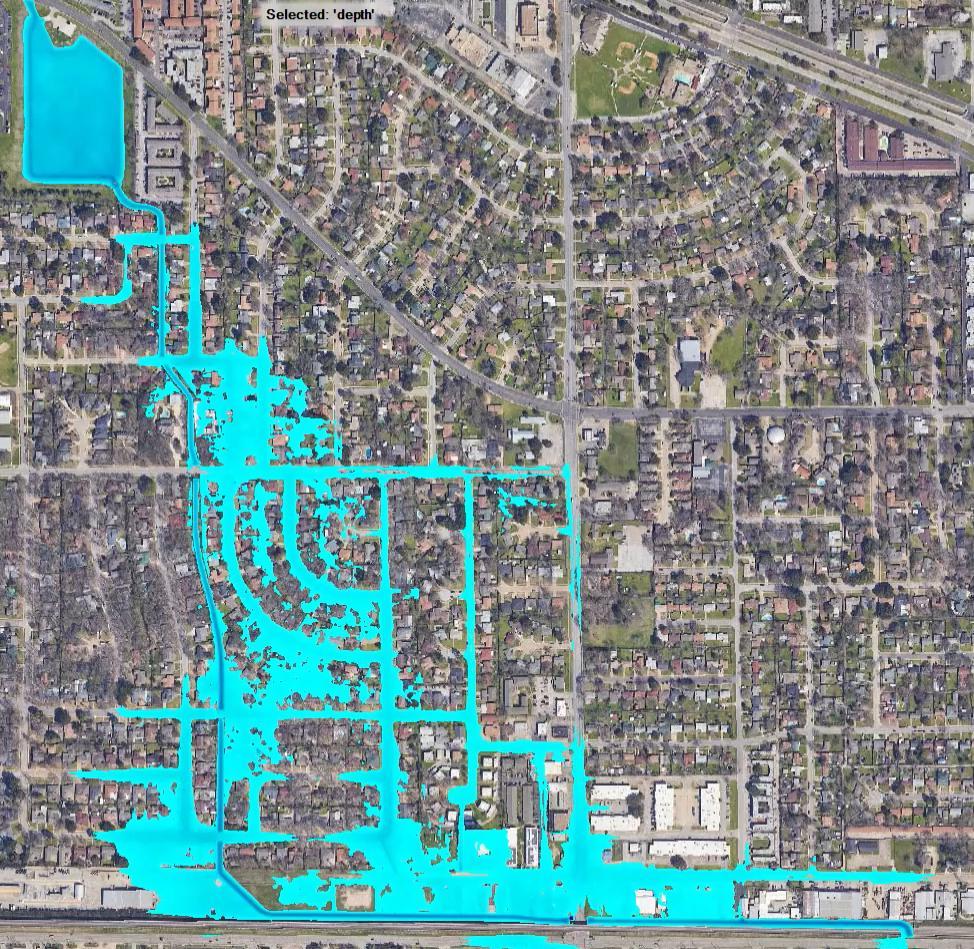

▪ Drains 15%+ of the City south of SH-183- over 3 square miles!

▪ Runs for 3+ miles from Wyche Park at Pioneer Road to outfall south of Oakdale Road

▪ Constructed in the 1960s

▪ Inadequate to meet current standards for 100-year flood capacity

Phase ACurrent Project Phase BFuture Phase Phase CFuture Phase Phase DFuture Phase

PHASED CAPACITY IMPROVEMENTS

FLOOD INFRASTRUCTURE FUND

▪ City was awarded $45M grant and 0% loan from Texas Water Development Board (TWDB)

▪ Funding

▪ Phase A – $24M TWDB Funded

▪ Phase B – Not Funded

▪ Phase C – Possible TWDB Funding

▪ Phase D – $21M TWDB Funded

▪ Project construction was delayed for the grant application

PROJECT OVERVIEW 2.

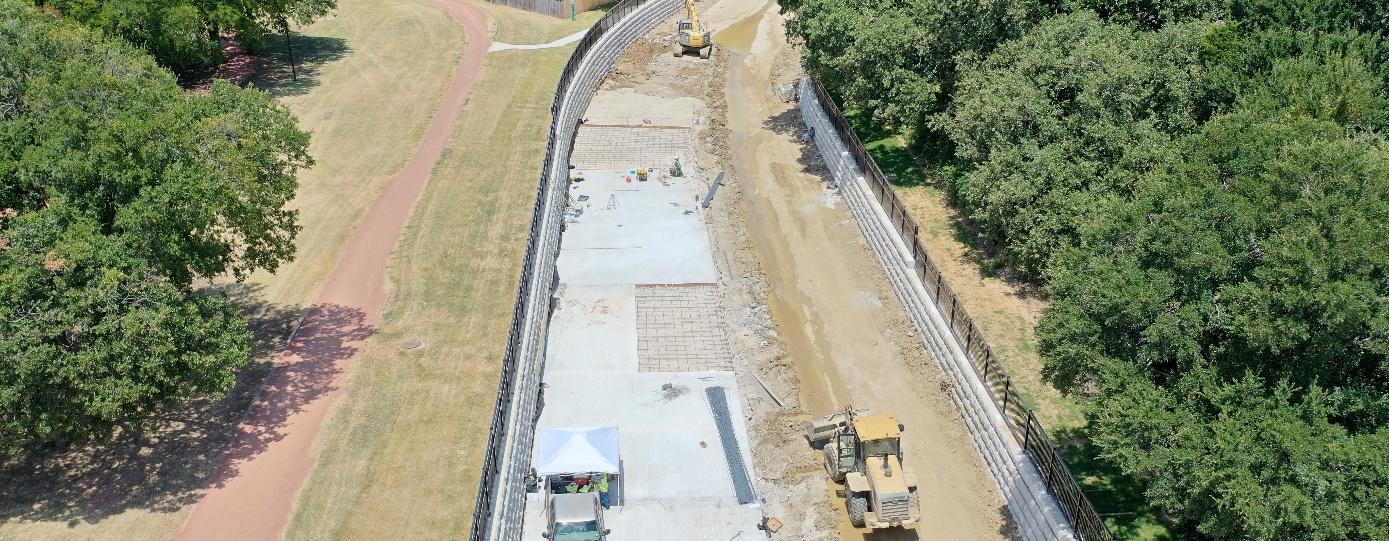

Delaware Creek Construction

PROJECT LIMITS

ROCK ISLAND RD
CONFLANS RD

PROJECT BENEFITS

CAPACITY

▪ Improvements similar to recently completed Delaware Creek

▪ Provide 100-Year Capacity

▪ Increase Detention at Wyche Park

▪ Reconstruct Channel with Vertical Walls

▪ Increase Capacity with Minimal Footprint

▪ Replace or Add Fencing

▪ Improve Aesthetics

Delaware Creek

CHANNEL

BRIDGES

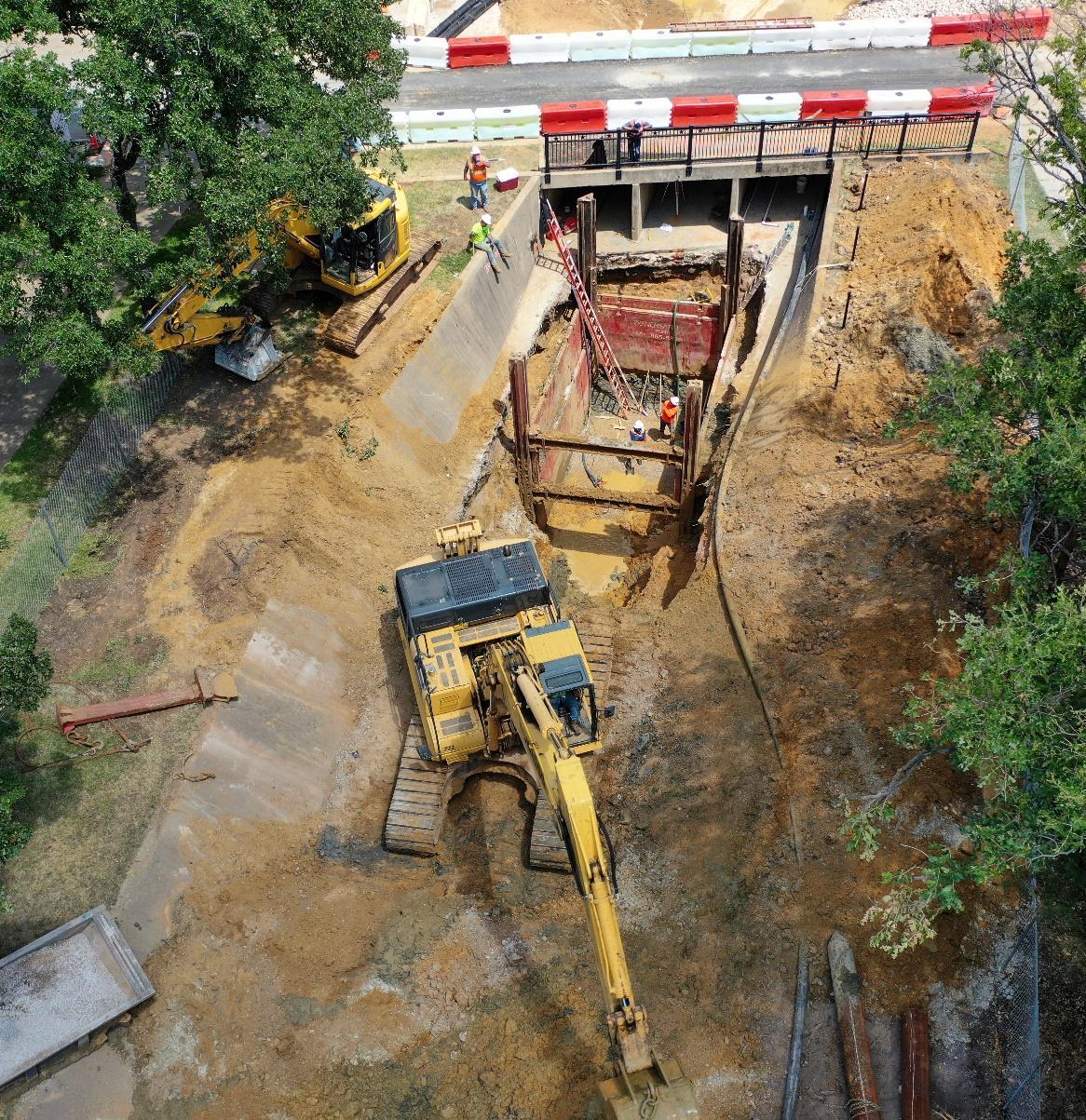

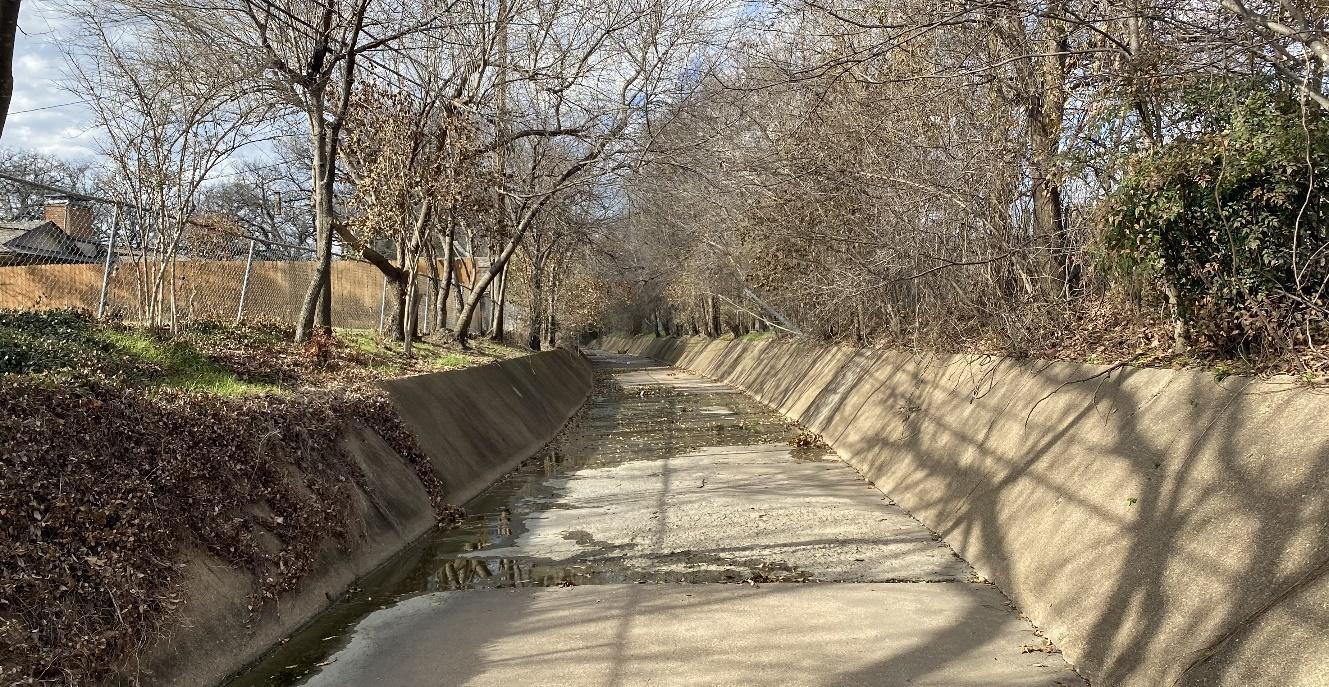

Existing Crossing

▪ 5 Bridge Replacements

▪ Replace Small Culverts with Large Single Span

▪ Improve Aesthetics

▪ Maintain Access

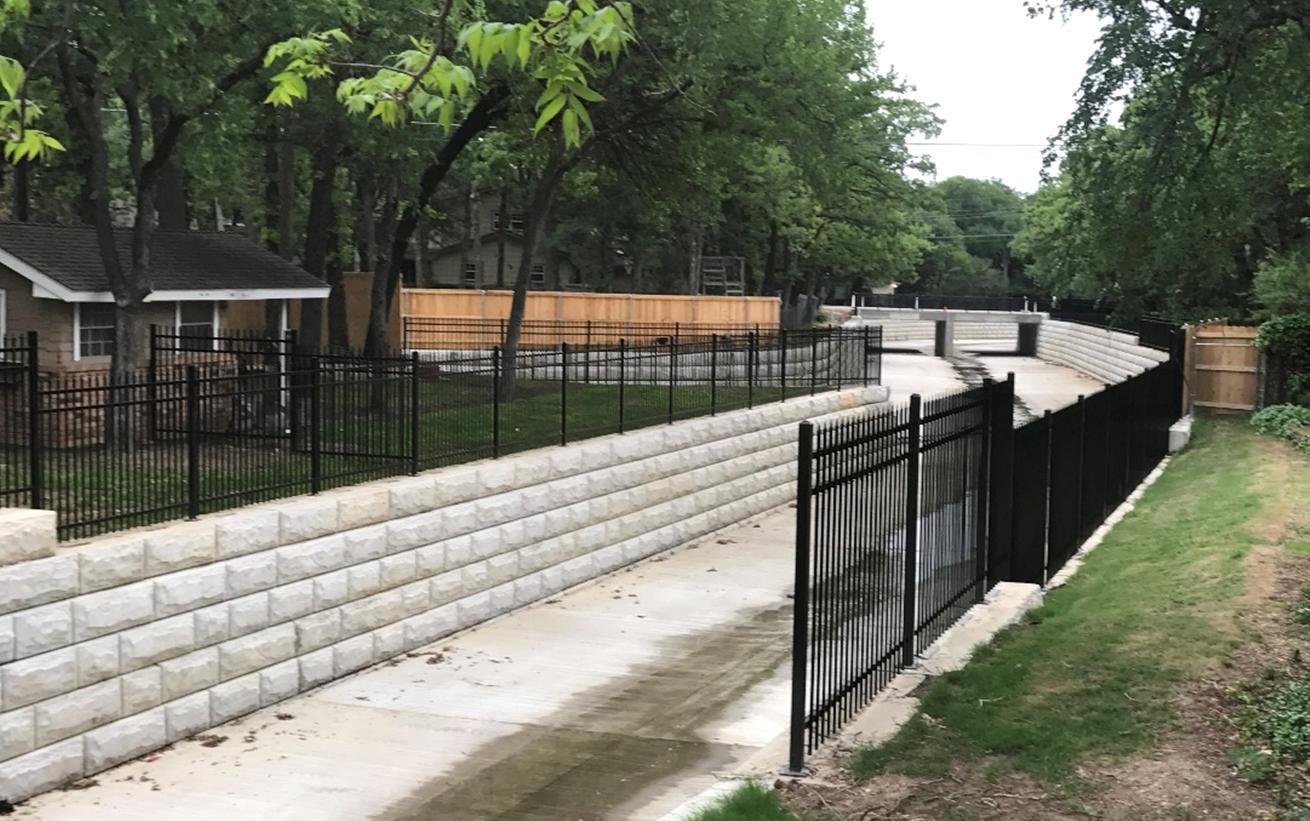

Single Span Bridge Delaware Creek

WATER &

▪ Replacing 3400’ Wastewater Main Beneath/Parallel to Channel

▪ Adjusting 5 Water Line Locations

▪ Adjustments To Be Made Before Channel Work

▪ Minimize Service Disruption

▪ Provide Capacity for Future Needs

WASTEWATER

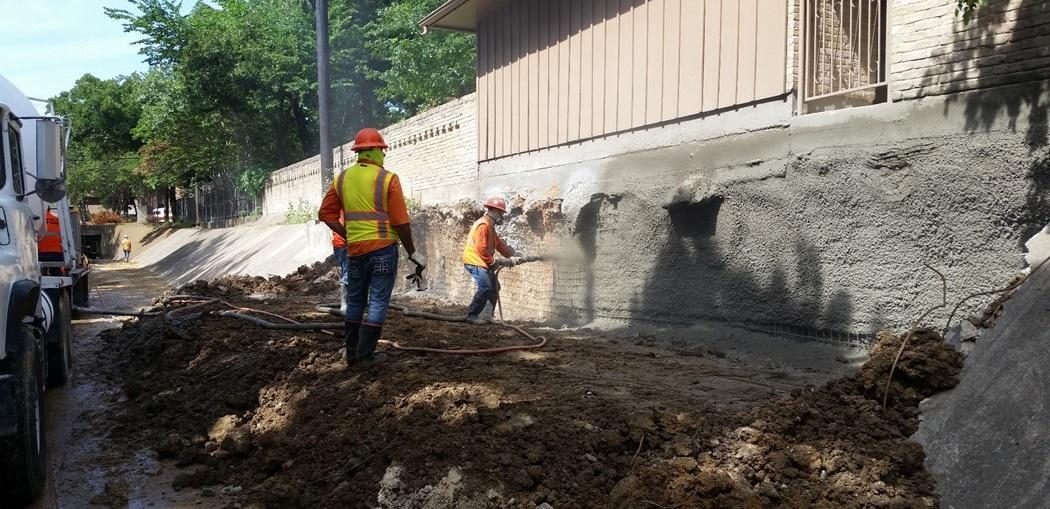

Wastewater Bore Delaware Creek

CHANNEL

SECTION

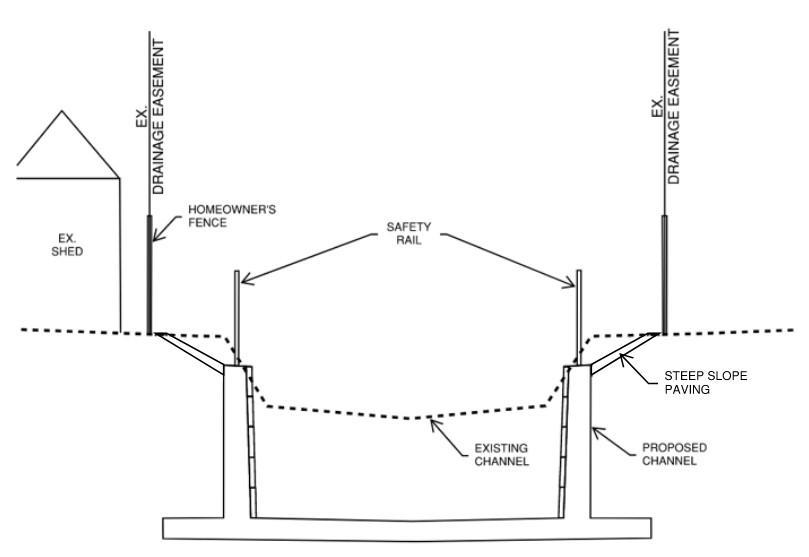

▪ Vertical Walls for Deeper Channel

▪ Fits In Narrow Easement Behind Residential Lots

▪ Construction Footprint Wider Than Finished Wall

▪ Relocation or Shoring May Be Necessary for Sheds, Storage Buildings, etc. Within or Adjacent to Easement

CHANNEL

FENCING

▪ Channel Area To Be Fully Fenced with Gates for City Maintenance

▪ Homeowner Fence To Be Replaced As-Is Along Property Line

▪ Safety Rail To Be Provided Along Channel ▪ Ornamental Rail To Be Provided At Public-Facing Locations

LICENSE

AGREEMENTS

▪ Access To Properties Adjacent To Channel Will Be Required For Construction

▪ Shoring Will Be Implemented To Protect Structures

▪ If the City has been trying to get in touch with you, please speak with us after the presentation!

WYCHE PARK

▪ Permanent Pond to Provide Water Quality with Forebay and Trash Collection

▪ Looped Walking Trail Along Edge of Park

▪ New Lighting Along Trail

▪ Natural Vegetation to Provide Wetland Habitat

SIDEWALK

▪ New Lighted Entrance To Wyche Park At Lawrence St

▪ Eliminated Previous Proposed Trail Connection to Rock Island Road

Lawrence St

3.

CONTRACTOR INTRODUCTION

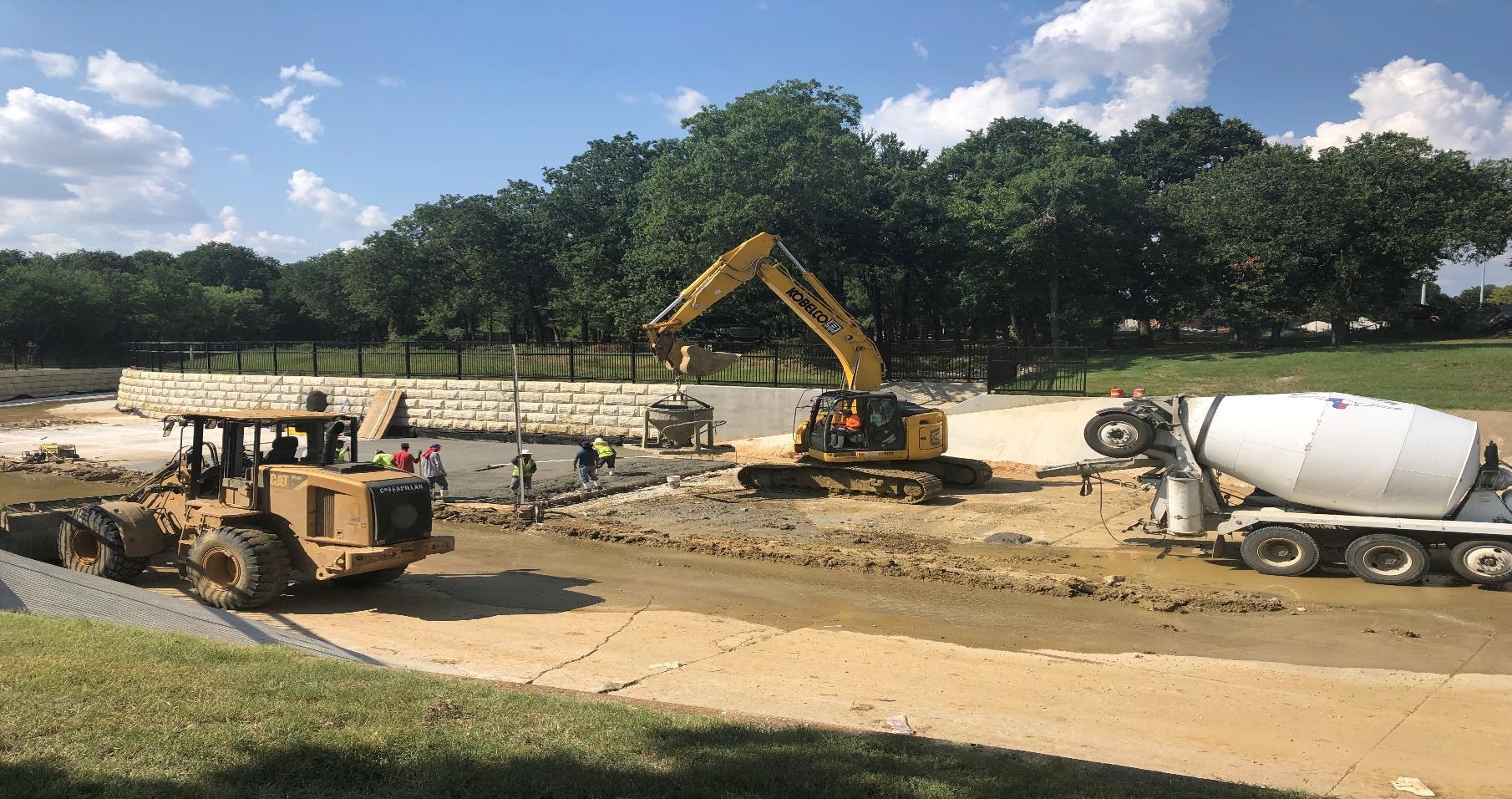

Delaware Creek Construction

HUMPHREY & MORTON CONSTRUCTION

▪ Points of Contact

▪ Contractor:

▪ Maddox Humphrey

▪ Cell: (817) 266-5124

▪ City Inspector: ▪ Ken Kriske

▪ Cell: (469) 435-2621

▪ Construction to begin May 2025 and be completed in 2028

4. QUESTIONS & ANSWERS

Sherwood Forest within Project 1

▪ Will the contractor be on my property?

▪ For properties along the channel, access will likely be needed.

▪ What time will construction take place?

▪ Normal working hours will be between 7:00 a.m. and 6:00 p.m. Monday through Friday except for City recognized holidays.

▪ How long will my property be disrupted?

▪ The contractor will aim to minimize the length of disruption to individual properties. A property may be impacted for up to six months.

▪ How will I know if something will be removed from my property (trees, bushes, fences etc.)?

▪ Trees designated for removal will be marked in advance. The contractor will notify residents before arriving on the property and will provide an opportunity to ask questions before construction activities begin.

FREQUENTLY ASKED QUESTIONS

▪ Will my fencing be restored to its original condition?

▪ New fences will be matched to the type and height of existing fencing.

▪ Will my landscaping be restored to its original condition?

▪ Trees will not be replaced, but irrigation systems and lawns will be restored. Other landscaping items will be addressed on a case-by-case basis.

▪ I have a shed/pool/etc in my backyard. Will this be affected by construction?

▪ Pools and large/permanent structures will be protected in place using shoring. Small sheds will be relocated by the contractor. The contractor will coordinate with residents for relocation and moving of shed contents.

▪ What safety measures will be utilized during construction?

▪ Temporary fencing will be installed along the active construction area for safety purposes until the new permanent fencing is in place.

FREQUENTLY ASKED QUESTIONS

▪ How will I know when roads are closed for construction?

▪ Residents can receive email updates on road construction by subscribing to the City’s Notify Me service.

▪ Who do I contact for unique property situations or other issues/concerns?

▪ For any questions, issues, or concerns please reach out to the contractor or the City inspector.
