City Manager Monthly Update - January 2026

Page 1

U P D A T E

M O N T H L Y J A N U A R Y 2 0 2 6

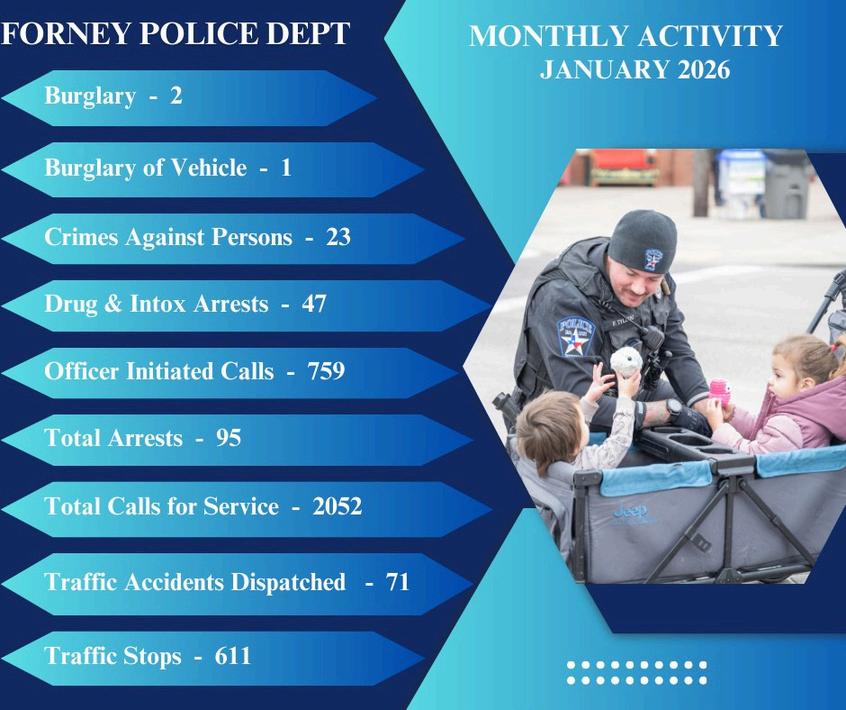

Patrol

Every category except "Drug & Intox Arrests" went down.

We saw a significant decrease in Traffic Accident Dispatched (105 in Dec.), which may indicate reduced traffic during the winter storm. It may also indicate the increased presence of the traffic section, which is designed to reduce traffic accidents.

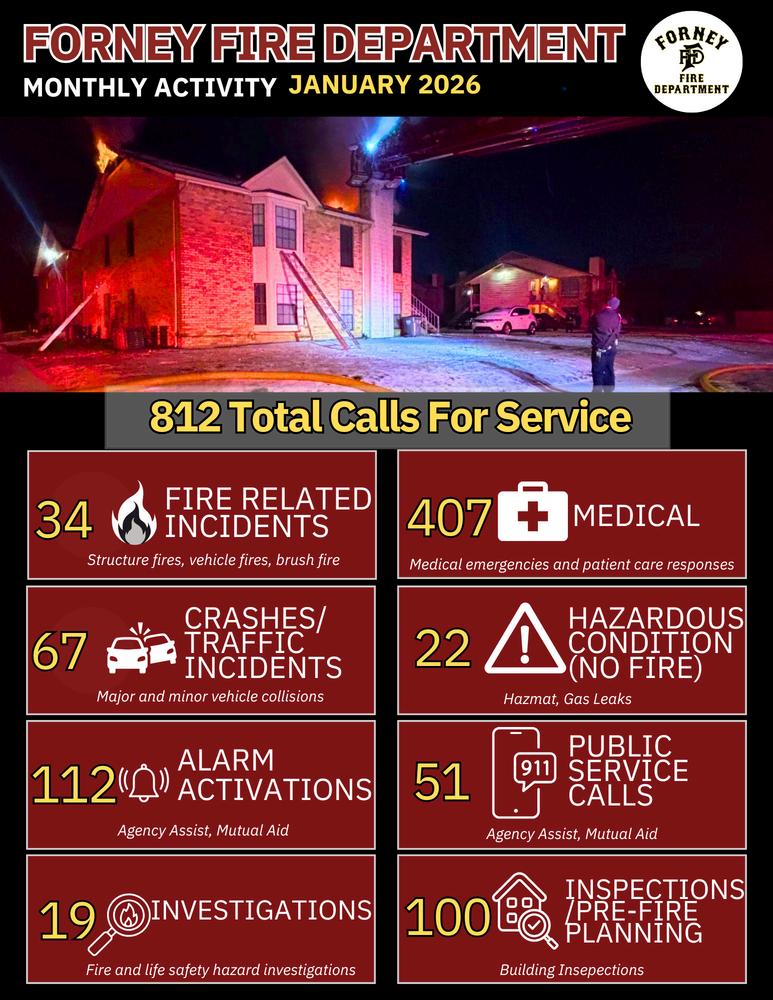

CID

Crimes against persons decreased, going from 25 in December to 23 in January.

Other Notable Events

The Citizens Police Academy is scheduled to start on February 19th.

Happy Retirement, Paula!

Paula proudly served 25 years as a dispatcher/communications officer, including 15 years with the Forney Police Department. Throughout her career, she exemplified professionalism, dedication, and calm under pressure, while building strong, trusted relationships with her coworkers Thank you, Paula, for your years of service and all you have done for our department. Best wishes in your well-deserved retirement!

A N U A R Y 2 0 2 6

Planning and Collaboration

Continued coordination with ESD #6 to identify and evaluate potential fire station sites as part of longterm planning efforts.

ESD #6 engaged Martinez Architects for the design of Fire Station #4, to be located on Ranch Road. Gallagher selected to serve as ESD’s Owner’s Representative.

Initial floor plan for Fire Station #4 has been completed.

Staffing / Training Update

Two Battalion Chiefs attended Battalion Chiefs Academy at CFT.

One Captain attended Officer Development Program at CFT.

One Firefighter attended Skills Day for Fire Instructor I.

Two Firefighters attended TCC Confined Space Class.

Two Driver/Operators attended TCC Command and Control Class.

Four Firefighters obtained their Class B Driver License.

Fire Chief attended SAFE-D Conference with ESD Board Members.

Annual Fire Officers Meeting conducted.

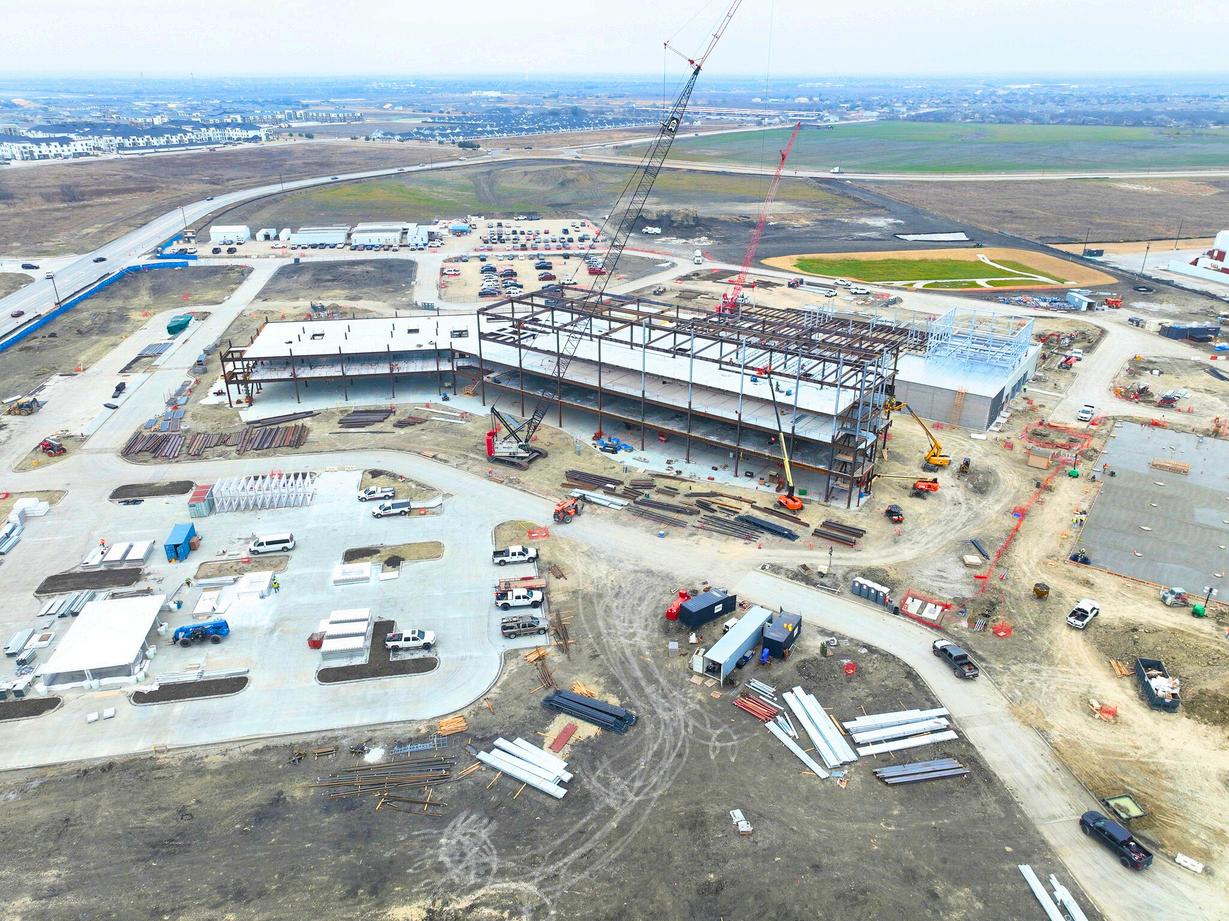

Station 2 Renovation and Addition

Renovation and expansion work is underway. Slab has been poured for the station addition. Exterior and interior block walls are currently being constructed.

Reporting and Compliance

Effective January 1, 2026, the department transitioned from NFIRS to the federally required NERIS reporting system.

Minor technical issues remain related to printing monthly reports.

Recruitments and Grants

Completed physical ability testing, written exams, Talassure assessment, and oral boards. Conditional job offers extended to nine firefighters under the SAFER Grant.

Candidates are currently in HR onboarding and background investigation.

Orientation scheduled for March.

N U A R Y 2 0 2 6

Facilities

Fire Station #2 Renovations & Expansion – Construction underway

City Hall Annex Elevator – Completed January 2026

Municipal Court Upgrades – Construction bids received; furniture quotes received

City Signage Package – Construction documents finalized; bidding soon

Animal Shelter Upgrades – Awning & turf complete; puppy room on hold

Fire Station #1 Upgrades – Bay renovations complete; canopy on hold

Public Works Remodel & Facility Projects – Planning / On Hold

Roadway

Ranch Road Extension – Legal closeout

Lovers Lane (Bond) – 95% design; easements in progres

FM 548 Monitor Connector (Bond) – Alignment finalizin

FCP Road Extension (Bond) – 60% design review

Railroad Grade Separation (Bond) – Feasibility; TxDOT coordination

FM 740 / Pinson Turn Lanes – Design coordination

Overland Grove – Warren MS Sidewalk – Active

Water

Bowie & York Waterline – Construction / Punchlist

SCADA Upgrade – Closeout

12" Water Line Loop (Northside) – 100% design review

Northside Elevated Tank – Design; land acquisition

FM 1641 Water Relocation – Final design review

Pump Station #2 Phase 3 – Tank 95%; pump station 60%

US 80 Water Line Relocation – Planning

Lollipop Water – Construction beginning late winter

Wastewater / Sewer

Clay Pipe Lining – Completed

CMOM Study – Completed

Sewer Extension (Kaufman to Bowie) – 95% design

Grayhawk Lift Station Decommission –Construction awarded

FM 1641 Wastewater Relocation – TXDOT coordination

Irish Ridge Lift Station – 90% design; on hold

US 80 Frontage Sewer Pipe Bursting – Preconstruction complete

Steve Silver Sewer – 100% design; awaiting easement

Drainage

Shands–Mulberry Drainage – Design; grant funding anticipated

Estate Lane Drainage – 100% design review

Mulberry Drainage & Parking – ISD coordination

Parks

Community Park Fence – Completed January 2026

Multi-Purpose Field – Completed December 2025

Community Park Wi-Fi – Construction

Additional Tennis Courts – 50% design review

Heritage Hill Playground – Construction award pending

Mulberry Baseball Phase 2 – Design; proposal pending

Forney Community Park Trail Extension – Design

Northside Park Master Plan – Adopted; Phase 1 planning underway

Private Developments

BJ’s – 80% complete; est. June 2026

Costco – 99% complete; est. March 2026

Target – 80% complete; est. June 2026

Crunch Fitness – 95% complete; est March 2026

Burger King – 35% complete; est April 2026

Victory Shops East – 75% complete; est. May 2026

Villages at Gateway – 96% complete; est. April 2026

Bellagio Laguna – 60% complete; est. May 2026

FISD OC Expansion – 5% complete; est. August 2026

EVO – 10% complete; est. November 2026

Oncor Forney Switch – 65% complete; est. September 2026

Texas Health Resources Hospital – 65% complete; est. 2027

Gail Wilson Way Extension – 90% complete; est April 2026

Slick’s – 0% complete; est July 2027

Weekly recycling service begins March 4th.

Under the City’s new contract with Community Waste Disposal, residential recycling pickup will increase from every other week to weekly service for residential customers within Forney city limits.

A N U A R Y 2 0 2 6

Facilities

51 tickets closed

Facilities winterized; assisted with winter storm preparation

Coordinated with vendors on facility repairs; performed general maintenance and custodial services

Ongoing coordination with vendors and Engineering on budget-approved facility projects

Fleet

26 tickets closed

Assisted with winter weather preparation and storm response

Set up and removed temporary generator during winter storm

Assisted with sander repairs

Transported units for maintenance, inspections, repairs, and registrations

Streets

Performed sanding operations on major streets and thoroughfares

Performed asphalt patchwork citywide

Sign Maintenance including repair damaged signs and replace those missing

Winterizing equipment

Performed site clean up and restorations at multiple locations city wide

Cleaned ditches of debris

Annual crack sealing on asphalt roads

Mowed assigned city owned lots

Annual winter tree trimming

Perform vehichle and equipment maintenance

Install traffic signs and markings per Engineering requests

Water/Sewer/Utilities

4 sewer dig-up repairs; 7 sewer stops cleared

Camera inspections on 6 sewer lines; 3 cleanout repairs; 3 manhole repairs

3 pressure checks; 11 leak checks; 2 water dig-ups

Pump, motor, valve, and electrical repairs completed at both pump stations

30 monthly water quality samples collected; 6 water quality calls responded to

45 dead-end flushings and additional auto-flusher maintenance performed

Valve and hydrant maintenance completed at 40 locations citywide

Job site restorations completed at 7 locations

Equipment and vehicle maintenance performed

Pump and lift stations winterized; crews responded during winter storm

Grounds

Assisted with winter weather preparation and storm response

Spot mowing performed as needed due to warmer temperatures

Tree trimming and winter projects initiated

Weed control performed

Lawn equipment maintenance and repairs completed

J A N U A R Y 2 0 2 6

Development-Related Tasks

11 utility locates completed

4 construction samples collected

5 contractor assistance calls

Texas Independence Day Concert

The Parks and Recreation Department has been planning an exciting lineup for our Texas Independence Day Concert, and we ’ re pleased to announce that the Randy Hoyet Band and Zach Welch will open for Giovannie & The Hired Guns. Join us for this free community concert on February 28th at the Spellman Amphitheater at Forney Community Park.

Spring Registrations

Concluded Registrations for spring sports, including baseball, softball, and soccer, have concluded. Approximately 2,200 kids are registered, surpassing last year ’ s totals. Thanks to Corbin, Caleb, Randy, Dodie, and the entire parks staff for their hard work during the registration process!

Cornhole Tournament

The Parks and Recreation Department is planning its first Cornhole Tournament of 2026 in conjunction with the Texas Independence Day Music Concert on Saturday, February 28 at 1:00 p.m. at the Spellman Amphitheater. The tournament will feature 45-minute matches, with each two-player team guaranteed three games, including two pool games and one bracket game. There is no registration fee, and boards and bags will be provided for participants.

Pickleball League in Collaboration with the OC

The City is pleased to announce a new partnership with The OC to launch Forney’s first pickleball league. This initiative expands recreational programming opportunities for residents and supports continued growth in community engagement.

Spring Sand Volleyball

The Parks and Recreation Department is currently preparing for the upcoming Adult Spring Sand Volleyball season. Registration has now closed, and staff are finalizing league details and team coordination. Additional information regarding schedules and league play will be shared with participants soon.

Congrats!

We’d like to send a huge congratulations to the Forney Rec All-Star team. They competed in the Frost Cup last weekend and finished second in their division out of six teams. This was their final tournament, and they went out with class! Congratulations to all of the parents and coaches who made this possible!

J A N U A R Y 2 0 2 6

Community Park Wi-Fi Project

Purpose: Provide reliable public Wi-Fi at Community Park while improving connectivity for events, vendors, and concessions, reducing reliance on temporary hotspots.

Current Status

Final installation phase delayed due to competing infrastructure priorities

All required hardware received; preliminary testing completed

Final deployment location confirmed at the baseball fields

Next Steps

Complete installation and activation with a revised target date of March 31, 2026

Conduct coverage validation and finalize project closeout

NICE Recorder – Police Department Phone & Radio Project

Purpose: Ensure reliable call recording, regulatory compliance, and enhanced quality assurance for Police Department phone and 911 communications

Current Status

System is live

Final validation phase underway; project closeout anticipated in the coming weeks

Next Steps

Complete technical and operational validation

Final sign-off and project closeout

Emergency Dispatch & Fire Operations – USDD Integration

Purpose: Improve emergency dispatch reliability and streamline integration between Tyler Technologies and USDD systems for Fire operations.

Current Status

User training completed for Battalion Chiefs, Dispatchers, and Dispatch Supervisor

Fire Chiefs have reviewed and observed tested, fully functional dispatch implementation

Installation planning underway; City staff coordinating on-site to finalize deployment sequencing

Next Steps

Install hardware at Fire Stations 1 and 3, tentatively scheduled for completion by mid-May

Fire Station 2 to receive core system components only due to construction System will go live once all stations have required hardware in place
