FPC 23
Trails! Trails! And Did I
Mention Trails?
The Path to Building Trail Communities
![]()
Franco Saraceno Principal Planner
Kittelson and Associates
Corinne Arriaga
Transportation Planner City of Sarasota
Alvimarie Corales
Chief Transportation Planner City of Sarasota
Nina Venter
Senior Planner
Sarasota/Manatee MPO
Develop multi modal solutions to issues such as:
✓ Congestion
✓ Equity
✓ Healthy Streets
✓ Modal Choice
✓ Safety
ACTIVE TRANSPORTATION PLAN
November 2019
US 41 MULTI MODAL EMPHASIS
CORRIDOR GAP & SAFETY ANALYSIS
February 2020
TRANSIT CHOICES STUDY
November 2021
SUN TRAIL ALIGNMENT STUDIES
May 2023
COMPLETE STREETS MOBILITY STUDY
March 2023 → Summer 2024
Develop multi modal solutions to issues such as:
✓ Congestion
✓ Equity
✓ Healthy Streets
✓ Modal Choice
✓ Safety
Direct federal funding to regional priority projects.
Long Range
Transportation Plan
5-YEARS

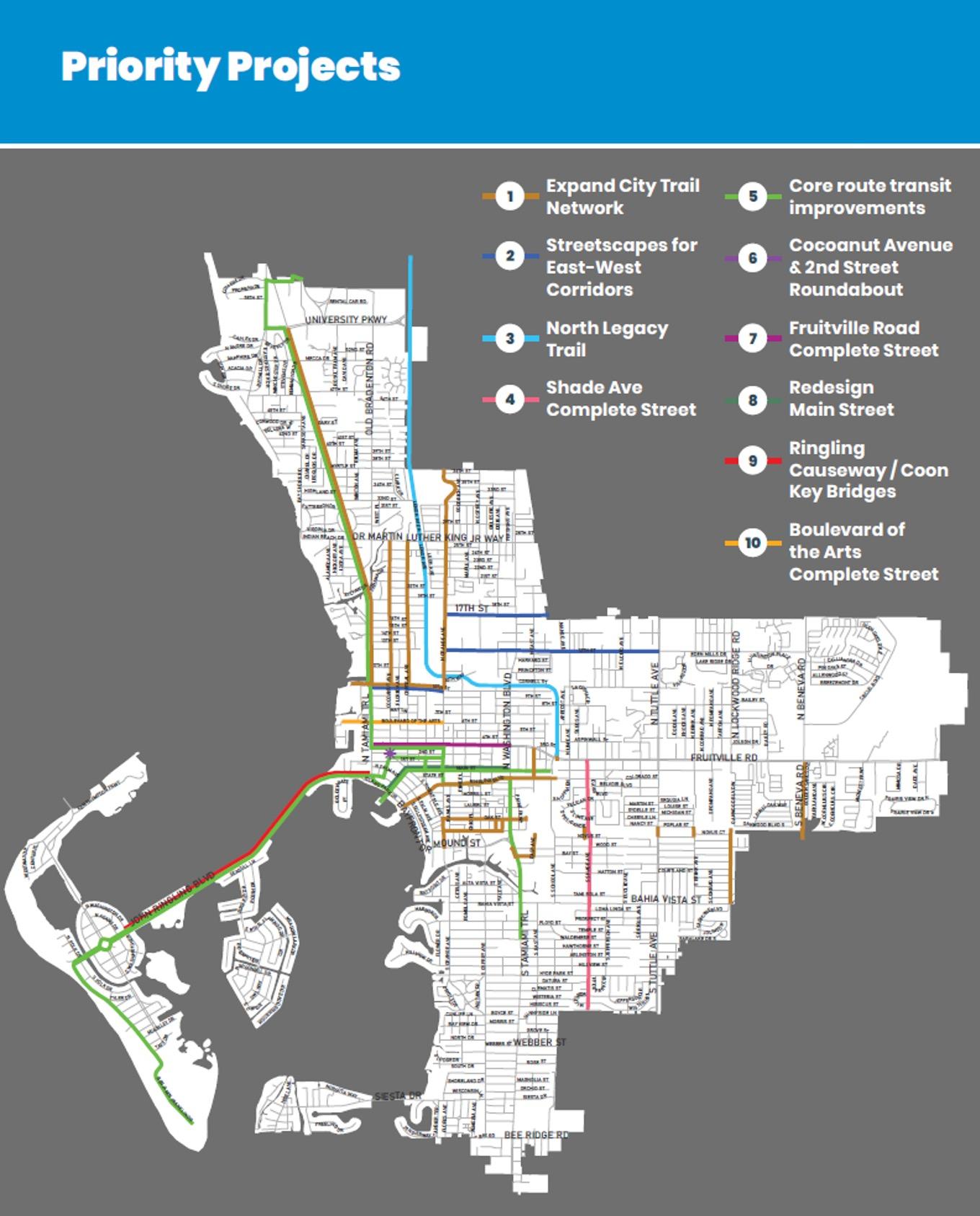

Project Priorities
ANNUAL
E.g., Transportation Alternatives
(TA)
CARB Funds
■ Direct federal funding to regional priority projects.
■ Align regional priorities with state funding opportunities.
Off-SIS Eligible

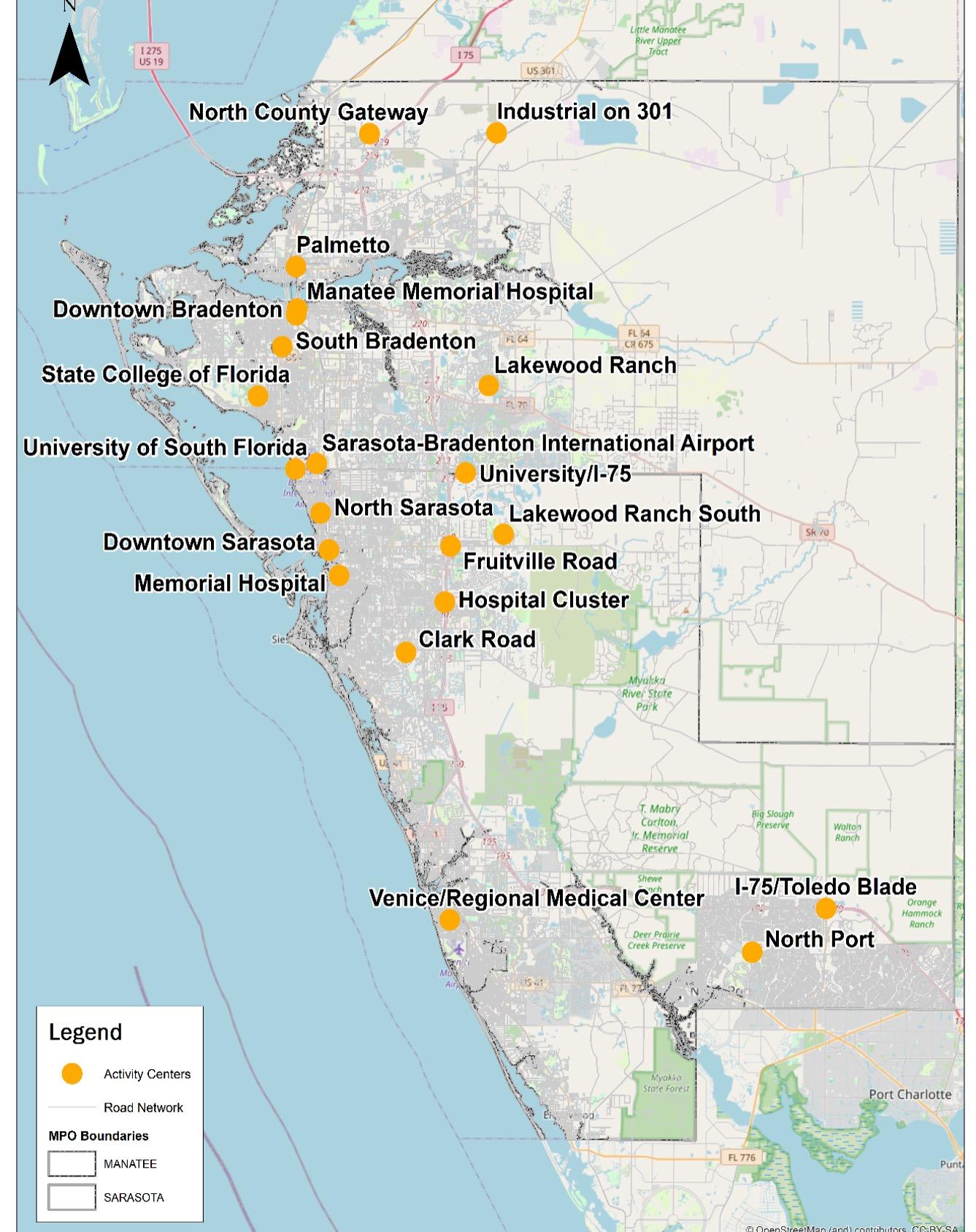

– Connect activity centers
– Connectivity within activity centers
– Connect activity centers
– Connectivity within activity centers
– Connect to public transit
• Systems Approach
– Connect activity centers
– Connectivity within activity centers
– Connect to public transit
• Build System around SUN Trail spine
– Connect to existing and future SUN Trail system

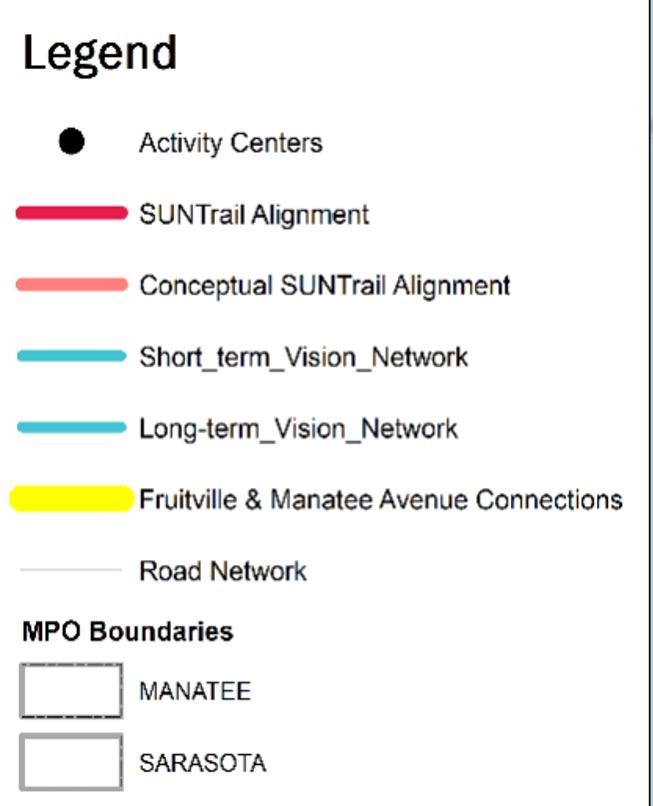

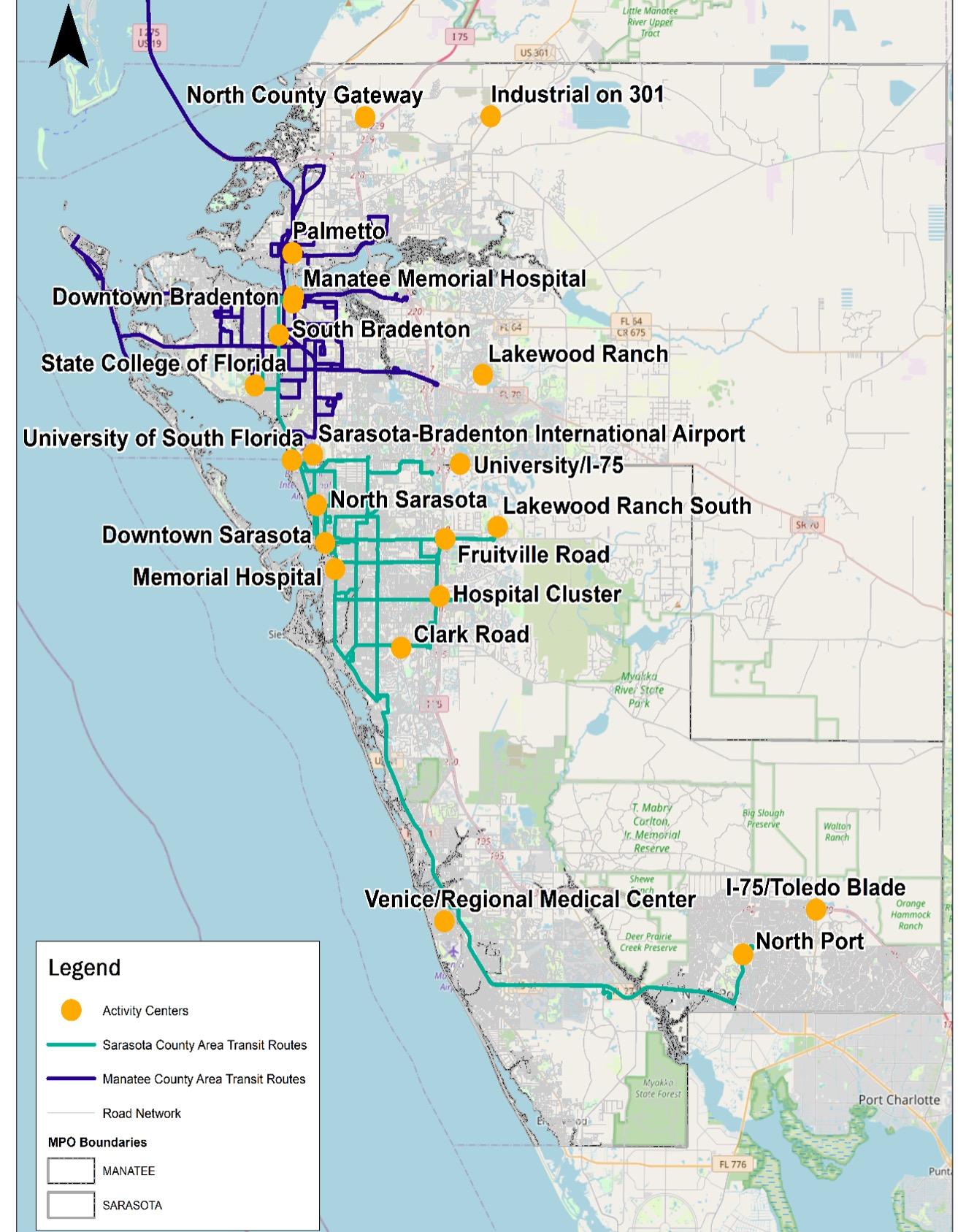

• Resulting ATP Vision is a multimodal network

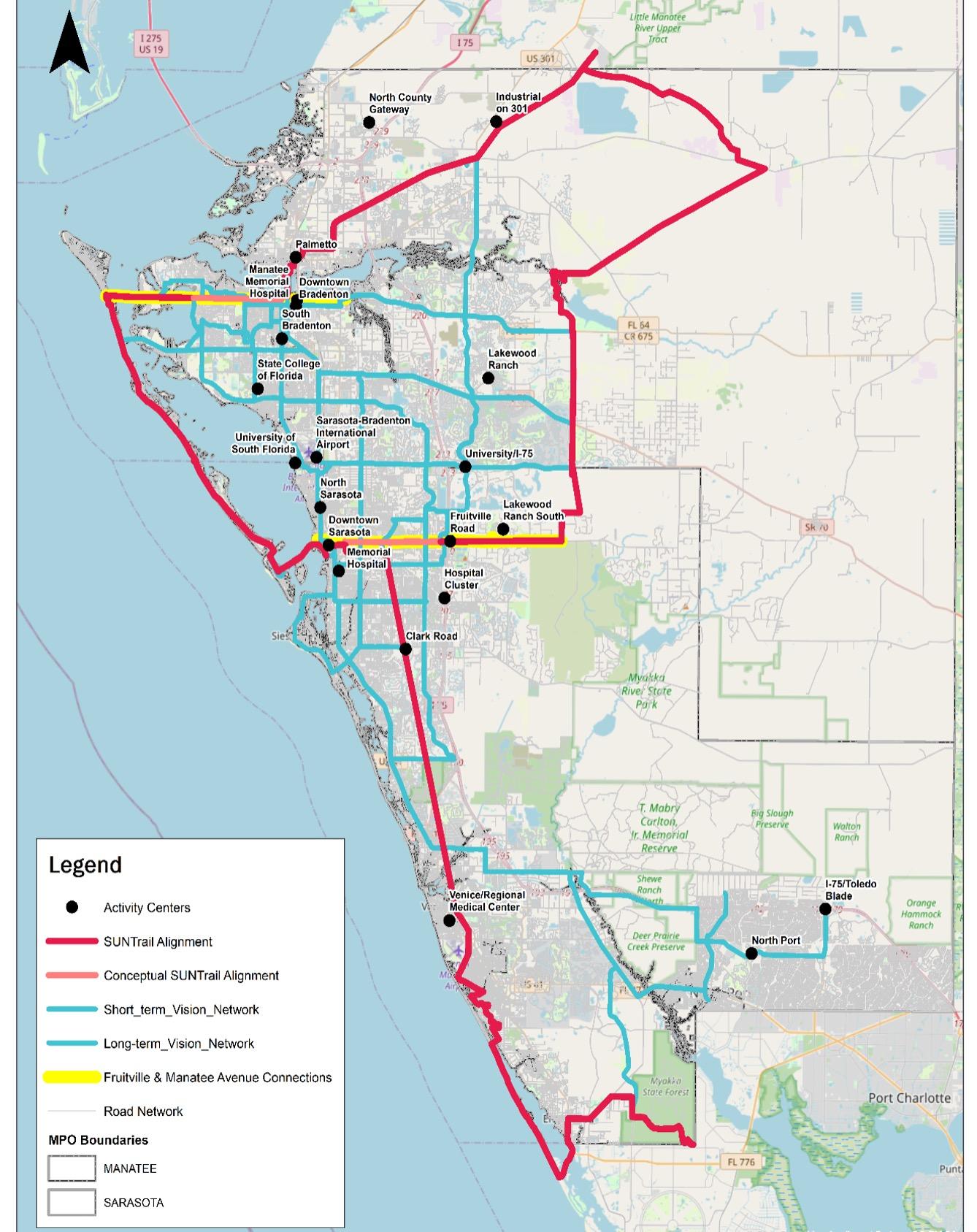

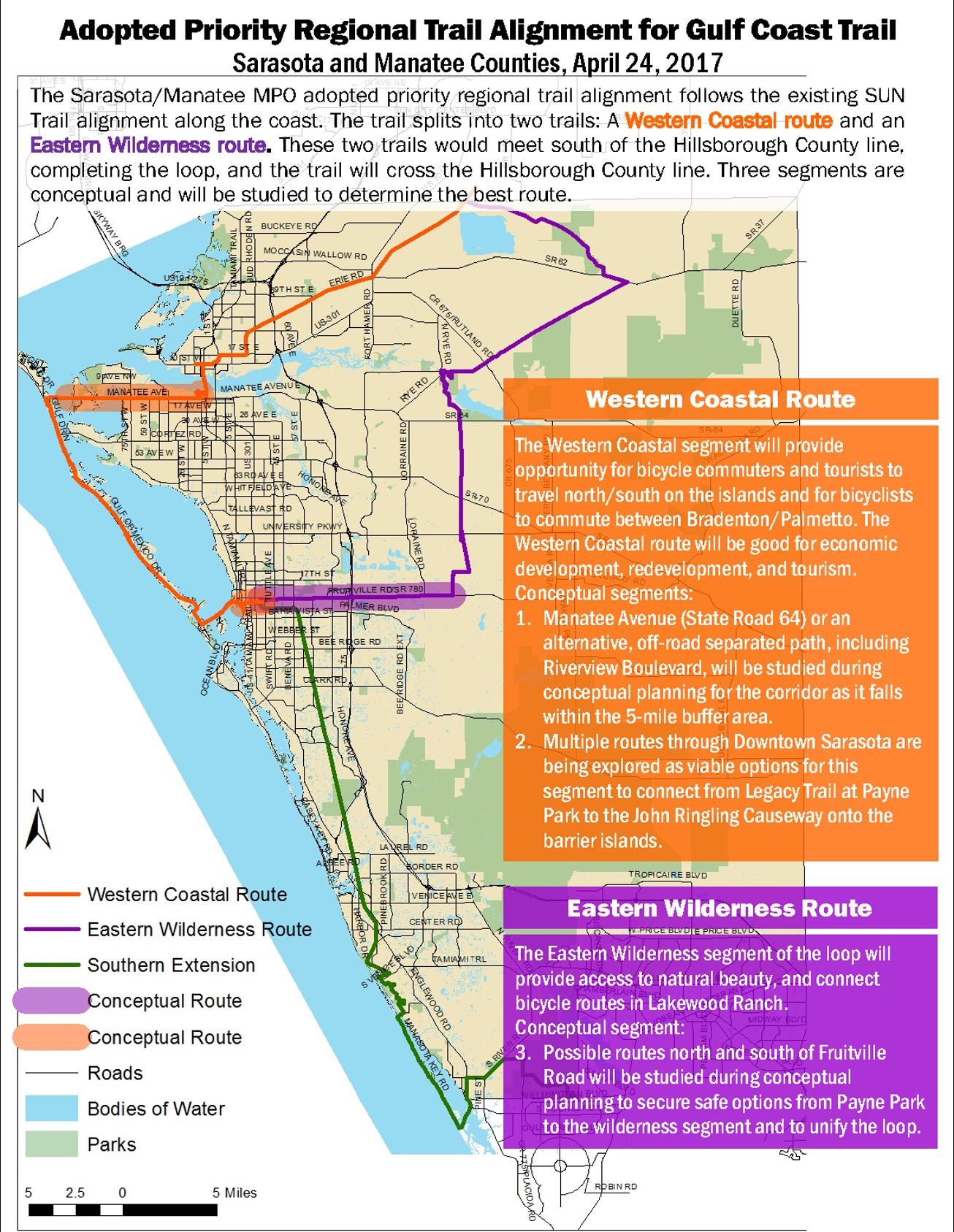

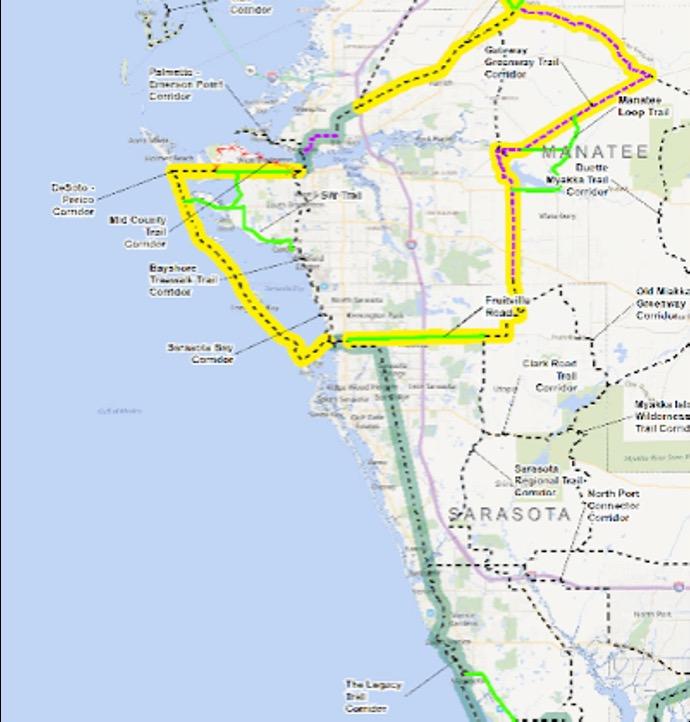

Alignment studies to identify best alignments

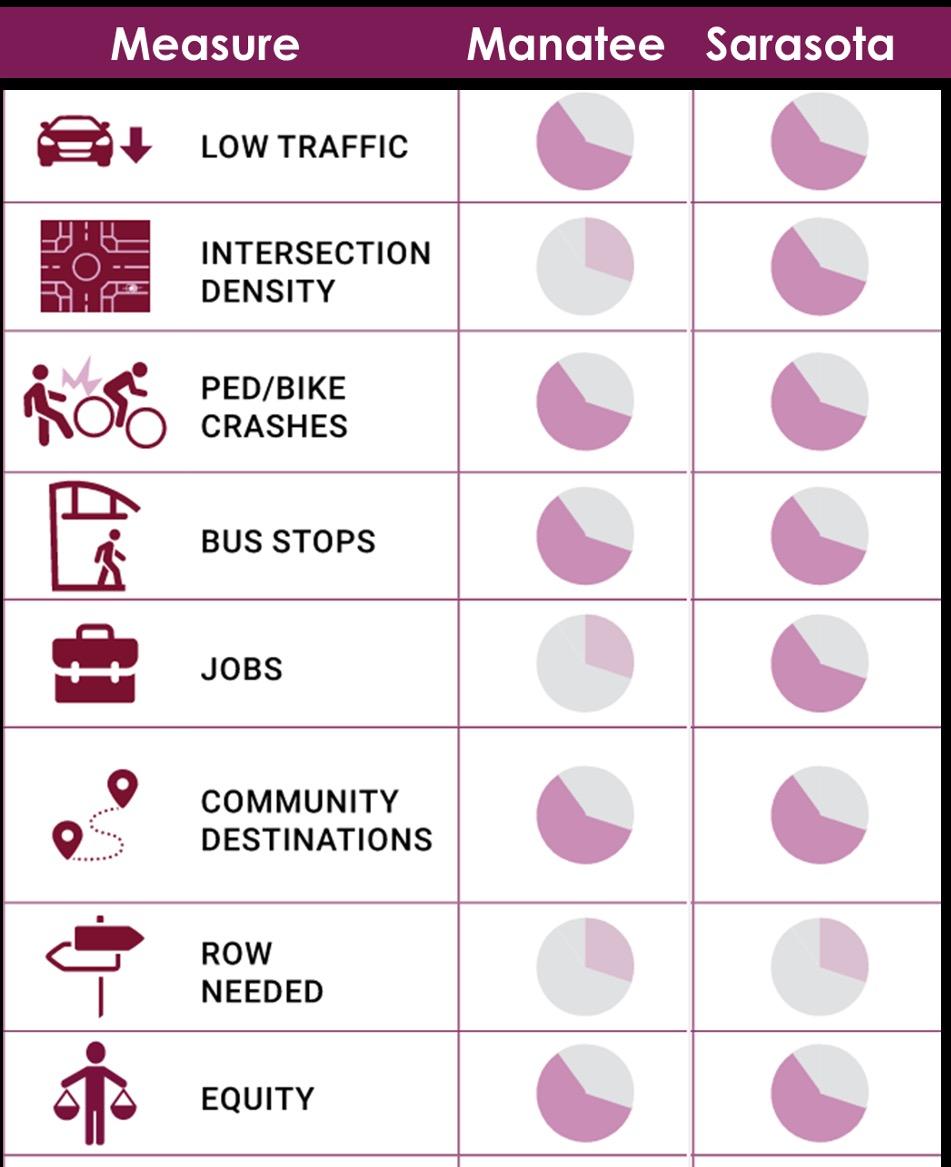

Data driven process
– origin/destination data
–
Crashes involving pedestrians/bicyclists
–
–
–
Walk/bike accessibility data
Public right-of-way
Disadvantaged areas
–
–
Transit ridership
Public input
Trails are multi-jurisdictional
Agency partners
–
–
Counties (5 departments)
Transit agencies
Cities –
–
FDOT
Private/Non-profit partners
–
Bicycle clubs
–
–
Trust for Public Land
Friends of the Legacy Trail
– Private developer
1 on 1 interviews with each identified stakeholder
Range of perspectives
–
Safety –
Leverage parks
–
Connect neighborhoods
–
Financial considerations
–
Variety of user groups
–
Economic development
–
Affordable housing

Sarasota
MPO ACTION
REGIONAL PROJECT PRIORITIZATION
COORDINATION
JURISDICTIONS & FDOT
RESULT ADOPTED ALIGNMENTS ELIGIBLE FOR FEDERAL FUNDING
MPO ACTION
MODIFY PRIORITY CORRIDORS
COORDINATION

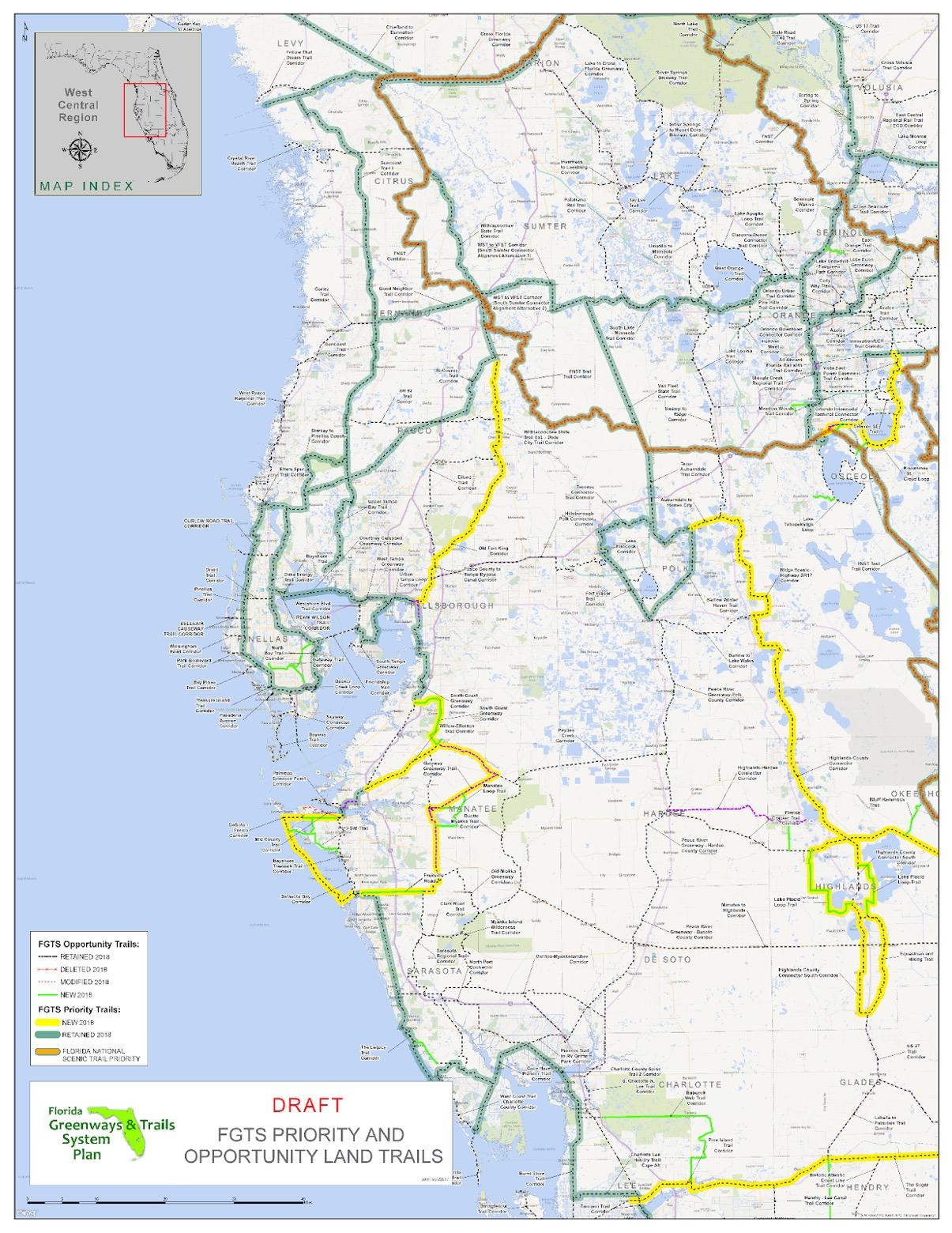

OFFICE OF GREENWAYS & TRAILS
RESULT ADOPTED ALIGNMENT ELIGIBLE FOR STATE FUNDING

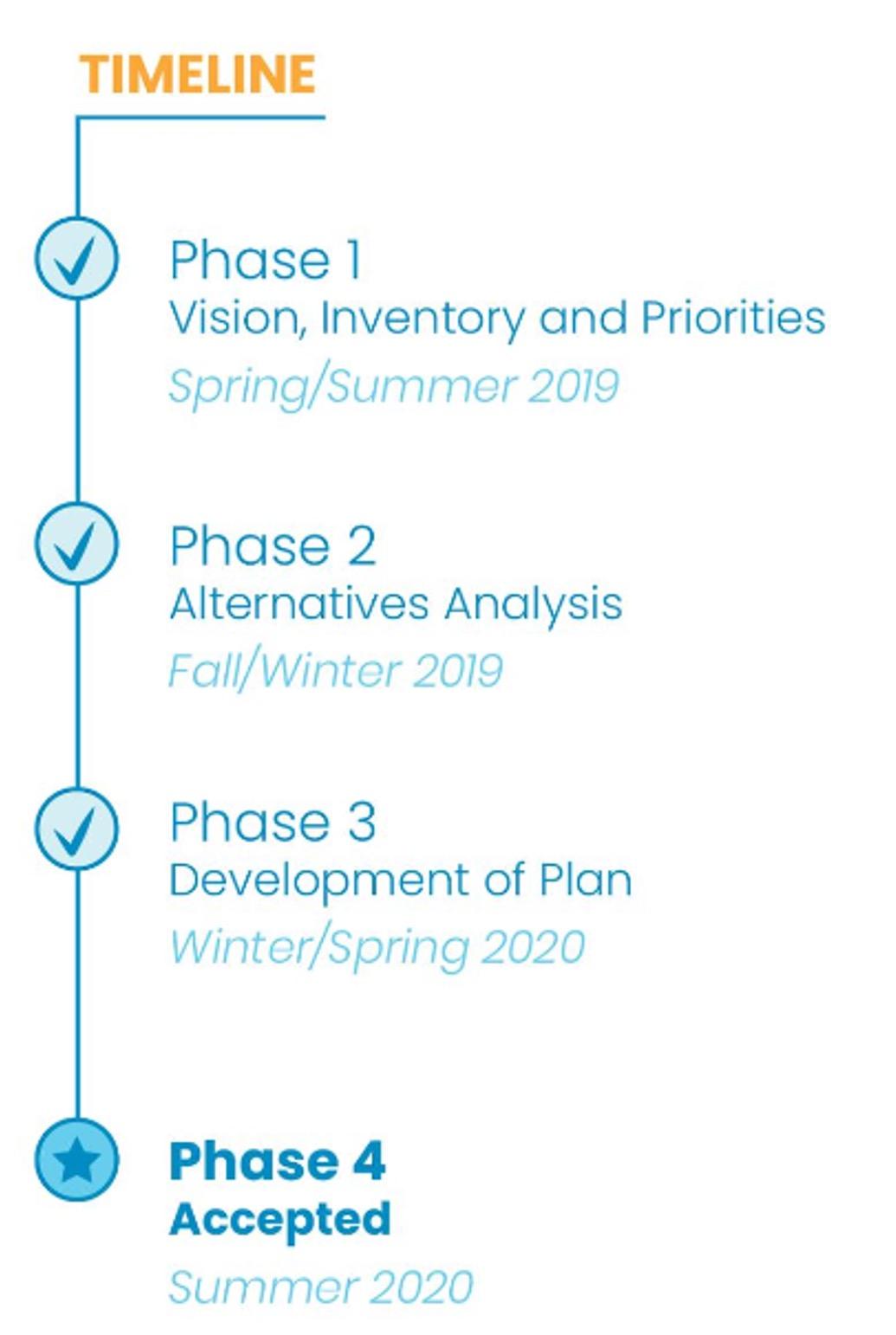

• What is it? – City of Sarasota’s first transportation master plan, which serve as a playbook for how the City not only invests in transportation infrastructure, but also how it achieves the community’s larger quality of life goals.
Began with an inventory of transportation projects
Over 100 projects were scored and analyzed
Only 50 made it in the plan
Accepted by City of Sarasota Commission on July 2020
Photo Courtesy of The Friends of the Legacy Trail
What is it?

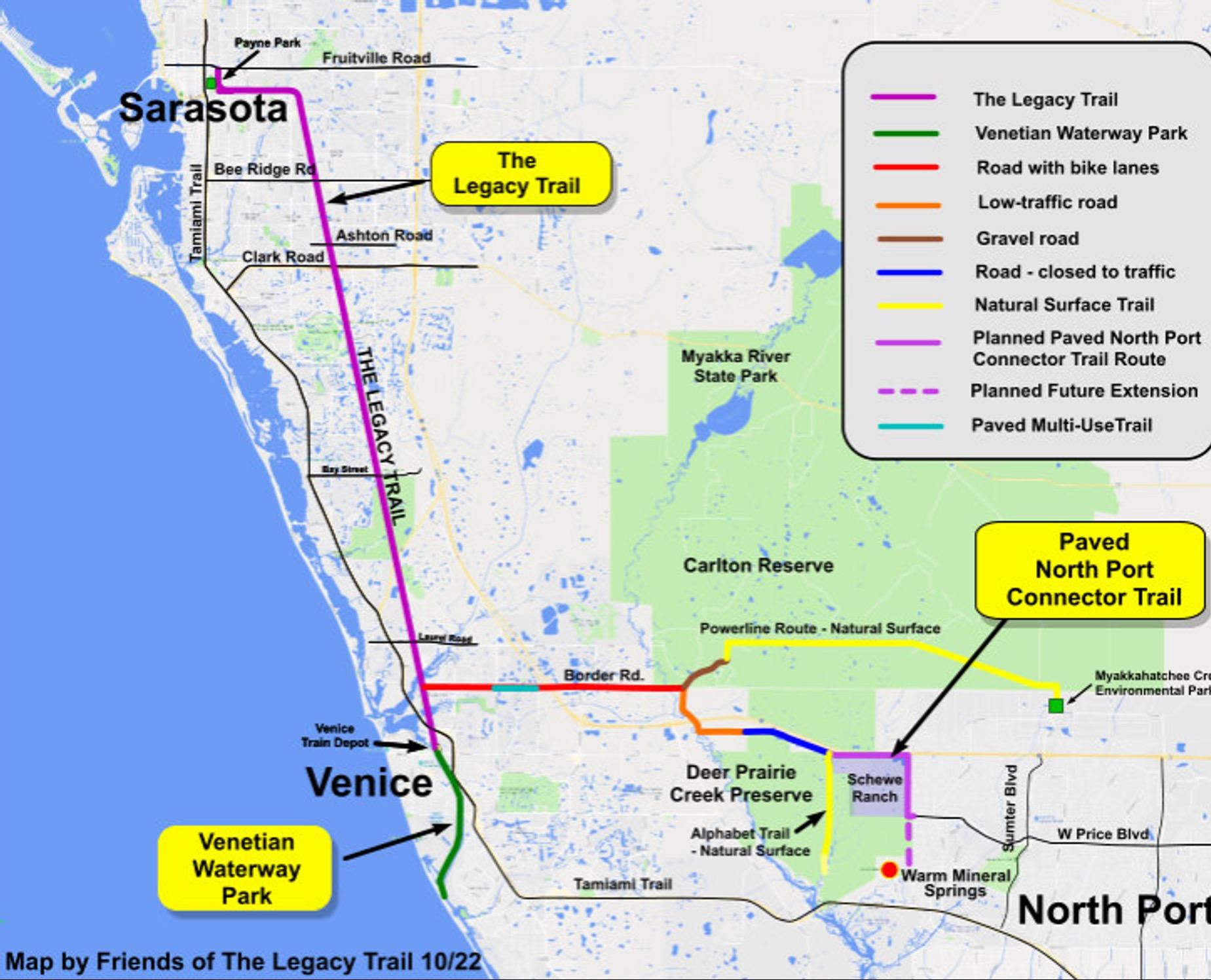

– Is a 22.5 mile nature trail that links to the Venetian Waterway Park at the historic Venice Train Depot, where trail users can continue north to Payne Park in downtown Sarasota.
– It has over 500,000 trail users a year
• CSX Railroad was purchased after a decade of planning
2008
• The Legacy Trail from the Venetian Waterway to Culverhouse Nature Park, Sarasota was completed
• Voters Bond Referendum approve –provided funding for the Legacy Trail to extend to the City of Sarasota
2022
• Legacy Trail extension from Palmer Ranch to City of Sarasota was completed
● Established on July 11, 2016 as an all-volunteer 501(c)(3) nonprofit organization.
● FLT exists to support, promote, enhance and protect The Legacy Trail, a Sarasota County Park, and its trail connectors.
● Raise funds to aid in the development, operation, maintenance and improvement of The Legacy Trail, its trail connectors and related facilities within the guidelines established in the operating agreement with Sarasota County.
• Rail Negotiation and Agreement
• Rail to Legacy Trail Network • Legacy Trail Network • Legacy Trail Network Projects
• Rail Negotiation and Agreement – Lease Agreement
• No ownership – Pay Railroad Company to:
• Construct Trail
• Relocate Rail – Rail company can remove – Approximately $40 Million
–
What can we do for $40 Million?
Coastal Trails
Creates connections to: – Transportation disadvantaged communities –
Over 20 Parks
7 schools –
–
2 colleges – Downtown amenities – Island beaches
Legacy Trail Network Projects

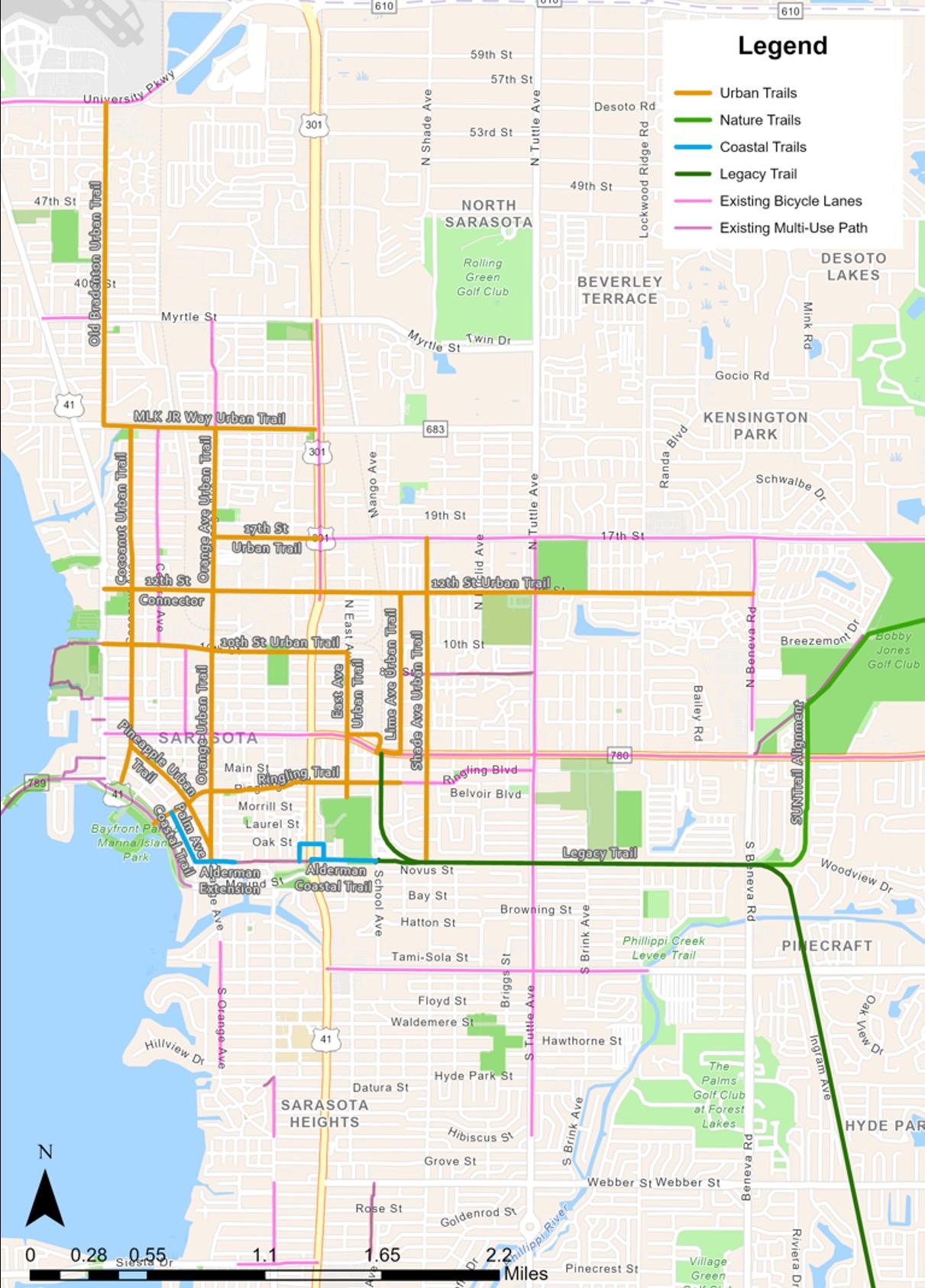

– Ringling Trail - Completed
–

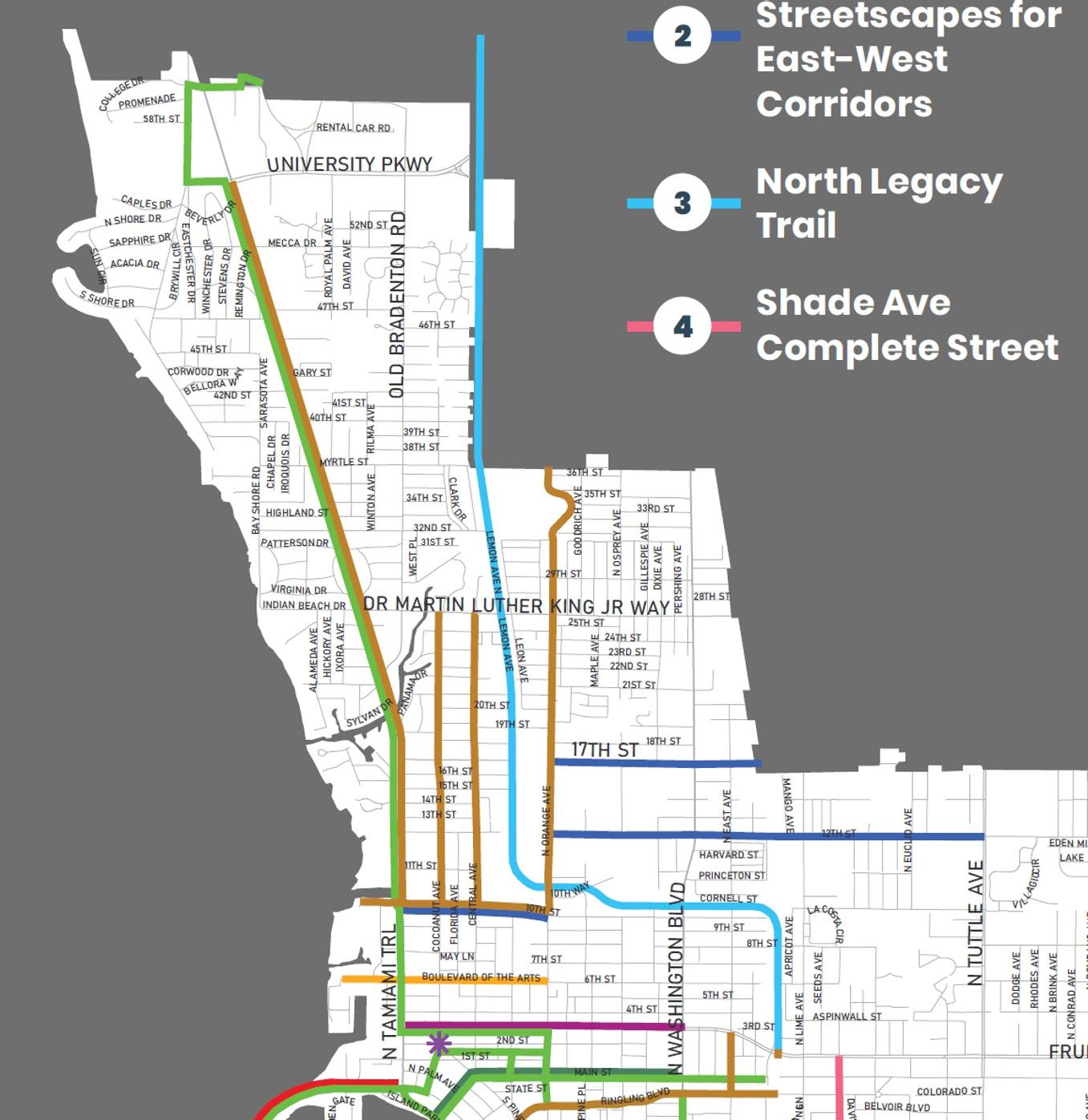

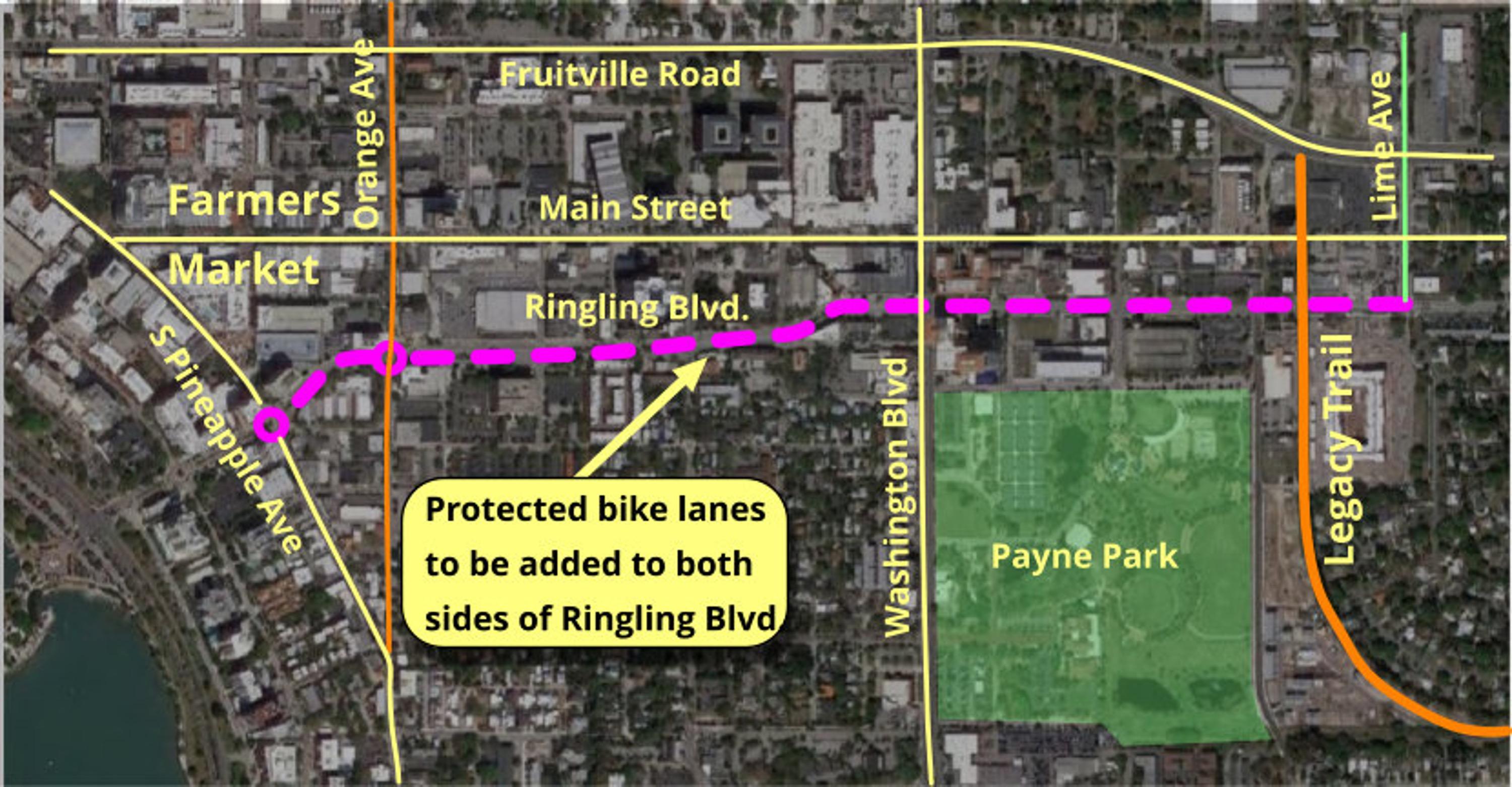

The Legacy Trail – Payne Park (Alderman

MURT) – NEPA and Construction
– 10th St and Blvd of the Art – 60% Design

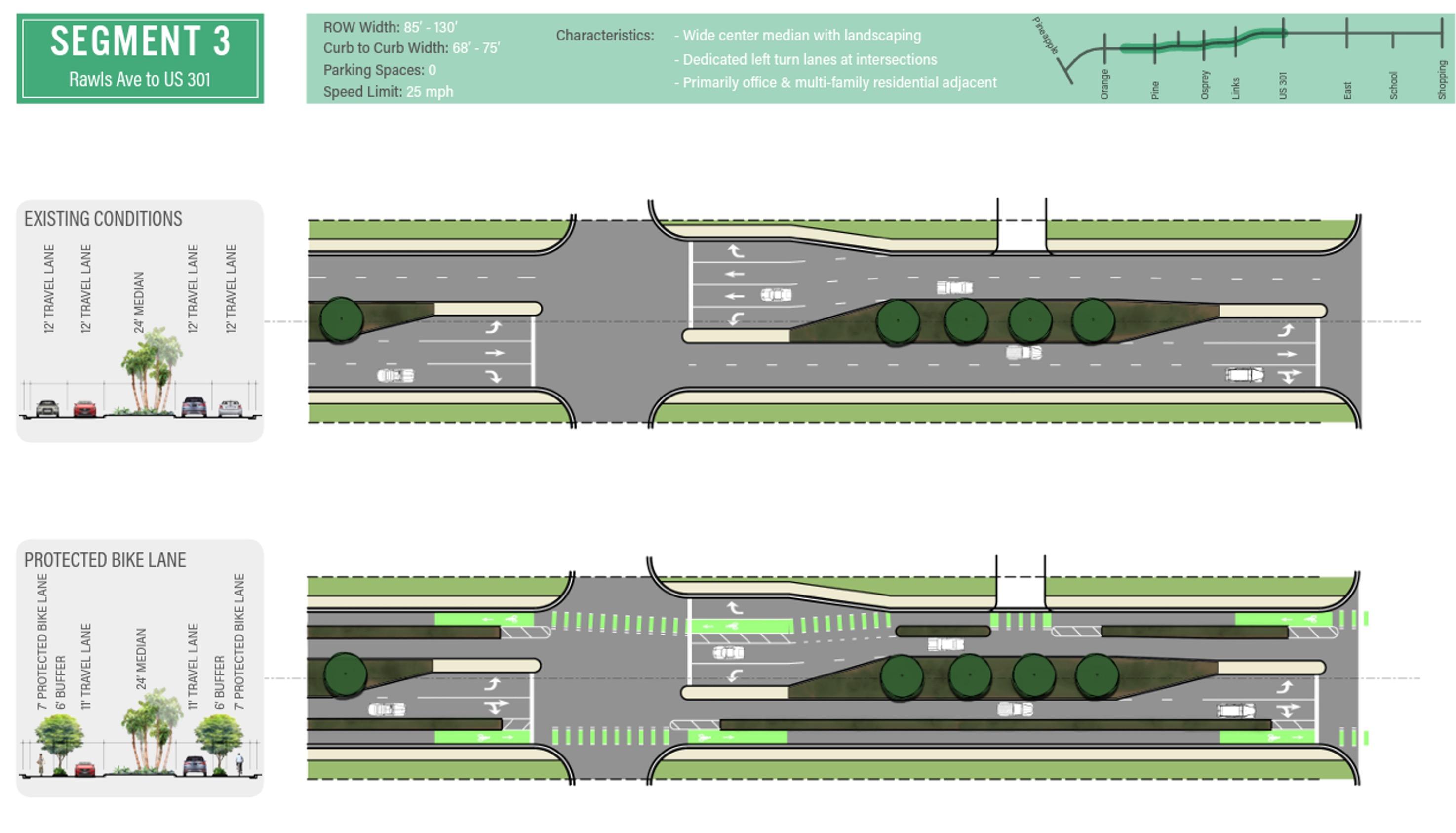

– Shade Avenue Complete Streets – 60% Design

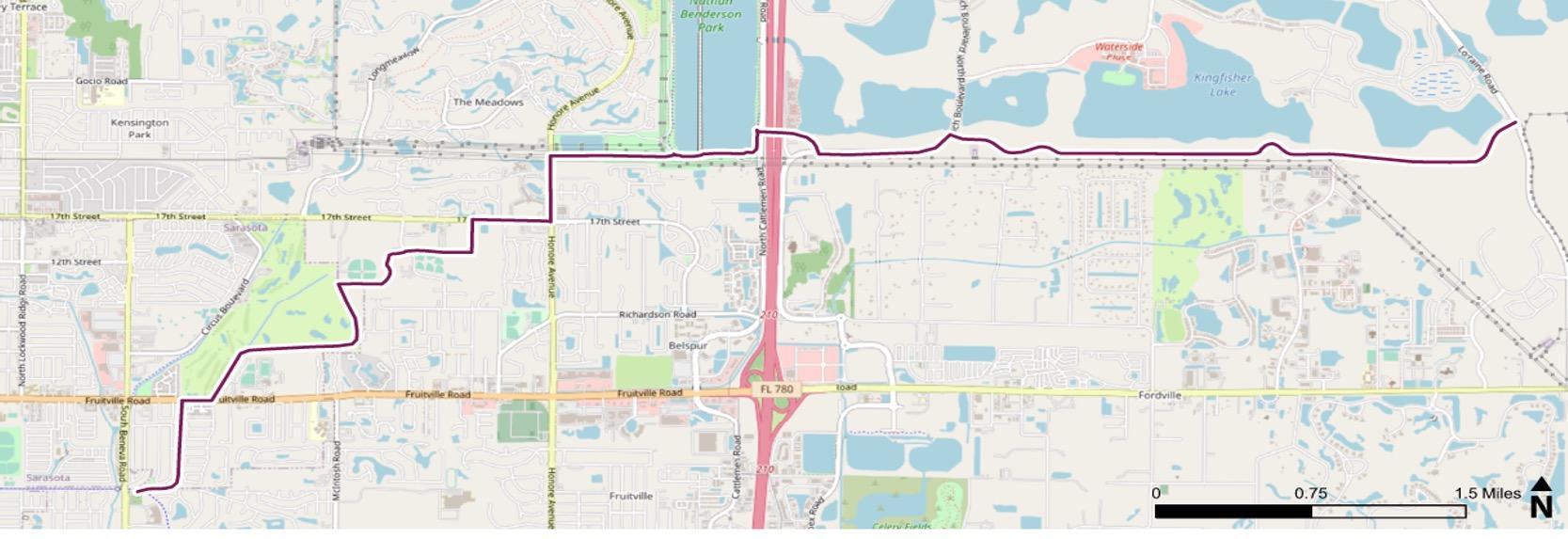

– Legacy Trail to Bobby Jones – Pre-PD&E
– Cocoanut Avenue Urban Trail –
Proposed
– East Avenue Urban Trail - Proposed
Photo taken from 2019 -2023 Florida Greenways & Trails System Plan
• Design-Build Contractor Procured (2021)
– Burgess & Niples (Designer)
– Ajax (Contractor)
• 100% Design Completed (2022)
– November 2022
• Construction (2022)
– Start: May 2022
– End: December 2022

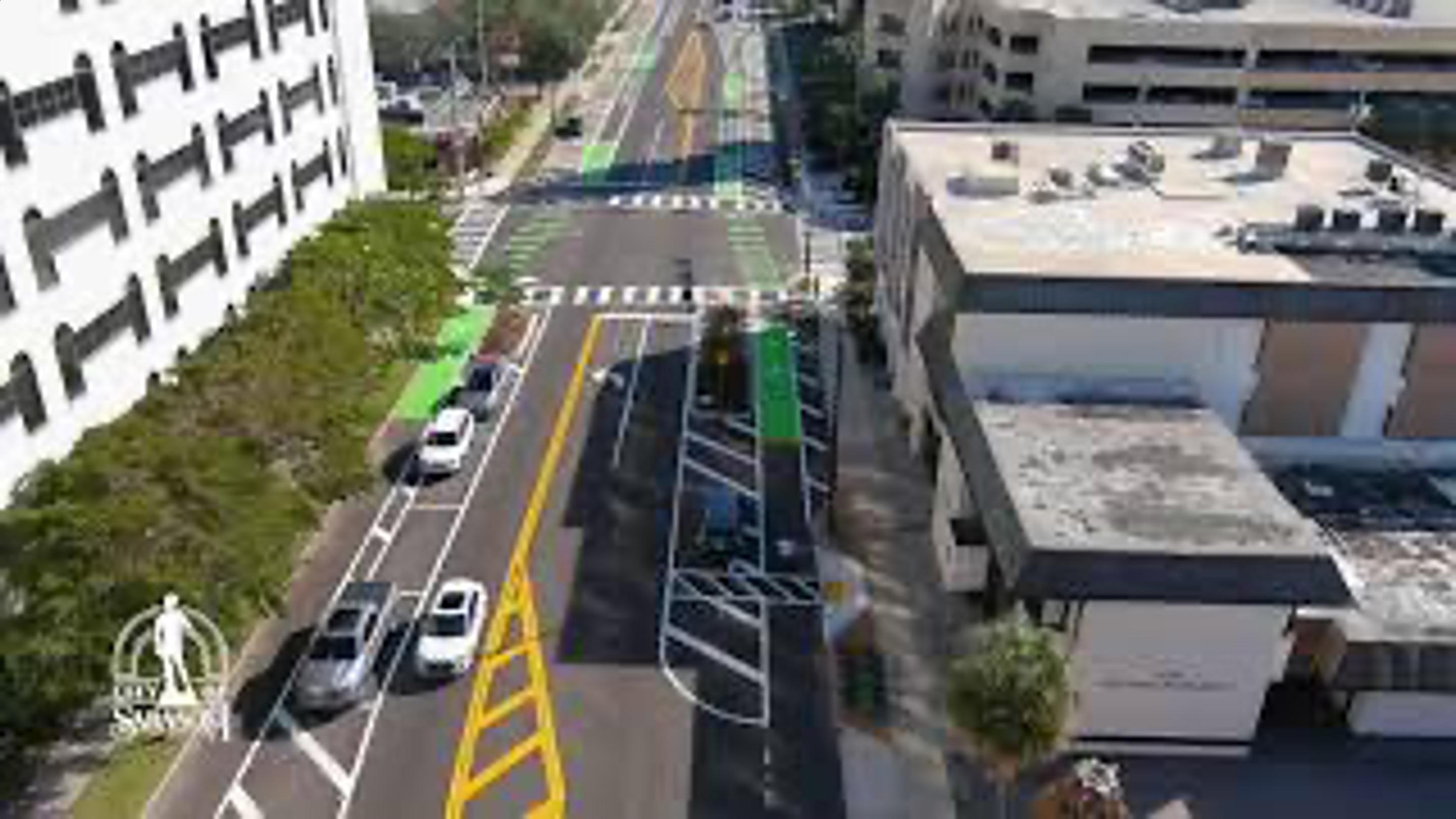

• Finishing Touches (2023)

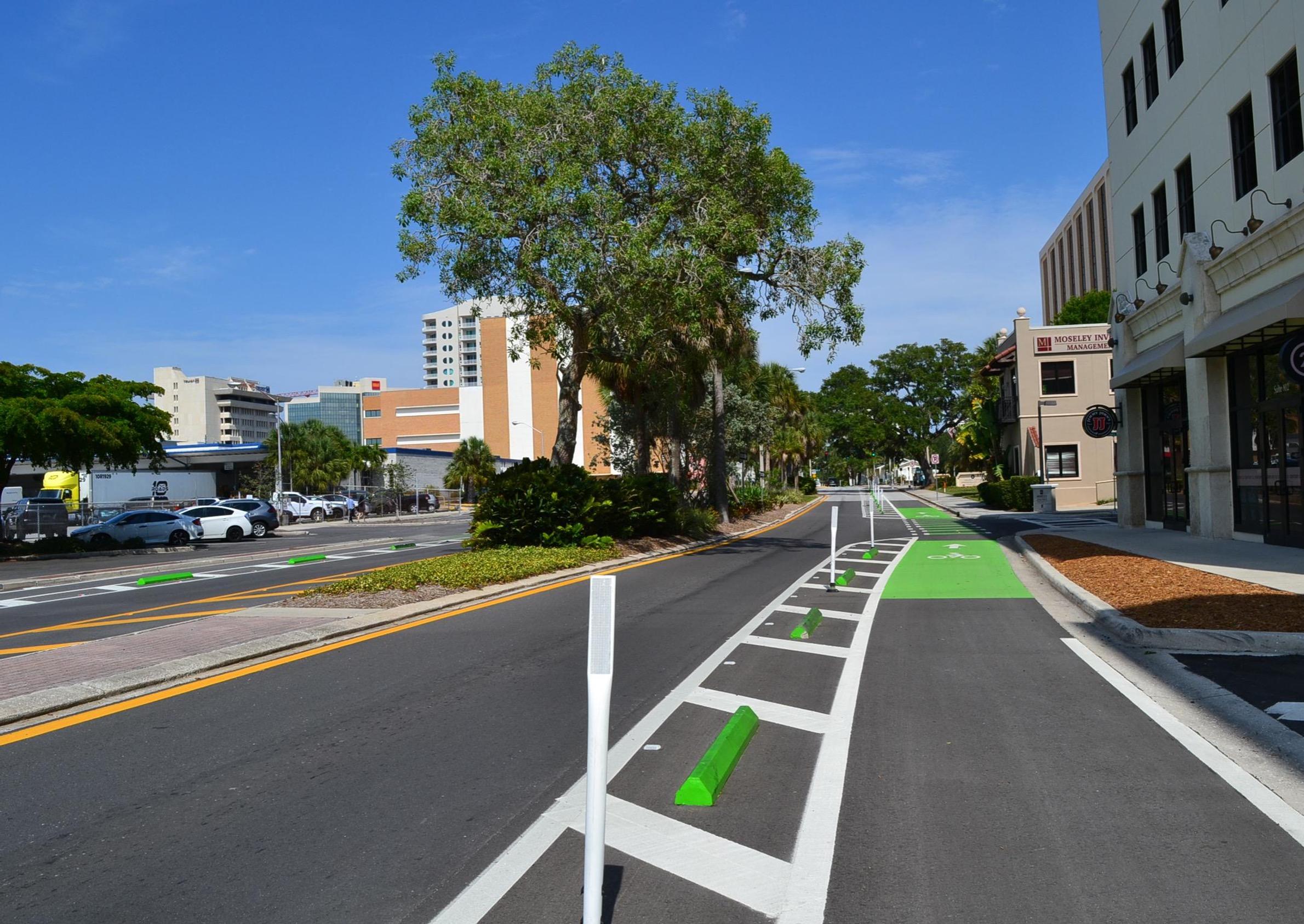

– Delineators
– Green Wheel Stops
Wenonah@MyMPO.org
FSaraceno@Kittelson.com
Alvimarie.Corales@SarasotaFL.gov
Corinne.Arriaga@SarasotaFL.gov
Franco Saraceno
Corinne Arriaga
Alvimarie Corales
Nina Venter
