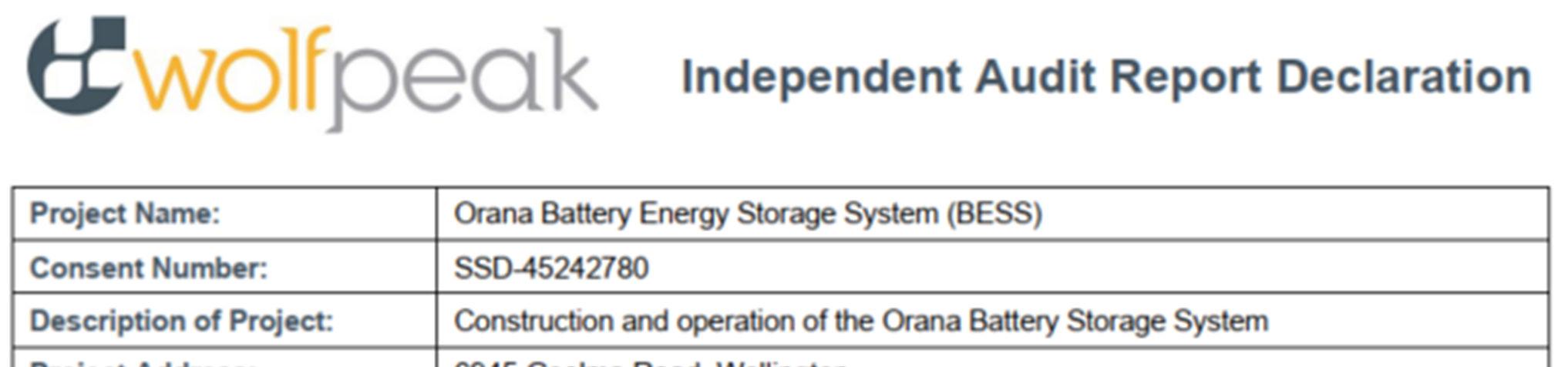

APPENDIX A – SSD 45242780 CONDITIONS OF CONSENT
PART A ADMINISTRATIVE CONDITIONS
OBLIGATION TO MINIMISE HARM TO THE ENVIRONMENT
A1 In meeting the specific performance measures and criteria in this consent, all reasonable and feasible measures must be implemented to prevent, and if prevention is not reasonable and feasible, minimise, any material harm to the environment that may result from the construction, commissioning, upgrading, operation, decommissioning or rehabilitation of the development.
TERMS OF CONSENT
A2 The development may only be carried out:
a) in compliance with the conditions of this consent;
b) in accordance with all written directions of the Planning Secretary;
c) generally in accordance with the EIS; and
d) generally in accordance with the Development Layout in Appendix 1.
Evidence referred to elsewhere in this table.

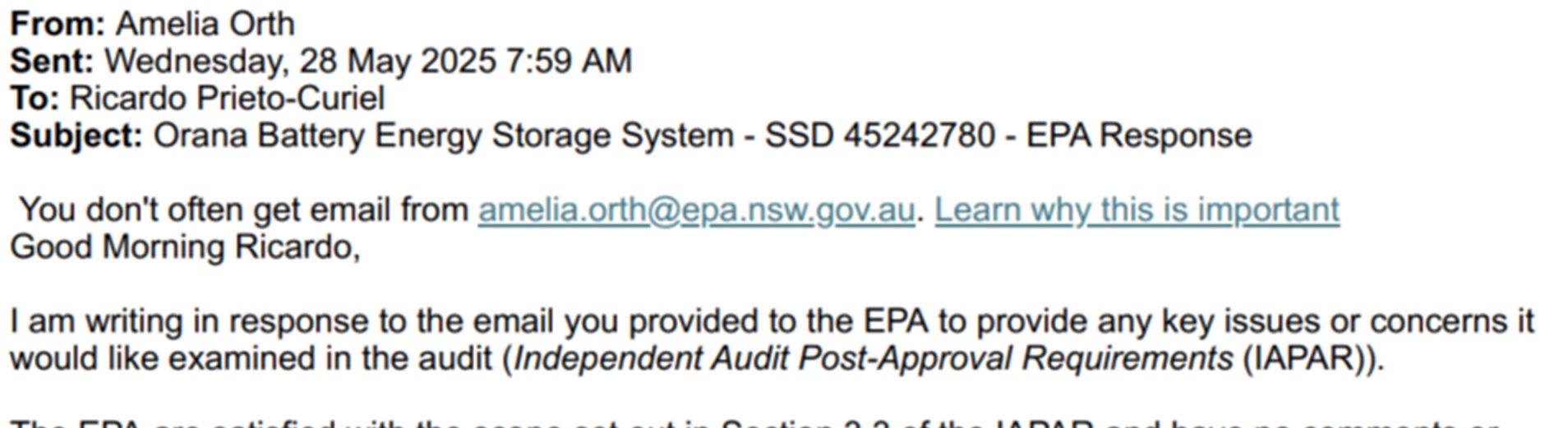

Site inspection and interview with auditees 4/06/2025

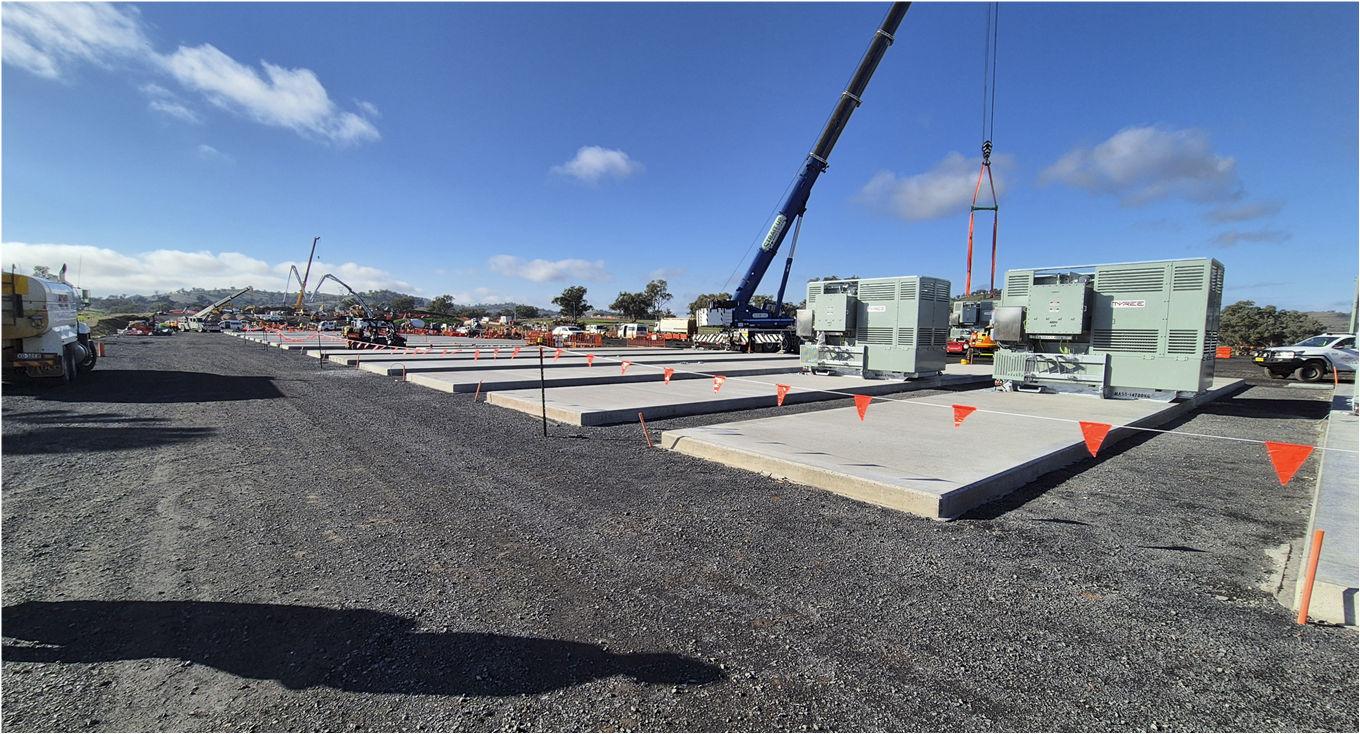

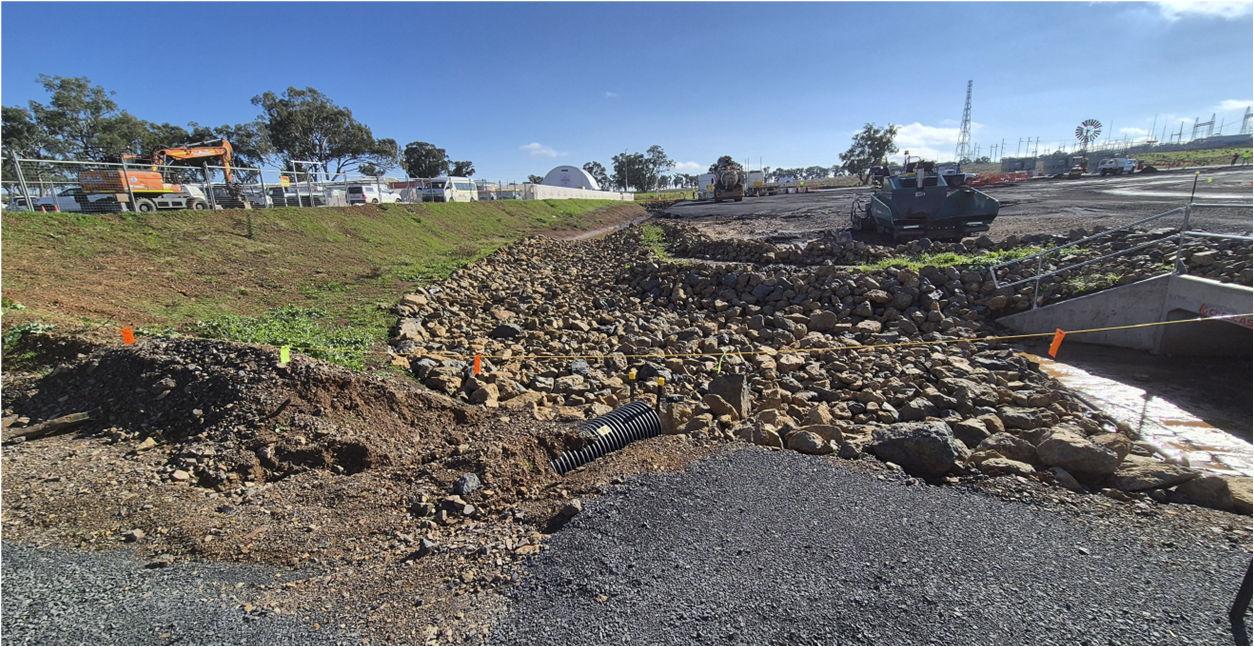

Site photos – Appendix E
Development Consent - Orana Battery Energy Storage System SSD 45242780 approved by Executive Director Energy, Resource and Industry Assessments on 22/12/2023
Mod-1 SSD 45242780 : Additional construction laydown area and permanent fill batters approved on 26/09/2029 by DPHI
Environmental Impact Assessment Orana Battery Energy Storage System Final v2.1 18/04/2023 prepared by NGH
Construction Certificate No. CCMCG40/2025 issued on 14/02/2025 by James Maltby of Maltby Certification Group Pty Ltd for the BESS including ancillary Switchgear and Control Buildings
Construction Certificate No. CCMCG40/2025/02 issued on 21/05/2025 by James Maltby of Maltby Certification Group for the Wellington Substation extension and supporting electrical infrastructure associated with the BESS
TfNSW Notice of Provisional Practical Completion dated 13/02/2025, re: WAD Wuuluman CHR(S) BAL MR 633 Goolma Road WST24/00057
Weekly Site Inspection Reports by CPP
08/05/2025
15/05/2025
22/05/2025
31/01/2025
The review of project records and the visual inspection of the site indicated that the applicant have implemented reasonable and feasible measures to prevent environmental impacts.
The auditees noted that there were no written directions from the Planning Secretary other than requests for information associated with the retirement of offset credits (reported in B12 and C11), a complaint related to spring clearing and impacts on Powerful Owl (reported in B14) and the responses to documentation submitted for approval or requests as reported elsewhere in this table. These include applicant requests to stage the Traffic Management Plan (refer to C3), request to vary vehicle numbers (refer to B1) and request to increase construction hours (refer to B17).
Development was observed to be generally carried out in accordance with the EIS, and the approved plans prepared for the project.
The Goolma Road intersection works have been completed in accordance with the consent. A notice of Provisional Practical completion was issued by TfNSW on 13/02/2025.
Construction Certificates have been issued to the project:
Construction Certificate No. CCMCG40/2025 (CC1 14/02/2025): Battery Energy Storage System (400mW) including ancillary Switchgear and Control Buildings
Construction Certificate No. CCMCG40/2025/02 (CC2) 21/05/2025: Wellington Substation extension and supporting electrical infrastructure associated with the Orana Battery Energy Storage System.
The approved documents under CC2 that the certifier relied on are:
o Long Service Leave Levy $8,902.00 paid 08/11/2024 (Receipt No. L0000169148)
o Structural Engineering Design Plans prepared by TransGrid Project No. WL1200 including Footing Layout & Details for 4m High Light Pole, Concrete Earth wire Pole, Surge Arrestor Supporter Transformer Support, Circuit Breaker & Post Insulator Support.
o Civil Engineering Design Plans prepared by TransGrid Project No. WL1200 including General Notes, Earthworks Bench Plan & Sections, Grading Layout, Demolition Plan, Drainage Layout & Pit.
Compliant
A3 The Applicant must comply with any requirement/s of the Planning Secretary arising from the Department’s assessment of:
a) any strategies, plans or correspondence that are submitted in accordance with this consent;
b) any reports, reviews or audits commissioned by the Department regarding compliance with this consent; and
c) the implementation of any actions or measures contained in these documents.
Letter 04/03/2024 DPHI-Akaysha re: Approval to increase the approved capacity of the battery energy storage system
Letter 20/11/2024 DPHI-Akaysha re: Stage 1 Road Upgrade – OOHW
Letter 3/03/25 Akaysha-DPHI re: Request to stage the TMP
Letter 10/03/25 DPHI-Akaysha re: Revised Traffic Management Plan Staging Orana BESS TMP dated 10/04/25 by CPP
Stage 2a Traffic Management Plan Rev C 7/03/25 by Amber
Letter 13/03/25 DPHI-Akaysha re: Approval of TMP Stage 2a
Stage 2b Traffic Management Plan Rev A 17/04/25 by Amber
Letter 14/05/25 DPHI-Akaysha re: Approval of TMP Stage 2b
Letter 7/04/25 Akaysha-DPHI re: Request to increase vehicle movements in relation to Condition B1
Letter 16/04/25 DPHI-Akaysha re: request to vary vehicle numbers
Letter 28/04/25 Akaysha-DPHI re: Request to vary construction hours
Letter 13/05/25 TfNSW-Akaysha re: Review of Out of Hours request for Orana BESS SSD-45242780
Letter 20/05/25 DPHI-Akaysha re: Out of Hours Approval

Weekly site inspections are being regularly undertaken for the project, covering areas such as housekeeping, tools and equipment, permits/SWMS, quality, mobile plant, and environmental aspects, including sediment controls, water drainage, air quality, solid/liquid waste, stockpiles, and chemical storage.

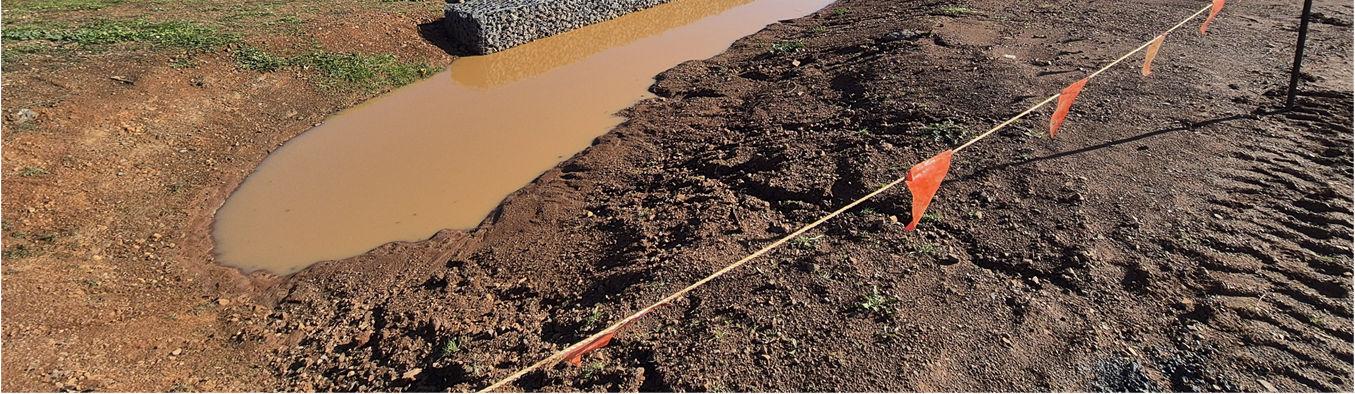

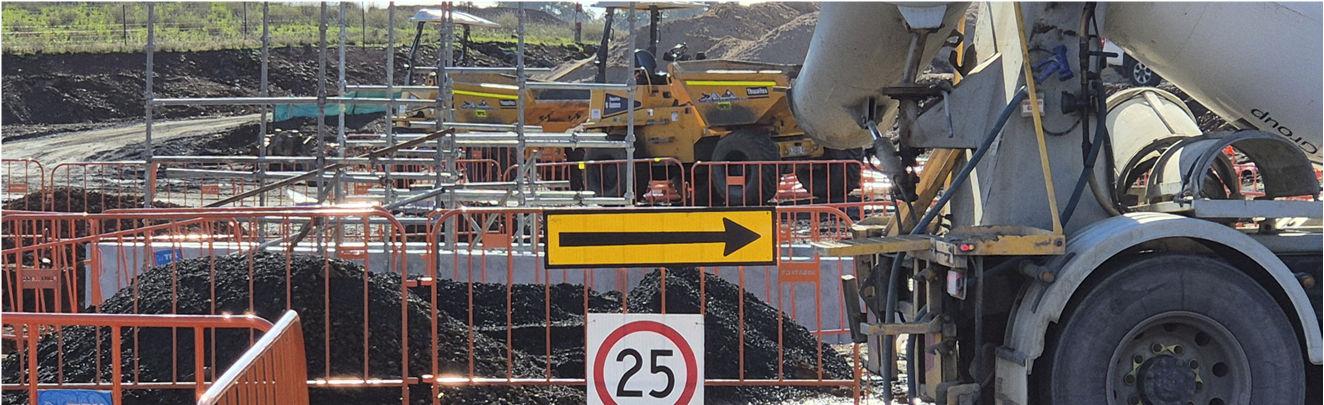

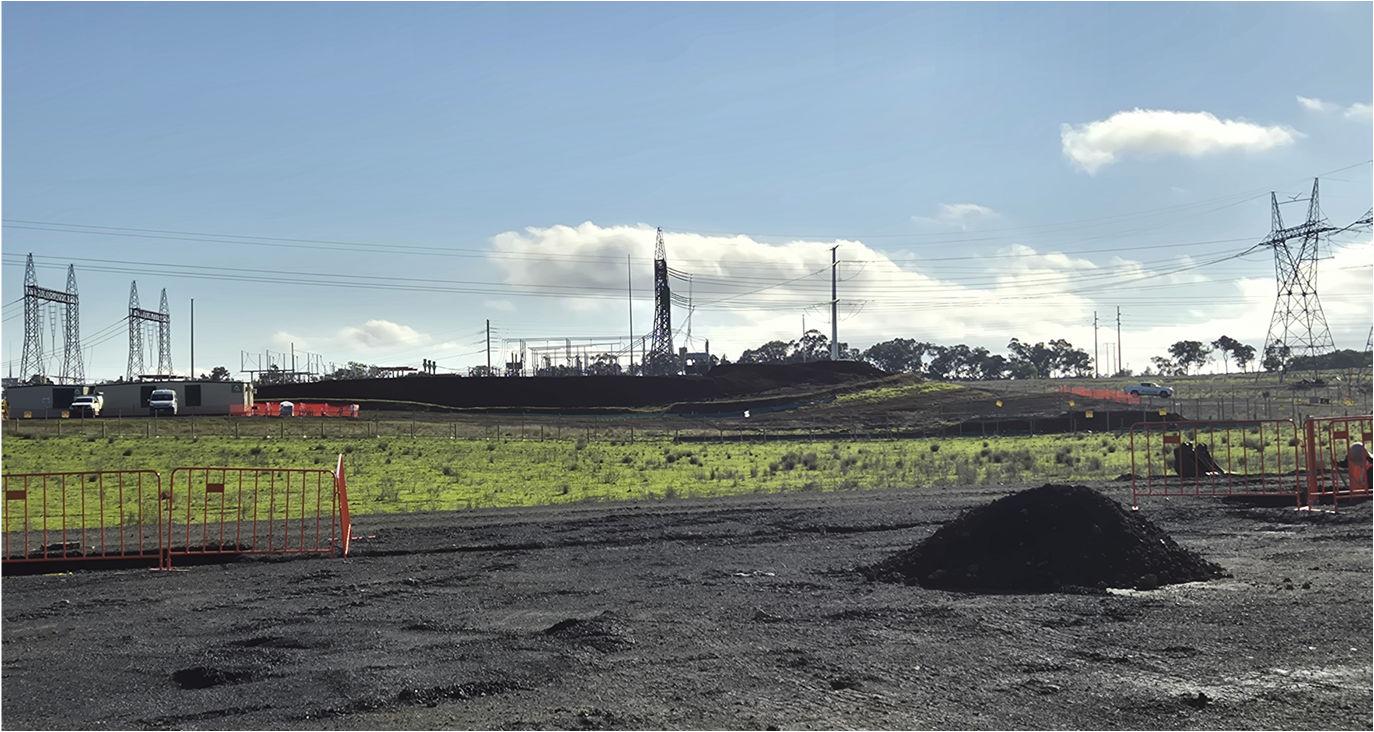

During the site inspection, it was observed that construction works were confined within the site footprint, secured by the installed fence (refer to site photos). BESS and Substation CCs issued as discussed above The auditee advised that no other CCs required for the project
On 04/03/2024, the Department approved a 15 MW increase to the total delivery capacity prescribed in Condition A5, bringing the total to 415 MW, with instructions to make this information publicly available on the project website at the earliest convenience.
On 20/11/2024, the Department approved the out-of-hours request to extend working hours from 1 PM to 5 PM each Saturday until the completion of Stage 1, which involves the construction of road upgrades at Goolma Road. The Department also instructed that this information be made publicly available on the project website at the earliest convenience.
On 3/03/25, the auditees made a request to stage TMP to the DPHI and the Department approved then request on 10/03/25. The revised Traffic Management Plan Staging include:
Stage 1: Construction of the road upgrades at the intersection of the site access and Goolma Road, construction of internal access roads, initial site mobilisation, progress site clearing and civil works for the BESS Bench.
Stage 2a: Onsite Construction activities of the BESS comprising of all remaining works, excluding movements with high-risk heavy vehicles requiring escort.
Stage 2b: remaining movements with high-risk heavy vehicles requiring escort.
Stage 3: Operation of the BESS.
Stage 4: Decommissioning the BESS at end of life.
DPHI approved the request to stage the TMP provisions in correspondence 10/03/25. It required that updates to the TMP are made prior to the commencement of each stage. A Stage 2a TMP (7/03/25) was prepared by Amber, which was approved by DPHI on 13/03/25. A Stage 2b TMP (17/04/25) was prepared by Amber, which was approved by DPHI on 14/05/25. TMP stage 2 The CPP’s TMP was updated in TMP dated 01/04/25.
On 7/04/25, the auditees made a request to increase vehicle movements relation to Condition B1 which include:
from 35 to 80 heavy vehicle movements per day during construction, upgrading or decommissioning.
from 30 to 50 light vehicle movements and from 5 to 10 heavy vehicle movements during the AM (6-7am) or PM (56pm) project peak hours during construction, upgrading or
Compliant

A4 The conditions of this consent and directions of the Planning Secretary prevail to the extent of any inconsistency, ambiguity or conflict between them and a document listed in condition A2(c) or A2(d). In the event of an inconsistency, ambiguity or conflict between any of the documents listed in condition A2(c) or A2(d), the most recent document prevails to the extent of the inconsistency, ambiguity or conflict.
Interview with auditees 4/06/2025
decommissioning. There is no proposed change to the 5 shuttle bus movements.
from 6 to 15 heavy vehicle movements requiring escort during construction, upgrading or decommissioning.
The Department approved the request on16/04/25 noting that:
increase in vehicle movements must also be incorporated within an updated Traffic Management Plan to be approved prior to any additional movements being undertaken.
there is a change to the high-risk heavy vehicle route to facilitate transformer deliveries to site as detailed in the TIA prepared by Amber (20 March 2025).
original route from Adelaide primarily used the Barrier and Mitchell Highways while the updated route primarily used the Newell Highway before using the Mitchell Highway at Dubbo. In accordance with Condition B4 of Schedule 2, all heavy vehicles requiring escort will still be travelling to and from the site via the Mitchell Highway and Goolma Road
prior to undertaking any heavy vehicle movements requiring escort please provide an updated Traffic Management Plan for Stage 2b of the development, in accordance with the staging request approved by the Department on 8 October 2024 (PA-23)
The revised approved traffic movements were documented in the A Stage 2b TMP (17/04/25)
On 28/04/25, the auditees submitted a request to the Department to vary the construction hours, with consultation undertaken with TfNSW on 8/05/25.
On 13/05/25, TfNSW provided a response to Akaysha’s request regarding OOHW during construction, noting that no further information is required by TfNSW, provided the OOHW is limited to 1:00 pm to 5:00 pm on Saturdays and 8:00 am to 5:00 pm on Sundays, and that traffic volumes align with the conditions of consent.
On 20/05/25, the Department approved the request for OOHW on Saturdays (1:00 pm to 5:00 pm) and Sundays (8:00 am to 5:00 pm) until 30/11/25.

Directions from the Department during the audit period included:
request for information regarding retirement of offset credits (for details refer to B12 and C11),
request for information regarding complaint on spring clearing and powerful owl incident (for details refer to B14)
TMP further re-staging, increase in traffic volumes and ncreased work hours (for details refer to A3)
No inconsistencies reported or identified during the audit.
Compliant
BATTERY STORAGE RESTRICTION
A5 Unless the Planning Secretary agrees otherwise in writing, the battery storage associated with the development must not exceed a total delivery capacity of 400 MW.
Note: This condition does not prevent the Applicant from seeking to lodge a separate development application or modify this consent to increase the capacity of the battery storage in the future.
Akaysha letter to DPHI dated 1/02/2024: Request to marginally exceed 400MW capacity due to technology and performance enhancements
DPHI letter to Development ANZ dated 4/03/2024, re: Request to increase the approved capacity of the BESS https://akayshaenergy.com/projects/oranabess
DPHI, in correspondence to Development ANZ dated 4/03/2024, approved a 15 MW increase to the total delivery capacity prescribed in Condition A5, to a total of 415 MW. DPHI required that the approval of increase capacity be made publicly available on the project website.
The approval to increase capacity is uploaded in the project website
No changes to this condition since last audit
A6 The Applicant may upgrade the battery storage and ancillary infrastructure on site provided these upgrades remain within the approved development footprint of the site. Prior to carrying out any such upgrades, the Applicant must provide revised layout plans and project details of the development to the Planning Secretary incorporating the proposed upgrades.
STRUCTURAL ADEQUACY
A7 The Applicant must ensure that all new buildings and structures, and any alterations or additions to existing buildings and structures, are constructed in accordance with the relevant requirements of the Building Code of Australia.
Notes:
Under Part 6 of the EP&A Act, the Applicant is required to obtain construction and occupation certificates for the development.
The EP&A Regulation sets out the requirements for the certification of the development.
Interview with auditees 4/06/2025

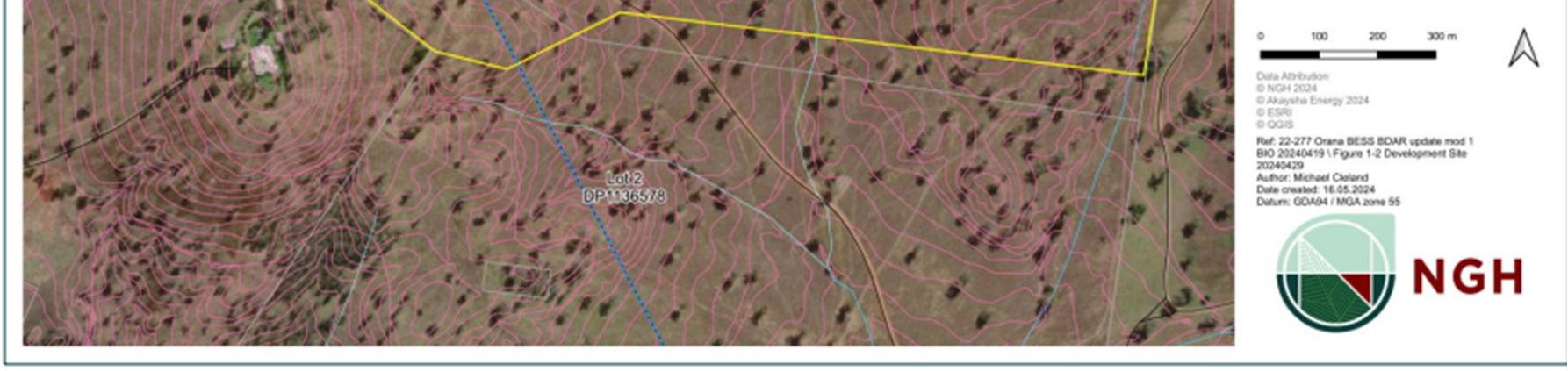

Eastern BESS Yard Facility Site Plan Rev O 13/12/24 by Consolidated Power Projects
Tesla Storage Shed Concept Design 12/02/25
Email 14/06/2024 CPP-Dubbo Council re: Orana BESS Construction Certificate
Email 19/06/2024 Dubbo Council-PCC re: response to query – Construction Certificate for the Project
Email osader@conpower.com.au to Council dated 14 June 14 2024, re: Orana BESS construction certificates
Construction Certificate No. CCMCG40/2025 approved on 14/02/2025 by James Maltby of Maltby Certification Group Pty Ltd for the BESS including ancillary Switchgear and Control Buildings
Construction Certificate No. CCMCG40/2025/02 approved on 21/05/2025 by James Maltby of Maltby Certification Group for the Wellington Substation extension and supporting electrical infrastructure associated with the BESS
No upgrades reported for the audit reporting period. Design has reportedly remained within the approved development footprint
Consolidated Power Projects made a query on 14/06/2024 to Dubbo Council regarding the Construction Certificate for the project. In that email it identified the following items requiring construction certificates in accordance with discussions with Council:
1. 2x Transformer bunds including pre-cast fire walls.
2. 448x Tesla Megapack battery blocks including foundations.
3. 1x Control building including foundation and stormwater drainage.
4. 2x Switchgear buildings including foundation and stormwater drainage.
5. 1x Operation & Maintenance building including foundation and stormwater drainage.
On 19/06/2024, Dubbo Council responded to the query and noted that in addition, the only building work that would need to be the subject of a Construction Certificate is the perimeter fencing and the water storage tanks.
Two Construction Certificates have been issued to the project:
Construction Certificate No. CCMCG40/2025 (CC1 14/02/2025): Battery Energy Storage System (400mW) including ancillary Switchgear and Control Buildings
Construction Certificate No. CCMCG40/2025/02 (CC2) 21/05/2025: Wellington Substation extension and supporting
triggered
Compliant
electrical infrastructure associated with the Orana Battery Energy Storage System.
The approved documents under CC2 that the certifier relied on are:
o Long Service Leave Levy $8,902.00 paid 08/11/2024 (Receipt No. L0000169148)
o Structural Engineering Design Plans prepared by TransGrid Project No. WL1200 including Footing Layout & Details for 4m High Light Pole, Concrete Earth wire Pole, Surge Arrestor Supporter Transformer Support, Circuit Breaker & Post Insulator Support.
o Civil Engineering Design Plans prepared by TransGrid Project No. WL1200 including General Notes, Earthworks Bench Plan & Sections, Grading Layout, Demolition Plan, Drainage Layout & Pit.
The auditee advised that no further CCs are required.
DEMOLITION
A8 The Applicant must ensure that all demolition work on site is carried out in accordance with Australian Standard AS 2601-2001: The Demolition of Structures, or its latest version.
PROTECTION OF PUBLIC INFRASTRUCTURE
A9 Unless the Applicant and the applicable authority agree otherwise, the Applicant must:
a) repair, or pay the full costs associated with repairing, any public infrastructure that is damaged by the development; and
b) relocate, or pay the full costs associated with relocating, any public infrastructure that needs to be relocated as a result of the development.
Note: This condition does not apply to the upgrade and maintenance of the road network, which is expressly provided for in the conditions of this consent.
OPERATION OF PLANT AND EQUIPMENT
A10 All plant and equipment used on site, or in connection with the development, must be:
a) maintained in a proper and efficient condition; and
b) operated in a proper and efficient manner.

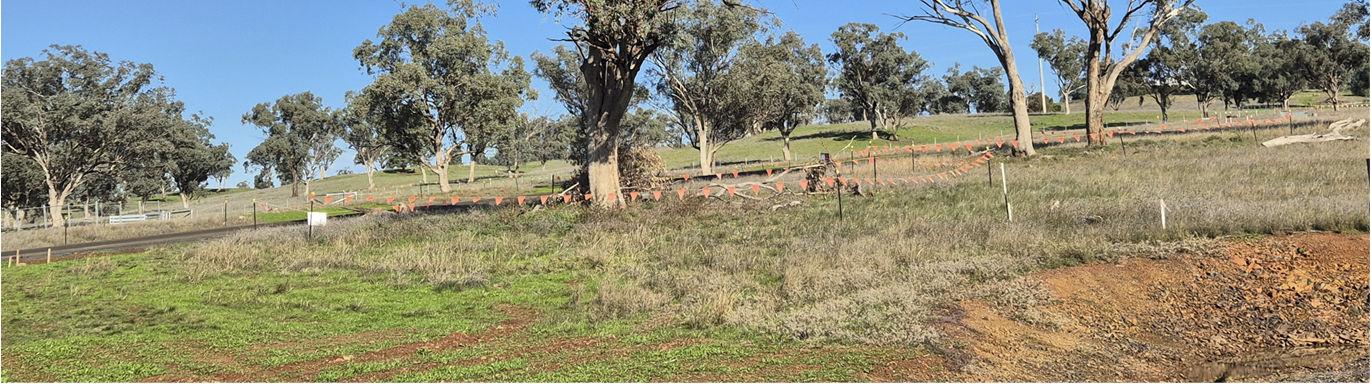

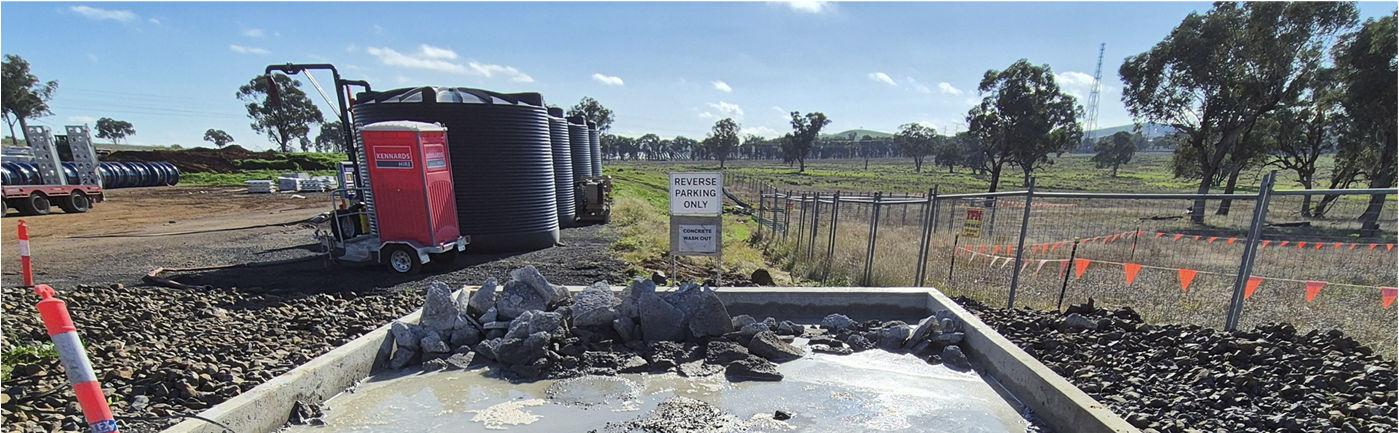

Interview with auditees 4/06/2025 No demolition of buildings or infrastructure required. Not triggered
Pre-Construction Geotagged Condition Survey OPT-33290, Lot 2 6945 Goolma Road, Montefiores NSW (inspection date: 23/04/2024) prepared by Aus Dilaps
Pre-Construction Geotagged Condition Survey OPT-33290, at Lot 2 6945 Goolma Road, Montefiores NSW of Council assets was undertaken by AusDilaps and include kerbs, gutters, footpaths and roadways.
The auditee advised that no repair works or relocation of public infrastructure have been undertaken since the project commenced. No damage of public infrastructure reported during the audit period
Orana BESS Plant List for road and rail plant (Feb 2024 to Feb 2025)
5t Excavator Kubota u55-4G last service 19/10/24 nest service 19/10/25
Vehicle mounted crane Volvo FM13 last service 22/01/25 next service 11/02/26
Roller Bomag last service 30/01/25 next service 3/01/23
Orana BESS Plant List Spicers Plant (Sept2024 to Feb 2025)
Articulated dumper last service 30/04/25 nest service 30/04/26
Grader CAT CS76 last service 7/04/25 next service 7/04/26
The Orana BESS Plant List was provided, including the plant ID, plant register name, make, status, organization name, last service date, and next service date.
Asset Repair & Maintenance History Report for spreader truck and soil compactor was provided showing all the repair and maintenance undertaken to the equipment.
Compactor last service 11/17/24 next service 20/12/25
Asset Repair & Maintenance History Report –Spreader Truck, FH
Asset Repair & Maintenance History Report –Soil Compactor, FH
SUBDIVISION
A11 The Applicant may subdivide land comprising the site for the purposes of carrying out the development as identified in Appendix 3 and in accordance with the requirements of the EP&A Act, EP&A Regulation and the Conveyancing Act 1919 (NSW).
Notes:
Under Part 6 of the EP&A Act, the Applicant is required to obtain a subdivision certificate for a plan of subdivision.
Division 6.4 of Part 6 of the Act sets out the application requirements for subdivision certificates.
APPLICABILITY OF GUIDELINES
A12 References in the conditions of this consent to any guideline, protocol, Australian Standard or policy are to such guidelines, protocols, Standards or policies in the form they are in as at the date of this consent. However, consistent with the conditions of this consent and without altering any limits or criteria in this consent, the Planning Secretary may, when issuing directions under this consent in respect of ongoing monitoring and management obligations, require compliance with an updated or revised version of such a guideline, protocol, Standard or policy, or a replacement of them.
COMPLIANCE
A13 The Applicant must ensure that all of its employees, contractors (and their sub-contractors) are made aware of, and are instructed to comply with, the conditions of this consent relevant to activities they carry out in respect of the development.
DP1301494 - Plan of Subdivision of Lot 2 DP1226754 and Right of Access affecting Lot 2 DP1136578, 24/04/2024, Pat Clarkstone
Plan Information Notice 24/04/2024 issued by Land Registry Services
Land has been purchased by Akaysha via a land agreement. and the site has been subdivided and registered in the land title office.
DP1301494 - Plan of Subdivision of Lot 2 DP1226754 and Right of Access affecting Lot 2 DP1136578 was provided prepared by Pat Clarkstone and was officially registered on 24/04/2024 under Dubbo Regional Council.
Plan Information Notice for DP1301494 was issued by Land Registry Services indicating that land was officially registered.
No changes during the audit period
CEMP and subplans
The management plans appear to reference the current guidelines, standards and protocols relevant to the topics that each document addresses during construction phase.
Orana BESS Specific Induction V3 April 2024
Orana BESS – Completed Induction Report Sept 2024 to May 2025
Email 26/11/2024 Akaysha-Stemar re: Deliver - MU Incomer BCT200 External Current Transformers
Project Directions and Requirement prepared by Akaysha issued to service providers and suppliers
Email 4/06/25 CPPA to Conpower re: induction snapshot to encourage carpooling

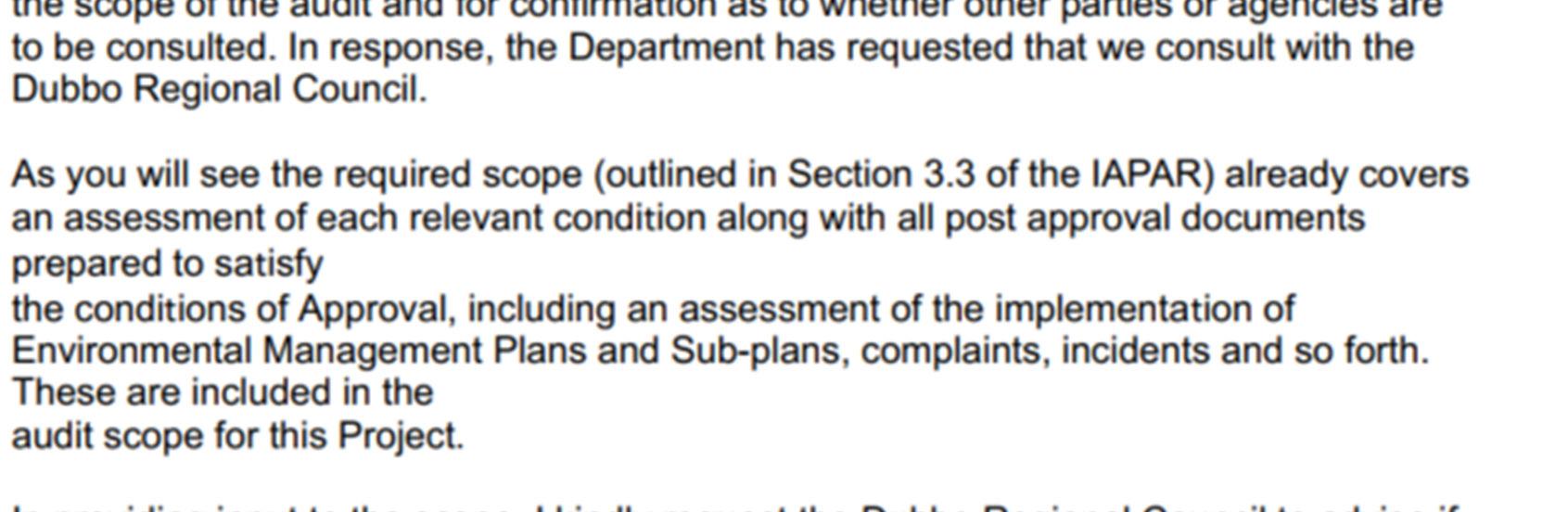

EVIDENCE OF CONSULTATION
A14 Where conditions of this consent require consultation with an identified party, the Applicant must: Orana Battery Energy Storage System Traffic Management Plan Stage 1 (Rev L,
Orana BESS Specific Induction V3 April 2024 was prepared that cover critical information to ensure that workers and visitors understand the site's safety, operational, and compliance requirements.
The Orana BESS Completed Induction Report, current as of 19/05/2025, was sighted. It showed site workers inducted from 21/09/2024 to the present, with a total of 531 workers inducted.
Email dated 26/11/2024 from Akaysha was provided, sharing the Traffic Management Plan with the supplier of MU Incomer BCT200 External Current Transformers. The plan is distributed to drivers traveling to the site.
The Project Directions and Requirements document, prepared by Akaysha, specifies that delivery drivers must report to the site office upon arrival and complete an induction.
Pre-engagement package which is sent to transport companies which includes driver delivery instructions
Consultation records required for the TMP were included in Appendix B of the plan.
a) consult with the relevant party prior to submitting the subject document to the Planning Secretary for approval; and
b) provide details of the consultation undertaken including:
i. the outcome of that consultation, matters resolved and unresolved; and
ii. details of any disagreement remaining between the party consulted and the Applicant and how the Applicant has addressed the matters not resolved.
19/09/2024) prepared by Amber Traffic & Transportation Direction.
Stage 2a Traffic Management Plan Rev C 7/03/25 by Amber
Stage 2b Traffic Management Plan Rev A 14/04/25 by Amber
Letter 4/03/25 TfNSW-Akaysha re: TfNSW response relating to consultation TMP Stage 2
Email 29/01/25 Akaysha-Council (Dubbo Regional Council) re: Consultation Stage 2 TMP
Email 8/05/25 Akaysha-TfNSW re: Consultation on OOHW
Letter 13/05/25 TfNSW-Akaysha re: Review of Out of Hours request for Orana BESS SSD-45242780
Email 7/05/25 Akaysha-Council re: Consultation relating to vary construction hours
Email 15/05/25 Council-Akaysha re: response to consultation relating to vary construction hours
Email 3/02/25 Akaysha-nearby residents (Carl & Jennie) re: Consultation with the resident relating to OOHW
Email 17/03/25 Carl & Jennie-Akaysha re: respond to OOHW consultation
Email 3/03/25 Ross Plasto (resident)Akaysha re: respond to OOHW consultation
COMMUNITY ENHANCEMENT
A15 Prior to commencing construction, or other timeframe agreed by the Planning Secretary, the Applicant must enter into a VPA with Council in accordance with:
a) Division 7.1 of Part 7 of the EP&A Act; and
b) the terms of the correspondence dated 27 November 2023, which are summarised in Appendix 6.
Heavy Vehicles Requiring Escort and Heavy Vehicle Restrictions
Planning Agreement for Orama BESS and Dubbo regional Council 2/08/2024
Letter 10/09/2024 Akaysha to DPHI re: Commencement of Goolma Road and Enabling Site Works – 29/08/2024
Consultations were undertaken for amending work hours on Saturdays.
Consultation Log and Correspondence prepared by Akaysha provide details of consultations undertaken with Heritage NSW and other relevant stakeholders.
Consultation for Orana BESS Fire Safety Study undertaken with FRNSW.
Evidence of consultation with TfNSW and Council was sighted in relation to the update of the TMP.
On 13/05/25, TfNSW provided a response to Akaysha’s request regarding OOHW during construction, noting that no further information is required by TfNSW, provided the OOHW is limited to 1:00 pm to 5:00 pm on Saturdays and 8:00 am to 5:00 pm on Sundays, and that traffic volumes align with the conditions of consent.
Consultation with Council and nearby residents was undertaken by the auditee prior to submitting the OOHW request to DPHI.
BCS consultation (incident) undertaken as reported in B14
The Planning Agreement between Orana BESS and Dubbo Regional Council was sighted. The Execution Agreement was signed by the Mayor and John Mullins, a representative from Wellington Battery Project Co P/L, on 2/08/2024, prior to the commencement of construction on 29/08/2024.
No updates since last audit
B1 The Applicant must ensure that:
a) the development does not generate more than:
i. 35 heavy vehicle movements a day during construction, upgrading or decommissioning;
ii. 30 light vehicle movements, 5 shuttle bus vehicle movements and 5 heavy vehicle movements during the AM (6-7 am) or PM (5-6 pm) project peak hours during construction, upgrading or decommissioning; and
iii. 6 movements of heavy vehicles requiring escort during construction, upgrading or decommissioning; and
b) the length of any vehicles (excluding heavy vehicles requires escort) used for the development does not exceed 26 metres, unless the Planning Secretary agrees otherwise.
Orana BESS Stage 1 Traffic Management Plan Rev L, 19/09/2024 prepared by Amber
Orana BESS Traffic Management Plan, 10/04/22025 prepared by CPP
Stage 2a Traffic Management Plan Rev C 7/03/25 by Amber
Letter 13/03/25 DPHI-Akaysha re: Approval of TMP Stage 2a
Stage 2b Traffic Management Plan Rev A 17/04/25 by Amber
Letter 14/05/25 DPHI-Akaysha re: Approval of TMP Stage 2b
Letter 7/04/25 Akaysha-DPHI re: Request to increase vehicle movements in relation to Condition B1
Letter 16/04/25 DPHI-Akaysha re: request to vary vehicle numbers
Monthly Vehicle Movements April and May 2025 by PCC
Escorted Vehicle Movements Register Orana BESS (CPP)
Oversize and/or Overmass (OSOM) Mass or Dimension Exemption Permit No. 1154161V3 dated 7/05/25 issued by National Heavy Vehicle Regulator (NHVR) - permit period 20/05/25-16/08/25
Interview with auditees 4/06/2025
On 7/04/25, the auditees made a request to DPHI increase vehicle movements relation to Condition B1 which include:
from 35 to 80 heavy vehicle movements per day during construction, upgrading or decommissioning.
from 30 to 50 light vehicle movements and from 5 to 10 heavy vehicle movements during the AM (6-7am) or PM (56pm) project peak hours during construction, upgrading or decommissioning. There is no proposed change to the 5 shuttle bus movements.
from 6 to 15 heavy vehicle movements requiring escort during construction, upgrading or decommissioning.
The Department approved the request on16/04/25 noting that:
increase in vehicle movements must also be incorporated within an updated Traffic Management Plan to be approved prior to any additional movements being undertaken.
there is a change to the high-risk heavy vehicle route to facilitate transformer deliveries to site as detailed in the TIA prepared by Amber (20 March 2025).
original route from Adelaide primarily used the Barrier and Mitchell Highways while the updated route primarily used the Newell Highway before using the Mitchell Highway at Dubbo. In accordance with Condition B4 of Schedule 2, all heavy vehicles requiring escort will still be travelling to and from the site via the Mitchell Highway and Goolma Road
prior to undertaking any heavy vehicle movements requiring escort please provide an updated Traffic Management Plan for Stage 2b of the development, in accordance with the staging request approved by the Department on 8 October 2024 (PA-23)
The CPP’s construction TMP was updated in TMP dated 01/04/25 In addition and in response to a request to stage the traffic management arrangements (refer to A3), a Stage 2a TMP (7/03/25) was prepared by Amber, which was approved by DPHI on 13/03/25. A Stage 2b TMP (17/04/25) was prepared by Amber, which was approved by DPHI on 14/05/25. TMP stage 2 The Stage 2b TMP provides the updated traffic movements as approved by DPHI on 16/04/25.
CPP monitors vehicles movements and prepares Monthly Vehicle Movements reports with details the number of heavy vehicles and light vehicles during both peak and off-peak hours.. A review of the Monthly Vehicle Movements reports for April and May 2025 (heavy, light and during peak hours) indicates that the Project complied with the approved limits. CPP keeps a Escorted Vehicle movement register for the project. The Escorted Vehicle Movements register shows a total of 11 Escorted vehicles to the site since the commencement of works, which is within the approved limits.
OSOM or Dimension Exemption Permit No. 1154161V3 was issued during the audit period by NHVR for block-truck towing OSOM load and Block truck, Planform for the period 2o May to 16 August 2025..
Compliant
B2 The Applicant must keep accurate records of the number of heavy vehicles requiring escort and heavy vehicles entering or leaving the site each day for the duration of the project.
Monthly Vehicle Movements Reports April and May 2025 by PCC
Escorted Vehicle Movements Register Orana BESS (CPP)
Oversize and/or Overmass (OSOM) Mass or Dimension Exemption Permit No. 1154161V3 dated 7/05/25 issued by National Heavy Vehicle Regulator (NHVR) - permit period 20/05/25-16/08/25
Email 22/05/25 Akaysha -TfNSW re: OSOM Movement Notification
CPP monitors vehicles movements and prepares Monthly Vehicle Movements reports with details the number of heavy vehicles and light vehicles during both peak and off-peak hours..
Monthly Vehicle Movements reports for April and May 2025 prepared by PCC, detailing the number of heavy and light vehicles during peak and off-peak hours, were provided to the auditor
Escorted Vehicle Movements 2024 report, prepared by PCC, was presented, highlighting three specific dates that required escorted vehicles.
Oversize and/or Overmass (OSOM) Mass or Dimension Exemption Permit No. 1154161V3 dated 7/05/25 issued by National Heavy Vehicle Regulator (NHVR) - permit period 20/05/25-16/08/25
An OSOM Movement Notification was provided by Akaysha to TfNSW via email on 22/05/25. The first transformer unit (TX1) is scheduled to depart the WTC factory in Victoria on 24/05/25, with delivery and offloading at Orana BESS planned for 28/05/25. The notification includes a list of items to be moved, along with their weight, length, and height
B3 All heavy vehicles associated with the development must travel to and from the site via:
a) Castlereagh Highway and Goolma Road; or
b) Mitchell Highway and Goolma Road, as shown in Appendix 4.

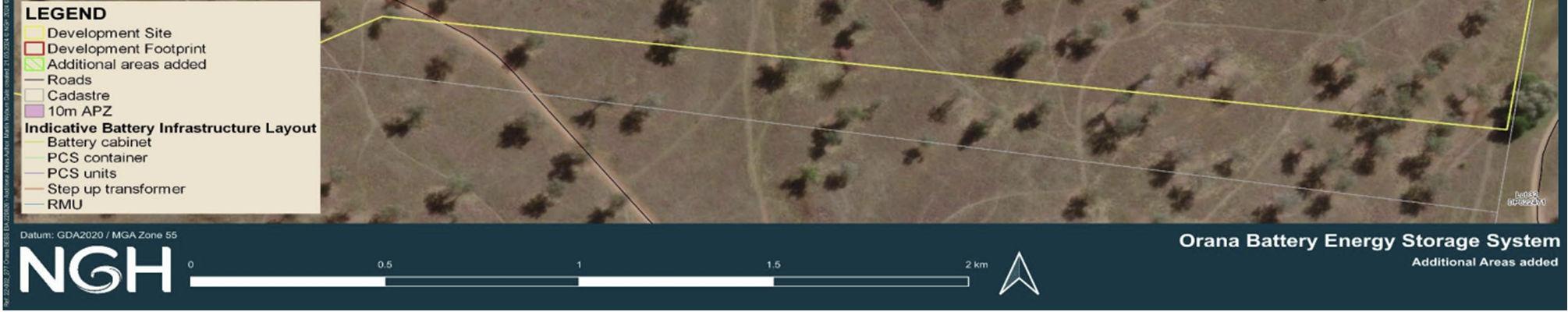

Orana BESS - Heavy Vehicle Route Map
Orana BESS Stage 1 Traffic Management Plan Rev L, 19/09/2024 prepared by Amber
Orana BESS Traffic Management Plan, 10/04/22025 prepared by CPP
Stage 2a Traffic Management Plan Rev C 7/03/25 by Amber
Letter 13/03/25 DPHI-Akaysha re: Approval of TMP Stage 2a
Stage 2b Traffic Management Plan Rev A 17/04/25 by Amber
Letter 14/05/25 DPHI-Akaysha re: Approval of TMP Stage 2b
Project Directions and Requirement prepared by Akaysha issued to service providers and suppliers
Stage 2b Traffic Management Plan Rev A 17/04/25 by Amber
Letter 14/05/25 DPHI-Akaysha re: Approval of TMP Stage 2b
Project Directions and Requirement prepared by Akaysha issued to service providers and suppliers
Oversize and/or Overmass (OSOM) Mass or Dimension Exemption Permit No. 1154161V3 dated 7/05/25 issued by National Heavy
The Orana BESS Traffic Management Plan, 10/04/22025 prepared by CPP, the Stage 2a Traffic Management Plan Rev C 7/03/25 by Amber, and the Stage 2b Traffic Management Plan Rev A 17/04/25 by Amber show the traffic routes for heavy vehicles.
Orana BESS - Heavy Vehicle Route Map that provides directions from Selwyn Street, Mayfield North NSW to 6945 Goolma Road, Montefiores NSW 2820, Australia
The Project Directions and Requirements document, prepared by Akaysha, includes the route to the site and specifies that delivery drivers must report to the site office upon arrival, complete an induction, and that the document is provided to all service providers and suppliers for guidance and compliance.
The Orana BESS Traffic Management Plan, 10/04/22025 prepared by CPP, the Stage 2a Traffic Management Plan Rev C 7/03/25 by Amber, and the Stage 2b Traffic Management Plan Rev A 17/04/25 by Amber show the traffic routes for heavy vehicles. The Stage 2b Traffic Management Plan Rev A 17/04/25 by Amber specifically shows the traffic routes for heavy vehicles requiring escort
The Project Directions and Requirements document, prepared by Akaysha, includes the route to the site and specifies that delivery drivers must report to the site office upon arrival, complete an
Access Route
B4 All heavy vehicles requiring escort associated with the development must travel to and from the site via the Mitchell Highway and Goolma Road, as described in the EIS.
Site Access
B5 All vehicles associated with the development must enter and exit the site via the site access point off Goolma Road as identified in Appendix 1.
B6 Prior to commencing construction, the Applicant must close and remove the existing site access servicing Lot 2 DP1136578.
Vehicle Regulator (NHVR) - permit period 20/05/25-16/08/25
Notification from Akaysha to TfNSW of OSOM to transport a transformer leaving Victoria on 24/05/25 and expected delivery on 28/05/25.
induction, and that the document is provided to all service providers and suppliers for guidance and compliance.
Oversize and/or Overmass (OSOM) Mass or Dimension Exemption Permit No. 1154161V3 dated 7/05/25 issued by National Heavy Vehicle Regulator (NHVR) - permit period 20/05/25-16/08/25. The permit provides route for the OSOM which complies with B4.
A notification to TfNSW was submitted for a OSOM transporting a transformer from Victoria departing on 24/05/25. The auditee advised that that the first OSOM for the project was completed on Monday 2/06/2025

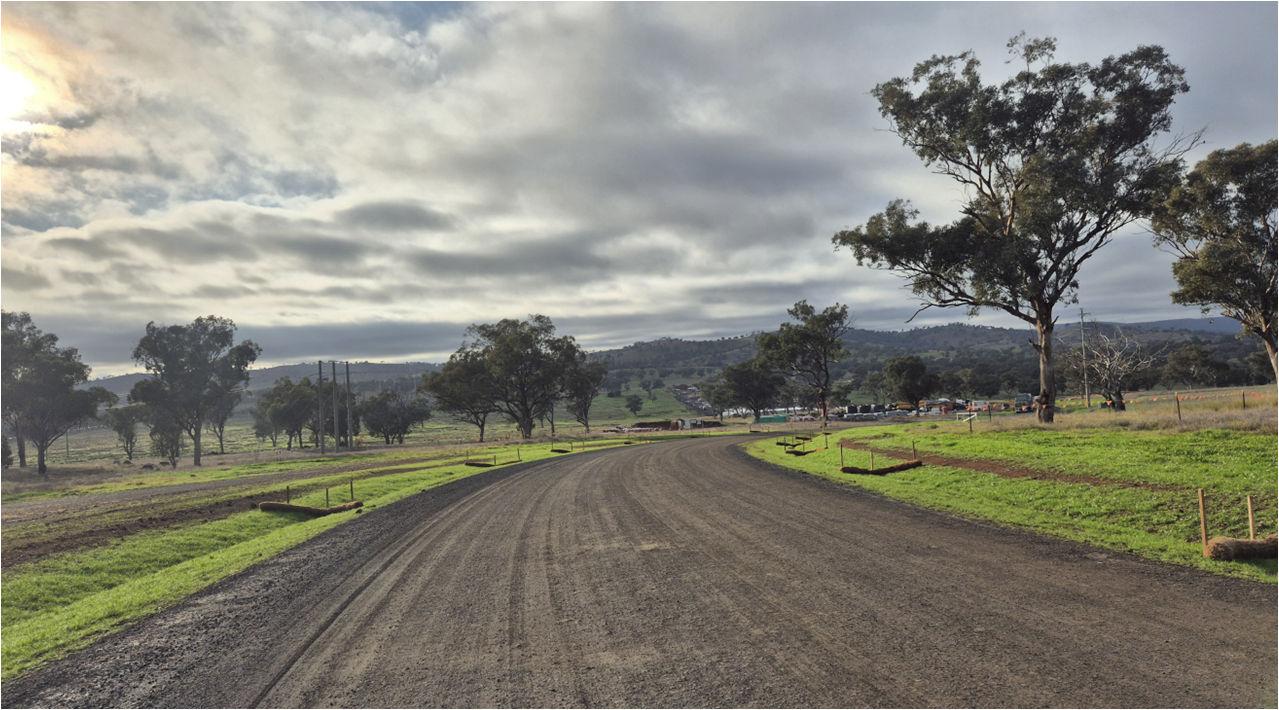

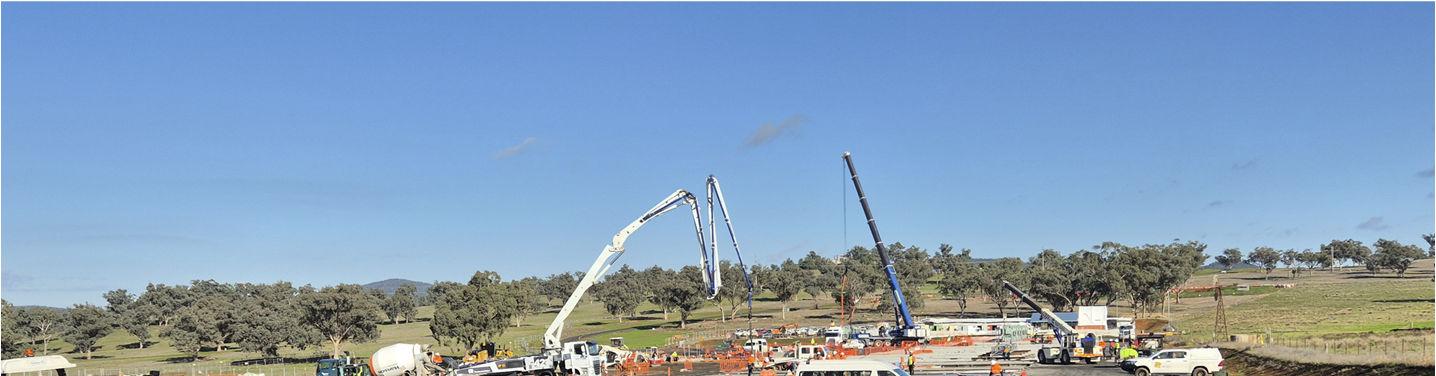

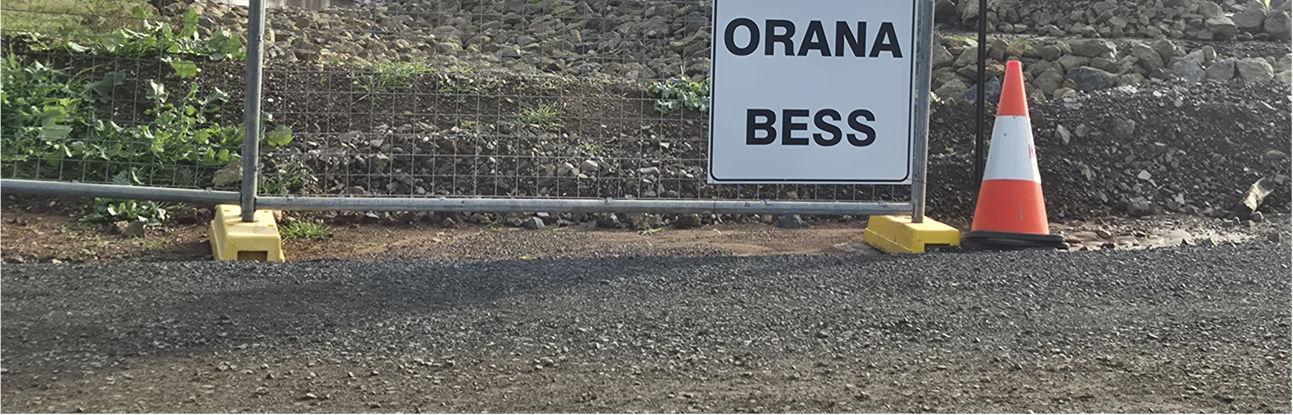

Site inspection 4/06/2025

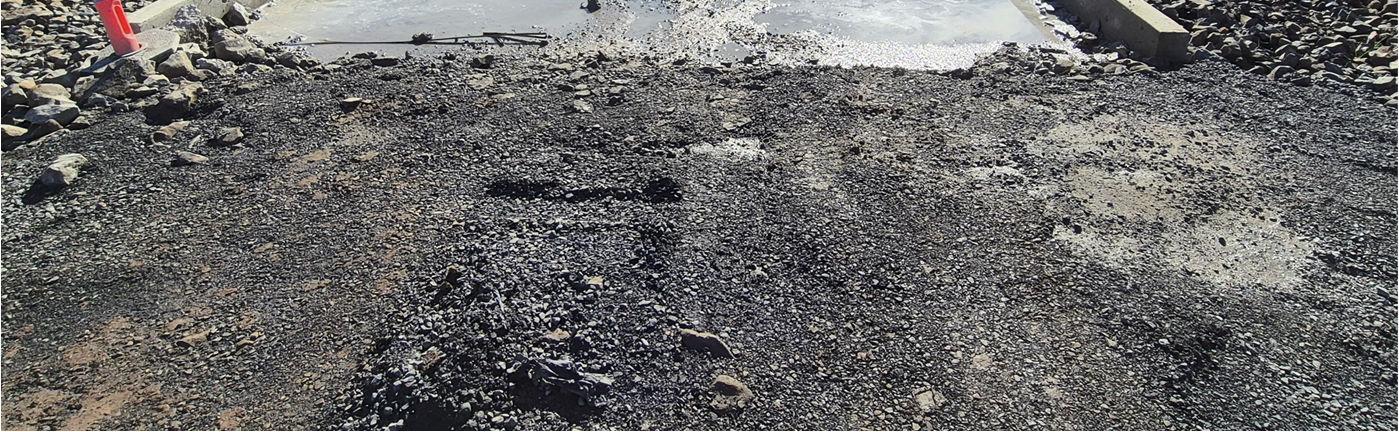

Site photos – Appendix E
Site inspection 4/06/2025
Site photos – Appendix E
Road Upgrades
B7 Unless the Planning Secretary agrees otherwise, prior to commencing construction, the Applicant must complete the road upgrades detailed in Appendix 5.
Unless the relevant road authority agrees otherwise, these upgrades must comply with the current Austroads Guidelines, Australian Standards and TfNSW supplements, and be carried out to the satisfaction of the relevant roads authority.

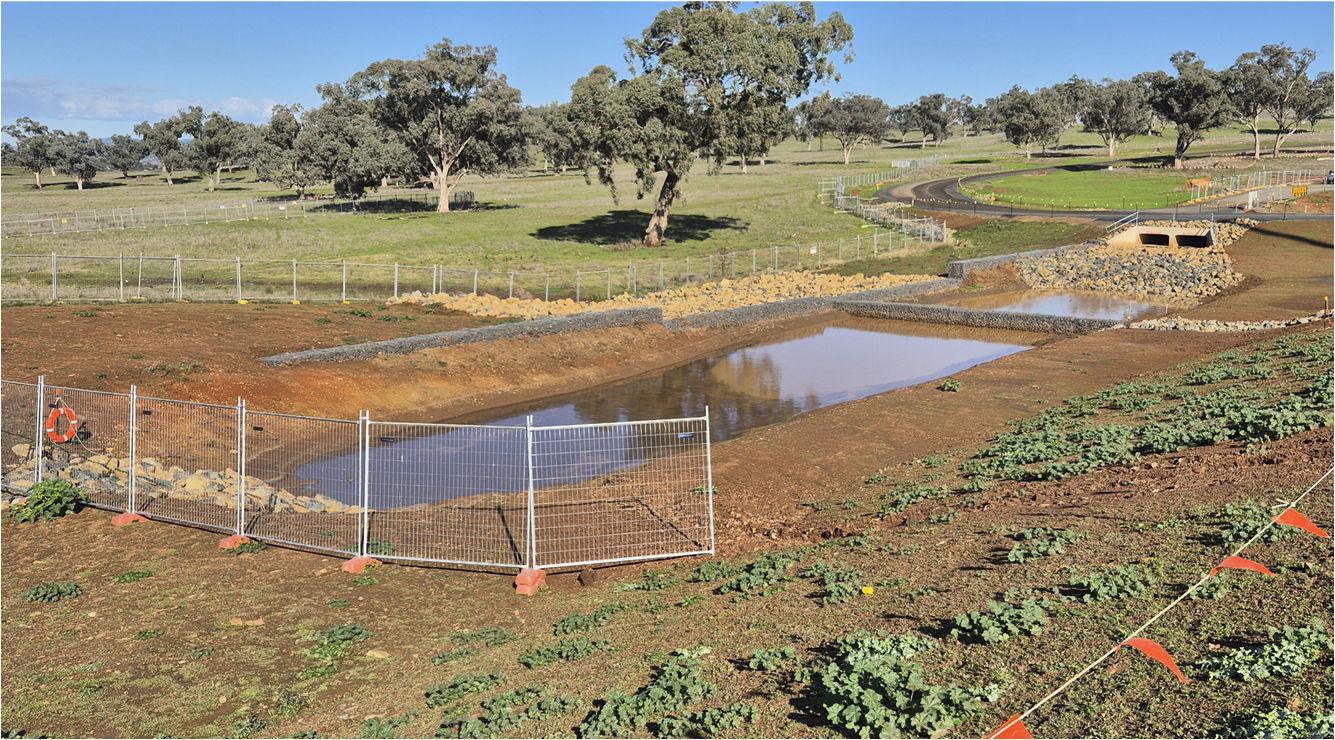

Site inspection 4/06/2025
DPHI letter to Akaysha dated 19/07/2024, re: Orana BESS – Road Upgrade and Enabling site works request
TfNSW Site Inspection Report for 6945
Goolma Road, prepared by Barker Ryan Stewart (BRS) in the following dates:
Site Inspection No.1: 4/09/2024
Site Inspection No.2: 20/09/2024
Site Inspection No.3: 23/09/2024
Site Inspection No.4: 24/09/2024
Site Inspection No.5: 25/09/2024
Site Inspection No.6: 01/10/2024
Site Inspection No.7: 02/10/2024
Site Inspection No.8: 02/10/2024
Site Inspection No.9: 21/10/2024
Site Inspection No.10: 02/11/2024
Site Inspection No.11: 04/11/2024
Site Inspection No.12: 06/11/2024
Site Inspection No.13: 07/11/2024
Site Inspection No.14: 14/11/2024
Site Inspection No.15: 19/11/2024
Site Inspection No.16: 25/11/2024
During the site inspection, it was observed that only one access point to the site was provided off Goolma Road.
No other accesses sighted during the audit
During the site interview, the auditees noted that access to Lot 2 was removed prior to the commencement of construction. Refer to the site photos for reference. The previous access was observed closed during the site inspection.
Works completed during the last audit period
During construction, TfNSW Site Inspection Reports were undertaken by Barker Ryan Stewart (BRS), an independent project verifier working on behalf of TfNSW to ensure compliance. A total of 19 site inspection reports were prepared for the project, as evidenced by the documents provided.
Goolman Road works obtained a notice of provisional practical completion from TfNSW on the 13 February 2025
For details of DPHI conditional approval to commence some enabling works in parallel with the Goolman Road upgrade refer to IA1.
Compliant
B8 Unless the Planning Secretary agrees otherwise, prior to commencing construction, the Applicant must provide a Strategic Concept Design to TfNSW for approval, detailing the intersection design identified in Appendix 5. The Strategic Concept Design must satisfy the requirements set out in Appendix 6 and the applicable guidelines and standards identified in condition B7.
Site Inspection No.17: 29/11/2024
Site Inspection No.18: 06/12/2024
Site Inspection No.19: 09/12/2024
Letter 13/02/25 TfNSW to Akaysha re: Notice of Provisional Practical Completion - WAD Wuuluman CHR(S) BAL MR633 Goolma Road WST24/00057
Refer also to B8
6945 Goolma Road, Montefiores – Detailed Design Verification (Ref No. 240367)Schedule 8 - Detailed Design Documents Certificate by Barker Ryan Stewart
Letter 30/04/2024 TfNSW-Akaysha re: Post Consent to Condition B7, B8
Letter 13/09/12024 TfNSW-Akaysha re: Approval to Commence Construction
Letter 13/09/12024 TfNSW-Akaysha re: Detailed Design Acceptance
Detailed Design Documents were certified by Barker Ryan Stewart.
TfNSW approved the strategic concept design and swept paths for the intersection treatments required to facilitate safe turning movements for the project on 30/04/2024.
The TfNSW, in its letter dated 13/09/2024, acknowledged receipt of and accepted all pre-construction documentation, authorizing works to commence within the State Road Reserve.
TfNSW approved the detailed design documentation on 13/09/2024 and noted that its validity is for 2 years from the date of approval.
Completed in last audit period
As indicated in B7, Goolman Road works obtained a notice of provisional practical completion from TfNSW on the 13 February 2025
Operating Conditions
B9 The Applicant must ensure:
a) the internal roads are constructed and maintained as all-weather roads;
b) there is sufficient parking on site for all vehicles, and no parking occurs on the public road network in the vicinity of the site;
c) the capacity of the existing roadside drainage network is not reduced;
d) all vehicles are loaded and unloaded on site, and enter and leave the site in a forward direction; and
e) development-related vehicles leaving the site are in a clean condition to minimise dirt being tracked onto the sealed public road network.
Traffic Management Plan

B10 Prior to commencing road upgrades identified in condition B7, the Applicant must prepare a Traffic Management Plan for the development in consultation with TfNSW, Council and Mid-Western Regional Council, and to the satisfaction of the Planning Secretary. This plan must include:
a) details of the transport route to be used for all development-related traffic;
b) details of the road upgrade works required by condition B7;
c) details of the measures that would be implemented to minimise traffic impacts during construction, upgrading or decommissioning works, including:
i. temporary traffic controls, including detours and signage;
Site inspection 4/06/2025

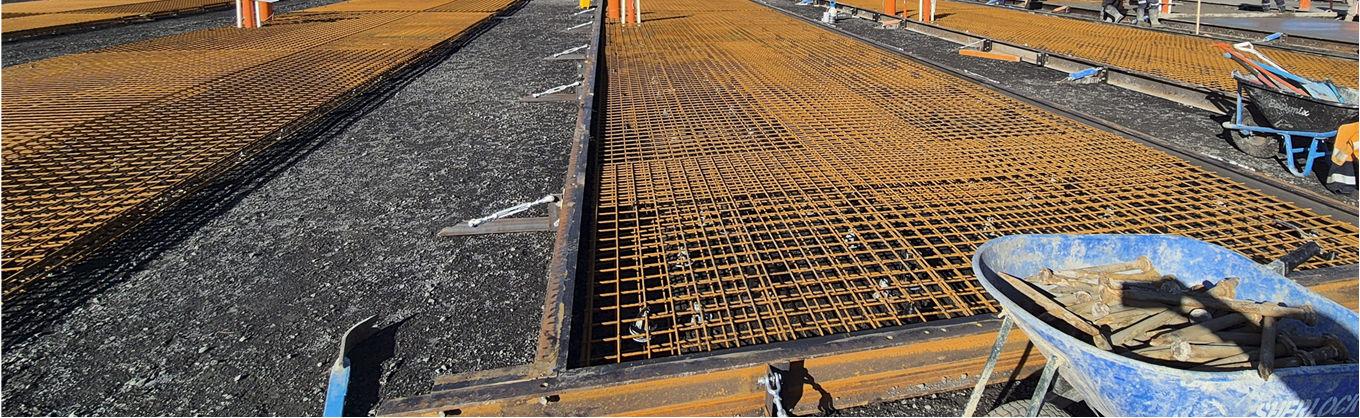

Pavement Plans (7 sheets) 12/08/2024 prepared by Quanta Services
Site inspection 4/06/2025
Orana Battery Energy Storage System Traffic Management Plan Stage 1 (Rev L, 19/09/2024) prepared by Amber Traffic & Transportation Direction.
DPHI letter to Akaysha dated 8/10/2024 re: Orana BESS – Traffic Management Plan Stage 1
Pavement plans dated 12/08/2024 prepared by Quanta Services showing internal pavement works for the project.
Internal access roads have been constructed to allow all-weather traffic for light and heavy vehicles (refer to photos in Appendix E).

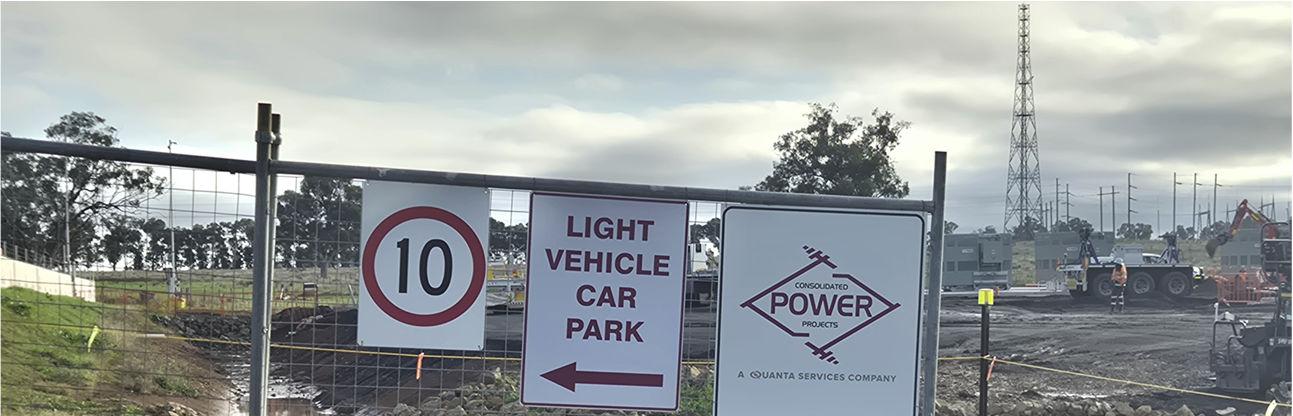

All vehicles observed parked on site. Light vehicle carpark have capacity for about 30-40 spaces.
All vehicles were observed loaded and unloaded on site, and leaving the site in a forward direction.
No dirt from the project site was observed along the public roads during the site inspection.
DPHI, in correspondence dated 8/10/24, approved the staging of the Traffic Management Plan. DPHI conditioned the approval to Stage 2 works only proceeding after the completion of the Goolma Road intersection.
DPHI, in correspondence dated 8/10/24, approved the Traffic Management Plan Stage 1 (Rev L). Consultation records were included in Appendix B of the plan.
The auditees provided evidence of consultation conducted via email regarding the Traffic Management Plan (TMP), which was sent to
ii. notifying the local community about development-related traffic impacts;
iii. procedures for receiving and addressing complaints from the community about development related traffic;
iv. minimising potential cumulative traffic impacts with other projects in the area.
v. minimising potential for conflict with school buses and other road users as far as practicable, including preventing queuing on the public road network;
vi. minimising dirt tracked onto the public road network from development-related traffic;
vii. details of the employee shuttle bus service, including pick-up and drop-off points and associated parking arrangements for construction workers, and measures to encourage employee use of this service as described in the EIS;
viii. encouraging car-pooling or ride sharing by employees;
ix. scheduling of heavy vehicle movements to minimise convoy length or platoons, and to minimise conflict with light vehicles;
x. responding to local climate conditions that may affect road safety such as fog, dust, wet weather and flooding;
xi. responding to any emergency repair or maintenance requirements; and
xii. a traffic management system for managing heavy vehicles requiring escort;
d) a driver’s code of conduct that addresses:
i. driver fatigue;
ii. procedures to ensure that drivers adhere to the designated transport routes and speed limits; and
iii. procedures to ensure that drivers implement safe driving practices; and
e) a program to ensure drivers working on the development receive suitable training on the code of conduct and any other relevant obligations under the Traffic Management Plan.
Following the Planning Secretary’s approval, the Applicant must implement the Traffic Management Plan.
BIODIVERSITY
Vegetation Clearance

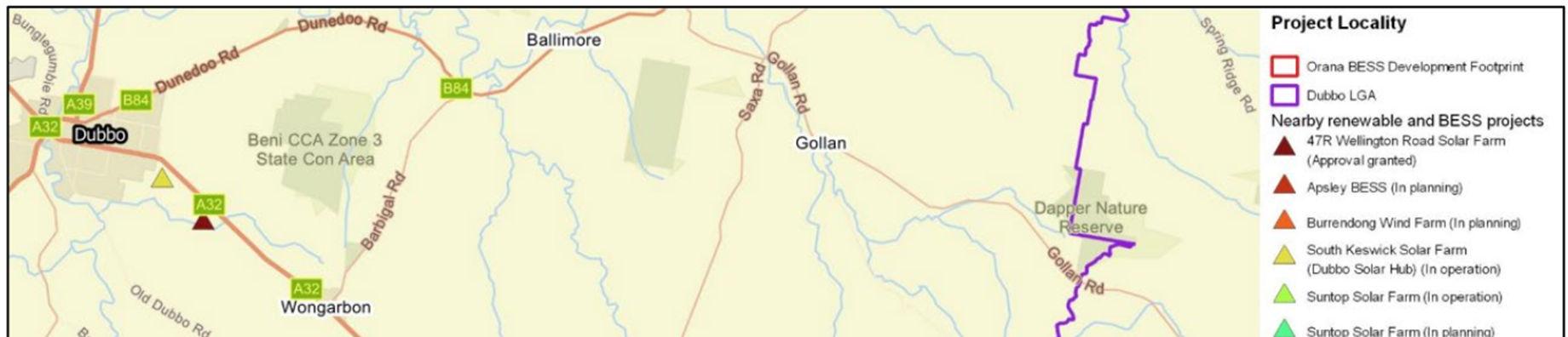

B11 The Applicant must not clear any native vegetation or fauna habitat located outside the approved disturbance areas described in the EIS.
DPHI letter to Akaysha dated 8/10/2024 re: Orana BESS – Traffic Management Plan Staging
Orana BESS Traffic Management Plan, 10/04/22025 prepared by CPP
Stage 2a Traffic Management Plan Rev C 7/03/25 by Amber
Letter 13/03/25 DPHI-Akaysha re: Approval of TMP Stage 2a
Stage 2b Traffic Management Plan Rev A 17/04/25 by Amber
Letter 14/05/25 DPHI-Akaysha re: Approval of TP Stage 2b
Email 4/06/25 CPPA to Conpower re: induction snapshot to encourage carpooling
nearby residents, TfNSW, and Dubbo Regional Council. For details of consultation refer to IA1.
During the audit period, DPHI approved the request to stage the TMP provisions in correspondence 10/03/25. It required that updates to the TMP are made prior to the commencement of each stage. A Stage 2a TMP (7/03/25) was prepared by Amber, which was approved by DPHI on 13/03/25. A Stage 2b TMP (17/04/25) was prepared by Amber, which was approved by DPHI on 14/05/25. TMP stage 2 The CPP’s TMP was updated in TMP dated 01/04/25.
The audit site inspection and review of project records indicated that the auditee has implemented the TMPs during the audit period. The traffic movement register for April and May 2025 showed that light and project heavy vehicle movements were within the limits in Condition B1 and those approved by the Department in correspondence dated 16 April 2025 (traffic movement limits are documented in the TMPs) Stage 2b traffic movements, which includes OSOM deliveries, commenced after DPHI approval of the Stage 2b TMP. The site is provided with sufficient parking for all vehicles, with no parking on the public road network observed during the site visit or otherwise recorded during the audit period Speed limits are applied in internal roads, with signage provided for 10km/h and 25km/h speed limits depending on the site road (refer to photos in Appendix E). Shuttle buses. Four x 14 seater shuttle buses are reportedly operating on site. The use of shuttle buses is documented in the TMPs Approved travel routes are documented in the TMPs and are implemented through inductions and notifications to truck companies and employees. The auditee implements a Driver’s code of conduct which addresses, amongst other items, drivers fatigue, traffic routes and safe driving practices.
The TMPs provide the school bus routes and public transport details and measures to avoid conflict

Site inspection 4/06/2025
Orana BESS Habitat Tree and Pre-Clearance Report June 2024 V2.0 21/06/2024 by NGH
Letter 12/09/2024 NGH-Akaysha re: Orana BESS HBT removal and Ecologist supervision
Report: Pre-clearing checks for fauna and flora (48 hours prior) prepared by NGH (12,17, 18, 19, 20, 21, 23, 24, 25 September 2024) for Stage 1
No clearing activities occurred during the current audit period. Trees remaining on site are protected with fencing and no-go flagging. Site footprint fenced off. Refer to photos in Appendix E.
For details of clearing refer to IA1. During the previous audit period, pre-clearance surveys were undertaken by ecologist specialists NGH on two occasions. These were documented in Orana BESS Habitat Tree and Pre-Clearance Report June 2024 V2.0 21/06/2024 by NGH and Letter 12/09/2024 NGH-Akaysha re: Orana BESS Letter of Advice HBT clearing for Sept 2024 – Stage 1
The first survey was undertaken between the 8 and10 May 2024 by NGH qualified Ecologist to:
Compliant
Report: Pre-clearing check for fauna and flora (48 hours prior) prepared by NGH (21, 22, 23, 25, 26, 27, 28 November 2024) for Stage 2
• confirm previously identified or new, significant fauna habitat features and breeding places within the disturbance footprint and or/animal activity.
• clearly mark all Hollow Bearing Trees (HBTs) planned for removal to prepare for staged clearing.
• clearly mark all trees to be retained, to inform the Project Arborist prior to the installation of tree protection zones (TPZ).
• identify and mark items that may provide animal habitat, such as hollow logs and rock piles, to be retained and moved outside of the project boundary for use by fauna.
• identify current Priority weed infestations.
The second survey was undertaken between the 3 and 7 June 2024 by NGH qualified Ecologist and the Project Arborists. This survey was specifically targeted at the HBTs planned for removal and was conducted via elevated work platform (EWP) to;
• assess if wildlife was present within the hollows and if any wildlife breeding had commenced in hollows.
• confirm if previously recorded (from the ground) tree hollows were suitable for wildlife breeding.
• block any unoccupied hollow entrances deemed suitable habitat, to prevent nesting activities in advance of the Spring breeding season (August through to October) when clearing is planned to take place.
In addition, pre-clearing checks for fauna and flora (49 hours prior) were undertaken by NGH (Veronica Philips, an ecologist from NGH P/L) for Stage 1 and Stage 2 to confirm that all relevant measures have been implemented as required.
The evidence provided indicates that the clearing works had been supervised by ecologists from NGH.
Biodiversity Offsets
B12 Prior to carrying out any development that could directly or indirectly impact the biodiversity values requiring offset, the Applicant must retire biodiversity credits of a number and class specified in Table 1 below. The retirement of these credits must be carried out in accordance with the NSW Biodiversity Offsets Scheme and can be achieved by:
a) acquiring or retiring ‘biodiversity credits’ within the meaning of the Biodiversity Conservation Act 2016;
b) making payments into an offset fund that has been developed by the NSW Government; or
Statement confirming payment into the Biodiversity Conservation Fund for an offset obligation (issued by the Biodiversity Conservation Trust, dated 27/02/2024 (date received) BCT ref: BCF678
Statement confirming payment into the Biodiversity Conservation Fund for an offset obligation (issued by the Biodiversity Conservation Trust, dated 1/11/2024 (date received) BCT ref: BCF794
Charge Quote Q00483 was issued by the BCT to Akaysha on 10 October 2024
Emails from/to BCT to NGH dated 10/10/24, 9/01/25, 10/01/25 and 15/01/25
Letter 14/04/25 NGH-DPHI (Department of Energy, Resource and Industry
Two Statements issued by the Biodiversity Conservation Trust confirming payment were provided as evidence of payment for the biodiversity credit retirement obligations satisfied by payment to the Biodiversity Conservation Fund under BCT reference numbers BCF678, for $191,834.34 (excluding GST), dated 24/02/2024, and BCF794, for $490,479.79 dated 7/11/24(excluding GST) (for details refer to IA1)
During IA1, an Observation was raised as follows. The above payments included all the species and credits listed in the species credit requirement, except for Prasophyllum sp. Wybong. This appeared to be an administrative mistake as BCT had advised the Applicant that it could not accept payment for Species Prasophyllum sp. Wybong as it is not listed under the BC Act. During this audit, the applicant further consulted with BCT who advised that it could instead provide a quote for Prasophyllum sp. Petilum. In response the applicant submitted in January 2025 an application to BCT for the retirement of credits of Prasophyllum Petilum which is listed under the BCT. IA1 did not recommend any further action other than notifying
c) funding a biodiversity conservation action that benefits the entity impacted and is listed in the ancillary rules of the biodiversity offset scheme.
Assessments) re: Orana BESS SSD 45242780 – DPHI Non-Compliance Notification Letter
the Department of the alternative arrangements made for the retirement of credits associated with Prasohyllum sp. in accordance with Condition B12 given that Prasophyllum sp. Wybong is not listed under the BC Act.
During IA2, the auditee reported a non-compliance to DPHI in accordance with C11 as discussed below.
Non-compliance: A Non-Compliance Notification Letter dated (NGH, 14 April 2025) was submitted to the Department, noting that payments made into the Biodiversity Conservation Fund intended to satisfy the obligations under Condition B12 for the retirement of biodiversity credits were completed in error, as they did not include Prasophyllum sp. Wybong. It indicated that the Biodiversity Conservation Trust (BCT) had advised that payments to the Biodiversity Conservation Fund can only be accepted for liabilities under the Biodiversity Conservation Act 2016. Prasophyllum sp. Wybong is only listed under the Commonwealth Environment Protection and Biodiversity Conservation Act 1999 (and not under the Biodiversity Conservation Act 2016) and therefore the BCT cannot accept a payment for this species. The Proponent submitted the Charge Quote Application to the NSW Biodiversity Conservation Trust and retired the credits against the Charge Quote Statement in good faith, believing they were acting in compliance with the conditions of consent. The Proponent will continue to work with the Department and the Commonwealth Department of Climate Change, Energy, the Environment and Water (DCCEEW) to resolve this non-compliance.
DPHI, in letter dated 1/05/25, responded to the above matter indicating that the non-compliance report generally satisfied the reporting requirements of C11. DPHI acknowledged that a resolution of the issue is still underway at the time of the notification and the Proponent is working with DCCEEW to resolve this matter. It also required that withing 2 months of the DPHI letter, a report be submitted to DPHI outlining the consultations with relevant department to resolve and / or achieve compliance with Condition B12.
Further to the above, prior to completing this audit report the Applicant advised that it agreed with DCCEEW and DPHI to prepare and submit a Modification of the SSI to address this non-compliance Akaysha advised that the Modification has been drafted (a copy was provided to the auditor) and that it will request to modify the current offset obligation to replace the Species Credit for requirement Prasophyllum sp. Wybong with an equivalent credit requirement for Prasophyllum sp. Petilum. This would correct an error which has prevented the Applicant from meeting their offset obligation in full. At the time of completing this audit report, the modification was not available in the Major Project website.
No recommendation for this non-compliance required as the Proponent is currently working with the Department and Commonwealth DCCEEW to resolve the non-compliance by means of submitting a modification application to correct the offset obligations under B12. This finding remains open under the Modification application is submitted and then approved by DPHI.
B13 Prior to carrying out any development that could directly or indirectly impact the biodiversity values requiring offset, the Applicant must provide evidence to the Planning Secretary that biodiversity credits have been retired.
Statement confirming payment into the Biodiversity Conservation Fund for an offset obligation (issued by the Biodiversity Conservation Trust, dated 27/02/2024 (date received) BCT ref: BCF678.
Statement confirming payment into the Biodiversity Conservation Fund for an offset obligation (issued by the Biodiversity Conservation Trust, dated 1/11/2024 (date received) BCT ref: BCF794.
Biodiversity Management Plan (BMP) Orana BESS (rev G, dated 8 November 2024) prepared by WSP.
Appendix C of the BMP attaches the evidence of payment of the credits carried out to date. The BMP was submitted to DPHI and DPHI approved the document.
Refer also above in B12 about the administrative non-compliance regarding the retirement of credits for the species Prasophyllum sp. Wybong which is not listed under the BC Act
B14 Prior to commencing construction, the Applicant must prepare a Biodiversity Management Plan for the development in consultation with BCS, and to the satisfaction of the Planning Secretary. This plan must:
a) be prepared in accordance with the revised Biodiversity Development Assessment Report (dated 6 September 2024);
b) include a description of the measures and timeframes that would be implemented for:
i. protecting vegetation and fauna habitat outside the approved disturbance areas;
ii. managing the remnant vegetation and fauna habitat on site;
iii. minimising clearing and avoiding unnecessary disturbance of vegetation that is associated with the construction and operation of the development;
iv. avoiding the removal of hollow-bearing trees during spring to avoid the main breeding period for hollow-dependant fauna;
v. minimising the impacts to fauna on site and implementing fauna management protocols, including design of temporary fencing;
vi. rehabilitating and revegetating temporary disturbance areas with species that are native to the area; maximising the salvage of vegetative and soil resources within the approved disturbance area for beneficial reuse in the enhancement or the rehabilitation of the site; and
vii. controlling weeds, feral pests and pathogens.
c) include a program to monitor and report on the effectiveness of mitigation measures;
d) include an incidental threatened species finds protocol to identify the avoid and/or minimise and/or offset options to be implemented if additional threatened species are discovered on site; and
e) include details of who would be responsible for monitoring, reviewing and implementing the plan.
Following the Planning Secretary’s approval, the Applicant must implement the Biodiversity Management Plan.
Site inspection 4 June 2025.
Biodiversity Management Plan (BMP) Orana BESS (rev G, dated 8 November 2024) prepared by WSP.
DPHI letter to Akaysha dated 20/11/2024, re: Orana BESS – Biodiversity Management Plan
Orana BESS Habitat Tree and Pre Clearance Report June 2024 V2.0 21/06/2024 by NGH
Letter 12/09/2024 NGH-Akaysha re: Orana BESS HBT removal and Ecologist supervision
Report: Pre-clearing check for fauna and flora (48 hours prior) prepared by NGH (12,17, 18, 19, 20, 21, 23, 24, 25 September 2024) for Stage 1
Report: Pre-clearing check for fauna and flora (48 hours prior) prepared by NGH (21, 22, 23, 25, 26, 27, 28 November 2024) for Stage 2
Email DPHI to Akaysha dated 13/09/2024: receival of relevant documentation to support the commencement of HBT removal on 13/09/24 in line with approved BMP
Removal of hollow-bearing tree
Email 26/03/25 DPHI-Akaysha re: Complaint on tree clearing activity in spring
Email 10/04/25 Akaysha-DPHI re: requesting for an extension to submit response relating to Complaint on tree clearing activity in spring (17/04/05)
A Biodiversity Management Plan (BMP) Orana BESS was prepared and then revised with MOD 1 (rev G, dated 8 November 2024) prepared by WSP. The BMP was prepared in consultation with BCS as per evidence provided in the BMP.
DPHI, in correspondence to Akaysha dated 20/11/2024, approved the revised Orana BESS – Biodiversity Management Plan (rev G, dated 8 November 2024) which included the increased footprint from Modification 1 and the inclusion of a Masked Owl Management Plan
No clearing has been reportedly undertaken during the current audit reporting period. All clearing was undertaken during the previous reporting period and is reported in IA1. During site inspection, the implementation of the BMP was observed on site including protection of vegetation retained within the site, boundary fending to protect vegetation outside the disturbance boundary, the presence of nest boxes installed in trees within and adjacent to the site (refer to photos in Appendix E), environmental inspections and environmental induction training. The implementation of the BMP during clearing activities is discussed below and in IA1.
During IA1, the auditor reported that project records indicated that clearing had been undertaken generally in accordance with the consent except for spring clearing as discussed below. The evidence provided indicated that the clearing works had been supervised by ecologists from NGH. Pre-clearance surveys were undertaken by NGH on two occasions, between 8 and 10 May 2024 and between 3 and 7 June 2024, and documented in pre-clearance reports. In addition, multiple pre-clearing checks for fauna and flora (48 hours prior) were undertaken by NGH ecologist to confirm that all relevant measures have been implemented as required.
NGH records indicated that the BMP had been implemented noting that clearing hollow-bearing trees was undertaken during the spring breeding period. This is documented in the approved BMP (Section 5.3.2) despite B14(iv) indicating the opposite. The Department approved the BMP. Section 5.3.2 of the BMP explicitly states: “As vegetation clearing will occur during local breeding and torpor seasons, being June to November inclusive, a written assessment by the Project Ecologist justifying clearing activities (i.e., no impact to
Biodiversity Management Plan
Compliant
Email 10/04/25 DPHI-Akaysha re: approval on the request for extension on the submission of the response.
Email 17/04/255 Akaysha-DPHI re: Submission of the response relating to Complaint on tree clearing activity in spring
Email 30/04/25 DPHI -Akaysha re: response on the submission relating to complaint on tree clearing activity in spring Powerful Owl Nest
Email 11/02/25 NGH-DPHI re: Orana BESS Pre-clearing and Modification #2 –unexpected find of powerful owl nest
Email 12/02/25 DCCEEW-NGH re: Response to Pre-clearing and Modification #2 –unexpected find of powerful owl nest
Email 20/02/25 NGH-DCCEEW re: submission of the required information relating to unexpected find.
Email 25/0/25 NGH-DCCEEW re: submission of photo of nest and correspondence with QLD Museum
Inquiry Details QMN:00861365 from QLD Museum (submission of photos powerful owl nest)
Letter 17/04/25 Akaysha-DPHI re: Orana BESS Project (SSD-45242780) - ComplaintTree Clearing Activities in Spring
breeding or torpor habitat) must be recorded and made available to DPE prior to works.”
The ecologist written statement Letter 12/09/2024 NGH-Akaysha re: Orana BESS HBT removal and Ecologist supervision indicated that hollow-bearing tree removal is to take place during September to October 2024 during the Spring breeding season and describing preclearance surveys and mitigation measures to be implemented. The ecologist written statement 12/09/2024 was submitted to DPHI on 13/09/2024, including notification of commencement of HBT removal on the 13/09/2024.
Further, Appendix B of the BMP – Hollow-Bearing Tree (HBT) Clearing Protocol, provides for clearing between June and January. The BMP further stipulates: "Should clearing of hollow-bearing trees be required during the breeding or hibernation periods of threatened species, consultation is to be undertaken with local wildlife carers and/or specialist carers for those faunal groups. Confirmation is to be sought from these groups that they would accept rescued fauna." In accordance with this provision, Akaysha engaged in the required consultations with local wildlife carers, and confirmation has been obtained regarding their acceptance of any rescued fauna. Consultation records were sighted.
IA1 reported a non-compliance as follows: There is no evidence that the removal of hollow-bearing trees during spring was avoided in accordance with B14(iv) to avoid the main breeding period for hollowdependent fauna. It is however noted that the approved BMP anticipated vegetation clearing during the local breeding season being June to November and included measures to mitigate impacts associated with it, including a Hollow-Bearing Tree (HBT) Clearing Protocol. Section 5.3.2 of the BMP explicitly states: “As vegetation clearing will occur during local breeding and torpor seasons, being June to November inclusive, a written assessment by the Project Ecologist justifying clearing activities (i.e., no impact to breeding or torpor habitat) must be recorded and made available to DPE prior to works.” An ecologist written statement dated 12/09/2024 was prepared and was submitted to DPHI on 13/09/2024, including notification of commencement of HBT removal on the 13/09/2024. Project records suggest that mitigation measures were implemented in accordance with the BMP.
With regard to the above the auditor reported in IA1 that the Applicant has complied with the approved BMP, but it reported it as a technical non-compliance against Condition B14(iv) with no further action required. The auditor assumed that the Department was aware of the proposed timing of clearing and was satisfied with the mitigation proposed.
IA2 update:

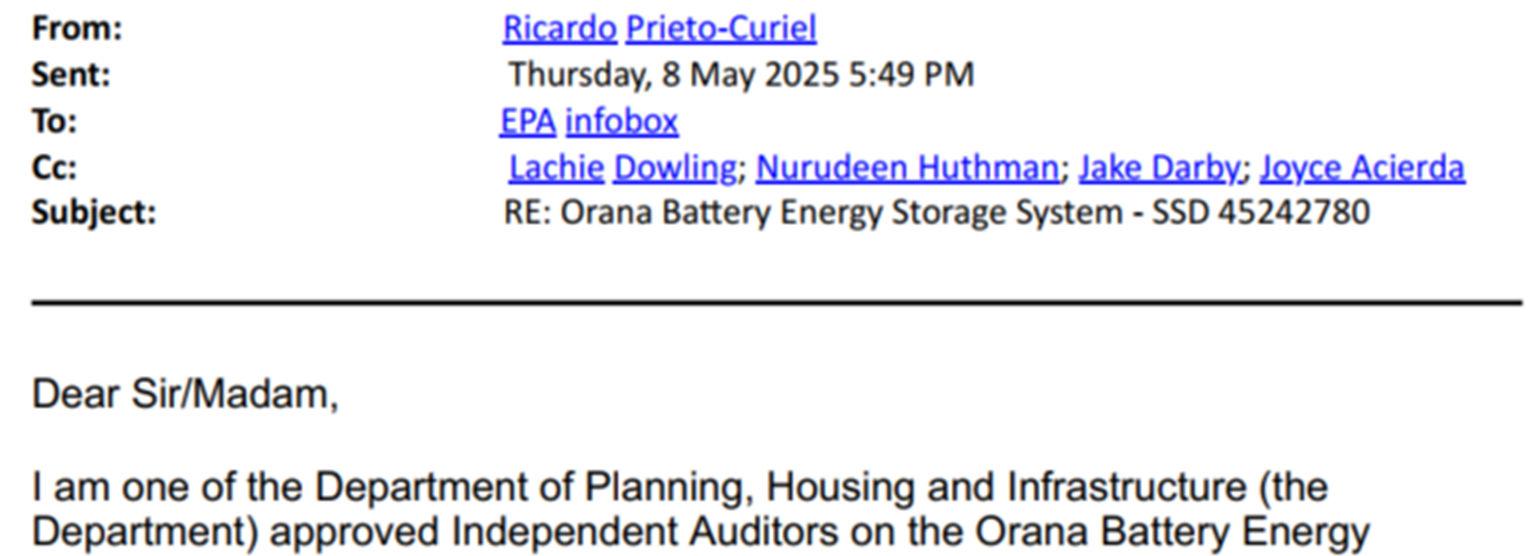

Unexpected Powerful Owl Nest
In accordance with the BMP, on 11/02/25, NGH advised DCCEEW’s CPHR of an unexpected find of a powerful owl nest during the initial clearing phase in spring. An ecologist came across an inactive nest, which was later verified to be a powerful owl nest. On 12/02/25,
DCCEEW responded, requested to information and recommended to implement:
Immediately ceases associated construction workscontinued operation may constitute knowingly impacting a threated species or its habitat which would effectively be a breach of the Biodiversity Conservation Act 2016
Immediately contact the decision maker notifying them on the unexpected occurrence and to commence discussion next steps
Adhere to Section 5.5 (incidental threatened species)n in the Orana BESS BMP.
DCCEEW noted that, in consideration of the powerful owl nest, the TBDC provides guidance on how to prepare a species polygon for the powerful owl.
On 20/02/25, NGH responded and submitted information related to the unexpected find, confirming that the TBDC guidelines had been followed and a species polygon for the powerful owl had been prepared.
DCCEEW acknowledged the submission on 24/02/25 and, on 25/02/25, requested photographs of the nest along with confirmation information from the Queensland Museum. NGH responded on the same day and submitted the requested information. On the 25/02/25 provided DCCEEW with photos of the nest and correspondence with QLD Museum.
DCCEEW reported the issue to the Department as discussed below.
Removal of hollow-bearing tree / spring clearing
The Department notified the auditee on 26/03/25 of a complaint received on the 12/03/25 regarding spring clearing and requested the provision of information and records in relation to a complaint received on 12/03/25, which raised concerns about the removal of hollowbearing tree 21B on 21/09/24
The auditees submitted their response with the corresponding records on 17/04/25.
DPHI provided a response on 30/04/25, noting that they had reviewed the information and records submitted, and it required no further information and had closed out the complaint
No actions for biodiversity management reportedly required under the BMP (during audit period). No unexpected finds during audit period (the unexpected find reported above was associated with the spring clearing reported in the previous audit period in IA1). (No documentation prepared during the audit period related to the BMP
B15 Road upgrades, construction, commissioning, demolition, upgrading or decommissioning activities (excluding blasting) may only be undertaken between:
a) 7 am to 6 pm Monday to Friday;
b) 8 am to 1 pm Saturdays; and
c) at no time on Sundays and NSW public holidays; unless the Planning Secretary agrees otherwise.
B16 The following activities may be carried outside the hours specified in condition B15 above:
a) commissioning activities that are inaudible at non-associated residences
b) the delivery or dispatch of materials as requested by the NSW Police Force or other public authorities for safety reasons; or
c) emergency work to avoid the loss of life, property or prevent material harm to the environment.
B17 The hours of construction activities specified in condition B15 of this approval may be varied with the prior written approval of the Planning Secretary. Any request to alter the hours of construction must be:
Site inspection and interviews on 4/06/2025
DPHI letter to Akaysha dated 20/11/2024, re: Orana BESS – Stage 1 Road Upgrade – Out of Hours Works
Email 30/09/2024 Akaysha-TfNSW re: Request to amend construction hours
Email 22/11/2024 TfNSW-Akaysha re: Response to request to amend construction hours
Email 26/06/2024 Akaysha-DRC (Dubbo Regional Council) re: Orana BESS queries
Email 26/09/2024 Akaysha-DRC re: Orana BESS queries / increasing works hours on Saturdays
Email 09/10/2024 DRC-Akaysha re: response / increasing works hours on Saturdays
Email 9/09/2024 Akaysha-Palmers Farm re: Road works – Goolma Road on Saturday hours (consultation)
Email 10/09/2024 Palmers Farm- Akaysha re: response to consultation
Letter 28/04/25 Akaysha-DPHI re: Request to vary construction hours
Letter 13/05/25 TfNSW-Akaysha re: Review of Out of Hours request for Orana BESS SSD-45242780
Letter 20/05/25 DPHI-Akaysha re: Out of Hours Approval
In correspondence dated 20/11/2024 DPHI approved a request from Akaysha (dated 30/10/24) to extend work hours on Saturdays from 1pm to 5pm until the 28 February 2025 associated with Stage 1 the construction of the road upgrades at Goolma Road. The agreement was conditional to TfNSW also providing written agreement to the extended hours.
Akaysha consulted with TfNSW on 30/09/2024 regarding amendments to construction hours for the Orana BESS project. On 22/11/2024, TfNSW responded, noting no objection to the proposed increase in working hours on Saturdays.
Akaysha consulted with Dubbo Regional Council (DRC) on 26/06/2024 regarding project parking, shuttle bus locations, and roadworks. Additionally, on 26/09/2024, Akaysha consulted DRC about increasing work hours on Saturdays. On 09/10/2024, DRC responded, agreeing to the extended Saturday work hours, noting that this would enhance productivity, reduce traffic interruptions, and ultimately minimize the impact on residents and the community.
Akaysha sent a consultation to Carl Palmer (Palmers Farm) on 09/09/2024 regarding Saturday work hours for the roadworks on Goolma Road. On 10/09/2024, Palmer responded with no objections.
On 28/04/25, the auditees submitted a request to the Department to vary the construction hours, with consultation undertaken with TfNSW on 8/05/25.
On 13/05/25, TfNSW provided a response to Akaysha’s request regarding OOHW during construction, noting that no further information is required by TfNSW, provided the OOHW is limited to 1:00 pm to 5:00 pm on Saturdays and 8:00 am to 5:00 pm on Sundays, and that traffic volumes align with the conditions of consent.
On 20/05/25, the Department approved the request for OOHW on Saturdays (1:00 pm to 5:00 pm) and Sundays (8:00 am to 5:00 pm) until 30/11/25.
Construction hours are provided in the CEMP and are communicated to personnel in induction training material
No complaints regarding construction hours have been recorded during the reporting period.
Site inspection and interviews on 4/06/2025 In correspondence dated 20/11/2024 DPHI approved a request from Akaysha (dated 30/10/24) to extend work hours on Saturdays from 1pm to 5pm until the 28 February 2025 associated with Stage 1 the
Compliant
Exceptions to Construction Hours
Variation of Construction Hours
a) considered on a case-by-case or activity-specific basis;
b) accompanied by details of the nature and justification for activities to be conducted during the varied construction hours;
c) accompanied by written evidence that appropriate consultation with potentially affected sensitive receivers and notification of Councils (and other relevant agencies) has been or will be undertaken;
d) accompanied by evidence that all feasible and reasonable noise mitigation measures have been put in place; and
e) accompanied by a noise impact assessment consistent with the requirements of the Interim Construction Noise Guideline (DECC, 2009), or latest version.
DPHI letter to Akaysha dated 20/11/2024, re: Orana BESS – Stage 1 Road Upgrade – Out of Hours Works
Email 30/09/2024 Akaysha-TfNSW re: Request to amend construction hours
Emails Akaysha-residents (several MarchApril 2025) with consultation on extended hours
Letter 28/04/25 Akaysha-DPHI re: Request to vary construction hours
TfNSW letter 13/05/25 Review of Out of Hours Request for Orana BESS SSD45242780
Letter 13/05/25 TfNSW-Akaysha re: Review of Out of Hours request for Orana BESS SSD-45242780
Letter 20/05/25 DPHI-Akaysha re: Out of Hours Approval
construction of the road upgrades at Goolma Road. The agreement was conditional to TfNSW also providing written agreement to the extended hours (for other details refer to IA1)
On 28/04/25, the auditees submitted a request to the Department to vary the construction hours, with consultation undertaken with TfNSW on 8/05/25.
On 13/05/25, TfNSW provided a response to Akaysha’s request regarding OOHW during construction, noting that no further information is required by TfNSW, provided the OOHW is limited to 1:00 pm to 5:00 pm on Saturdays and 8:00 am to 5:00 pm on Sundays, and that traffic volumes align with the conditions of consent.
On 20/05/25, the Department approved the request for OOHW on Saturdays (1:00 pm to 5:00 pm) and Sundays (8:00 am to 5:00 pm) until 30/11/25. DPHI required that the approval be made publicly available at the earliest convenience. The approval letter is publicly available in the project website
Noise

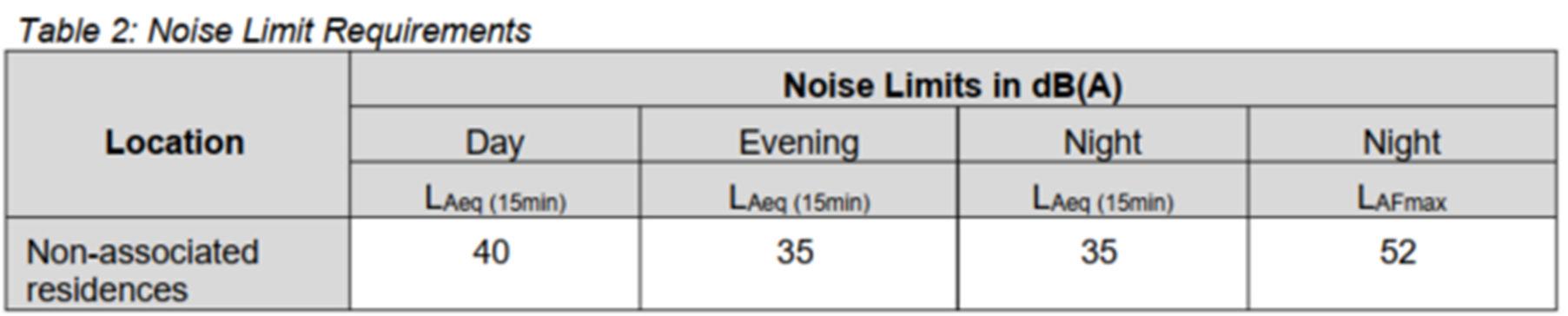

B18 The Applicant must:
a) minimise the noise generated by any construction, upgrading or decommissioning activities on site in accordance with best practice requirements outlined in the Interim Construction Noise Guideline (DECC, 2009) or its latest version; and
b) take all reasonable and feasible steps to minimise operational noise and ensure that the noise generated by the operation of the development does not exceed the noise limits in Table 2 below to be determined in accordance with the procedures in the NSW Noise Policy for Industry (EPA, 2017) at any non-associated residences unless the Planning Secretary agrees otherwise.
Construction & Operational Noise & Vibration Assessment Rev 6, 31/03/2023 prepared by Renzo Tonin & Asso.
Environmental Noise Assessment V02 April 25 by Enviro Science Solutions
The Construction & Operational Noise & Vibration Assessment (CONVA)) (Rev 6), dated 31/03/2023 and prepared by Renzo Tonin & Associates, noted that noise emissions from the construction phase of the project are predicted to exceed the nominated criteria at one (1) of the nearest receiver locations when the three (3) loudest items of plant and equipment operate concurrently and at the closest proximity to the receiver. In-principle recommendations are provided in Section 4.4 to limit the potential impact of construction noise to acceptable levels.
The assessment determined that the large distance between the site and the nearest affected receivers makes structural damage from construction vibration negligible, with a very low risk of complaints from residents. Additionally, road traffic noise during construction complies with relevant criteria, and operational traffic noise impacts are considered negligible due to minimal traffic movements.
Noise monitoring is required under the Environmental Management Strategy “as relevant to the plant and equipment on site and in response to noise complaints”. Noise monitoring was undertaken at the site during the audit period as discussed below
EnviroScience Solutions undertook unattended environmental noise monitoring at 3 locations around the site for a period of a week from Monday 17/03/25 to Sunday 30/03/25 Two monitoring stations showed exceedances for the night time when no works were taking place. The third station showed some exceedances for the day time and evening periods on two days, however other measures were generally below the criteria. The assessment recommended that attended monitoring utilising 15-minute spot measurements during the Day, Evening, and Night periods at sensitive receiver locations would be beneficial to the project. This would allow for observations to
Compliant
B19 Unless the Planning Secretary agrees otherwise, within 3 months of the commencement of operation, the Applicant must prepare and submit a Noise Monitoring Report for the development to the satisfaction of the Planning Secretary. The Noise Monitoring Report must:
a) be prepared by a suitably qualified, experienced and independent acoustic consultant;
b) demonstrate that noise monitoring:
i. has been carried out in accordance with the procedures in the Noise Policy for Industry (EPA, 2017); and
ii. includes monitoring during the day, evening and night periods during operational, temperature and meteorological conditions that would represent typical worst-case scenarios where reasonable and feasible; and
c) include:
i. 1/3 octave data and calculated sound power levels along with a discussion of any excessive annoying characteristics and directionality;
ii. an analysis of compliance with the noise limits specified in condition B18 at R1;
iii. an outline of implemented at-source and transmission pathway mitigation measures and their effectiveness at reducing operational noise; and
iv. a description of contingency measures in the event implemented mitigation measures are not effective at reducing noise levels to comply with limits specified in condition B18 at R1 at all times.
The Applicant must undertake further noise monitoring of the development if required by the Planning Secretary.
B20 The Applicant must minimise the dust generated by the development.
B21 The Applicant must:
a) minimise the off-site visual impacts of the development, including the potential for any glare or reflection;
Site inspection and interviews 4/06/2025
Email 13/12/2024 Akaysha-CPPA re: Site Water Carts
Email 13/12/2024 CPPA-Akaysha re: response to Site Water Carts query
Record of dust on-site security team and weather forecast monitoring during the Christmas break
determine the sources of elevated noise levels during these periods (e.g. traffic, wildlife, construction activities, or vegetation movement).
No noise complaints received during the reporting period
Site inspection 4/06/2025
At the time of the audit site inspection the site was observed mostly cleared of vegetation and bare soils exposed. During inspection, it was noted that water carts were on site. It was reported that there are 3 water carts permanently on site, available on a full-time basis to suppress dust. No dust was observed during the site inspection.
Dust generation is managed on site using water carts, speed limits and visual inspections. The Applicant provided evidence of visual monitoring conducted / recorded by 24/7 on-site security team and weather forecast monitoring.
Alll dust water sourced from the approved bore and sediment basins
This is primarily an operational condition. No advertising signs or logos observed during the site inspection. Compliant
Interview with auditees 4/06/2025 The project is in the construction phase, this condition will be addressed during operation phase. Not triggered
Dust
Compliant
Visual
b) ensure the visual appearance of all ancillary infrastructure (including paint colours) blends in as far as possible with the surrounding landscape; and
c) not mount any advertising signs or logos on site, except where this is required for identification or safety purposes.
Lighting
B22 The Applicant must:
a) minimise the off-site lighting impacts of the development; and
b) ensure that any external lighting associated with the development:
i. is installed as low intensity lighting (except where required for safety or emergency purposes);
ii. does not shine above the horizontal; and
iii. complies with Australian/New Zealand Standard AS/NZS 4282:2019 – Control of Obtrusive Effects of Outdoor Lighting, or its latest version.
Protection of Heritage Items
B23 The Applicant must ensure the development does not cause any direct or indirect impacts on Aboriginal heritage items located outside the approved development footprint.
Site inspection and interviews 4/06/2025
Site inspection and interviews 4/06/2025
There are no lights reportedly at night at the site during construction, except for the site compound which has low intensity lighting for security and safety reasons. No complaints or issues reported to date regarding lighting impacts
Chance Finds Protocol
B24 Prior to the commencement of road upgrade works, the Applicant must prepare a Chance Finds Protocol for the development in consultation with Aboriginal Stakeholders, and to the satisfaction of Heritage NSW. Following approval, the Applicant must implement the Chance Finds Protocol.
Akaysha Chance Finds Protocol, Version 3 dated 12 July 2024, prepared by Virtus Heritage
Letter 19/070/2024 DPHI-Akaysha re: Akaysha Chance Finds Protocol
Consultation Log and Correspondence on Heritage (Stage 1.1) by Akaysha
Email 18/08/2022 Heritage NSW-Akaysha re: response to consultation
No unexpected heritage findings have been reported to date. The construction footprint is fenced, and construction works are contained within the site. An exclusion zone (including fencing) has been installed around the culturally modified tree (refer to Photos in Appendix E).
A Chance Finds Protocol, Version 3 dated 12 July 2024, was prepared by Virtus Heritage for Akaysha.
The Department, in correspondence dated 19/07/2024 to Akaysha, noted that no further comments on the Chage Finds Protocol (V3) at this time and instructed that the documents be made publicly available on the project website at the earliest convenience.
The document is available on the project website:
https://hdp-au-prod-app-akaysha-energy-files.s3.apsoutheast2.amazonaws.com/5317/2428/7327/Orana_BESS_Chance_Finds_Protocol1.pdf
Consultation Log and Correspondence prepared by Akaysha provide details of consultations undertaken with Heritage NSW and other relevant stakeholders. The log includes the name or group of the stakeholder, the date the consultation was sent, the date a response was received, and details of the response.
An email dated 18/08/2022 from Heritage NSW to Akaysha provided a list of possible stakeholders within the Dubbo Regional LGA to contact.
No changes since last audit
Water Supply
B25 The Applicant must ensure that it has sufficient water for all stages of the development, and if necessary, adjust the scale of the development to match its available water supply.
Note: Under the Water Act 1912 and/or the Water Management Act 2000, the Applicant is required to obtain the necessary water licences for the development.
Water Pollution
B26 The Applicant must ensure that the development does not cause any water pollution, as defined under Section 120 of the POEO Act.
Site inspection and interviews 4/06/2025
Certificate of Title Box IW (AI877499) Water Management Act 2000
Certificate of Title Water Management Act WAL35136 Date of issue 1/9/2021
Site inspection and interviews 4/06/2025
Erosion and Sediment Control Plan Rev 1, 30/05/2025 by Consolidated Power (Hatch)
Water for dust suppression is used from the sediment basin and from a registered bore on site (groundwater).
The licence for the groundwater bore was provided during the audit
No changes to water supply management reported since last audit.
Sediment controls are in place in accordance with the Project’s Erosion and Sediment Control Plan. It includes 4 sediment basins for 4 different site sub-catchments The sediment basins were inspected during the audit site inspection (refer to photos in Appendix E). The 4 basins were observed in good condition and evidence of off-site water pollution could be noted.
Erosion and Sediment Control Plans were updated on 30/05/2025 by Consolidated Power to reflect the current works on site.
Operating Conditions
B27 The Applicant must:
a) minimise any soil erosion and control sediment generation;
b) ensure the battery storage and ancillary infrastructure and any other land disturbance associated with the construction, upgrading or decommissioning of the development has appropriate drainage and erosion and sediment controls designed, installed and maintained in accordance with the relevant requirements in the Managing Urban Stormwater: Soils and Construction (Landcom, 2004) manual, or its latest version;
c) ensure the battery storage and ancillary infrastructure (including security fencing) are designed, constructed and maintained to reduce impacts on surface water, localised flooding and groundwater at the site; and
d) ensure the battery storage and ancillary infrastructure are designed, constructed and maintained to avoid causing any erosion on site.
Site inspection and interviews 4/06/2025
Erosion & Sediment Control Plan – BESS Yard Rev 0,12/08/2024 and Rev 1, 30/05/2025) prepared by Hatch for CPP, Drawings 12937-CI-DR-00110 and 12937-CIDR-00111
Soil and Water Management Plan - Road Remediation & Safety Improvements Soil & Water Management Plan - Goolma Road Rev 1,12/09/2024 prepared by Harch for CPP Drawings 2937-CI-DR-00370 and 2937-CIDR-00371
Erosion & Sediment Control Plans have been prepared by consulting engineers Hatch for the site and for the Goolma Road works, showing the locations of controls and the types of controls required. As indicated above, it includes 4 sediment basins to which the entire site drain to.
During the audit site inspection sediment controls were observed in place, the 4 sediment basins, sediment fences, bunding and drainage to the basins (refer to photos in Appendix E).
B28 Prior to commencing construction of the battery storage, the Applicant must prepare a Fire Safety Study for the development, to the satisfaction of FRNSW and the Planning Secretary in writing. The study must:
a) be consistent with the Department’s Hazardous Industry Planning Advisory Paper No. 2 ‘Fire Safety Study’ guideline;
b) describe the final design of the battery storage;
c) include reasonable worst-case bush fire scenario to and from the battery storage and the associated bush fire management; and
Fire Hazard and Risk Assessment (FHRA) prepared by NJM Design dated 28 November 2024 (Rev 6)
FRNSW written report application for fire safety study by Akaysha (undated)
FRNSW Clarification Register Based on the Teams meeting held between Akaysha
During IA1 a Fire Hazard and Risk Assessment (FHRA) by NJM Design dated 28 November 2024 (Rev 6) had been prepared in response to condition B28. At the time, the FHRA had been submitted and was under review by FRNSW, as the related documentation was submitted on 29/11/2024. Evidence of consultation on the FHRA with FRNSW dates back to 18 July 2024.
During IA1, the auditor noted that the Fire Safety Study, submitted it to FRNSW in accordance with B28, was yet to be approved by FRNSW and DPHI. The interpretation of the timing of this condition made by
d) identify measures to eliminate the expansion of any fire incident including:
i. adequate fire safety systems and appropriate water supply;
ii. separation and / or compartmentalisation of battery units; and
iii. strategies and incident control measures specific to the battery storage design.
Following approval by the Planning Secretary, the Applicant must implement the measures described in the Fire Safety Study.
Note: ‘to the satisfaction of FRNSW’ above means confirmation in writing from FRNSW that the Study meets the requirements of FRNSW as required by the Department’s Hazardous Industry Planning Advisory Paper No. 2 ‘Fire Safety Study’ guideline.
Energy, NJM and FRNSW on 31/07/2024 prepared by Akaysha
Email 18/07/2024 Akaysha-FRNSW re: Orana BESS - FSS Review with FRNSW Request
Email 1/08/2024 FRNSW-Akaysha re: response to FSS Review with FRNSW Request
Email 29/11/2024 Akaysha-FRNSW re: Submission of documents for Orana BESSFSS Review
Fire Safety Study (FSS) for BESS Rev 7, 14/05/2025 by NJM Design
Email 12/05/25 Akaysha- FRNSW, re: Fire Safety Study
Email 13/05/25 FRNSW-Akaysha, re: Fire Safety Study
the Applicant was that approval is required prior to the installation of the Battery Storage (noting that the timing in other conditions is “prior to construction” and not referring specifically to a project item). The auditor also noted that the condition refer to operational and design requirements. The Applicant advised then that Revision 6 of the Orana BESS FSS was under review from FRNSW & Approval was expected prior to first BESS arrival July 2025. The auditor agreed at the time with the Applicant interpretation and will review compliance with this condition in the next six monthly audit
During the current audit, the Fire Safety Study (FSS) had been revised (rev 7 dated 14/05/2025) and was still pending approval by FRNSW and DPHI. Project correspondence indicates that the FSS is still under review by FRNSW. In email dated 12/05/25, Akaysha requested FRNSW that it supports a request DPHI to stage the FSS under CoA C3 so that FRNSW endorsement of the FSS is required prior to energisation of the project. FRNSW, in email dated 13/05/25 indicated that it supports in-principle the staging of the FSS as long the BESS units are stored in accordance with FRNSW Position Station.
The auditor notes that no batteries have been installed to date.
Fire Safety Study Rev 7 dated 14/05/2025 was prepared by NJM Design and currently under review by FRNSW
Observation: The Fire Safety Study (FSS) required under CoA B28 is yet to be endorsed by FRNSW and approved by the Planning Secretary. The interpretation of the timing of this condition made by the Applicant is that approval is required prior to the installation of the Battery Storage (noting that the timing in other conditions is “prior to construction” and not referring specifically to a project item). The auditor notes that the FSS is an operational related plan and that no batteries have been installed to date. Upon request from Akaysha FRNSW indicated on the 13 June 2025 that it supports in-principle the staging of the FSS to allow FRNSW endorsement of the FSS prior to energisation of the Project as long the BESS units are stored in accordance with FRNSW Position Station.
Recommendation: discuss with the Department and agree on the timing of FRNSW endorsement and Department’s approval of the FSS
Storage and Handling of Dangerous Goods
B29 The Applicant must store and handle all chemicals, fuels and oils used on-site in accordance with:
a) the requirements of all relevant Australian Standards; and
b) the NSW EPA’s Storing and Handling of Liquids: Environmental Protection – Participants Handbook if the chemicals are liquids.
In the event of an inconsistency between the requirements (a) and (b) above, the most stringent requirement must prevail to the extent of the inconsistency.
Operating Conditions
Site inspection 4/06/2025

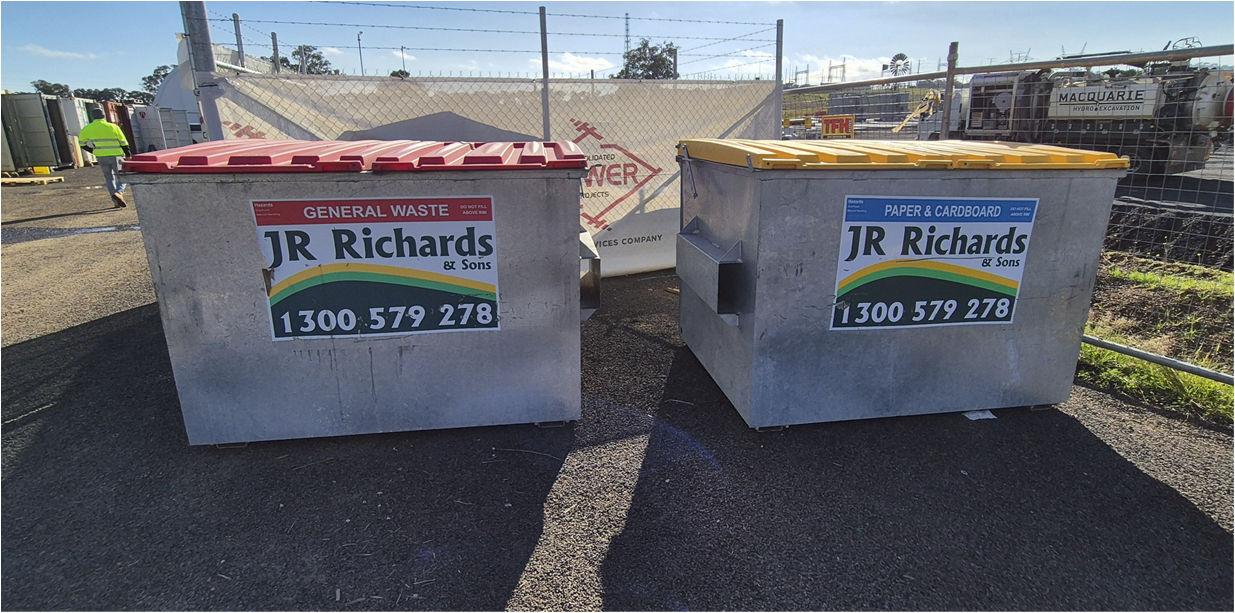

Site photos – Appendix E

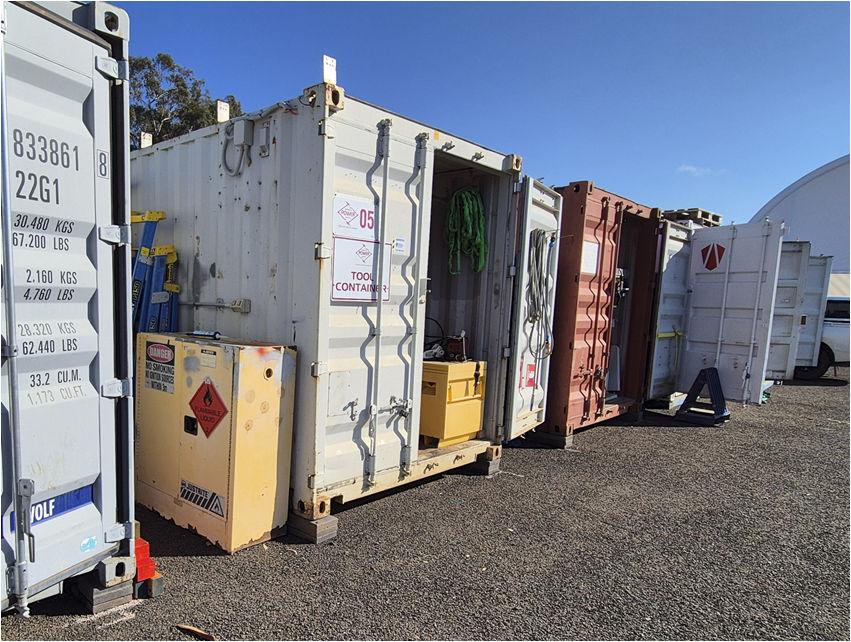

Small volumes of chemicals are stored on site in a bunded storage area (refer to photos in Appendix E).
B30 The Applicant must:
a) minimise the fire risks of the development, including managing vegetation fuel loads on-site;
b) ensure that the development:
i. complies with the relevant asset protection requirements in the RFS’s Planning for Bushfire Protection 2019 (or equivalent) and Standards for Asset Protection Zones; and
ii. is suitably equipped to respond to any fires on site, including provision of a 20,000 litre water supply tank fitted with a 65 mm Storz fitting and a FRNSW compatible suction connection;
c) ensure that the battery storage area:
i. includes a 10 metre defendable space around the perimeter that permits unobstructed vehicle access; and
ii. is managed as an asset protection zone (including the defendable space);
d) assist the RFS and emergency services as much as practicable if there is a fire in the vicinity of the site; and
e) notify the relevant Local Emergency Management Committee following construction of the development, and prior to commencing operations.
Emergency Plan
B31 Prior to commencing commissioning, the Applicant must develop and implement a comprehensive Emergency Plan and detailed emergency procedures for the development, and provide a copy of the plan to the NSW RFS Orana Fire Control Centre and FRNSW. The plan must:
a) be prepared in accordance with the findings of the Fire Safety Study required under condition B28 of Schedule 2;
b) be consistent with the Department’s Hazardous Industry Planning Advisory Paper No. 1, ‘Emergency Planning’ and RFS’s Planning for Bushfire Protection 2019 (or equivalent);
c) include details on how the battery storage and sub-systems can be safely isolated in an emergency;
d) include bushfire emergency management planning, including:
i. details of the location, management and maintenance of the Asset Protection Zone;
ii. a list of works that should not be carried out during a total fire ban;
iii. details of how RFS would be notified, and procedures that would be implemented, in the event that:
there is a fire on-site or in the vicinity of the site;
there are any activities on site that would have the potential to ignite surrounding vegetation; or
there are any proposed activities to be carried out during a bushfire danger period; and
e) include an Emergency Services Information Package in accordance with Emergency services information and tactical fire plan (FRNSW, 2019), to the satisfaction of FRNSW and RFS.
B32 The Applicant must:
a) implement the Emergency Plan and the Emergency Services Information Package for the duration of the development; and
Emergency Management Plan 17/07/2024 by Consolidated Power Projects
The site is under civil construction, which is in its majority clear of vegetation with minor risk of fire Not triggered
This is considered to be an operational related condition. This requirement is not required during this audit period which relates to construction
The Emergency Management Plan, dated 17/07/2024, was prepared by Consolidated Power Projects and establishes an organizational structure and procedures for responding to emergencies while working at or visiting Orana BESS. It assigns roles and responsibilities for implementing the plan during an emergency.
Not triggered
Interview with auditees 4/06/2025
This is considered to be an operational condition. Accordingly it has not been triggered during the audit period.
b) following commencement of commissioning of the battery storage, keep a copy of the Emergency Services Information Package on-site in a prominent position adjacent to the site entry points at all times
B33 The Applicant must:
a) minimise the waste generated by the development;
b) classify all waste generated on site in accordance with the EPA’s Waste Classification Guidelines 2014 (or its latest version);
c) store and handle all waste on site in accordance with its classification;
d) not receive or dispose of any waste on site; and
e) remove all waste from the site as soon as practicable, and ensure it is reused, recycled or sent to an appropriately licensed waste facility for disposal.
Construction Environmental Management Plan (CEMP) 03/12/2024 by Consolidated Power Projects
Notice of Determination – Liquid Waste Discharge to Sewer dated 23/08/2023 issued to Wellington Plant Hire (WPH) – Septage Receival Station valid until 23/080/2028
Delivery Note No. 58, 5/09/2024 re: Septic pump out waste disposal (4kl) by WPH
Delivery Note No. 60, 18/09/2024 re: Septic pump out waste disposal (4kl) by WPH
Delivery Note No. 62, 2/10/2024 re: Septic pump out waste disposal (4kl) by WPH
Delivery Note No. 74, 15/11/2024 re: Septic pump out waste disposal (3kl) by WPH
Delivery Note No. 77, 22/11/2024 re: Septic pump out waste disposal (3kl) by WPH
Orana Waste Register 30/08/2024 to 30/05/2025 by Akaysha
ACCOMMODATION AND EMPLOYMENT STRATEGY
B34 Prior to commencing construction, the Applicant must prepare an Accommodation and Employment Strategy for the development in consultation with Council and Mid-Western Regional Council. This strategy must:
a) propose measures to ensure there is sufficient accommodation for the workforce associated with the development;
b) consider the cumulative impacts associated with other State significant development projects in the area;
c) investigate options for prioritising the employment of local workers for the construction and operation of the development, where feasible; and
d) include a program to monitor and review the effectiveness of the strategy over the life of the development, including regular monitoring and review during construction.
The Applicant must provide a copy of the Accommodation and Employment Strategy to the Planning Secretary prior to commencement of construction, and implement the plan throughout construction.
Orana Battery Energy Storage System Accommodation and Employment Strategy (Rev C, dated 15 July 2024) prepared by Consolidated Power Projects.
DPHI letter to Akaysha Energy dated 23/07/2024, re: Orana BESS –Accommodation and Employment Strategy
Industry briefing article – Orana BESS ICN job fair attracts strong regional interest 30/09/2024
Social Licensing Reporting June to Oct 2024 by Akaysha
Email 1/10/2024 Akaysha-DRC re: Orana BESS Accommodation and Employment Strategy
Email 8/10/2024 DRC-Akaysha re: Response to Orana BESS Accommodation and Employment Strategy

Section 8.3 of the CEMP provides details on waste minimisation and management Plan.
No spoil removed from site to date (cut and fill balanced to date), Testing for waste classification purposes for material stored on site which may need to be removed in the future. Testing done, Waste Classification Report to be prepared. Liquid waste (septic, portaloo) removed during the audit period
Notice of Determination – Liquid Waste Discharge to Sewer, dated 23/08/2023, was issued to Wellington Plant Hire, the service provider responsible for collecting the septic pump-out from the project site for disposal.
Deliver note (no. 58, 60, 62, 65, 66, 69, 71, 72, 74, & 77) were issued by Wellington Plant Hire for the collection of septic pump out waste disposal.
Orana Waste Register from 30/08/2024 to 30/05/2025 prepared by Akaysha was provided that include details load inspected by (prior to disposal), waste type, waste disposal location, and volume.
In correspondence dated 23/07/2024, DPHI approved the Accommodation and Employment Strategy (Rev C, dated 15 July 2024).
An industry briefing session was conducted on 30/09/2024 at Wellington In that regard, the article titled "Orana BESS ICN Job Fair Attracts Strong Regional Interest," indicated that it had 92 registered attendees representing 61 different businesses from the local community. The Job fair is part of efforts to connect regional business with opportunities related to the Orana BESS project.

Consultation records from April to July 2024 provided details on consultation undertaken with the Mid-Western Regional Council and Dubbo Regional Council.
Social Licensing Reporting from June to Oct 2024 was provided indicating that 22.7% achievement before commercial operation.
An email was sent to DRC on 1/10/2024 by Akaysha regarding the Orana BESS Accommodation and Employment Strategy, requesting a meeting with the Council to discuss and report the key metrics. On 8/10/2024, DRC responded, noting they were short-staffed and suggested discussing the report on key metrics in early November. Akaysha replied to DRC and proposed holding the meeting on 11/11/2024. However, no response was received from DRC. A follow-
Compliant
DECOMMISSIONING AND REHABILITATION
B35 Within 18 months of the cessation of operations, unless the Planning Secretary agrees otherwise, the Applicant must rehabilitate the site to comply with the objectives in Table 3 below.
ENVIRONMENTAL MANAGEMENT, REPORTING AND AUDITING
ENVIRONMENTAL MANAGEMENT
Environmental Management Strategy
C1 Prior to commencing construction, the Applicant must prepare an Environmental Management Strategy for the development to the satisfaction of the Planning Secretary. This strategy must:
a) provide the strategic framework for environmental management of the development;
b) identify the statutory approvals that apply to the development;
c) describe the role, responsibility, authority and accountability of all key personnel involved in the environmental management of the development;
d) set out the procedures that would be implemented to:
i. keep the local community and relevant agencies informed about the operation and environmental performance of the development;
ii. receive, handle, respond to, and record complaints;
Email 9/10/2024 Akaysha-DRC re: Orana BESS Accommodation and Employment Strategy
Email 18/11/2024 Akaysha-DRC re: follow-up Orana BESS Accommodation and Employment Strategy
Project Monthly Report May 2025 by CPP
up email was sent by Akaysha to the Council on 28/11/2024 however, DRC made no response.
CPP reports monthly to Akaysha on key targets. The May 2025 project monthly report, prepared by CPP, provides an update of the monitoring for Accommodation & Employment Strategy. The AES forms part of the engagement and onboarding process with subcontractors and employees. It indicates that it undertakes regular site visits to local suppliers.
Observation: Project records indicate that the Applicant has not implemented some of the commitments of the Accommodation and Employment Strategy (AES) during the reporting period There are no records of monthly meetings with Councils, or evidence of attendance to community meetings and liaison with local businesses during the reporting period.
Recommendation: Ensure that the AES is implemented during the entire construction period
Environmental Management Strategy Orana BESS – (rev D dated 30 July 2024) prepared by WSP
DPHI letter to Akaysha Energy dated 31/07/2024, re: Orana BESS – Environmental Management Strategy
Weekly Site Inspection Reports by CPP
08/05/2025
15/05/2025
22/05/2025
31/01/2025
DPHI, in correspondence to Akasha Energy dated 31/07/2024, approved the Orana BESS – Environmental Management Strategy (rev D dated 30 July 2024)
Project records indicate that the applicant has generally implemented the EMS during the reporting period.
Weekly inspections are undertaken in accordance with the Environmental Management Strategy CPP undertakes the regular weekly inspections for the project, covering housekeeping, safety, tools and equipment, environmental aspects, permits to work/SWMS, quality, and mobile plant operations, with a different focus area each week
iii. resolve any disputes that may arise;
iv. respond to any non-compliance;
v. respond to emergencies; and
e) include:
i. references to any strategies, plans and programs approved under the conditions of this consent; and
ii. a clear plan depicting all the monitoring to be carried out in relation to the development, including a table summarising all the monitoring and reporting obligations under the conditions of this consent.
Following the Planning Secretary’s approval, the Applicant must implement the Environmental Management Strategy.
Revision of Strategies, Plans and Programs
C2 The Applicant must:
a) update the strategies, plans or programs required under this consent to the satisfaction of the Planning Secretary prior to carrying out any upgrading or decommissioning activities on site; and
b) review and, if necessary, revise the strategies, plans or programs required under this consent to the satisfaction of the Planning Secretary within 1 month of the:
i. submission of an incident report under condition C10 of Schedule 2;
ii. submission of an audit report under condition C14 of Schedule 2; or
iii. any modification to the conditions of this consent.
Interview with auditees 4/06/2025
Environmental Management Strategy Orana BESS – (rev D dated 30 July 2024) prepared by WSP
Biodiversity Management Plan Orana BESS (rev G, dated 8 November 2024) prepared by WSP
DPHI letter to Akaysha dated 20/11/2024, re: Orana BESS – Biodiversity Management Plan
Stage 2a Traffic Management Plan Rev C 7/02/25 by Amber
Letter 13/03/25 DPHI-Akaysha re: Approval of TMP Stage 2a
Stage 2b Traffic Management Plan Rev A 17/04/25 by Amber
Letter 14/05/25 DPHI-Akaysha re: Approval of TMP Stage 2b
Traffic Management Plan (TMP) Revision D, 21/03/25 by Consolidated Power Projects
Environmental monitoring has been undertaken including vehicle movement (refer to B2), noise monitoring (refer to B18) and dust visual monitoring (refer to B20)
EMS has not been updated during the audit period The applicant advised that an update of the EMS was not required.
The contractor, CPP, has a CEMP prepared for the project under contractual requirements with Akaysha. The CEMP sits under the EMS and is not a document prepared under the Development Consent. The CPP’s CEMP was updated on 20/03/2025.
Staging, Combining and Updating Strategies, Plans or Programs
C3 With the approval of the Planning Secretary, the development may be stages and the Applicant may:
a) prepare and submit any strategy, plan or program required by this consent on a staged basis (if a clear description is provided as to the specific stage and scope of the development to which the strategy, plan or program applies, the relationship of the stage to any future stages and the trigger for updating the strategy, plan or program);
DPHI letter to Akaysha dated 8/10/2024 re: Orana BESS – Traffic Management Plan
Staging
Stage 2a Traffic Management Plan Rev C 7/02/25 by Amber
IA1 indicated that the BMP was revised in response to MOD 1, which amongst other items, included a Masked Owl Management Plan as MOD 1 resulted in Masked Owl needing to be offset. The revised BMP (8 Nov 2024, but initial amended version dated 30/09/2024) was approved by DPHI on the 20/11/2024. Other documents were reportedly reviewed after MOD 1 by the applicant but did not require updating.
During the IA2 period, on 3/03/25, the auditees made a request to stage TMP to the DPHI and the Department approved then request on 10/03/25. TMP Stage 2a was approved by DPHI on 13/03/25, TMP Stage 2b was approved on 14/05/25. The TMP was updated to Revision D, dated 21/03/25, by Consolidated Power Projects to reflect changes to project staging and relevant definitions TMPs were the only documents revised during the audit period Stage 2 Traffic Management Plan (7/02/2025) was revised within a month of the Independent Audit No. 1 (06/02/2025). The auditee advised that other plans required under the Development Consent were reviewed but did not require updating.
No incidents (as defined in the Development Consent) reported during the reporting period.
The project has not been staged, other than the traffic works and Traffic Management Plan.
During IA1, DPHI, in correspondence dated 8/10/24, approved the staging of the Traffic Management Plan (refer also to B10)
Construction Environmental Management Plan Revision F, 20/03/25 by Consolidated Power Projects (CPP)
Compliant
Compliant
b) combine any strategy, plan or program required by this consent (if a clear relationship is demonstrated between the strategies, plans or programs that are proposed to be combined); and
c) update any strategy, plan or program required by this consent (to ensure the strategies, plans and programs required under this consent are updated on a regular basis and incorporate additional measures or amendments to improve the environmental performance of the development).
C4 If the Planning Secretary agrees, a strategy, plan or program may be staged or updated without consultation being undertaken with all parties required to be consulted in the relevant condition in this consent.
Letter 13/03/25 DPHI-Akaysha re: Approval of TMP Stage 2a
Stage 2b Traffic Management Plan Rev A 17/04/25 by Amber
Letter 14/05/25 DPHI-Akaysha re: Approval of TP Stage 2b
C5 If approved by the Planning Secretary, updated strategies, plans or programs supersede the previous versions of them and must be implemented in accordance with the condition that requires the strategy, plan or program. As above
C6 If the Planning Secretary agrees, a strategy, plan or program may be staged without addressing particular requirements of the relevant condition of this consent if those requirements are not applicable to the particular stage.
NOTIFICATIONS
Notification of Department
C7 Prior to commencing the construction, operations, upgrading or decommissioning of the development or the cessation of operations, the Applicant must notify the Department in writing via the Major Projects website portal of the date of commencement, or cessation, of the relevant phase.
If any of these phases of the development are to be staged, then the Applicant must notify the Department in writing prior to commencing the relevant stage, and clearly identify the development that would be carried out during the relevant stage.
Letter 17/06/2024 Akaysha to DPHI re: Request to commence limited construction activities prior to completion of Goolma road upgrades
Letter 19/07/2024 DPHI-Akaysha re: Orana BESS road upgrade and enabling works request
Letter 10/09/2024 Akaysha to DPHI re: Commencement of Goolma Road and Enabling Site Works
Stage 2a Traffic Management Plan Rev C 7/02/25 by Amber
Letter 13/03/25 DPHI-Akaysha re: Approval of TMP Stage 2a
Stage 2b Traffic Management Plan Rev A 17/04/25 by Amber
Letter 14/05/25 DPHI-Akaysha re: Approval of TP Stage 2b
Letter 13/03/2025 Akaysha to DPHI, re: Commencement of Stage 2A construction activities
During the audit period, on 3/03/25 the auditees made a request to further stage TMP to the DPHI and the Department approved then request on 10/03/25.
TMP Stage 2a was approved by DPHI on 13/03/25, TMP Stage 2b was approved on 14/05/25.
The TMP was updated to Revision D, dated 21/03/25, by Consolidated Power Projects to reflect changes to project staging and relevant definitions
DPHI approvals of the staged TMPs (Stage 2a and 2b) issued on 13/03/25 and 14/05/25 respectively.
Refer also to B10 (implementation).
IA1:
Akaysha, in its email dated 17/06/2024, made a request to the Department to commence limited construction activities prior to the completion of Goolma Road upgrades. On 19/07/2024, The Department approved the request.
Akaysha, in correspondence dated 10/09/2024, notified DPHI of the commencement of Goolma Road upgrade road on the 29/08/2024 and the development plans to commence construction in line with the parallel works approval on the 11/09/2024.
IA2: The TMP has been staged as discussed in B10
The notification of commencement of Stage 2a on the 14/03/25 to the Department was provided in letter dated 13/03/25.
Non-compliance: The notification of commencement of construction of Stage 2B works on the 15 May 2025 was submitted on the 10 June 2025, approximately 4 weeks after the date in which construction commenced for Stage 2B This item is closed as the notification was submitted to DPHI and DPHI, in correspondence dated 11 June 2025 reminded the Applicant of the requirement to submit notifications regarding dates of commencement of construction prior to commencing any such works. DPHI also indicated that in this occasion it has determined that no further action is required.
Non-compliant
Letter 10/06/25 Akaysha to DPHI, re: Commencement of Stage 2B construction activities
Letter 11/06/25 DPHI to Akaysha, re: Orana BESS Construction Commencement Stage 2b
Final Layout Plans
C8 Prior to commencing construction, the Applicant must submit detailed plans of the final layout of the development to the Department via the Major Projects website, showing comparison to the approved layout and including details on the siting of battery storage and ancillary infrastructure.
The Applicant must ensure that the development is constructed in accordance with the Final Layout Plans.
Work as Executed Plans
C9 Prior to commencing operations or following the upgrades of any battery storage components or ancillary infrastructure, the Applicant must submit work as executed plans of the development showing comparison to the final layout plans to the Department via the Major Projects website and to Council.
Incident Notification
C10 The Applicant must notify the Department within 24 hours of becoming aware of an incident. The notification must be made via the NSW planning portal (Major Projects) and address details of the incident including:
a) date, time and location;
b) a brief description of what occurred and why it has been classified as an incident;
c) a description of what immediate steps were taken in relation to the incident; and
d) identifying a contact person for further communication regarding the incident.
C10A The Applicant must provide the Department with a subsequent incident report in accordance with Appendix 8 (Incident Notification and Reporting Requirements).
Non-Compliance Notification
C11 Within seven days of becoming aware of a non-compliance, the Applicant must notify the Department of the non-compliance. The notification must be in writing and must be submitted via the NSW planning portal (Major Projects). The notification must identify the development (including the development application number and name), set out the condition of this consent that the
DRW No. 12937-EL-DR-10000 Overall Site Layout Rev A 29/05/2024 by Consolidated Power Projects
DRW No. 12937-EL-DR-10001 Facility Plan Rev B 29/05/2024 by Consolidated Power Projects
DRW No. 12937-EL-DR-11100 General Arrangement Rev A 29/05/2024 by Consolidated Power Projects
Email 9/07/2024 DPHI-Akaysha re: Acknowledgement receipt for the submission of Final Layout Drawings
Interview with Auditees 4/06/2025
Sighted an email from DPHI dated 9/07/2024 acknowledging the submission of the final layout drawings to the Department.
No changes since last audit
Interview with Auditees 4/06/2025
SureWorx records January to May 2025
Refer to B10
The project is in the construction phase, this condition will be addressed during final phase. Not triggered
Interview with Auditees 4/06/2025
Refer to B10

Interview with Auditees 4/06/2025
Letter 1/05/2025 DPHI-Akaysha – Re: Orana BESS Biodiversity Offset Non-compliance
No incidents as defined in the Development Consent were reported under C1 during the audit period.
The auditee maintains incident records in the platform SureWorkx Incidents reported during the audit period included minor safety or environmental events. SureWorkx incidents records were sighted by the auditor.
As discussed in B14, an unexpected find associated with a powerful owl inactive nest was reported to DCCEEW and DPHI during the reporting period. In addition, a complaint was raised regarding a potential non-compliance associated with spring clearing. These two events are discussed in detailed in B14.
Refer to above Not triggered
Non-Compliance Notification Letter dated 14/04/25 was prepared by NGH, noting that payments made into the Biodiversity Conservation Fund intended to satisfy the obligations under Condition B12 for the retirement of biodiversity credits were completed in error, as they did
development is non-compliant with, why it does not comply, the reasons for the noncompliance (if known), and what actions have been undertaken, or will be undertaken, and when, to address the non-compliance.
Note: A non-compliance which has been notified as an incident does not need to also be notified as a noncompliance.
Letter 14/04/25 NGH-DPHI (Department of Energy, Resource and Industry Assessments) re: Orana BESS SSD 45242780 – DPHI Non-Compliance Notification Letter
C12 Deleted Mod-1 SSD 45242780 : Additional construction laydown area and permanent fill batters approved on 26/09/2029 by DPHI
C13 Deleted Mod-1 SSD 45242780 : Additional construction laydown area and permanent fill batters approved on 26/09/2029 by DPHI
INDEPENDENT ENVIRONMENTAL AUDIT

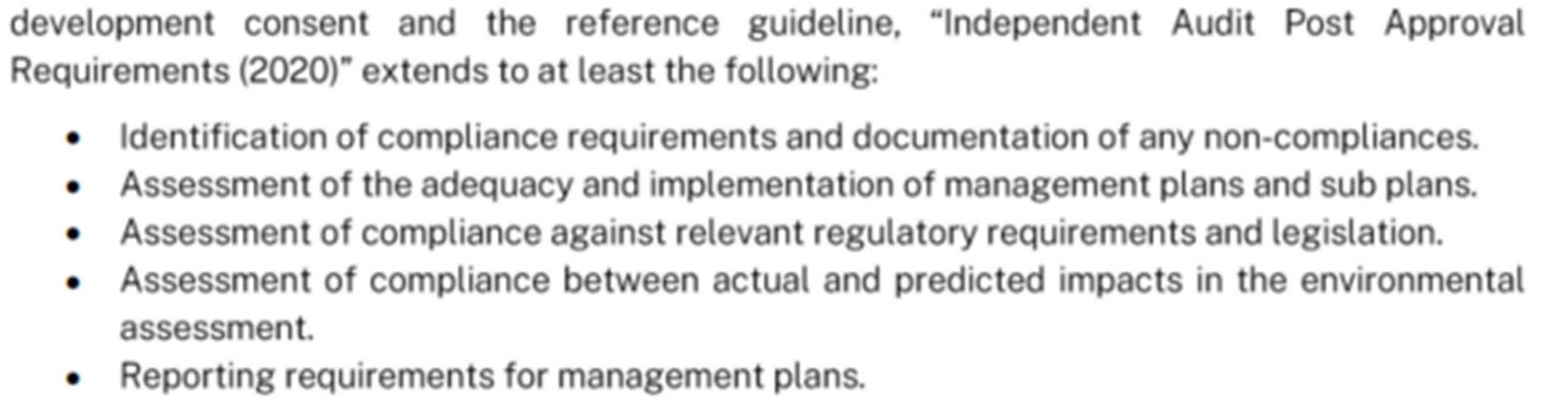

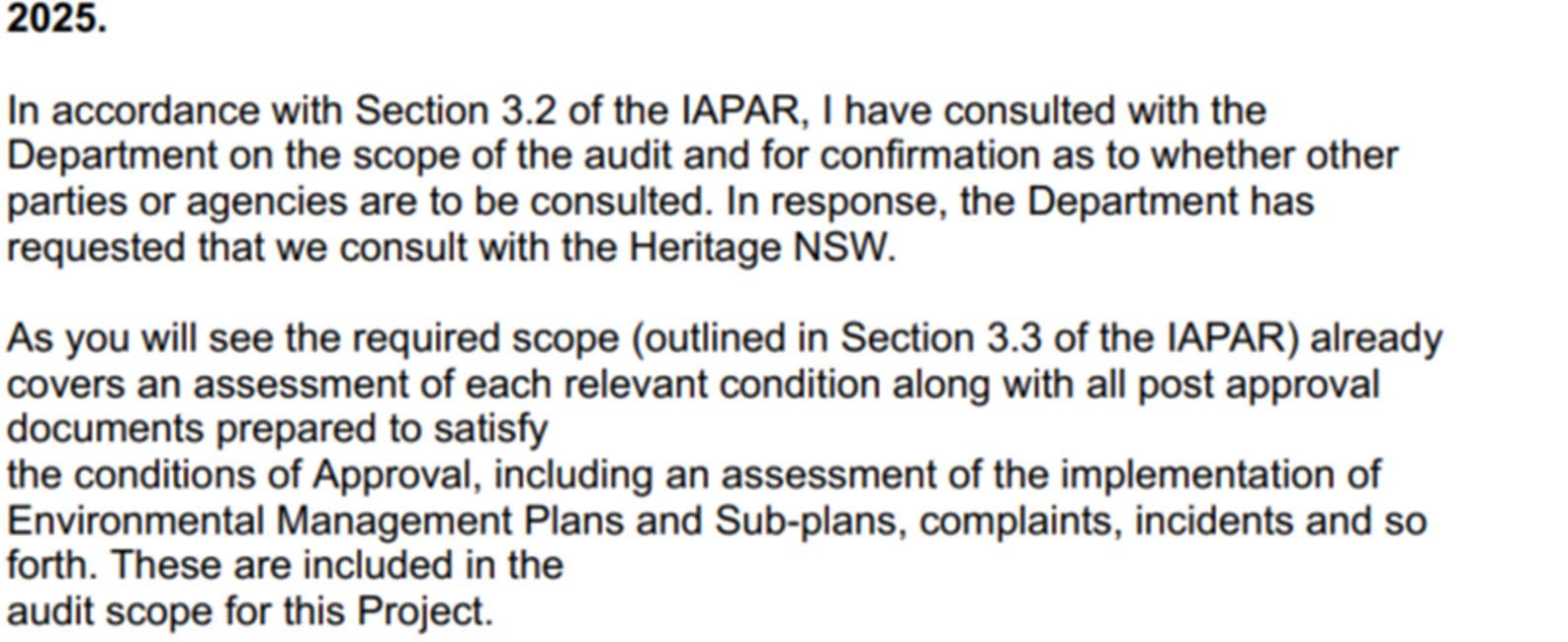

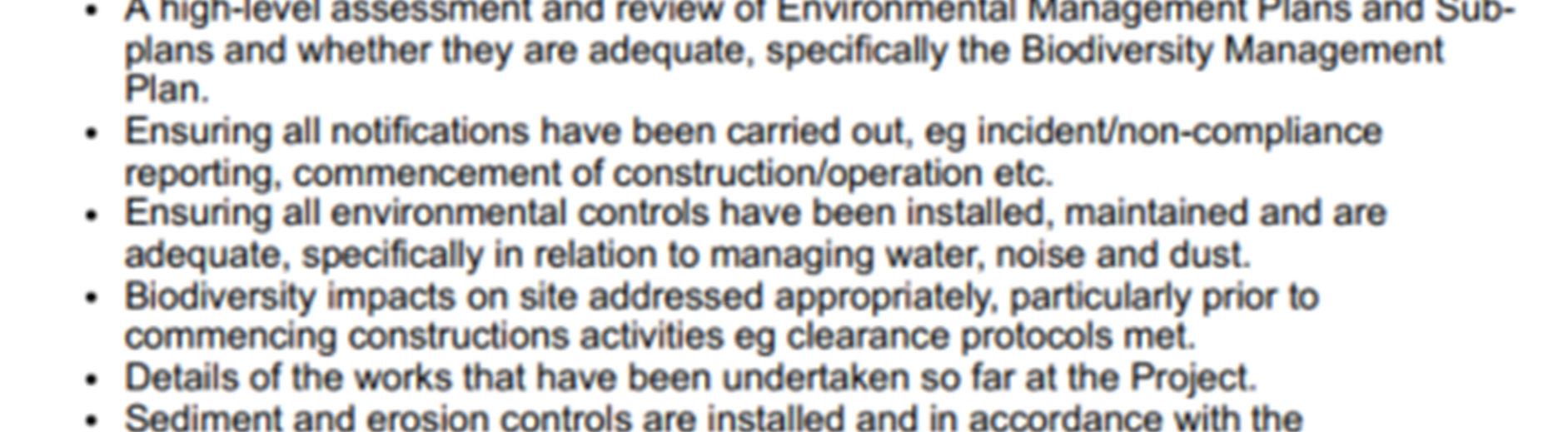

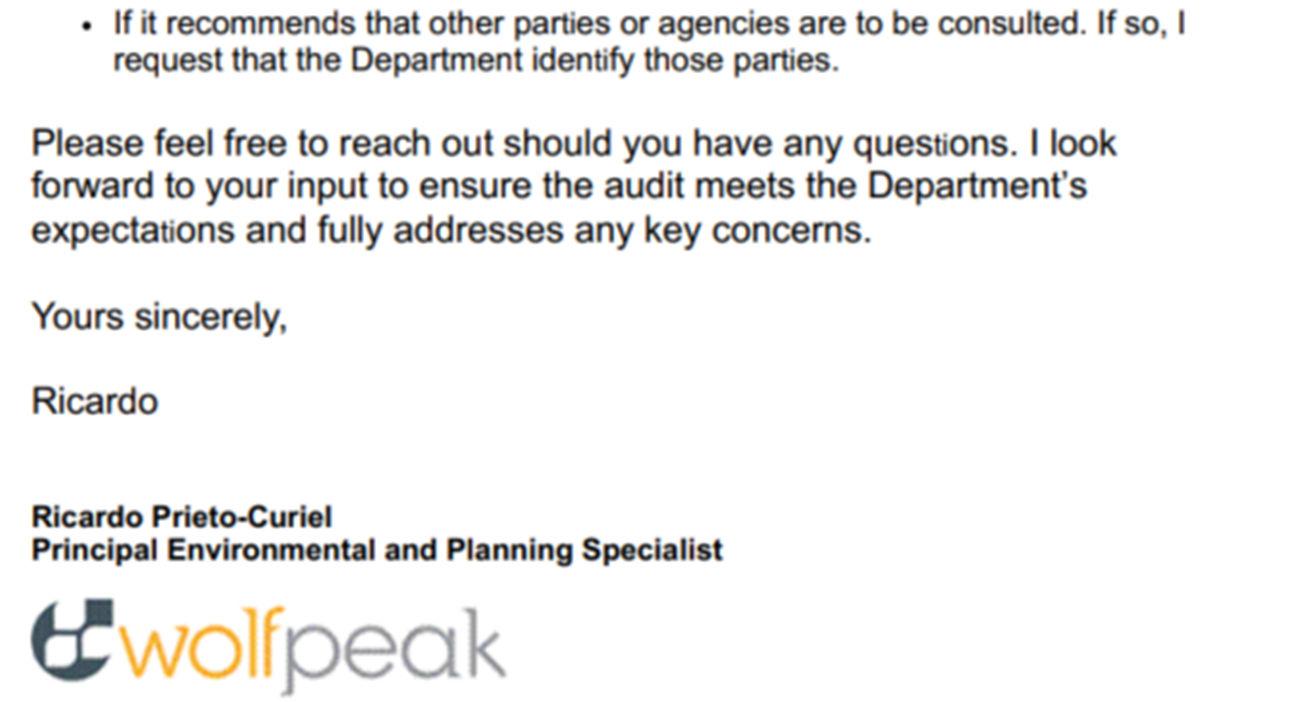

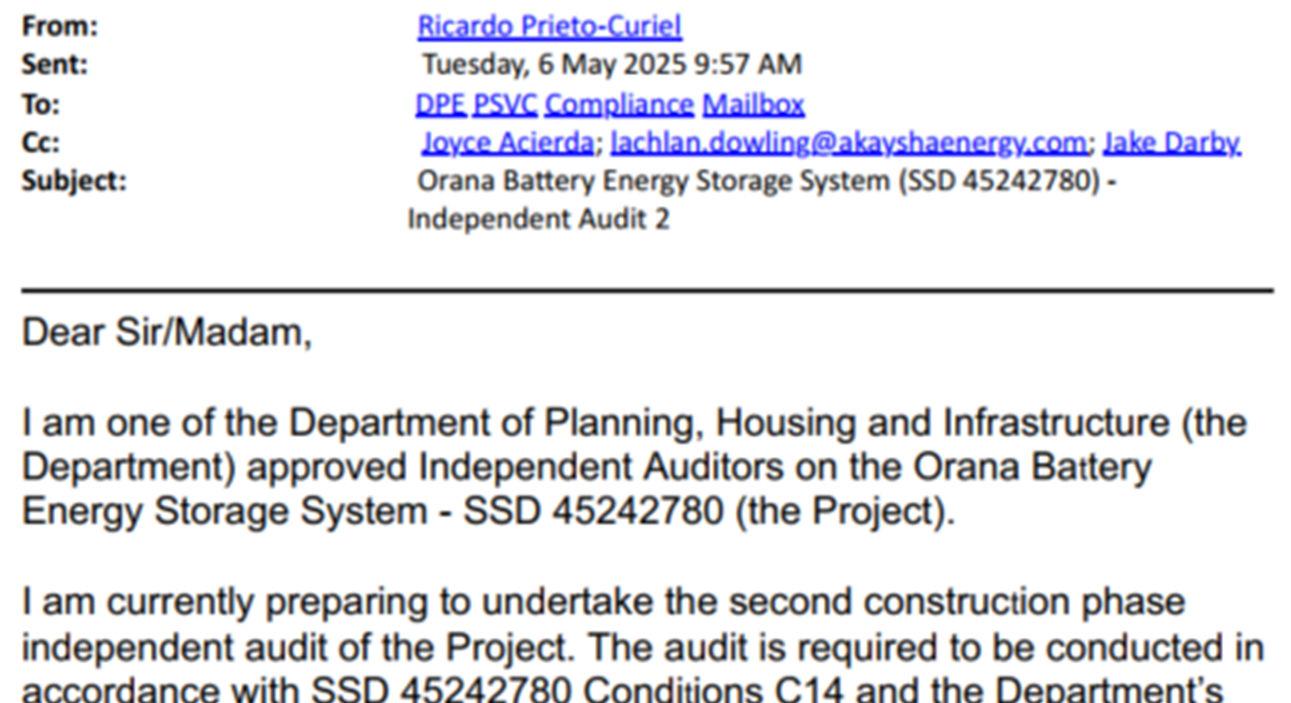

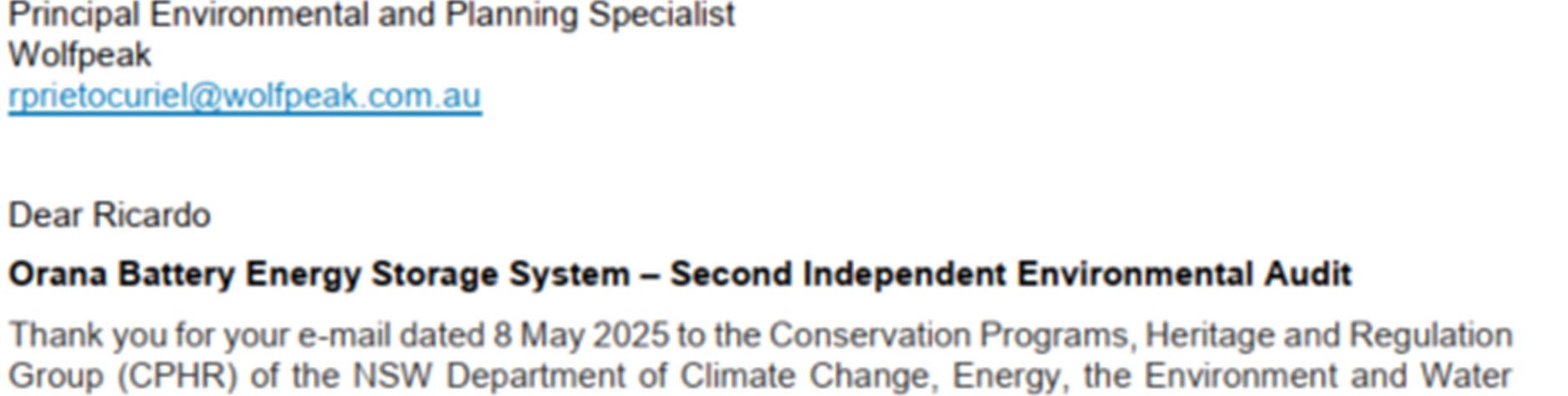

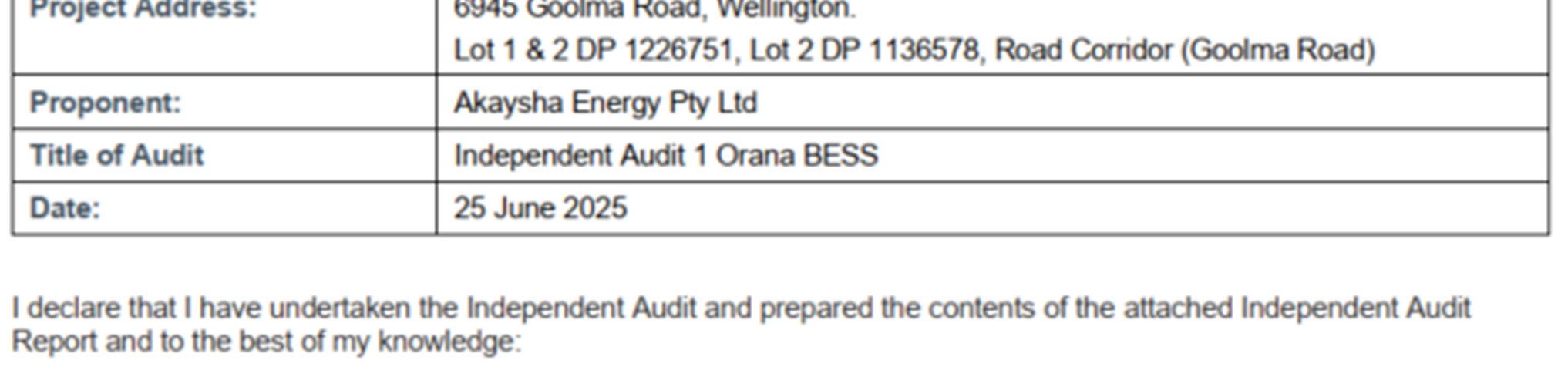

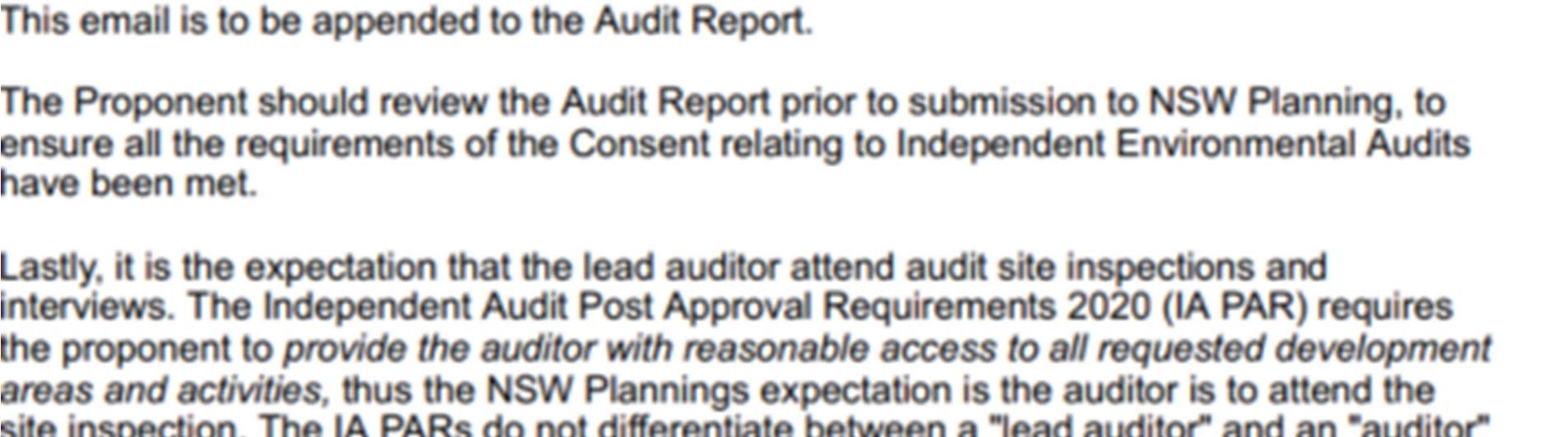

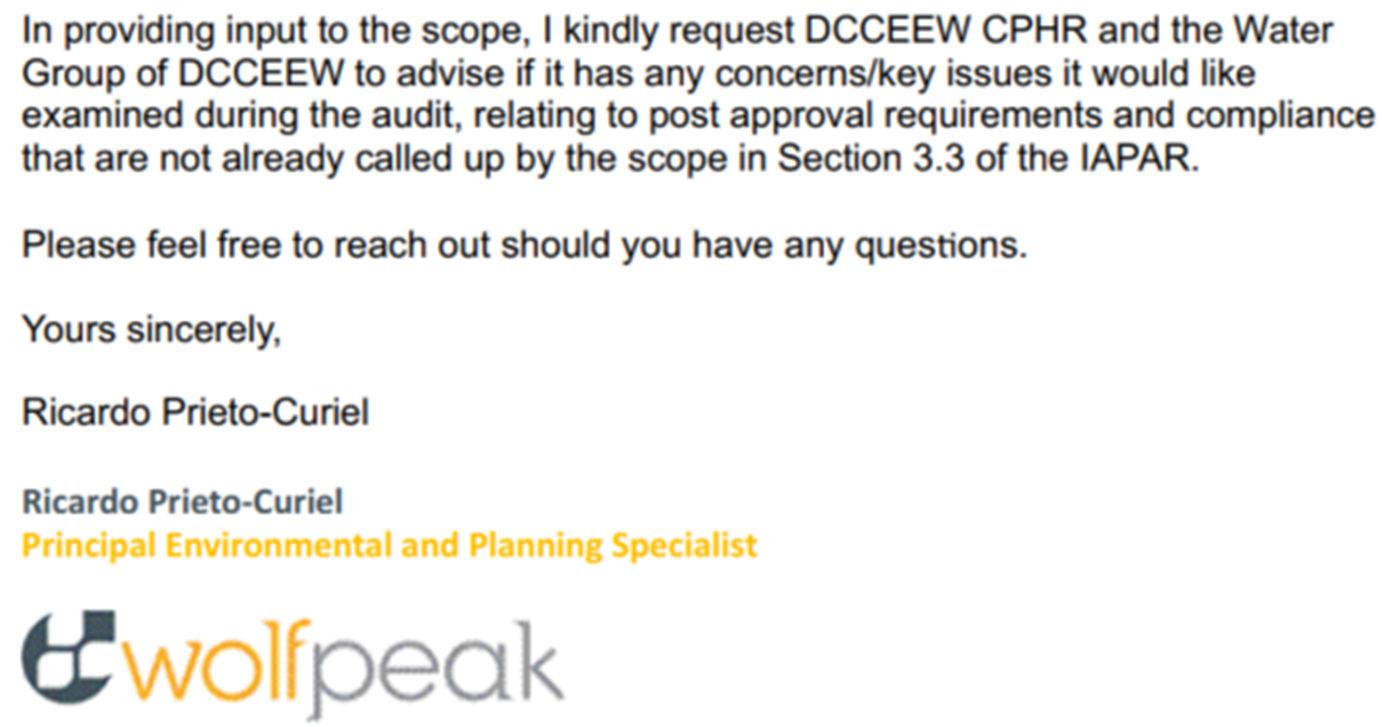

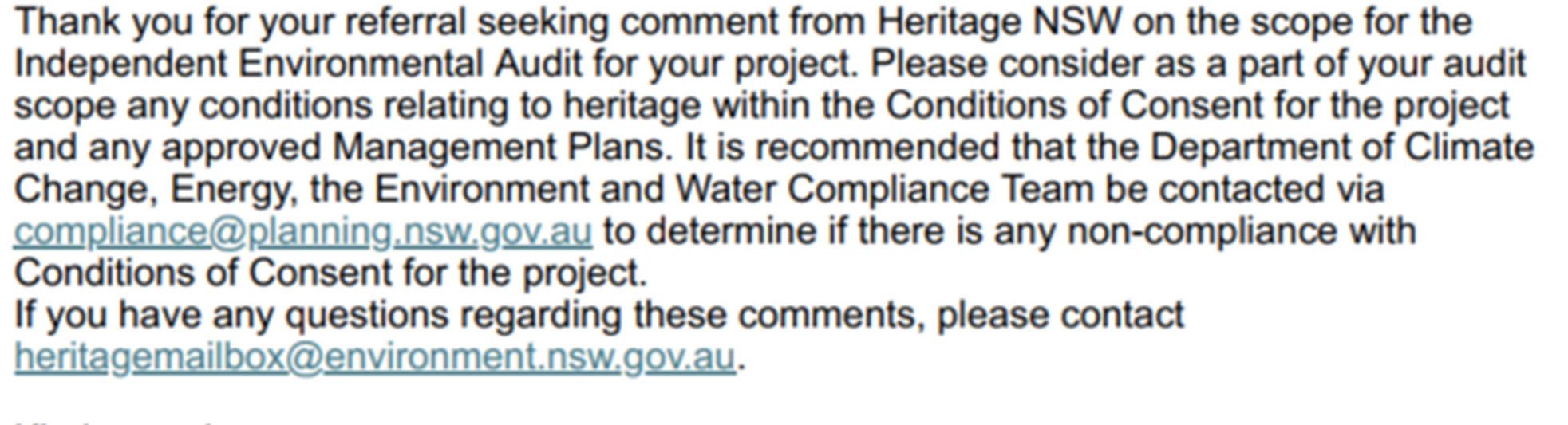

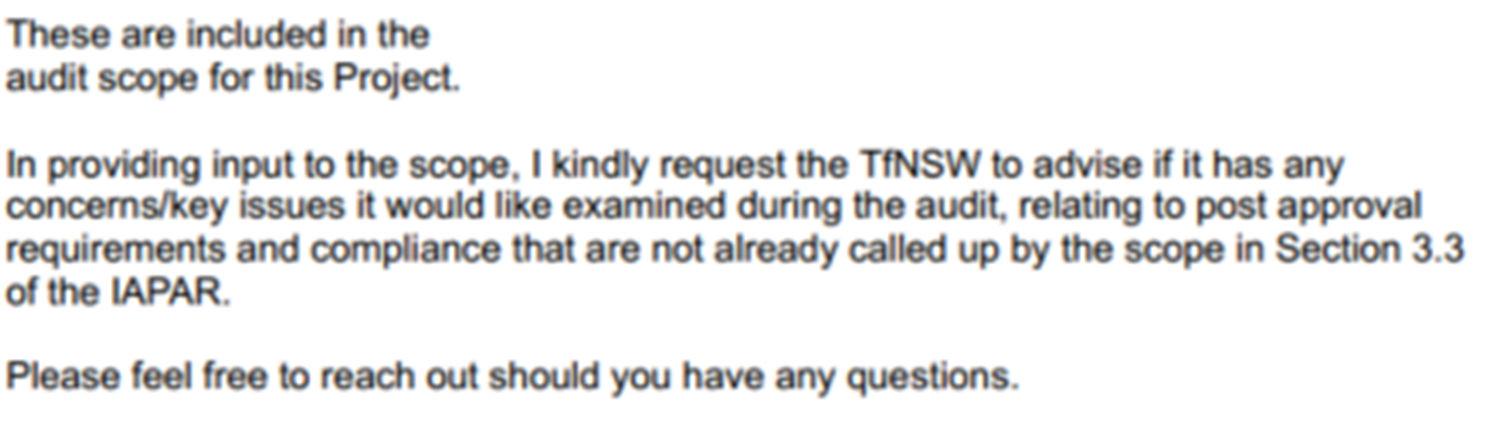

C14 Independent Environmental Audits of the development must be conducted and carried out in accordance with the Independent Audit Post Approval Requirements (2020) or as updated from time to time and published on the Department's website.
IAPAR 2020

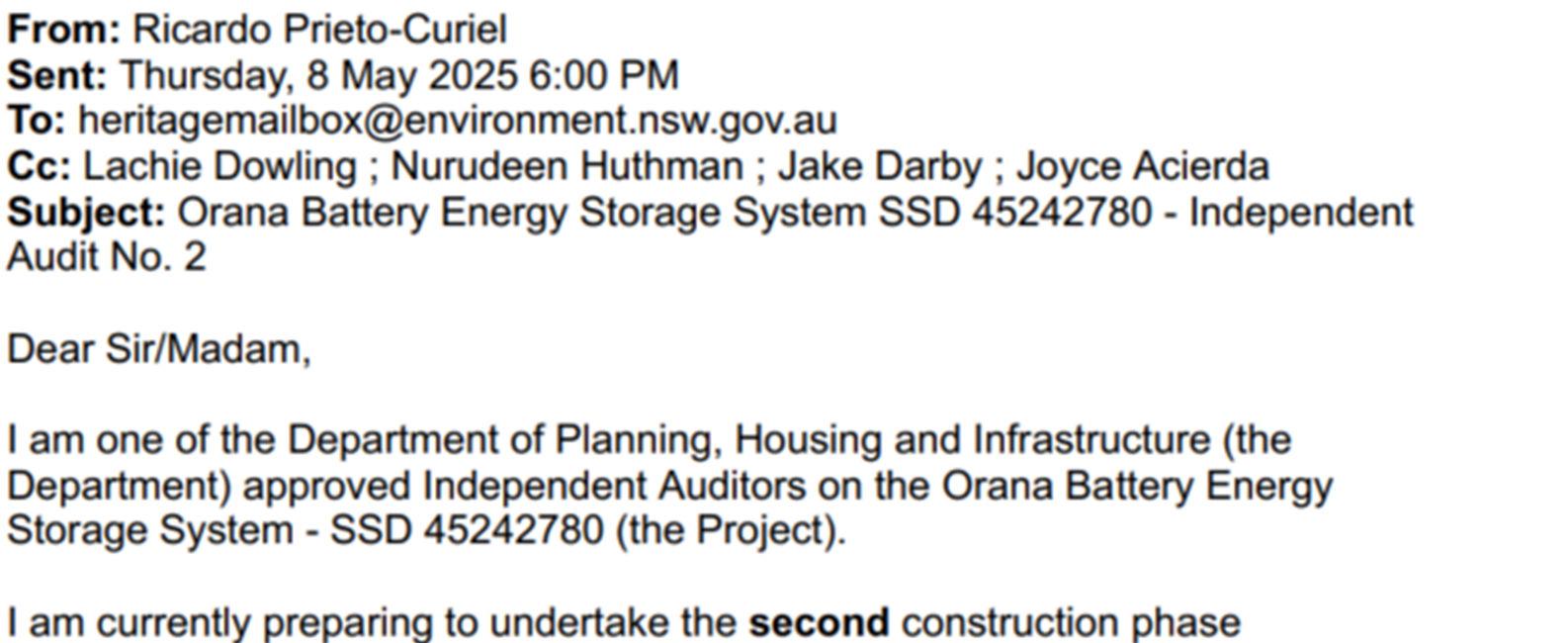

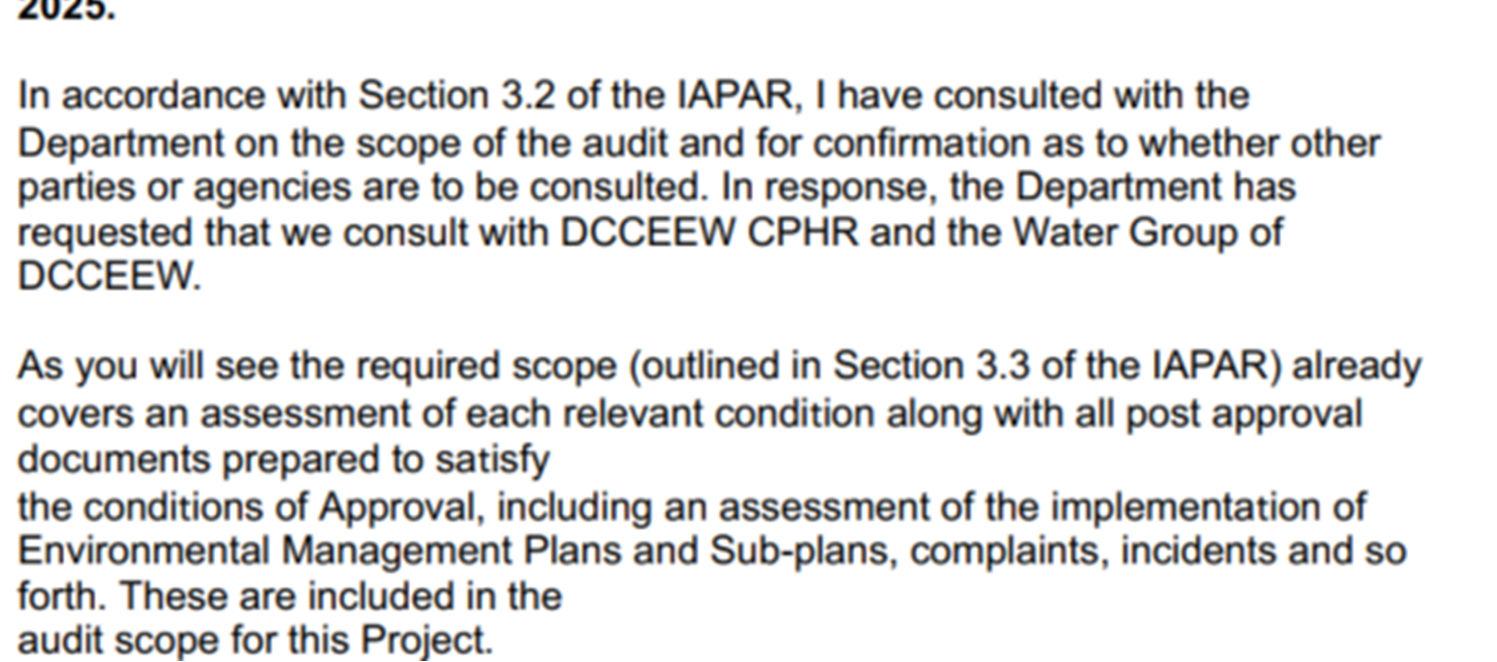

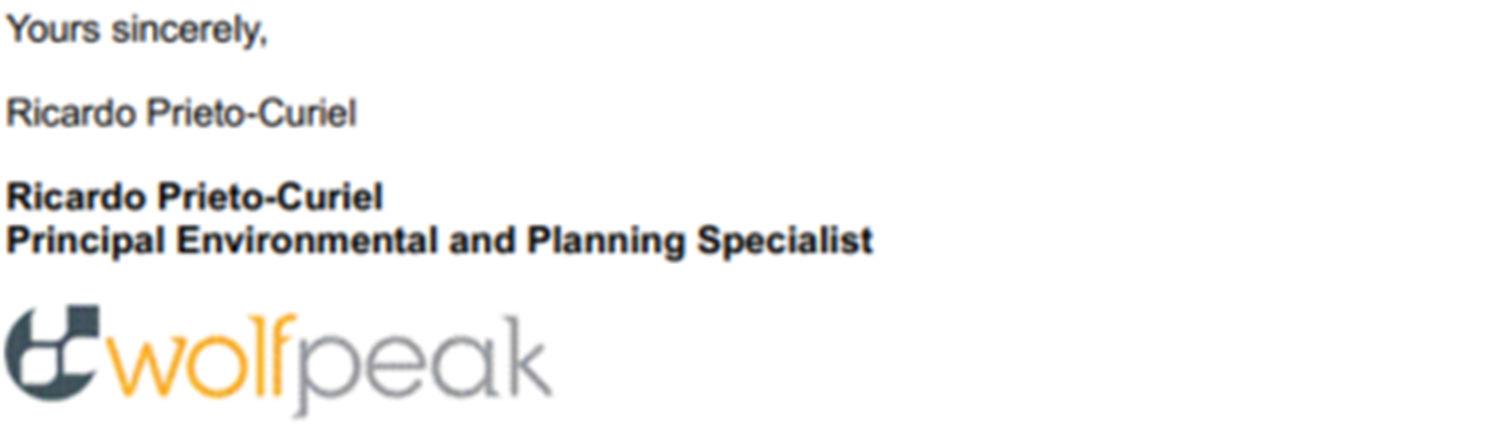

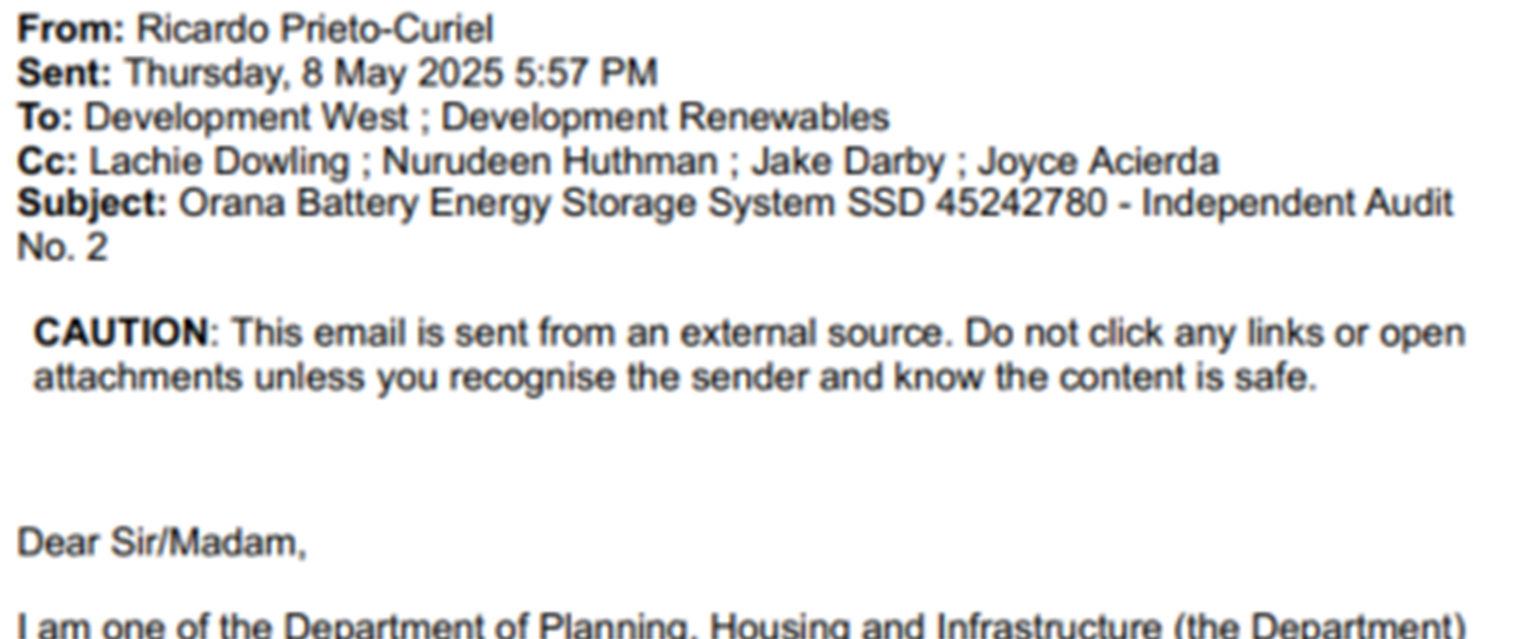

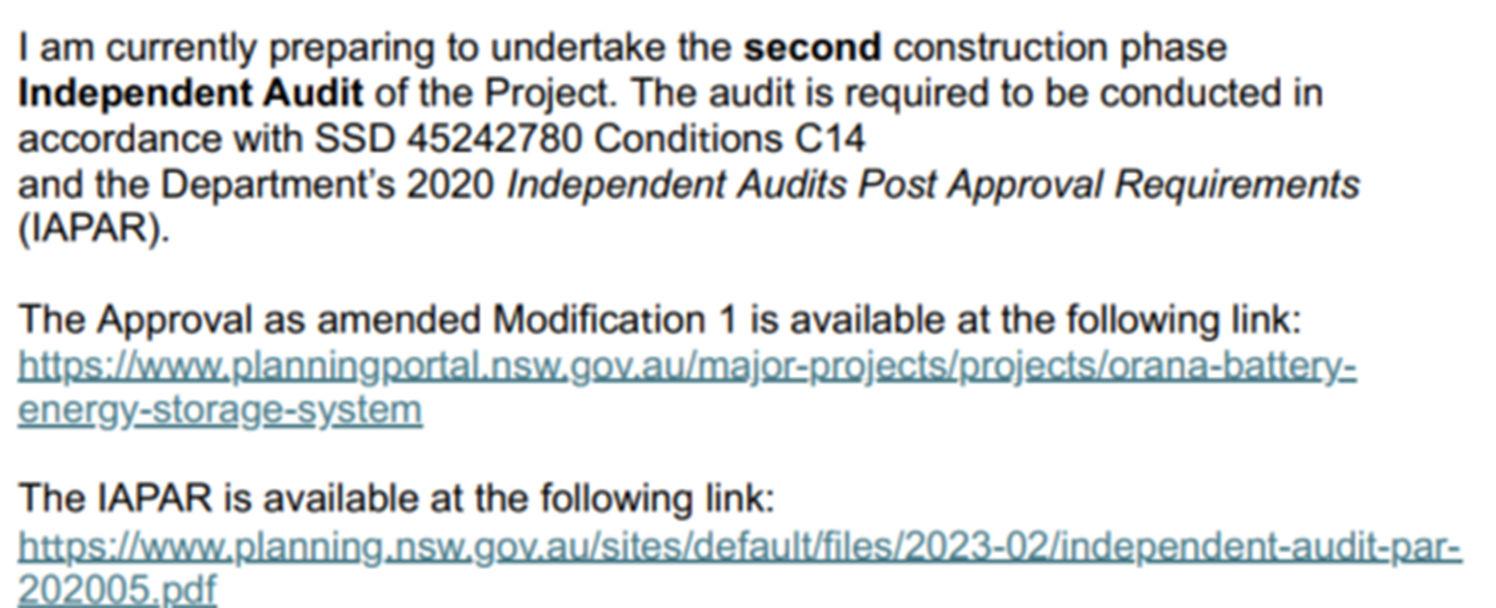

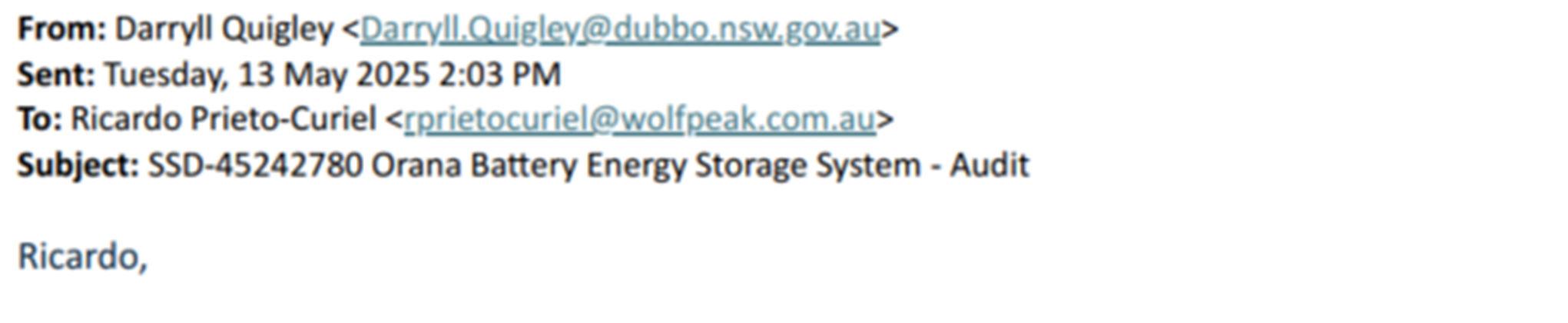

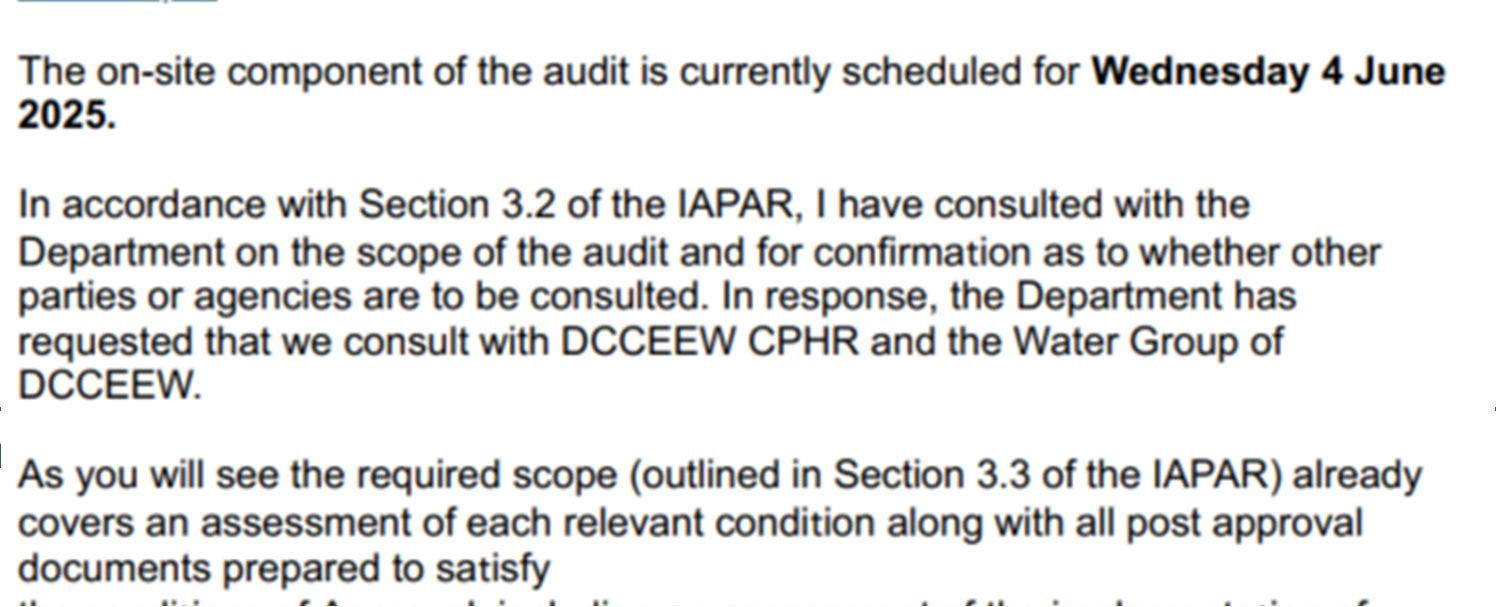

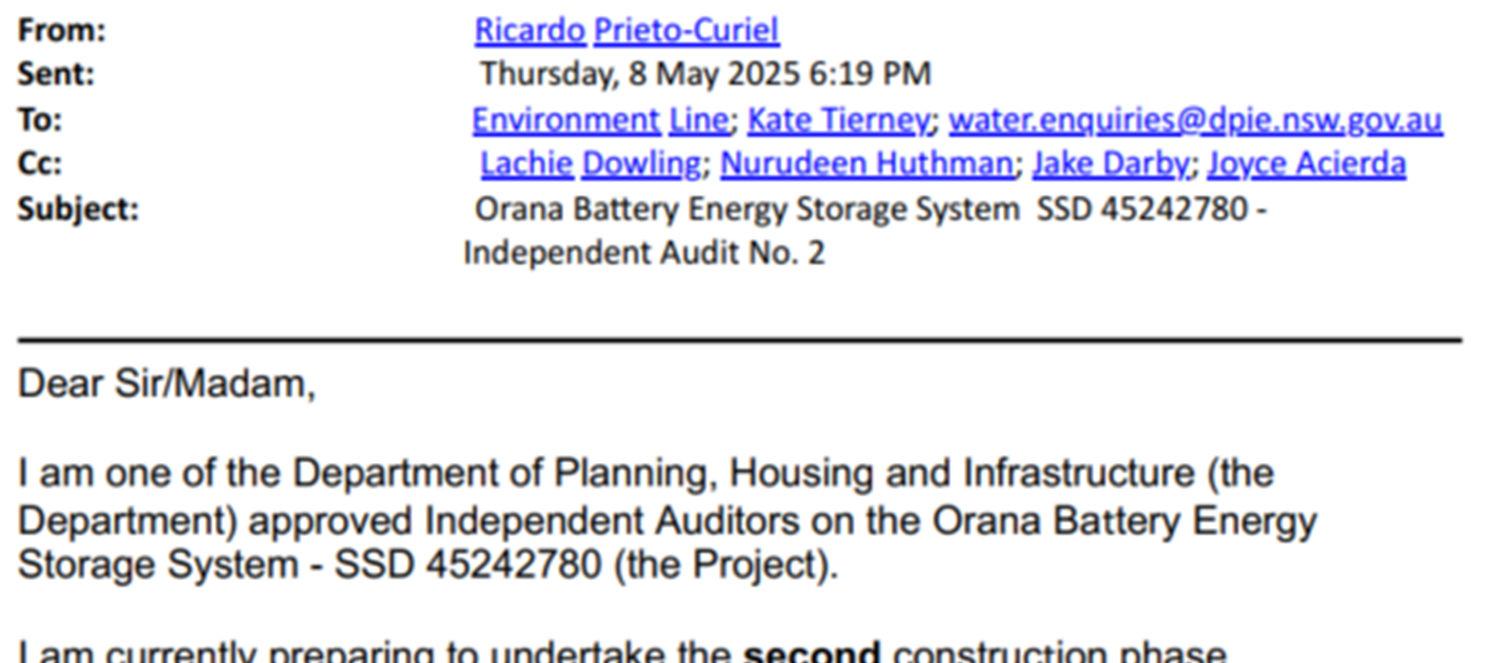

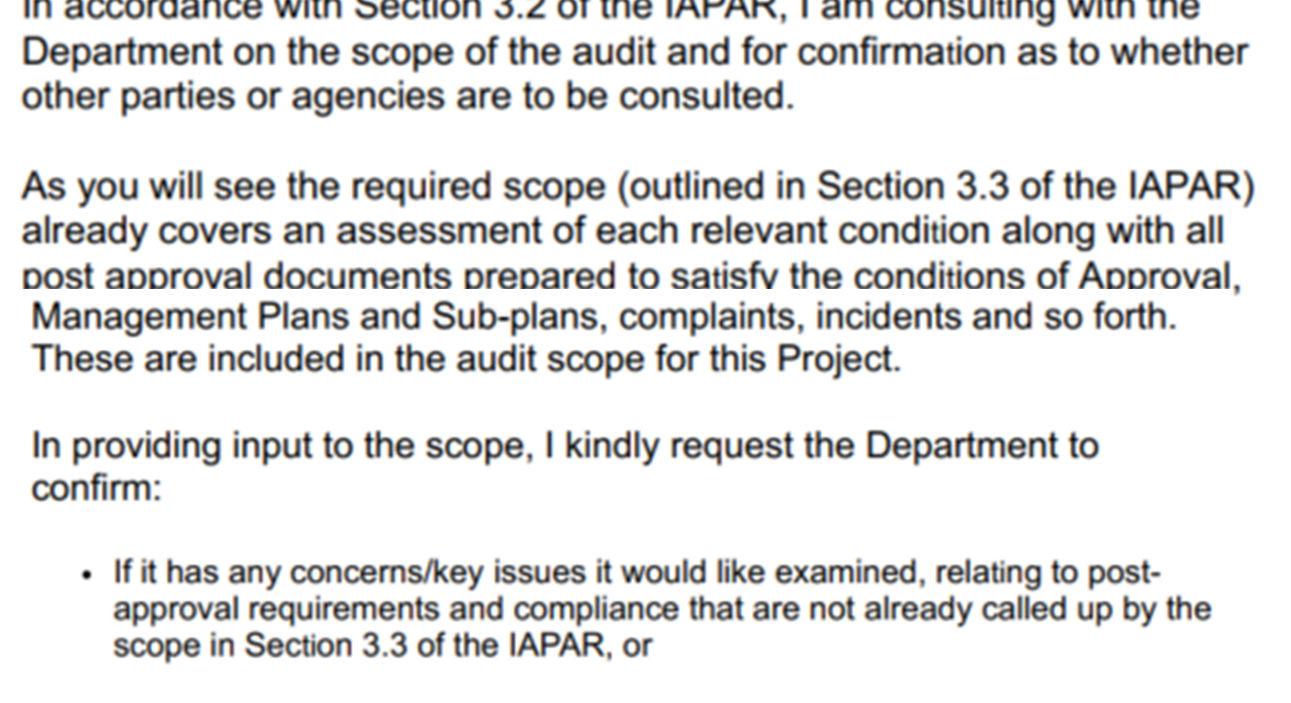

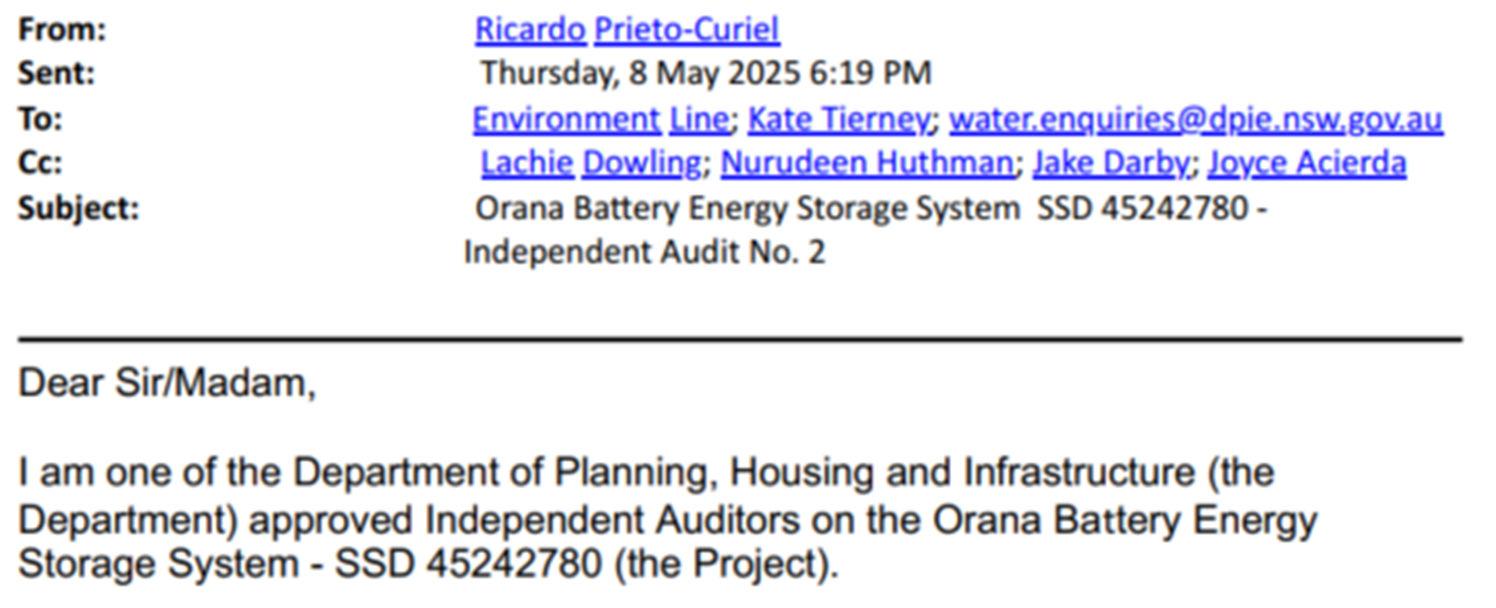

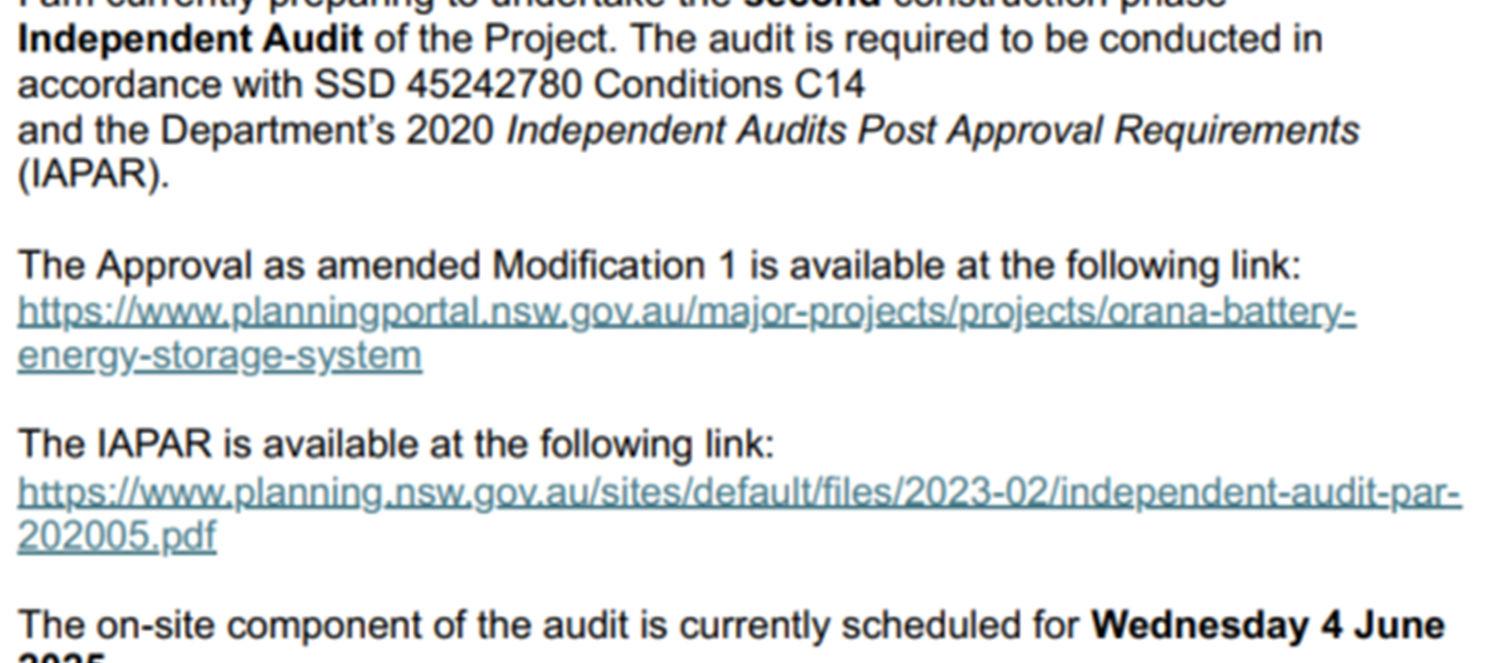

Independent Audit 1 by WolfPeak dated 6/02/25

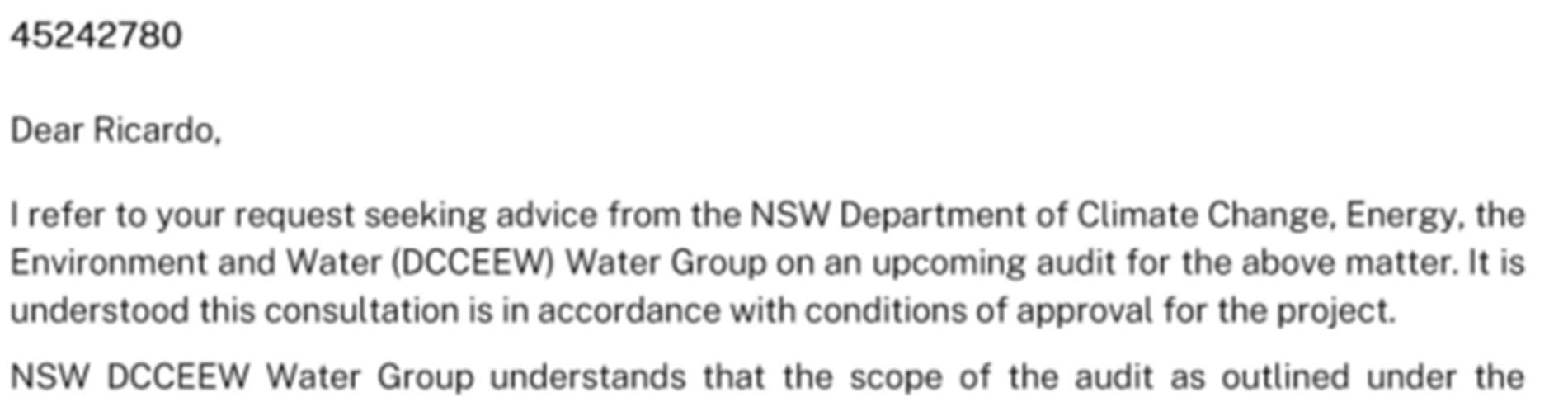

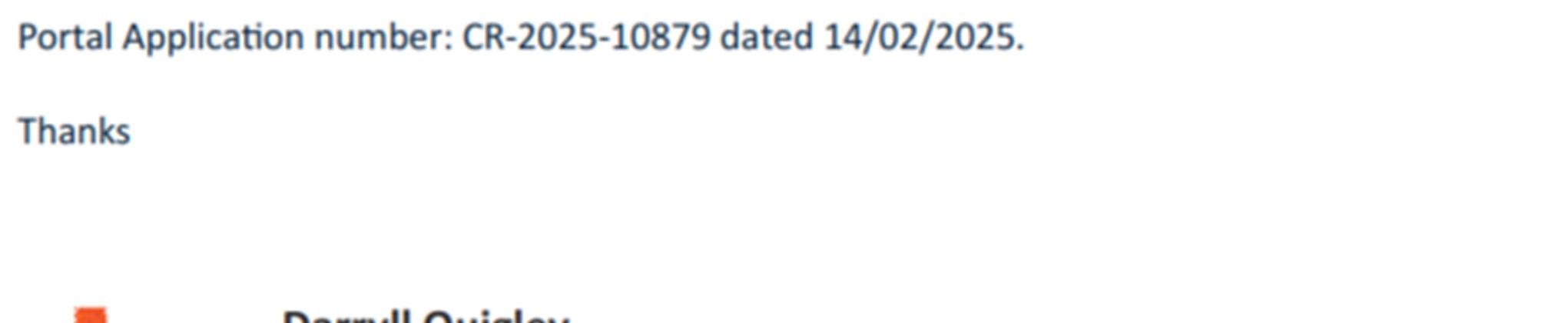

Post Approval dated 14/02/25 re: submission of Orana BESS Independent Audit No. 1 Rev 3, 6/02/25 by WolfPeak and response to audit findings.

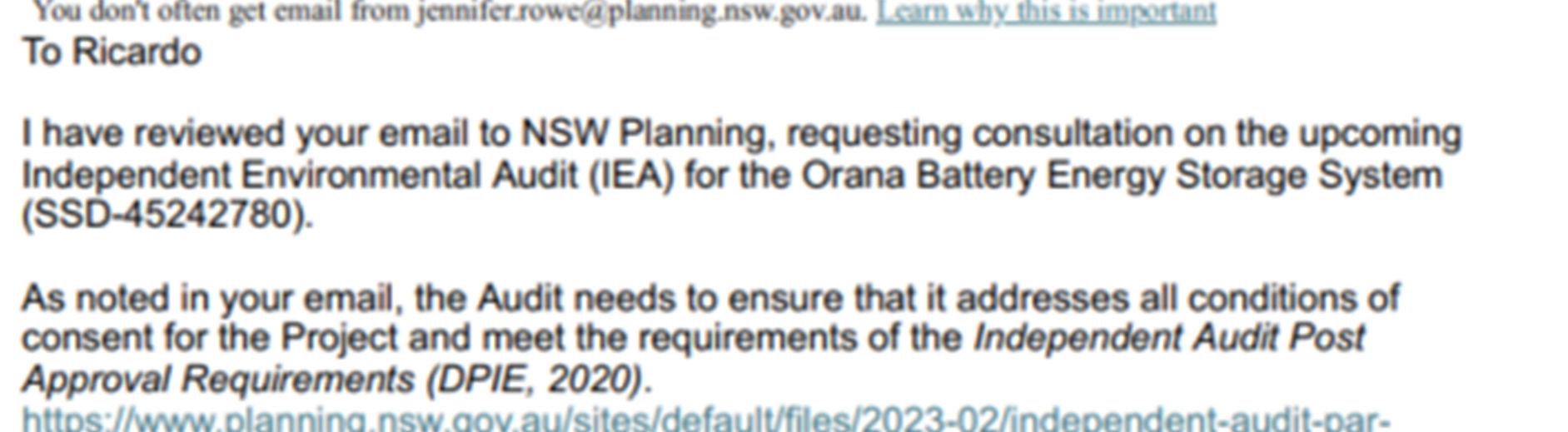

Letter 26/02/2025 DPHI-Akaysha re: Response to submission of IA1
Orana BESS Proponent response to audit findings (IA1)

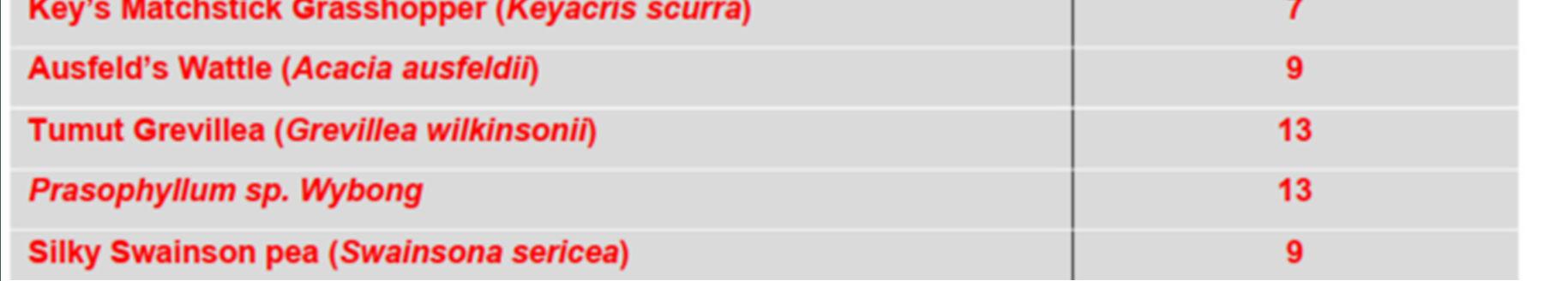

not include Prasophyllum sp. Wybong. The Proponent submitted the Charge Quote Application and retired the credits against the Charge Quote Statement in good faith, believing they were acting in compliance with the conditions of consent. The Proponent indicated that it will continue to work with DPHI and the Commonwealth Department of Climate Change, Energy, the Environment and Water (DCCEEW) to resolve this non-compliance.

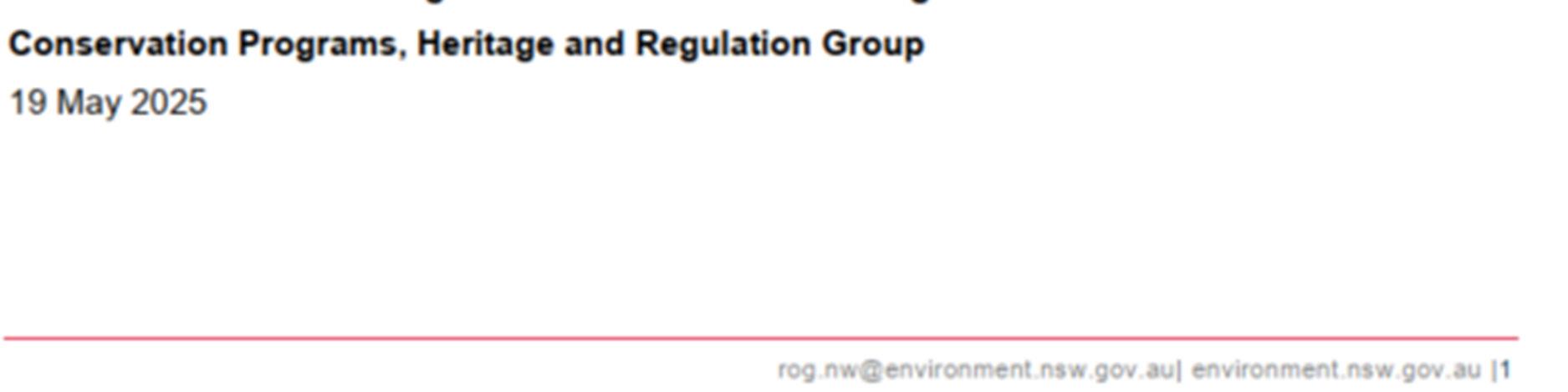

DPHI, in letter dated 1/05/25, responded to the above matter indicating that the non-compliance report generally satisfied the reporting requirements of C11. DPHI acknowledged that a resolution of the issue is still underway at the time of the notification and the Proponent is working with DCCEEW to resolve this matter. It also required that withing 2 months of the DPHI letter, a report be submitted to DPHI outlining the consultations with relevant department to resolve and / or achieve compliance with Condition B12.

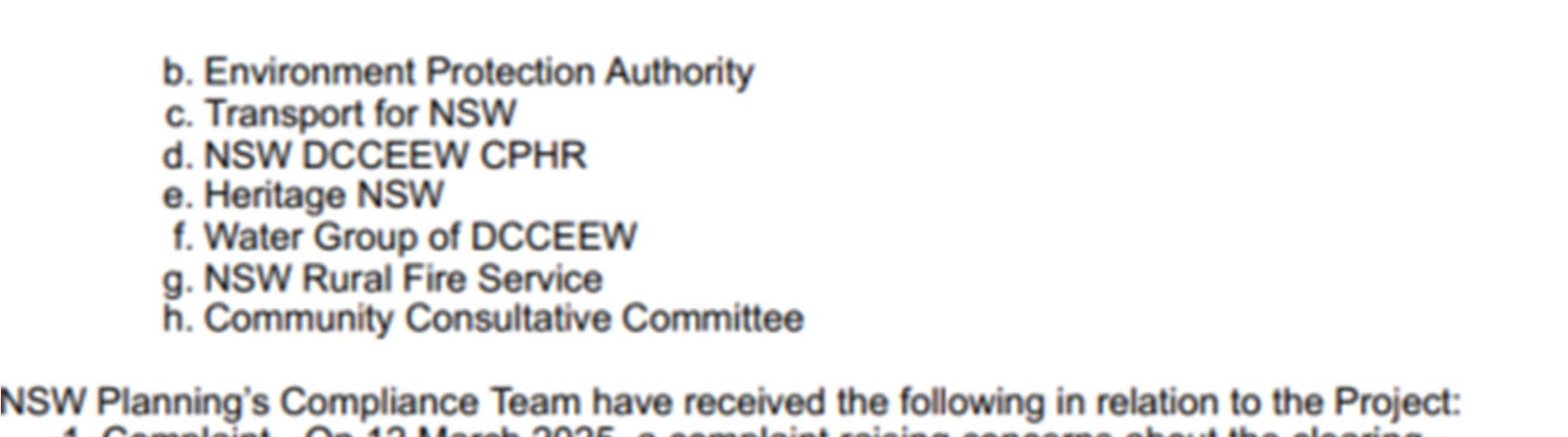

The above matter was raised as a finding in IA1 (for details refer IA1 report) and it is reported as non-compliance in IA2 until a resolution of the issue is found.
This requirement was removed in Modification 1.
This requirement was removed in Modification 1.

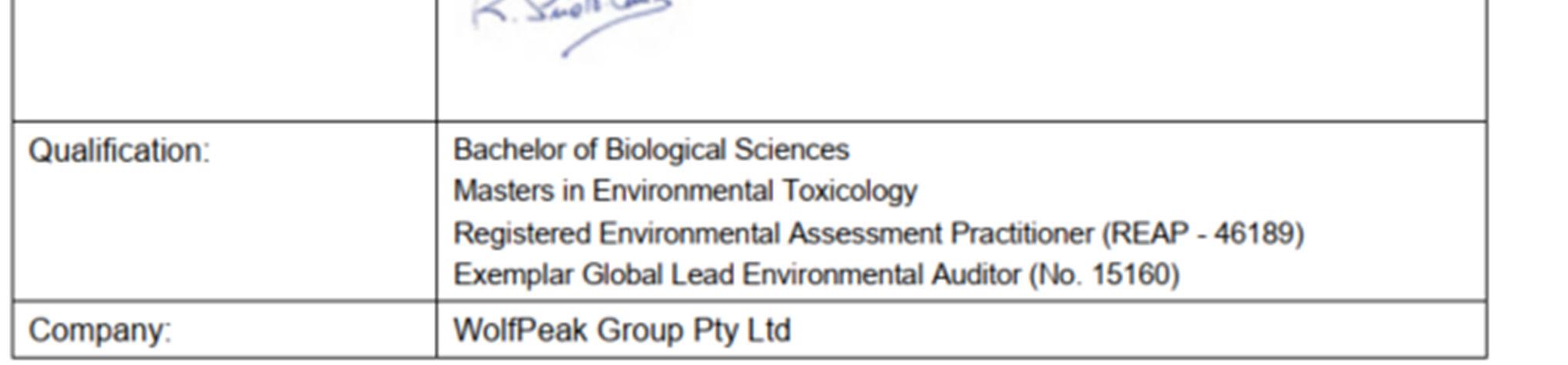

WolfPeak was engaged by Akaysha to undertake the independent audits for the project.

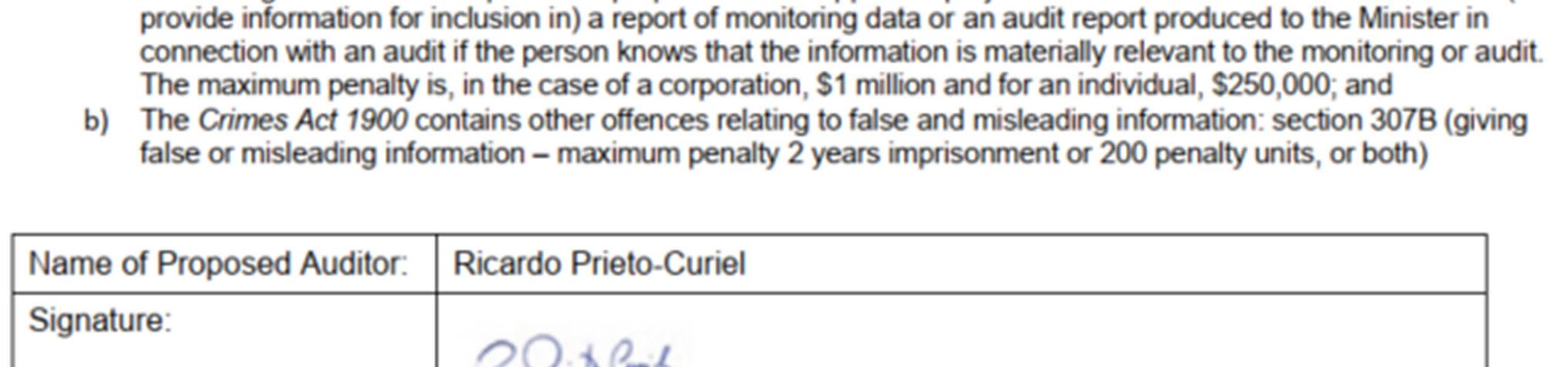

Independent Audit No. 1 Rev 3, dated 06/02/25, was prepared by WolfPeak, and the response to the audit findings was submitted to DPHI on the same date, within the required timeframe specified in the IAPAR 2020.
DPHI provided its response on 26 February 2025 regarding the submission of IA1 and considered the IEA report to generally satisfy the reporting requirements of the consent and IAPAR 2020.

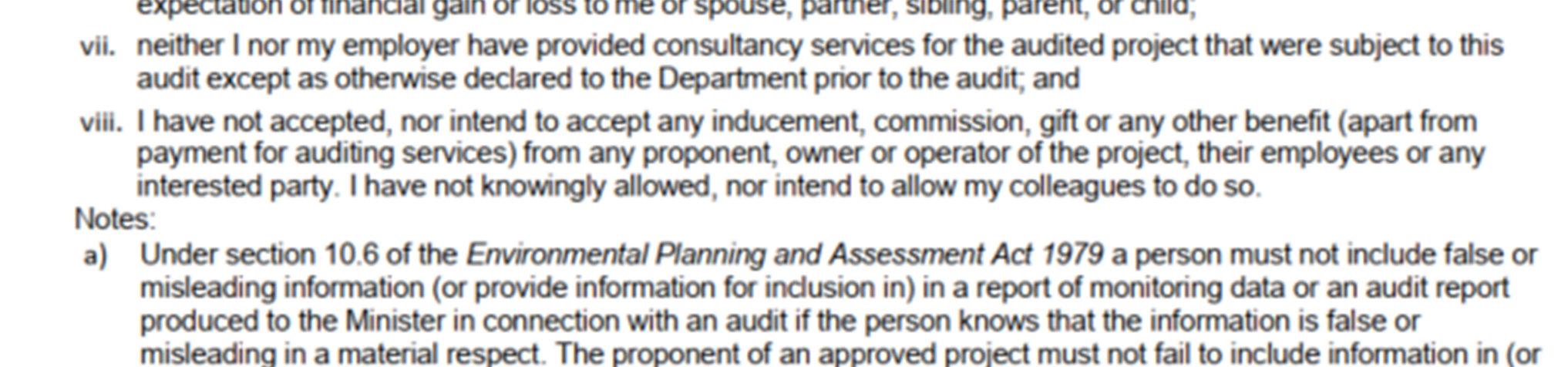

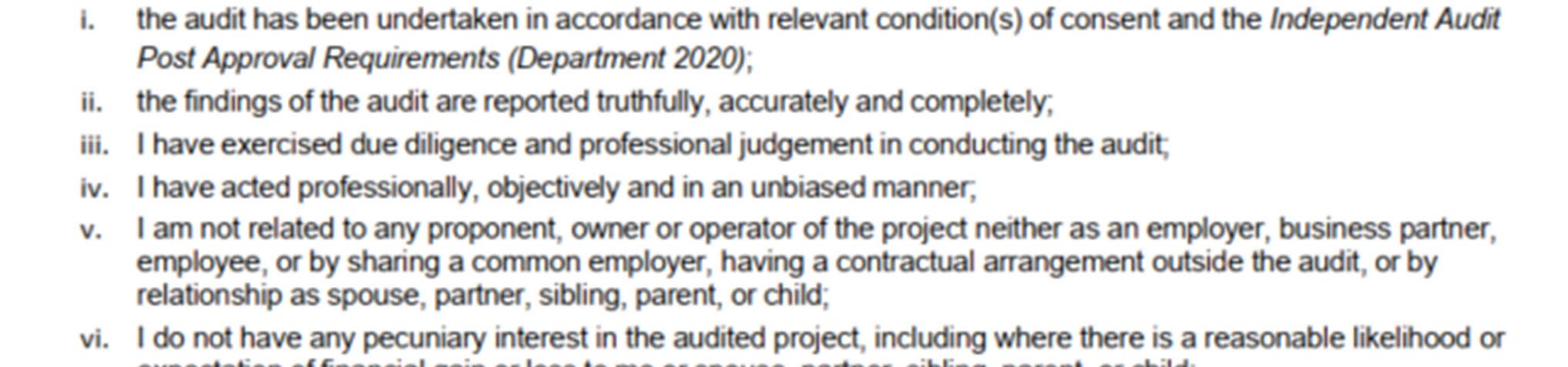

The current audit has been undertaken in accordance with IAPAR (2020), and within the timeframes required under IAPAR (2020)
Non-compliance: The applicant’s original response to Independent Audit No. 1 (IA1) did not address the observations / opportunities for improvement, as required under IAPAR 2020.
It is however noted that the Applicant subsequently submitted a report to DPHI addressing the observation raised in IA1. the Observation raised in IA1 related to Biodiversity Offsets (B12) which has been separately reported to DPHI as discussed in B12 and does not need to be reported again. This item is closed as all findings of IA1 have now been reported to DPHI.
Non-compliant
C15 Deleted Mod-1 SSD 45242780 : Additional construction laydown area and permanent fill batters approved on 26/09/2029 by DPHI
C16 Deleted Mod-1 SSD 45242780 : Additional construction laydown area and permanent fill batters approved on 26/09/2029 by DPHI
C17 Deleted Mod-1 SSD 45242780 : Additional construction laydown area and permanent fill batters approved on 26/09/2029 by DPHI
C18 Deleted Mod-1 SSD 45242780 : Additional construction laydown area and permanent fill batters approved on 26/09/2029 by DPHI
This requirement was removed in Modification 1.
This requirement was removed in Modification 1.
This requirement was removed in Modification 1.
This requirement was removed in Modification 1.
C19 Notwithstanding the requirements of the Independent Audit Post Approvals Requirements (2020), the Planning Secretary may approve a request for ongoing independent operational audits to be ceased, where it has been demonstrated to the Planning Secretary’s satisfaction that independent operational audits have demonstrated operational compliance. The project is under construction Not Triggered
ACCESS TO INFORMATION
C20 The Applicant must:
a) make the following information publicly available on its website as relevant to the stage of the development:
i. the EIS;
ii. the final layout plans for the development;
iii. current statutory approvals for the development;
iv. approved strategies, plans or programs required under the conditions of this consent (other than the Fire Safety Study and Emergency Plan);
v. the proposed staging plans for the development if the construction, operation and/or decommissioning of the development is to be staged;
vi. a comprehensive summary of the monitoring results of the development, which have been reported in accordance with the various plans and programs approved under the conditions of this consent;
vii. how complaints about the development can be made;
viii. any independent environmental audit, and the Applicant’s response to the recommendations in any audit; and
ix. any other matter required by the Planning Secretary; and
b) keep this information up to date.
There are two project websites with information about the project:
https://community.akayshaenergy.com/oranabess
https://akayshaenergy.com/projects/oranabess
https://community.akayshaenergy.com/oranabess
The website https://community.akayshaenergy.com/orana-bess contains the following or access to that information via links to the major projects website:
i. EIS

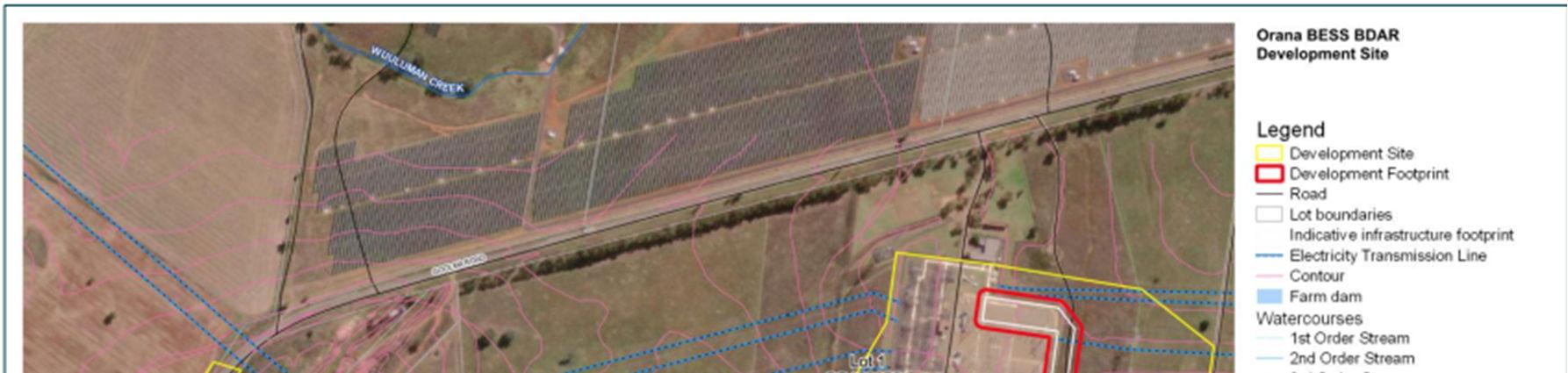

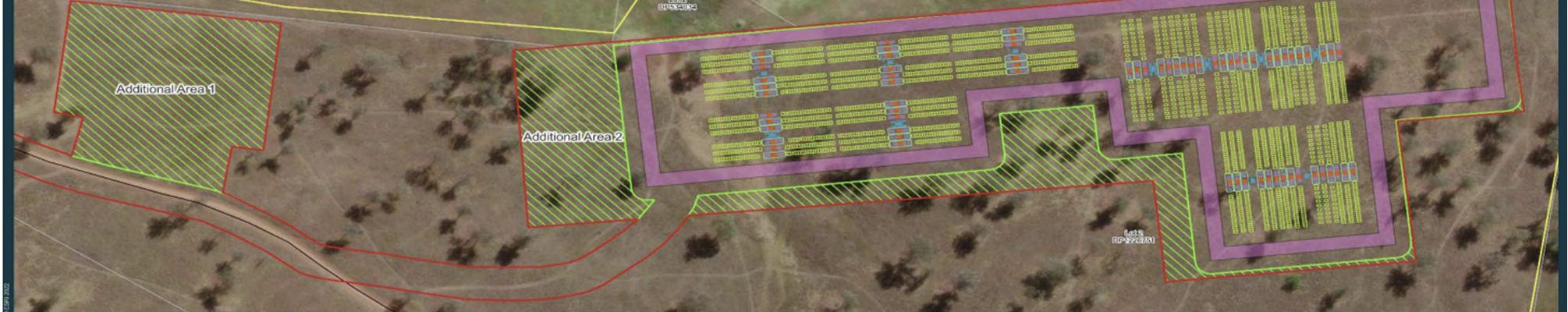

ii. A Final Layout Plan is uploaded
iii. The SSD approval is available in the Major Projects link provided in the website
iv. Environmental Management Strategy, Biodiversity Management Plan, Traffic Management Plan and Accommodation and Employment Strategy uploaded
v. Traffic Management Plan Stages uploaded
vi. Monitoring results not updated
vii. Community feedback form and contact details provided

viii. The first audit is available in the Major Projects link provided in the website
ix. The approved capacity increase to 415 MW and the Chance Finds Protocol are uploaded in the website in accordance with Planning Secretary requests (DPHI correspondences dated 4/03/2024 and 19/07/24 respectively)

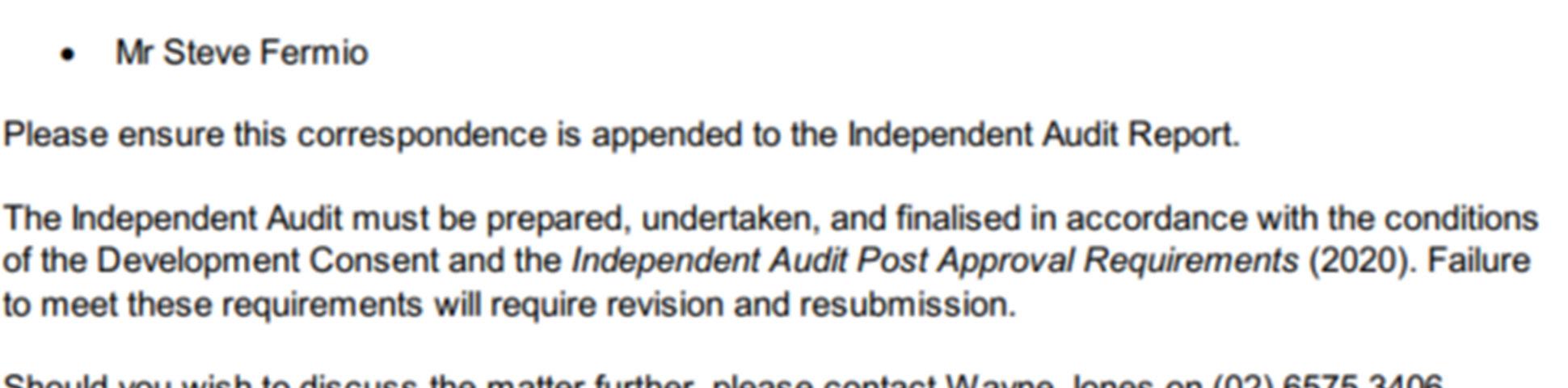

Non-compliance: The project website does not include a comprehensive summary of the monitoring results for the development or the applicant’s response to the findings of Independent Audit No. 1.
Recommendation: Update the project website and include the monitoring results for the development and the applicant’s response to the findings of Independent Audit No. 1.
(Note: in response to the Draft IA2 report, the auditee advised that ongoing monitoring reports were uploaded incorrectly with sensitive personal information and Akaysha removed for editing prior to resubmission.)
